Data center construction delays are costly and disruptive. Missed deadlines can halt IT migrations, cloud launches, or client onboarding, with penalties reaching tens of thousands of dollars daily. These projects face challenges like complex systems, supply chain issues, and permitting delays. Here’s how to stay on track:

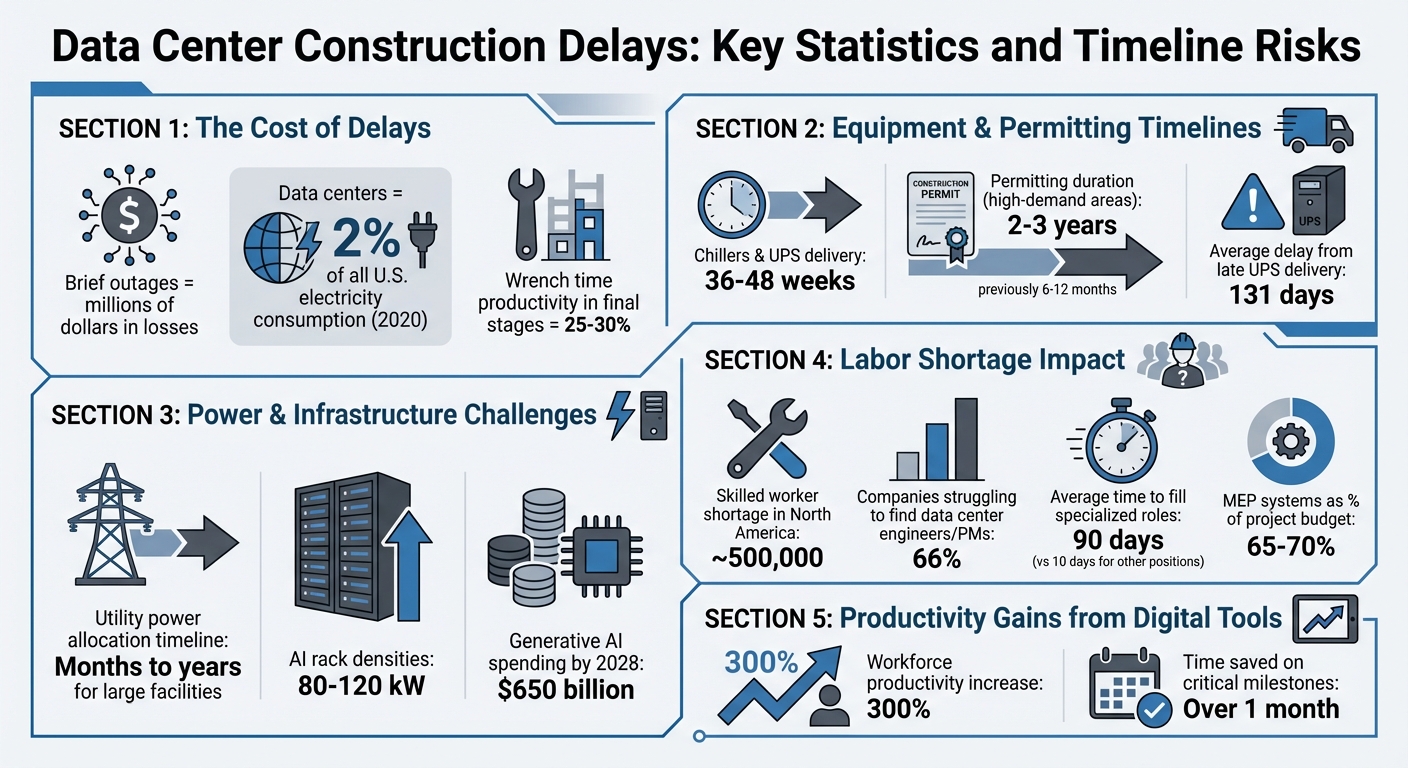

Data Center Construction Delays: Key Statistics and Timeline Risks
Building data centers comes with its own set of hurdles. These facilities depend on global supply chains to procure highly specialized components like modular UPS systems, advanced cooling setups, and transformers. If a vital piece of equipment misses its production window, the entire project can face delays stretching several quarters. Such logistical setbacks carry significant financial implications.
Delays in data center construction can lead to steep financial losses. In 2020, data centers accounted for nearly 2% of all electricity consumed in the U.S., a number that keeps climbing as AI workloads grow. Even brief outages can result in millions of dollars in losses for organizations. BDO highlights the risks:
"AI data centers require sustained computational power across distributed systems, making brief interruptions as damaging as extended outages".
When construction delays compress the commissioning phase, testing often gets rushed, which can undermine system reliability. The financial stakes grow even higher when technical challenges add complexity to the project.
Technical challenges make scheduling even tougher. Data centers are intricate systems where changes in one area can trigger a cascade of adjustments across multiple engineering disciplines. For instance, tweaking the dimensions of an equipment room might require a complete overhaul of MEP systems, wiring layouts, and HVAC designs.
Commissioning these facilities is no small feat. It involves multiple stages of tagging, securing witness sign-offs, and transitioning from contractor-led to owner-led testing. As FTI Consulting explains:
"the commissioning of data centres can also lead to unforeseen technical challenges as there are more complex and rigorous testing requirements than typical construction projects".
During the final stages of construction, productivity often takes a hit. In the dense, confined spaces of data centers, tradesmen’s effective working time - known as "wrench time" - can drop to just 25–30%.
Utility coordination adds another layer of difficulty. Securing power allocations from utility providers can take months or even years for large-scale facilities. Meanwhile, critical equipment like chillers and UPS systems often require 36 to 48 weeks for delivery. If load estimates change mid-project, site energization can face additional months of delays.
Building data centers on time is no small feat, and delays often boil down to three main areas: permitting challenges, power infrastructure issues, and supply chain hiccups. Getting a handle on these risks early can help teams create more realistic timelines and prepare backup plans to keep things on track.
Getting permits for data centers has become a major headache. In high-demand areas like Northern Virginia, Dublin, and Singapore, what used to take 6–12 months now stretches into 2–3 years. Why? Authorities are taking a closer look at things like water usage, carbon emissions, noise, and how these massive facilities impact their surroundings.
Zoning is another hurdle. Many sites aren't pre-approved for data center construction, meaning developers have to go through time-consuming processes like zoning variances or special-use permits. As Datacenters.com puts it:
"Permitting is no longer an afterthought - it is the first hurdle in the construction process".
Classification issues can also slow things down. Local governments may label data centers under "Business" occupancy (Group B), adding unnecessary requirements for exits and amenities. Reclassifying these facilities as "Storage" (Group S) can simplify compliance and help avoid delays.
Environmental reviews are yet another stumbling block. Stricter regulations now require detailed assessments, which can drag out the process by months. To sidestep potential lawsuits or community pushback, developers are finding it's smarter to start working with local authorities and community groups years before breaking ground.
But permitting isn't the only challenge - power and utility coordination can throw a wrench into schedules, too.
Power availability is now the biggest obstacle in data center construction. In key markets like Northern Virginia, Dublin, and Singapore, utility providers are even imposing moratoriums on new connections. And when power is available, getting utilities to approve allocations for large-scale facilities can take months - or even years.
Grid capacity is another issue. Many areas need significant upgrades, such as new substations or transmission lines, to accommodate data centers. These upgrades must align with construction timelines, which adds another layer of complexity. The rise of AI workloads is only making things trickier. With rack densities now reaching 80–120 kW, data centers require advanced high-voltage systems (415V or higher).
Mid-project changes to IT load estimates can also derail schedules. When developers update their power needs, utilities have to re-evaluate interconnection requests, which can delay site energization by several months. And with generative AI spending expected to hit $650 billion by 2028, the demand for power will only grow, further straining existing infrastructure.
Then there’s the issue of equipment and labor shortages, which can grind progress to a halt.
Supply chain delays and labor shortages are two more big factors that throw off project timelines. Specialized equipment like transformers, UPS systems, and cooling units often takes a long time to manufacture. For example, an FTI Consulting case study from October 2024 highlighted a 131-day delay on a project due to late UPS delivery. Initially, the UPS wasn’t on the critical path, but the extended delay ended up shifting the entire project timeline, delaying the fit-out phase.
Labor shortages make things even harder. Skilled tradespeople and construction project managers are in short supply, which directly slows down construction. Chris Fancher, US Head of Construction Property at Allianz Commercial, summed it up:
"At a $20bn+ facility, tens of thousands of workers and massive equipment flows demand expert coordination to avoid costly delays".
Timing is everything. If equipment arrives before the site is ready or crews are available, it creates storage and handling headaches. On the flip side, if equipment arrives late, contractors face expensive downtime while workers wait around. The reliance on global supply chains for pre-assembled components also exposes projects to risks like geopolitical disruptions and shipping delays.
Staying ahead of potential delays is crucial for keeping data center projects on track. By addressing challenges like permitting, power, and procurement early, teams can better manage risks and stick to their schedules.
Getting stakeholders involved early can significantly improve schedule control. Assigning an owner's representative to evaluate contractors, verify their qualifications, and establish an incentivized construction schedule is a smart first step. This representative should also monitor the project timeline regularly to ensure testing and commissioning phases aren’t compromised by construction delays.
Bringing a Commissioning Agent (CxA) on board early ensures sufficient testing time is built into the schedule. When the CxA collaborates with the General Contractor during the planning phase, it’s easier to allocate adequate time for Level 4 and Level 5 testing, preventing the "commissioning buffer" from being consumed by construction overruns. Including operations teams during the design and construction stages is equally important - they can influence change management and familiarize themselves with critical systems before the facility becomes operational.
On the utility front, submitting interconnection and load letters early is essential to securing queue slots. Adjusting load estimates mid-process can delay site energization by months. Before finalizing construction milestones, ensure you have stamped letters from providers confirming power and fiber availability. Some teams streamline coordination by adopting Integrated Project Delivery (IPD) or Design-Build models, which consolidate architects, engineers, and contractors under a single contract. This approach aligns incentives and accelerates construction timelines.
Digital tools further enhance this coordination by providing real-time updates and ensuring everyone stays on the same page.
Digital tools are game-changers for improving schedule accuracy and transparency. An Integrated Master Schedule (IMS) maps out the entire project scope, including thousands of tasks, to identify critical paths and dependencies. Mobile apps allow supervisors to receive real-time updates from crews, enabling faster problem resolution. Meanwhile, 3-D digital twins, created from drone footage, provide detailed visual planning and help teams set realistic daily goals.
One key advantage of digital tools is the level of visibility they offer. Including milestones such as "room readiness" and technical phase completions makes it easier to pinpoint the cause of any delay. AI-powered platforms also simplify the tracking of pre-construction milestones - like permitting, grid access, and procurement of long-lead equipment - preventing coordination gaps. These tools have proven to boost workforce productivity by 300 percent while shaving over a month off critical milestones.
Before diving into advanced analytics, it's essential to establish solid schedule management practices. For example, when integrating subcontractor schedules into a master program, use unique activity identifiers to avoid duplication and logic errors. Regular Schedule Risk Assessments (SRA) can help quantify the likelihood of meeting deadlines and identify tasks that are piling up, often referred to as "bow wave" tasks.
Beyond digital tools, proactive supply chain and labor strategies are vital to maintaining schedule integrity. Start by pre-ordering long-lead equipment - such as transformers, backup generators, UPS systems, and cooling units - during the planning phase to account for extended production and delivery timelines. Establishing vendor agreements early with contractors who have specific data center experience can also help prevent last-minute scrambling.
Early Contractor Involvement (ECI) is another effective approach. By bringing contractors into the project during the design phase, teams can develop more accurate cost and time estimates while ensuring the schedule aligns with contractor capabilities. Diversifying supplier networks also reduces reliance on a single vendor, minimizing risks from global supply chain disruptions. Additionally, syncing workforce schedules with equipment delivery ensures that skilled technicians, like HVAC specialists and electrical crews, are available when components arrive, eliminating downtime.
Using modular and off-site fabrication can further streamline the process. This method reduces on-site assembly time, improves quality control, and helps address local labor shortages. A Just-in-Time (JIT) delivery strategy, where modules arrive only when needed, minimizes site congestion and reduces storage and handling risks. To protect high-value modular components, set up predefined, climate-controlled staging zones to prevent damage and ensure they’re ready for immediate installation.
Finally, hiring experienced project managers with expertise in data center construction is essential. These professionals excel at coordinating complex schedules, managing vendor relationships, and keeping teams aligned on tight deadlines. By combining thorough planning, advanced technology, and skilled leadership, data center projects can stay on track and avoid unnecessary delays.
While cutting-edge tools and strategies are essential, the foundation of any successful data center project lies in its skilled workforce. Even the most advanced digital tools and planning methods can't deliver results without the right people to implement them. Data center projects demand professionals who not only excel in traditional construction management but also understand the technical intricacies of mission-critical infrastructure. Without this dual expertise, projects risk falling behind schedule and exceeding budgets.
The challenge? North America is grappling with a shortage of around 500,000 skilled workers. About 66% of companies report difficulty finding engineers and project managers with data center-specific experience. Specialized roles, in particular, remain open for an average of 90 days, compared to just 10 days for other positions in the field. This talent shortfall gives competitors a significant edge in securing top candidates.
Schedulers play a pivotal role in keeping data center projects on track, and their skill set must go beyond software proficiency. While expertise in tools like Primavera 6 (P6) is a must-have, the real value lies in understanding how construction works in practice. A scheduler who lacks real-world construction knowledge may create timelines that look good on paper but fail in execution. Industry insiders stress that this gap can lead to costly scheduling mistakes, making it crucial to hire or train professionals with hands-on experience.
Technical expertise sets apart exceptional schedulers. They need a deep understanding of critical equipment such as electrical switchgear, UPS systems, backup generators, chillers, cooling towers, and CRAC units. Knowledge of Level 4 and Level 5 commissioning processes is equally important to avoid compressing these critical phases when construction falls behind. Additionally, concepts like "Concurrent Maintainability" and "Fault Tolerance" are vital for ensuring that scheduling adjustments don’t compromise the facility’s Tier rating.
Another key responsibility is managing procurement timelines for specialized MEP equipment, which can account for 65% to 70% of a data center project's budget. Schedulers must incorporate long-lead items into the master schedule to prevent delays on the critical path. Without this expertise, projects face significant risks when essential components don’t arrive as planned. These skills bridge the gap between digital scheduling tools and on-site execution, making expert schedulers indispensable for mitigating baseline risks.
In a tight labor market where top talent moves quickly, traditional hiring methods often fall short. Standard job postings and lengthy HR processes can cause companies to lose qualified candidates to faster-moving competitors. This is where specialized recruiters come in, offering a more targeted approach to finding the right professionals for mission-critical construction projects.
iRecruit.co is one such recruiter, specializing in connecting data center builders and developers with construction project managers who have the necessary technical expertise. Rather than relying solely on traditional applications, they actively engage experienced, passive candidates. Their process includes technical vetting to ensure candidates have hands-on experience with MEP systems, commissioning, and mission-critical facilities.
iRecruit.co operates on a success-based model, charging fees of 20% to 25% of the first year’s salary, depending on the number of open roles. For companies hiring multiple positions, they offer monthly retainers starting at $3,500 per role, with reduced success fees of 20%[website]. This model ensures alignment - recruiters only get paid when a hire is made, and their 90-day replacement guarantee adds an extra layer of confidence.
Considering that MEP systems account for such a large portion of project budgets, hiring professionals who truly understand these systems isn’t just smart - it’s essential. The difference between a scheduler who merely knows the software and one who understands construction realities can mean the difference between an on-time project and significant delays.
Delays in data center projects can often be avoided with proper planning and early coordination. By implementing the strategies discussed, such as finalizing designs early and aligning resources effectively, teams can stay ahead of potential setbacks. Engaging suppliers well in advance ensures the timely delivery of critical equipment. Additionally, selecting an appropriate delivery model allows construction to begin even as final designs are being completed, helping to streamline timelines. Allocating sufficient time for commissioning is also key to ensuring optimal facility performance.
Having the right expertise on board is equally important. Keith Klesner from Uptime Institute emphasizes this point:
"Experienced teams push back on unrealistic schedules or VE suggestions that do not meet OPR [Owner's Project Requirements], which prevents commissioning schedule compression".
Skilled project managers and schedulers bring a deep understanding of both software tools and on-the-ground construction realities. They can identify when a timeline looks feasible on paper but is impractical in execution.
Data from over 550 Tier Certifications across 65 countries reveals that poor integration of complex systems and rushed commissioning schedules are leading causes of delays and failures in data center projects. To avoid these pitfalls, it's crucial to assemble the right team from the start. Whether through specialized recruiters like iRecruit.co or other targeted hiring efforts, securing top talent is what distinguishes successful, on-time projects from those that fall behind. With a well-coordinated team and careful schedule management, data center projects can meet their deadlines and achieve their goals efficiently.
Managing schedule risks in data center construction demands careful planning, seamless coordination, and a solid risk management approach. One of the most important steps is finalizing and aligning the project design as early as possible. Why? Because late-stage design changes can ripple across multiple work areas, causing delays that are tough to recover from. A well-defined project management process, covering every phase from concept to commissioning, helps ensure smoother execution and fewer surprises.
Tools like the Critical Path Method (CPM) or schedule risk analysis are invaluable for spotting potential delays. They help teams allocate the right contingencies where needed most. Clear communication, detailed documentation, and quick resolution of issues are also key to avoiding misunderstandings and keeping everything on track. By weaving these practices into the project workflow, teams can tackle schedule risks head-on and set the stage for a successful delivery.
Supply chain disruptions can throw a wrench into data center construction schedules, primarily by delaying the arrival of essential materials and equipment. These setbacks often result in longer project timelines, increased costs, and difficulties in sticking to the original schedule.
To tackle these risks, proactive planning is key. This might involve finding alternative materials, reorganizing labor schedules, and keeping a close eye on supply chain trends. By creating contingency plans early, you can help keep projects on track, ensuring they’re completed on time and ready for seamless operation.
In data center construction projects, getting stakeholders involved early is key. It helps align the operational requirements with the construction plans, ensuring everyone is on the same page. This early collaboration lays the groundwork for realistic timelines, well-defined goals, and shared expectations.
When teams tackle potential design changes or unexpected challenges upfront, they can minimize schedule risks and sidestep expensive delays. Clear communication and teamwork from the outset build a solid base for a successful project.
