Sovereign AI data centers are redefining how organizations manage AI infrastructure, prioritizing control, security, and compliance. These facilities are purpose-built to handle high-density AI workloads, ensuring data, models, and operations remain within specific legal and physical boundaries. Here's what you need to know:
These data centers are critical for sectors like defense, finance, and national security, where operational control and compliance are non-negotiable. Addressing power, cooling, and legal requirements upfront is key to building facilities that meet performance and regulatory standards.

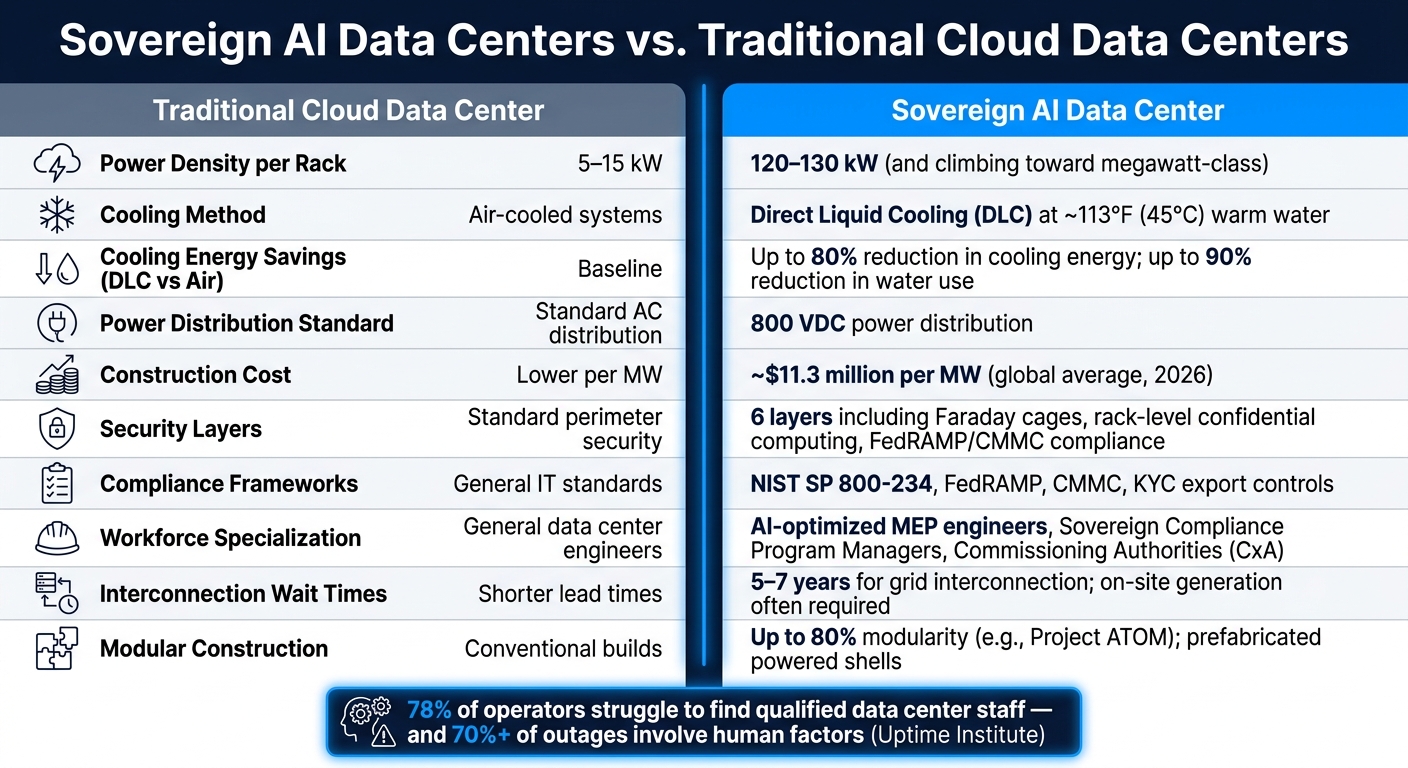

Sovereign AI Data Centers vs. Traditional Cloud: Key Specs & Requirements
Building a sovereign AI data center comes with challenges that go far beyond those of a typical cloud facility. Every decision, from power systems to cooling methods, plays a crucial role in ensuring the facility can handle the intense demands of high-density AI workloads. When constructing at this scale, there’s little room for error. Let’s dive into the key considerations for site selection and infrastructure planning.
Choosing the right location for a sovereign AI facility has become more complex. It’s no longer just about affordable land and proximity to fiber networks. Now, the focus is on power availability, cooling resources, and meeting regulatory requirements. These priorities are reshaping how developers evaluate potential sites.
"Power decides whether the campus is viable. Connectivity decides which customers it can serve." - Build Team
Developers are increasingly moving away from crowded hubs like Northern Virginia and targeting areas in the Midwest and Texas. States such as Ohio, Indiana, and Texas (ERCOT) have become hotspots for these projects, thanks to their available power capacity and appealing tax incentives. The RAND report from March 2026 highlighted the Stargate and Pantex Plant sites in Texas as prime choices due to their infrastructure and energy resources.
Water availability is another critical factor. Florida’s SB 484, effective July 1, 2026, introduced strict water usage regulations for data centers exceeding 50 MW. This led to the cancellation of a project in Fort Meade over water concerns. To avoid such issues, developers should assess water access, discharge regulations, and the feasibility of liquid cooling before committing funds. Securing a utility "Will-Serve" letter is also essential to reduce risks, especially when interconnection wait times can stretch from 5 to 7 years. Many are now considering on-site power generation options like natural gas, solar-plus-storage, or fuel cells.
The power and cooling needs of sovereign AI facilities far surpass those of traditional data centers. While standard cloud infrastructure typically operates at 5–15 kW per rack, AI racks in 2026 are hitting 120–130 kW - and climbing. This shift makes conventional air-cooled systems impractical for modern AI workloads.
"Power densities are already pushing past 120–130 kW per rack and heading toward megawatt-class racks, so air-only designs simply won't scale." - Marc Hamilton, VP of Solutions Architecture and Engineering, NVIDIA
To meet these demands, the industry is adopting two key standards: 800 VDC power distribution and direct liquid cooling (DLC). DLC systems use warm water at approximately 113°F (45°C), eliminating the need for traditional chiller plants. This approach can reduce cooling energy use by up to 80% and water consumption by up to 90% compared to air-cooled systems.
Notable projects are already showcasing these advancements. For example, "The Barn", a $16 billion Oracle/Related Digital campus in Michigan, cut its emergency generator count from 600 to just 12 by using battery storage instead of diesel generators. Similarly, in Texas, DPR Construction is managing daily installations worth $10 million at an Abilene data center, coordinating 10 buildings designed to support 400,000 NVIDIA chips using Bentley’s SYNCHRO 4D and iTwin platforms.
Mechanical, electrical, and plumbing (MEP) engineers must finalize network fabric and interconnect strategies early - ideally within the first 90 days of design. Decisions around NVLink domains and network segmentation directly impact power and cooling layouts, making late-stage changes both costly and disruptive.
Sovereign AI facilities demand advanced physical security measures. Confidential computing boundaries must be integrated at the rack level, while site plans should include security setbacks, controlled access zones, and perimeter hardening from the start.
Modular construction is also gaining momentum. Prefabricated "powered shells" allow structural and MEP components to be assembled off-site while foundational work continues on-site. This approach shortens project timelines and provides flexibility for IT infrastructure. For example, Project ATOM aims for 80% modularity to address labor shortages - a pressing issue, as 92% of construction firms reported difficulty filling roles in 2025.
"I do think that labor is going to be the biggest bottleneck. If you look out over 10 years, I think we're going to always continue to wake up where skilled labor is our biggest challenge." - Bill Stein, Data Center Revolution Podcast
With global data center construction costs projected to average $11.3 million per MW in 2026, delays are more than just inconvenient - they’re financially risky. Modular construction helps mitigate these risks by reducing exposure to weather-related setbacks and trade conflicts that can derail traditional builds.
When it comes to sovereign AI data centers, ensuring strong regulatory, security, and compliance measures is not optional - it’s essential. In the U.S., this means navigating a maze of federal regulations, state laws, and security standards. The regulatory landscape is constantly evolving, and overlooking compliance can result in costly delays. Before breaking ground, developers must understand the intersection of power, permitting, and security requirements to avoid potential pitfalls. One of the first hurdles? Data residency.
While the U.S. lacks a single federal data residency law, the state-level rules create a complicated patchwork. In 2025 alone, over 200 bills were introduced across all 50 states targeting data centers, with more than 40 being signed into law. States are stepping in to fill the federal void, and the regulations differ widely depending on the location.
Foreign ownership has become a hot-button issue in this space. For instance, in December 2025, Florida Governor Ron DeSantis unveiled a "Citizen Bill of Rights for Artificial Intelligence", empowering local governments to block data center projects tied to foreign entities. Arkansas has taken similar steps, emphasizing the need to vet ownership structures and supply chain origins early in the planning process.
Export controls add another layer of complexity. The Bureau of Industry and Security (BIS) enforces strict rules on advanced semiconductors and high-performance computing hardware. Facilities must implement Know Your Customer (KYC) protocols to prevent unauthorized access. In a notable case from July 2025, BIS imposed a $140 million penalty on a company, marking the first enforcement action based on the likelihood of a violation rather than direct evidence. As Michael H. Huneke, Partner at Morgan Lewis, aptly stated:
"Data centers and their customers are today's national security 'first responders,' expected to maintain US national security guardrails through risk-based compliance and due diligence."
Security frameworks for AI data centers have also advanced. A key milestone came in May 2026 with the release of NIST SP 800-234, a framework tailored for high-performance computing environments used in AI and machine learning. This document adapts 60 controls from the broader NIST SP 800-53 catalog to address the unique needs of AI data centers. For facilities focused on large-scale AI model training, this framework now serves as the baseline.
Data centers supporting federal agencies face additional compliance requirements, such as FedRAMP and the Department of Defense’s CMMC (Cybersecurity Maturity Model Certification). Physical security measures are becoming increasingly stringent, with frameworks calling for six layers of protection - ranging from hardware safeguards to Faraday cages designed to block side-channel attacks. Continuous AI audits are also recommended to detect potential backdoors. As Tim Fist of New America put it:
"AI data centers used to train and run the most powerful models will likely need to be secured with nation-state-level adversaries in mind."
Adding to the challenge, state-level zoning laws can disrupt construction timelines. In June 2025, Frederick County, Maryland, imposed a six-month moratorium on new data center applications. By December, zoning restrictions further limited eligible development sites. Developers must stay vigilant about local zoning changes, not just state-level legislation.
As security protocols grow more rigorous, energy and environmental regulations are also tightening to meet the demands of this sector.
Energy use remains a pressing issue. In 2023, American data centers consumed approximately 4% of the country’s electricity, with projections indicating this could rise to between 6.7% and 12% by 2028. This rapid growth has caught the attention of regulators at both federal and state levels.
At the federal level, the White House has introduced the "America's AI Action Plan" to streamline environmental permitting. This includes Categorical Exemptions under NEPA and the FAST-41 process, which aims to improve interagency coordination for large infrastructure projects. The urgency is clear:
"Existing environmental permitting structures make it almost impossible to build this infrastructure … with the speed that is required." - America's AI Action Plan
State-level regulations are also evolving, particularly around energy cost allocation. In states like California, Texas, and Minnesota, there’s bipartisan momentum to ensure data centers bear the full cost of their energy demands, rather than shifting those costs to retail ratepayers. Developers should keep a close eye on state utility tariff proposals, especially those targeting facilities with energy demands exceeding 75 MW.
Once design and compliance challenges are addressed, the next step is finding the right talent to bring these complex projects to life. Staffing shortages are now a major concern, often jeopardizing project timelines. As projects grow more intricate, having the right expertise becomes just as important as building a solid infrastructure. In fact, the Uptime Institute's 2022 Management & Operations survey revealed that 78% of operators struggled to find qualified data center staff, and 32% reported that staffing shortages had already disrupted their operations.
Sovereign AI construction projects require more than just the usual project managers and MEP engineers. These initiatives demand roles specifically tailored to sovereignty requirements, AI workload intensity, and federal security mandates. Understanding the workforce landscape is essential before assembling a team.
Here’s a breakdown of the key roles essential to tackling the unique demands of sovereign AI projects:
| Role | Primary Focus | Why It's Different in Sovereign AI |
|---|---|---|
| Mission-Critical Project Manager | Schedule, procurement, risk management | Must manage compliance and export-control risks alongside construction milestones, addressing both technical and regulatory requirements |
| AI-Optimized MEP / Power Architect | High-density power and cooling design | Handles designs for 50–100 kW+ per rack, liquid cooling systems, and GPU cluster loads, balancing technical demands with compliance needs |
| Commissioning Authority (CxA) | System validation and testing | Ensures thermal stability under AI training profiles and sovereign data isolation rules, meeting both operational and regulatory standards |
| Physical & Technical Security Lead | Physical and logical security integration | Implements federal-grade perimeter controls and network segmentation in line with FedRAMP and NIST 800-53 standards |
| Sovereign Compliance Program Manager | Regulatory alignment | Integrates data residency and classification requirements into design and construction workflows, ensuring compliance is built into every phase |
Staffing gaps in these roles often emerge during critical project phases - like design coordination, procurement of long-lead equipment, and transitioning from construction to commissioning - when schedule pressures are at their peak.
While technical expertise is essential, it’s not enough on its own. The best candidates for sovereign AI projects combine hands-on experience with resilient high-density systems - such as liquid cooling, advanced UPS setups, and medium-voltage distribution - with the ability to operate within structured commissioning and change-control processes. According to Uptime Institute's 2023 Global Outage Analysis, over 70% of data center outages involve human factors, including procedural errors and staffing gaps. This highlights the importance of prioritizing experience over credentials.
Leadership skills are equally critical. For example, a project manager who understands NEC and ASHRAE TC 9.9 but cannot effectively communicate export-control requirements to field teams risks creating compliance issues during execution. Similarly, commissioning engineers need to produce test reports that satisfy not only internal governance but also regulators and financiers. Excellence in the workforce ensures not only regulatory compliance but also timely, budget-conscious project delivery.

iRecruit.co specializes in recruiting for mission-critical industries, including data centers, energy infrastructure, defense-tech, and advanced manufacturing. Unlike traditional HR approaches, iRecruit.co integrates workforce planning into every phase of the project.
"In mission-critical construction, workforce availability is no longer a downstream consideration. It is a primary factor in whether projects stay on schedule, maintain quality, and achieve operational readiness." - iRecruit.co
Their approach emphasizes pre-qualified candidate screening. This means candidates are vetted for specific mission-critical experience, such as work on Tier III/IV or hyperscale data centers, certifications like PE, PMP, CxA, or NICET, and familiarity with AI-intensive or classified environments. iRecruit.co also supports blended staffing models, allowing teams to bring in temporary specialists during high-demand phases like systems integration or commissioning. For sovereign AI projects, where even a single staffing gap can lead to delays or compliance failures, their targeted, phase-specific recruitment strategy makes a tangible impact.
When it comes to sovereign AI data center projects, ensuring they stay on schedule and are built for the long haul is no small task. These projects deal with complex timelines, strict regulations, and ever-evolving technology. That’s why planning from the very beginning is absolutely critical.
One of the biggest risks to staying on schedule is delaying key decisions. As Hypertec Construction puts it:
"A data center schedule does not slip at the end. It slips the day decisions get deferred."
Take power availability, for instance - it’s almost always the first major hurdle. Developers need firm delivery dates for power, not vague estimates. Only power that’s already in service or confirmed by utilities with a clear scope, cost, and timeline is reliable. Anything that depends on interconnections or developer-managed supplemental power introduces serious risks to the schedule.
But power isn’t the only thing to address early. Developers must also consider factors like entitlements, water rights, noise restrictions, air permits, and fiber diversity. For example, simply having two carriers in the same physical corridor doesn’t guarantee redundancy. Catching these kinds of issues during due diligence - before construction starts - can mean the difference between a smooth project and one that grinds to a halt.
Another smart approach is prefabrication. By manufacturing components off-site while construction happens on-site, teams can cut timelines by up to 50%. However, this only works if design interfaces are finalized early and changes are tightly controlled. For sovereign AI projects, where long-lead items like transformers and liquid cooling hardware are involved, treating procurement as a key strategy (not just an administrative task) is a must.
Advanced tools like SYNCHRO 4D and NVIDIA Omniverse DSX are also game-changers. They let teams simulate things like airflow and electrical loads before construction even begins, helping to identify potential conflicts early.
These early steps set the stage for facilities that can handle the growing demands of AI.
Sovereign AI facilities need to be ready not just for today’s technology but for the next two or three generations. With power densities now exceeding 120–130 kW per rack, air-only cooling is no longer enough. Designing for hybrid or full liquid cooling from the start is now the standard for facilities expected to last a decade or more.
By planning the building envelope, cooling systems, and power infrastructure with future upgrades in mind, operators can turn GPU-tray updates into routine maintenance rather than major construction projects. Marc Hamilton, VP of Solutions Architecture and Engineering at NVIDIA, explains:
"If the building shell, liquid‑cooling loops, and 800 VDC backbone are designed to spec, then a GPU‑tray refresh becomes a maintenance event, not a construction project."
Using modular architectures like NVIDIA’s DGX SuperPOD also helps. These pre-validated building blocks make scaling up easier without constant redesigns. A great example is the "Deutschland Stack", a sovereign AI facility Deutsche Telekom began building in March 2026. This billion-euro project in Munich uses nearly 10,000 NVIDIA Blackwell GPUs in a modular setup, enabling strict multi-tenant isolation while supporting shared high-performance acceleration for both public and private sectors.
To accommodate future growth, structural and mechanical systems should be designed to handle a 2–3x increase in density over the facility’s lifetime. This requires phased capacity modeling, where each phase of the project is treated as a separate delivery. This way, phase one can remain fully operational even as phase two is under construction.
Even the best-designed facility can face delays if the right people aren’t in place during critical phases. Transitions like moving from design to procurement or from construction to commissioning are especially tricky, as they demand tight coordination.
Experienced project managers who understand construction sequencing and sovereign compliance can spot procurement issues early. Likewise, commissioning engineers with Tier III/IV or hyperscale experience know how to implement test plans that prevent small problems from becoming major delays. As Hannu Lindberg, Construction Technology Leader at DPR Construction, explains:
"The expectation is to deliver quick wins while sustaining performance over the long haul."
To address these challenges, iRecruit.co uses a phase-specific recruitment model. By bringing in pre-qualified specialists during high-pressure phases - whether for systems integration, commissioning, or regulatory closeout - teams can avoid the setbacks that come with hiring generalists mid-project. For sovereign AI projects, even one staffing gap can lead to compliance issues or missed energization deadlines, making targeted recruitment a key part of staying on schedule.
Sovereign AI data centers rely on a mix of advanced construction techniques, rigorous compliance measures, and specialized expertise - each playing a crucial role in ensuring project success. Recent examples, like Canada’s 100MW+ compute initiative, highlight how this is becoming a priority for many organizations. With little room for error, success hinges on seamlessly integrating infrastructure, compliance, and talent right from the beginning.
"Organizations that focus exclusively on infrastructure often discover they have solved the easiest part of the problem while leaving the harder parts (model governance, talent, data quality, testing adaptive systems) unaddressed."
Key factors like power density, cooling systems, data residency requirements, and critical hiring decisions must be tackled as a unified effort from the outset. Proper alignment of these elements ensures timely and scalable deployments. For more detailed insights into how workforce strategies tie into project delivery in such environments, check out the data center construction guide available at iRecruit.co. It offers practical advice for construction professionals managing these intricate projects.
A sovereign AI data center operates entirely within a nation's borders, both legally and physically. This setup ensures that all aspects - data, models, inference processes, and infrastructure - are exclusively managed without relying on foreign technology or outside entities. By doing so, it guarantees adherence to local laws and security standards, while maintaining full control over essential operations.
Teams maintain compliance with data residency and export-control requirements by implementing detailed audit trails, enforcing strict data governance policies, and ensuring infrastructure and operations remain within jurisdictional boundaries. They support these efforts through continuous monitoring, comprehensive documentation, and, when necessary, external validation to meet regulatory standards.
The delays in sovereign AI data center schedules often stem from a lack of specialized skilled labor. Key roles like electricians, project managers, and experts in liquid cooling or high-density thermal management are particularly hard to fill. This issue is largely fueled by widespread labor shortages across the industry, a wave of retirements, and not enough new talent stepping into these essential positions.
