AI-focused data centers are transforming construction management due to skyrocketing power demands, advanced cooling systems, and dense infrastructure requirements. Traditional methods no longer suffice as server racks now consume up to 300 kW, with projections reaching 600 kW per rack. This shift brings challenges in power availability, cooling technologies, and staffing specialized roles.
Key takeaways:
With 446 new data centers planned in North America by 2030 and costs averaging $20 million per MW, firms must secure talent early and prioritize efficient workflows to meet tight timelines.

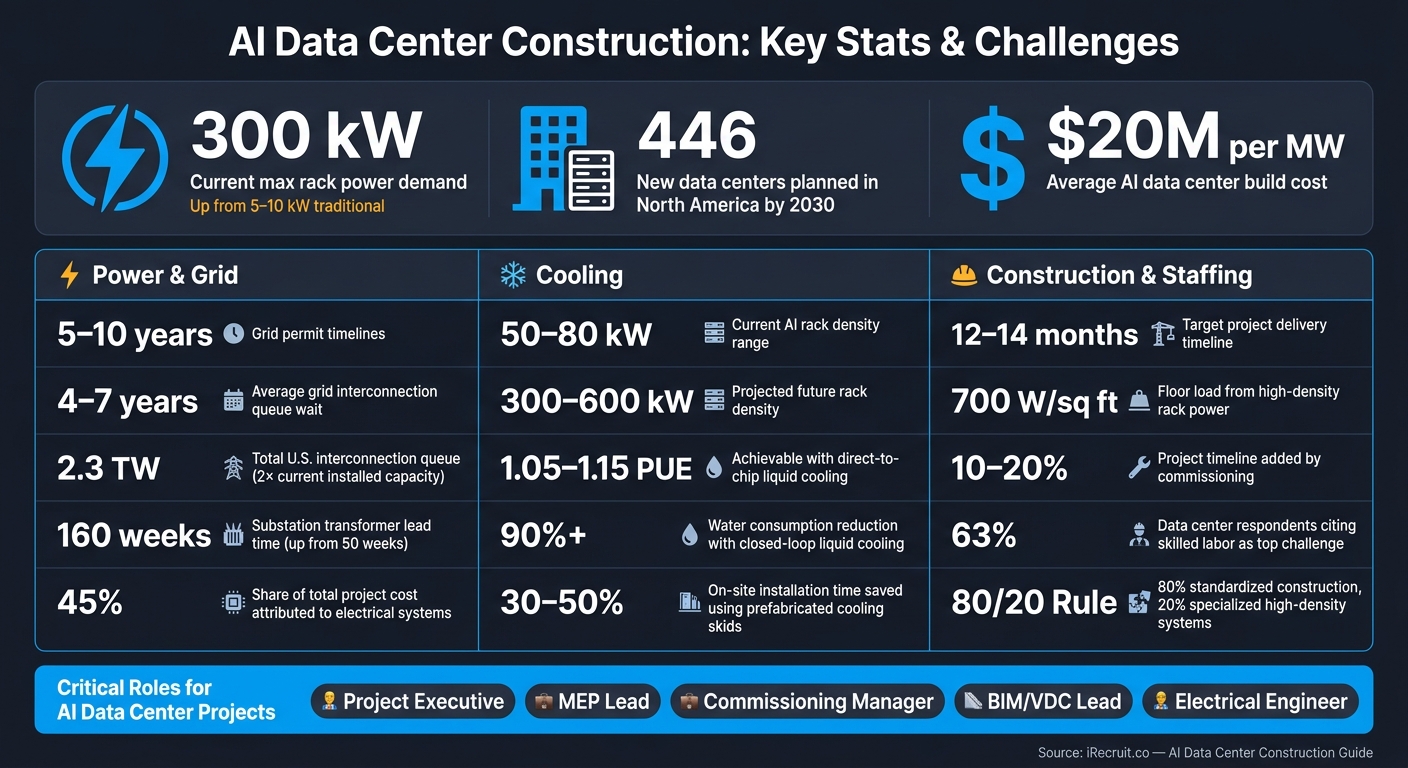

AI Data Center Construction: Key Stats & Challenges at a Glance
Power requirements are now at the heart of every AI data center project. Rack densities, which used to range from 5–10 kW, have soared to 50–100 kW, with future GPUs potentially requiring up to 1 MW per rack. For construction managers, understanding the impact of power and energy infrastructure is no longer optional - it's essential.
AI data centers are built in 18–36 months, but securing power grid permits can take 5–10 years. On top of that, grid interconnection queues now average 4–7 years, with the U.S. interconnection queue totaling about 2.3 TW - twice the nation’s current installed generation capacity.
"The issues outside of the queue are the biggest obstacle we face to bringing projects online." - Jeff Shields, Senior Manager of External Communications, PJM
This backlog is forcing developers to rethink site selection. Areas like Northern Virginia, long-time data center hubs, are nearing grid capacity, driving interest in locations such as Texas and Georgia, where power availability is less constrained. To bypass delays, some operators are turning to behind-the-meter solutions. For instance, in September 2025, Microsoft partnered with Constellation Energy in a $16 billion deal to revive Pennsylvania’s Three Mile Island nuclear plant, securing 835 MW of clean energy for its AI data centers. Similarly, Google announced a $25 billion investment in regional data center infrastructure, including a $3 billion hydropower deal in Pennsylvania, to ensure off-grid power reliability.
Construction teams are also adopting phased energization strategies - bringing facilities online in stages while waiting for grid transmission upgrades. These evolving practices highlight the need for a fresh approach to internal electrical design.
Grid challenges aside, internal power systems are facing mounting pressure. High-density AI workloads demand reimagined electrical designs, with electrical systems now accounting for up to 45% of total project costs. Long lead times for critical components are another hurdle: substation transformers, which once took about 50 weeks to procure, now require over 160 weeks. Similarly, switchgear lead times have climbed to around 52 weeks.
Emerging technologies like high-capacity busways, larger UPS systems, and 800V DC distribution architectures - expected in nearly half of new facilities by 2028 - add further complexity. Even commissioning, which can take up 10–20% of the project timeline, becomes a bottleneck if understaffed, delaying revenue from facilities that cost around $20 million per megawatt to build.
Overcoming these challenges requires a mix of technical innovation and strategic staffing. Prefabrication, early procurement, and modular construction are proving to be effective strategies. Prefabricated electrical rooms and modular power skids - complete with preassembled transformers, switchgear, and UPS systems - allow construction teams to work in parallel, reducing on-site labor needs. A standout example is the partnership between CyrusOne and Eolian for the DFW7 campus in Fort Worth, Texas. By repurposing high-voltage infrastructure from a 100 MW battery energy storage system, the project broke ground in April 2025 and aimed to deliver capacity by 2026, avoiding lengthy grid interconnection delays.
On the staffing front, these projects require specialized roles unfamiliar to traditional data center construction. Electrical project managers who can track long-lead equipment are indispensable, as are utility coordination experts skilled in navigating regulatory hurdles. As Francesco "Frio" Iorio, CEO of Augmenta, notes:
"Electrical is the biggest spend in the data center … it can be 45% of the entire spend on the project."
Firms that prioritize power infrastructure and assemble the right teams are better equipped to meet the demanding timelines of AI data center construction.
With rack densities hitting 50 kW–80 kW and projections soaring to 300–600 kW, traditional air cooling systems are no longer sufficient. As Data Center Frontier aptly stated:
"Air cooling alone can no longer keep pace, and liquid cooling has rapidly become a foundational requirement, not a specialty solution."
This evolution has significant implications for construction managers, reshaping how facilities are designed, built, and staffed. Familiarity with liquid cooling systems is now a baseline requirement for modern data center projects.
Liquid cooling solutions like direct-to-chip (DTC) cooling, rear-door heat exchangers, and immersion cooling each come with unique construction demands. For instance, DTC cooling requires the integration of cooling distribution units (CDUs), reinforced concrete slabs to support heavier racks, and extensive piping systems. These setups necessitate precise coordination between trades and can streamline construction by eliminating the need for raised floors and cold aisle containment, freeing up ceiling space and cutting certain costs.
Closed-loop liquid cooling systems are another game-changer, reducing water consumption by over 90% compared to evaporative cooling. However, they come with a trade-off: increased electrical power requirements for the facility.
Commissioning these advanced systems can extend project timelines by 10–20%. This step involves simulating full IT loads and rigorously testing mechanical and electrical systems under real-world conditions. Sean Maguire, SVP and Global Head of Data Center Strategy at Black Box, highlighted the challenges:
"The steepest challenge was skills. Most local contractors had never worked with CDUs or liquid cooling systems. On-site training proved vital for system activation."
These adjustments underscore the importance of aligning cooling strategies with overall project goals, as cooling choices directly impact efficiency and timelines.
Power Usage Effectiveness (PUE) is a key metric driving the selection of cooling systems in AI data centers. Achieving low PUE values, such as the 1.05–1.15 range possible with DTC liquid cooling, requires a comprehensive approach to facility design. Phill Lawson-Shanks, Chief Innovation and Technology Officer at Aligned Data Centers, emphasized this point:
"You have to start thinking about the whole building as a cohesive system. Not separate layers reacting to each other."
This cohesive approach means integrating cooling controls with building management systems to prepare for incoming AI workloads. Liquid-cooled systems are particularly sensitive to disruptions, with even brief interruptions risking equipment damage. To address this, thermal storage tanks are often incorporated into cooling loops, ensuring thermal stability during equipment failures.
The complexity of liquid cooling systems is reshaping hiring priorities in data center construction. Mechanical engineers are increasingly required to handle tasks traditionally managed by electrical engineers during commissioning due to a shortage of specialists. John Diamond, Principal at Strategic Facility Advisors, noted:
"The electricity demands for server racks and cabinets are rising from 100 kilowatts now... to 300 kilowatts – and potentially 600 kilowatts in a few years."
To meet these demands, projects now seek professionals with hands-on experience in liquid cooling. This includes mechanical project managers, MEP specialists skilled in coordinating dense piping layouts, and commissioning engineers capable of balancing thermal and electrical systems under live workloads. Engaging cooling technology experts early in the design phase can also help avoid costly rework during installation.
One solution to the labor gap is prefabricated cooling skids. These modular units allow much of the assembly to occur off-site, reducing on-site installation time by 30–50% compared to traditional methods. This shift not only speeds up construction but also ensures higher precision in system assembly, addressing the growing complexity of AI-focused data centers.
The move toward liquid cooling has completely changed how AI data centers are built. With rack densities skyrocketing from the traditional 5–10 kW to a staggering 30–100 kW per rack, construction methods have had to adapt quickly. This shift has a direct impact on both structural planning and mechanical, electrical, and plumbing (MEP) systems.
AI racks are not only heavier but also generate significantly more heat compared to conventional equipment. With power densities reaching 700 watts per square foot, the load on floor slabs, support columns, and overhead systems has increased dramatically. Structural engineers now need to account for the combined weight of these racks and the additional mechanical systems that share the same space.
This dense concentration of infrastructure leaves little room for error. Even a minor mistake - like a misaligned floor embed or an incorrectly placed conduit sleeve - can create a domino effect, delaying multiple trades. Duane Gleason, Industry Workflow Director at Trimble, explains:
"A layout mistake, such as an incorrect embed location or misplaced sleeve doesn't simply cause rework; it disrupts thousands of downstream tasks across multiple trades."
To handle these challenges and meet tight delivery timelines of 12–14 months, modular construction has become essential. The 80/20 rule is a common strategy: standardize 80% of the construction process, such as site work and structural components, so that the remaining 20% - focused on high-density power and cooling systems - gets the specialized attention it needs.
Prefabricated MEP modules play a key role in this approach. For example, power skids containing transformers and switchgear can be built off-site and installed independently from cooling systems or IT pods. This allows multiple teams to work simultaneously, speeding up the schedule and reducing the risk of supply chain delays. In some cases, phased hall designs and standardized compute pods allow temporary server setups, enabling AI training to begin even before the entire facility is completed. Using LOD 400/500 BIM models ensures that prefabricated pipes, conduits, and cable trays fit precisely into the limited overhead space.
For a deeper dive into these strategies, check out iRecruit.co's data center construction guide.
With modular construction and high-density demands, labor strategies have also evolved. These workflows shift the focus from on-site labor to skilled specialists who can manage integrated systems within tight timelines. According to 63% of data center respondents, the lack of skilled labor remains the top challenge.
Superintendents on these projects must now oversee complex system integrations under compressed schedules. Field engineers are expected to use advanced tools like robotic total stations and 3D laser scanners to ensure prefabricated components meet exact tolerances. Additionally, BIM/VDC specialists who can produce detailed LOD 400/500 models are now a standard requirement, especially for projects where overhead spaces are packed with MEP systems.
Recruiting these specialized roles early is critical for keeping projects on track and maintaining quality.
When it comes to AI data centers, success hinges on seamless integration of power, cooling, and IT systems from the very start. These facilities aren't just buildings - they're intricate ecosystems where delays in one area ripple across the entire project. As The Birmingham Group succinctly puts it:
"The electrical timeline does not sit next to the schedule. It is the schedule."
This reality has made tools like a Common Data Environment (CDE) indispensable. A CDE functions as a shared digital workspace, linking design, fabrication, and on-site installation in real time. This approach prevents costly mistakes caused by outdated plans. Considering that electrical systems alone can consume up to 45% of a project's total budget, precise coordination isn't just helpful - it's mandatory.
To tackle the challenges of high-density power demands, advanced cooling technologies, and modular construction, commissioning managers and facility operations teams must be embedded in the process early. Their involvement - well before equipment handover - ensures that potential issues are addressed proactively. For a deeper dive into how integrated delivery frameworks work in mission-critical projects, check out iRecruit.co's construction project delivery guide.
Ultimately, success in system integration depends on assembling a construction management team with the right expertise, as detailed below.
With 446 new data centers expected in North America by 2030 and project timelines shrinking to just 12–14 months, the demand for experienced construction leaders is fierce. The specialized nature of AI data center projects means that general construction experience often isn’t enough.
Here’s a breakdown of the key roles and why they’re essential:
| Role | Why It Matters on AI Data Center Projects |
|---|---|
| Project Executive | Oversees portfolio-level risks and ensures adherence to tight 12–14 month schedules |
| MEP Lead | Manages dense mechanical/electrical rooms and ensures proper integration of liquid cooling systems |
| Commissioning Manager | Conducts full IT load simulations and verifies the performance of interconnected systems |
| BIM/VDC Lead | Creates detailed LOD 400/500 models and oversees robotic field layout for precision |
| Electrical Engineer | Designs systems capable of supporting 300kW+ rack densities and handles complex power distribution needs |
Securing these roles early in the process is non-negotiable. Competitive salaries are key, as the market for skilled mission-critical professionals moves quickly. Firms that hesitate risk losing top candidates. iRecruit.co specializes in connecting construction firms with pre-qualified talent across all these critical roles, streamlining the hiring process for mission-critical projects.
The labor market is so tight that some companies are transitioning expert electricians from fieldwork into office-based digital design roles, highlighting the growing demand for both technical and digital skills. Building a team with the right mix of hands-on experience and technical expertise is what sets successful projects apart from those that fall behind schedule.
AI data centers are reshaping how construction management operates. Power delivery, cooling systems, and high-density infrastructure aren't just considerations - they're the core of every project. With global data center construction costs expected to reach $11.3 million per MW by 2026 and AI-related power demand anticipated to hit 123 GW by 2035, precision and efficiency have become essential.
To tackle these challenges, top firms are embracing proactive strategies. They focus on early procurement, lock in electrical layouts, and integrate commissioning teams from the outset. Additionally, they rely on a connected construction workflow to ensure that all trades stay in sync in real time. As Brandon Michalski, Principal Economist at MSI Economics, explains:
"Firms must anchor their planning in real-time capital deployment, project-level data, and the realities of grid interconnection queues, labor bottlenecks, and equipment lead times."
But even the most advanced workflows depend on skilled professionals to bring AI data center designs to life. The talent shortage is becoming a growing concern, particularly for roles like project executives, MEP leads, commissioning managers, and BIM/VDC specialists with direct AI data center experience. Companies that act quickly, offer competitive compensation, and secure top talent will stay on track. Those that don’t risk delays and complications.
iRecruit.co specializes in helping mission-critical construction firms fill these high-demand roles - from project executives to commissioning managers - ensuring teams are equipped to meet the demands of AI-driven projects from the very beginning.
Teams can sidestep lengthy grid interconnection delays by taking a proactive approach. Starting power-related discussions early ensures potential issues are identified upfront. Opting for sites with strong grid capacity can also prevent bottlenecks. Additionally, using advanced scheduling tools to monitor and manage the interconnection process helps keep everything on track. Early planning and smart site selection are crucial for keeping delays to a minimum.
Liquid cooling stands out as a go-to solution for high-density racks and tight project timelines because of its ability to manage high power densities efficiently. Methods like direct-to-chip cooling and immersion cooling are particularly effective at drawing heat away from densely packed computing hardware. Modular liquid cooling systems add another layer of convenience - they're designed to scale up and integrate seamlessly into existing infrastructures. This makes them an excellent choice for quick deployment, especially in AI-focused data centers with demanding cooling needs.
The toughest positions to staff in AI data center construction are electricians, engineers, and utility coordination specialists. Why? There's a noticeable lack of skilled professionals in these areas. These roles are essential for handling the unique demands of AI data centers, such as their massive power needs, advanced cooling technologies, and intricate infrastructure.
