May 21, 2026

Data Center Construction Management: What Owners Should Expect from Their CM Firm

By:
Dallas Bond

Building a data center is not just about construction - it’s about creating a highly interconnected system where power, cooling, and controls work flawlessly. A small error can lead to millions in losses, so choosing the right construction management (CM) firm is critical. Here’s what you, as an owner, should expect from a CM firm:

  • Planning and Governance: Clear project priorities, risk tracking, and managing permits with local authorities.
  • Vendor Coordination: Overseeing specialized contractors, managing long-lead equipment, and avoiding delays with tools like BIM.
  • Commissioning: Testing all systems in stages, from factory tests to full-load simulations, ensuring readiness before handover.
  • Preconstruction Essentials: Site selection, budgeting with risk scenarios, and scheduling around key equipment timelines.
  • Risk Management: Identifying issues early, addressing handoff gaps, and preventing disruptions in live environments.
  • Procurement Strategies: Prequalifying vendors, securing critical equipment, and leveraging prefabrication to save time.
  • Contracting Models: Options like GMP, lump sum, or design-build, tailored to your project’s complexity and control needs.

Bottom line: A CM firm must have technical expertise, a proven track record, and the ability to manage risks while meeting tight deadlines. Owners should also build a strong internal team to oversee the process and ensure accountability.

Data center construction resources

Successful delivery also depends on the competencies of mission-critical construction managers who oversee these complex builds.

Core Responsibilities of a Data Center CM Firm

A construction management (CM) firm working on a data center project handles much more than just schedules and budgets. With power, cooling, and control systems so closely connected, the CM firm ensures that every element - from design review to final testing - works together seamlessly. This level of coordination helps owners set realistic expectations before contracts are signed. Let’s break down the key responsibilities that make this possible.

Project Planning and Governance

Good planning starts long before construction begins. A CM firm takes business goals and translates them into clear design and execution priorities. They define roles, establish decision-making authority, and create escalation paths to resolve issues quickly. Managing relationships with the Authority Having Jurisdiction (AHJ) - the local agencies responsible for permits and inspections - is another critical task, as it helps reduce permitting risks.

One often overlooked responsibility is maintaining a live risk register. This is a constantly updated log that tracks potential risks to cost, schedule, and technical performance. By identifying issues early, the CM firm helps keep the project on track. Once governance is set, the next step is coordinating vendors and planning project phases.

Vendor Coordination and Project Phasing

Data center projects bring together a wide range of specialized vendors, including electrical and mechanical contractors, IT providers, utility companies, commissioning agents, and sustainability consultants. The CM firm manages the entire vendor process - from issuing RFPs to evaluating proposals - and ensures work is scheduled so no single trade causes a bottleneck.

Tracking Owner-Furnished, Contractor-Installed (OFCI) equipment like generators, UPS systems, and switchgear is another key task. With lead times often stretching 36 to 48 weeks, even small delays can become expensive. To avoid costly mistakes, CM firms use tools like Building Information Modeling (BIM) and clash detection to sort out routing conflicts - like those between conduit, chilled-water piping, and fire-suppression systems - before construction starts.

"In a data center environment, [CM] responsibilities still matter, but they carry more technical weight. A missed handoff between electrical and mechanical teams can affect commissioning." - Broadstaff Global

Commissioning and Facility Readiness

Commissioning is where all the planning and coordination come together. A skilled CM firm treats commissioning as a comprehensive process, starting during design and continuing through the handover to operations.

"Commissioning isn't a checkbox - it's the ultimate test of everything built to that point." - KGO

The process unfolds in four stages: factory witness testing of critical equipment at the manufacturer, on-site component-level verification, system-level failure mode simulations, and finally, Integrated Systems Testing (IST). During IST, the entire facility operates at full design load under simulated power-loss conditions. Delays at this stage can be extremely costly - commissioning delays for a 60 MW facility, for example, can result in $14.2 million per month in lost revenue and other impacts.

Once testing is complete, the CM firm hands over a full turnover package to the operations team. This includes as-built drawings, O&M manuals, warranties, and hands-on training to ensure the facility is ready for use.

What to Expect During Preconstruction and Planning

The preconstruction phase is where the foundation for a project's success is laid. A skilled Construction Management (CM) firm treats this stage as critical, ensuring everything is meticulously planned before construction begins. For project owners, understanding the essentials of this phase can make a world of difference when it comes to holding teams accountable. This phase also sets the stage for key decisions, like site selection and feasibility analysis. If you're curious about how delivery methods influence this process, check out the data center construction guide.

Site Selection and Feasibility Studies

Choosing the right site isn't just about finding affordable land - it’s about ensuring the infrastructure can support the project’s needs. Power access is a top priority. CM firms assess proximity to high-voltage transmission lines, substation capacity, and the timeline for utility interconnection. In some parts of the U.S., grid connection wait times can stretch beyond four years. For high-demand areas like Northern Virginia, delays in interconnection can lead to losses exceeding $500,000 per month in net operating income.

A thorough site evaluation also considers factors like:

  • Fiber path diversity: Ensures reliable connectivity.
  • Geotechnical conditions: Assesses soil stability and seismic risks.
  • Floodplain proximity and ambient temperature: Impacts cooling strategies and long-term Power Usage Effectiveness (PUE).

Regulatory concerns, including zoning laws, EPA storm-water compliance, and local noise ordinances, are addressed early to avoid costly setbacks. One key deliverable at this stage is a "will serve" letter from the utility, which confirms power availability. This letter is often required by lenders and ensures the project timeline stays on track.

Budgeting and Cost Transparency

Decisions made during preconstruction directly impact risk management and financial controls later on. A reliable CM firm prepares budgets with three risk scenarios - high, mid, and low - allowing for flexibility in the face of price changes or scope adjustments. Typical data center construction costs range from $8 million to $12 million per megawatt (MW) of IT load. Liquid-cooled facilities, often used for AI workloads, cost about 10% more due to the additional infrastructure required.

Transparency is key. The budget should include open-book tracking with monthly updates on commodity prices, labor rates, and utility costs. To prevent crises, escalation triggers for high-cost items like steel, transformers, and HVAC equipment should be built into the budget. This allows the team to adjust through contingency funds or value engineering before costs spiral out of control. Owners should also expect clear terms regarding Owner-Furnished, Contractor-Installed (OFCI) equipment, including deposit requirements to secure pricing for long-lead items.

Scheduling and Long-Lead Equipment Procurement

Once the budget is set, scheduling becomes the next critical focus. Missteps here can lead to significant delays. A common mistake in data center projects is assuming the building shell is the main schedule driver - it rarely is. Instead, the real bottlenecks often involve utility interconnection, substation construction, and factory acceptance testing (FAT) for major equipment.

Key equipment lead times include:

Equipment Type Typical Lead Time Key Scheduling Step
Generators 12–18 months Factory Witness Testing (FAT)
Transformers 12–18 months Utility Coordination / Substation Prep
Switchgear 25–55 weeks MEP Coordination / Access Routing
UPS Systems 25–55 weeks Battery Room Readiness / BESS Integration
Chillers 25–55 weeks Piping Tolerances / Pressure Testing

A capable CM firm keeps a close eye on delivery schedules and factory progress. Separate procurement agreements for owner-furnished equipment help clarify responsibilities for payment, shipping, and installation. In high-growth regions, permitting can add another six to 12 months to the timeline. To avoid delays, the best CM firms engage utilities and local authorities early - during the concept design phase - rather than waiting until design documents are finalized.

Risk Management and Cost Controls

Data Center Contracting Models: GMP vs Lump Sum vs Cost-Plus vs EPC vs Design-Build

Data Center Contracting Models: GMP vs Lump Sum vs Cost-Plus vs EPC vs Design-Build

Managing risk and controlling costs are key to ensuring that mission-critical data centers are both operationally ready and perform well over the long term. Even the most carefully planned data center project can falter without a disciplined approach to these areas. Once schedules and procurement plans are set, a construction management (CM) firm's job is to ensure the project stays on track.

Risk Identification and Contingency Planning

Top-tier CM firms don't wait for problems to arise - they actively identify risks. One tool they rely on is a risk register, which tracks potential threats and outlines clear strategies to address them.

One commonly overlooked risk in data center construction is the "handoff gaps" between electrical, mechanical, and controls teams. These gaps can lead to confusion about accountability, often resulting in commissioning delays and costly rework. CM firms tackle this issue by conducting pull-planning sessions with trade partners. By working backward from the commissioning date, they ensure that long-lead equipment deliveries align with the project's critical path.

The risk landscape becomes even trickier for projects near live data halls. Here, CM firms use real-time vibration monitoring and negative-pressure work tents to prevent dust from damaging active equipment. Additional measures, such as isolation zones and multi-layer badge access, separate construction from ongoing operations. The stakes are high - mismanaging these risks can lead to liquidated damages ranging from thousands to tens of thousands of dollars per day.

"A delayed data center is not just a late building. It may mean delayed customer capacity, delayed cloud or AI workloads, delayed revenue, and missed market timing." - Broadstaff Global

Once risks are identified and mitigation plans are in place, the focus shifts to securing critical equipment through a disciplined procurement process.

Procurement Strategies for Critical Equipment

Procurement can make or break a mission-critical construction project. Successful CM firms prequalify subcontractors before work begins, evaluating them on factors such as pricing, experience with data center-specific tolerances, compliance with U.S. safety standards, and their ability to perform factory acceptance testing on major equipment.

Prefabrication plays a growing role in efficient project execution. By manufacturing components like cooling skids and electrical raceways off-site, CM firms reduce congestion at the construction site and streamline schedules. Clear contracts are vital, specifying who is responsible for procuring, transporting, offloading, installing, and testing each piece of specialized equipment.

In addition to procurement, selecting the right contracting model is another way to manage risk effectively.

Contracting Models and Owner Expectations

The choice of contract structure has a big impact on how risks are distributed throughout a data center project. There’s no universal solution - it depends on the level of control the owner wants and how clearly the project scope is defined. Well-structured contracts help allocate risks appropriately and keep projects on schedule.

Here’s a look at some common contracting models used in U.S. data center construction:

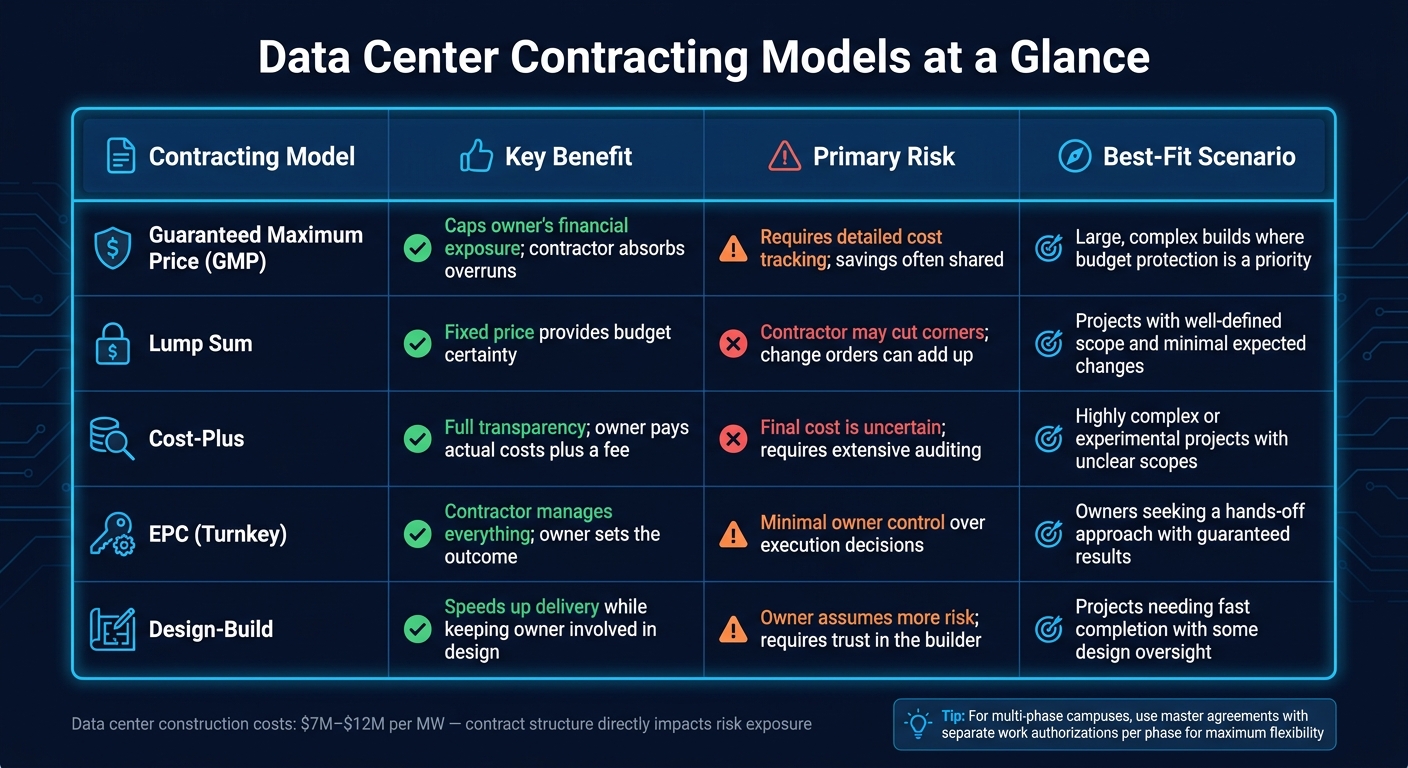

Contracting Model Key Benefit Primary Risk Best-Fit Scenario
Guaranteed Maximum Price (GMP) Caps owner's financial exposure; contractor absorbs overruns Requires detailed cost tracking; savings often shared Large, complex builds where budget protection is a priority
Lump Sum Fixed price provides budget certainty Contractor may cut corners; change orders can add up Projects with a well-defined scope and minimal expected changes
Cost-Plus Offers full transparency; owner pays actual costs plus a fee Final cost is uncertain; requires extensive auditing Highly complex or experimental projects with unclear scopes
EPC (Turnkey) Contractor manages everything; owner sets the outcome Minimal owner control over execution decisions Ideal for owners seeking a hands-off approach with guaranteed results
Design-Build Speeds up delivery while keeping owner involved in design Owner assumes more risk; requires trust in the builder Projects needing fast completion with some design oversight

For multi-phase campuses, master agreements with separate work authorizations for each phase provide flexibility. If the first phase doesn’t meet expectations, this approach allows for a clean exit without renegotiating every term.

Two often-overlooked contract provisions are liquidated damages (LDs) and force majeure clauses. LDs should reflect a realistic daily estimate of potential losses, such as extra financing costs, consultant fees, or SLA penalties, rather than an inflated figure that might be unenforceable. Similarly, force majeure clauses should specifically address supply chain disruptions and geopolitical events, as vague terms like "acts beyond control" may not hold up in today’s legal landscape.

How to Evaluate a CM Firm for Data Center Projects

Choosing the right Construction Management (CM) firm for a data center project requires a thorough evaluation of their expertise and track record. With data center construction costs ranging from $7 million to $12 million per megawatt, there’s little room for error. General construction experience isn’t enough - owners need a firm that specializes in mission-critical projects.

Technical Expertise in Mission-Critical Facilities

Start by examining the firm’s MEP (mechanical, electrical, and plumbing) capabilities. These systems drive the critical path in data center construction, and a lack of in-house MEP coordination can lead to costly risks. Ask the firm directly: How many megawatts of data center capacity have you delivered in the last three years? Do you self-perform MEP coordination, or is it subcontracted?

Additionally, look for experience with high-density power and cooling systems. This includes expertise in UPS configurations, switchgear, backup generators, and advanced cooling solutions like direct-to-chip liquid cooling or rear-door heat exchangers. With AI workloads pushing power densities higher, firms without this background may fall behind.

Equally important are digital coordination tools. The firm should use software like Navisworks or Revit for federated-model reviews to identify design clashes before equipment arrives on-site. Also, verify their adherence to cybersecurity standards, such as NIST CSF 2.0, to safeguard building automation systems and IoT devices.

Technical expertise is the foundation, but a firm’s track record and team qualifications are just as critical.

Track Record and Team Qualifications

A firm’s portfolio reveals its experience, but the qualifications of the team running your project are just as important. When reviewing their track record, request:

  • Documented megawatts completed in the last 36 months.
  • Sample Integrated Systems Test (IST) reports from previous projects.
  • Validated Power Usage Effectiveness (PUE) data from finished facilities.

Here’s a quick breakdown of what to demand during evaluation:

Vetting Category Key Proof Point to Demand
Experience Megawatts delivered in the past three years
Safety Experience Modification Rate (EMR) below 1.0
Technical Self-performed MEP coordination and BIM/VDC expertise
Validation IST reports from completed projects
Cybersecurity Compliance with NIST CSF 2.0 standards

Pay close attention to the commissioning manager. This individual is responsible for overseeing all four levels of testing - factory witness tests, component testing, system testing, and integrated systems testing. They should be involved from the preconstruction phase, not brought in as an afterthought.

"A data center is only successful when systems perform under load, redundancy behaves as designed, and commissioning validates operational readiness." - iRecruit.co

The right team is just as important as technical expertise.

Using Specialized Recruiting to Build Your Owner-Side Team

Even with a top-tier CM firm, success also depends on having a strong owner-side team. Without proper oversight, issues like scope creep, phase handoff gaps, and field problems can spiral into costly delays.

Finding qualified construction managers with mission-critical experience can be tough, especially in high-demand regions like Northern Virginia, Central Texas, and the Southwest. Salaries for data center construction managers typically range from $105,000 to $175,000 annually, with total compensation (including bonuses and per diems) often reaching $180,000 to $220,000.

This is where specialized recruiting comes in. Firms like iRecruit.co, founded by Dallas Bond and Tanya Runholt, focus exclusively on recruiting for mission-critical facilities. Their process includes technical interviews covering redundancy configurations, clean build protocols, and phased energization sequences, ensuring candidates are prepared for the unique challenges of this field.

Key roles to fill on the owner’s side include:

  • Owner’s Representative
  • MEP Manager
  • Commissioning Lead
  • QA/QC Inspector

Hire these positions during the preconstruction phase to avoid costly mistakes later.

"Hiring a PM isn't simply filling a position; it's an investment in your data center's lasting success." - JLL

Conclusion: Choosing the Right CM Firm for Your Data Center Project

For data center owners, partnering with a construction management (CM) firm that can handle mission-critical demands isn't just important - it's essential. With global data center construction spending surpassing $59 billion annually and load growth projected to double or even triple by 2028, mitigating schedule risks is essential, as any delay can mean lost revenue, diminished customer trust, and missed market opportunities.

The data shows that the best-performing CM firms share some key qualities. They consistently excel in cost management, scheduling, and ensuring operational readiness. How? By combining deep mechanical, electrical, and plumbing (MEP) expertise, disciplined procurement processes, integrated commissioning, and strong governance. These elements are critical for success in mission-critical environments. However, even with a top-tier CM firm, having a capable owner-side team is just as important.

The owner-side team plays a pivotal role in overseeing and challenging the CM firm’s work. Even the most skilled CM firm needs a knowledgeable counterpart - someone who can ask tough questions, identify potential issues early, and hold all vendors accountable.

"In data center construction, talent availability directly affects execution risk. This is especially true for leadership roles that sit at the intersection of systems, schedule, and stakeholder coordination." - iRecruit.co

This is where specialized recruiting partners like iRecruit.co come in. Founded by Dallas Bond and Tanya Runholt, iRecruit.co focuses on pre-qualifying and placing skilled professionals, including project managers, MEP specialists, commissioning engineers, and QA/QC experts, all with mission-critical experience. By assembling these teams before construction begins, they help owners avoid problems down the line and ensure that oversight is in place from day one - not after issues arise.

FAQs

What deliverables should I require from a CM firm before construction starts?

Before starting construction, data center owners should insist on a detailed project framework from their construction management (CM) firm. This framework should cover several critical elements, including:

  • A master schedule that outlines key milestones.
  • A risk register to identify and monitor potential risks.
  • A procurement plan focused on securing long-lead equipment.
  • A commissioning plan to ensure systems are tested and operational.
  • A site-readiness assessment to confirm the location is prepared for construction.
  • A budget tracking system to monitor financial progress.

On top of these, the framework should also include a staffing plan, a strategy for selecting contractors, and clear protocols for design coordination, permitting, and quality assurance. These components help ensure the project stays on track and meets all necessary standards.

How can I reduce long-lead equipment and utility interconnection delays?

To avoid delays, it's essential to factor in long-lead equipment and utility interconnections during the pre-construction phase. These items should be identified early and treated as critical path dependencies in your master project schedule. With delivery timelines often ranging from 9 to 18 months, make sure your construction management team sets realistic schedules.

Additionally, establish clear handoff procedures between teams to ensure smooth transitions. Leveraging integrated digital tools can be a game-changer, allowing you to track procurement milestones and site readiness simultaneously and in real time. This proactive approach helps keep everything on track.

What should I ask to confirm a CM firm can manage commissioning and IST?

To determine if a construction management (CM) firm is equipped to manage commissioning and integrated systems testing (IST), it’s important to dig into their approach. Start by asking how they integrate these tasks into the project schedule from day one. This ensures commissioning isn’t treated as an afterthought.

Next, find out how they handle coordination between key teams - electrical, mechanical, controls, and commissioning. Smooth handoffs are critical to avoid miscommunication that could derail progress.

Finally, ask about their process for validating system performance under load. Specifically, how do they test failure modes? Do they use commissioning gates to guide construction sequencing? These steps ensure systems are thoroughly tested and ready for real-world operation.
