May 23, 2026

Life Science Construction Companies: How Owners Evaluate Lab Builders

By:
Dallas Bond

Building a life science facility is far more complex than constructing typical offices or warehouses. Owners prioritize selecting builders with proven expertise in technical systems, regulatory compliance, and cost management to avoid costly delays and ensure compliance. Here's what matters most:

  • Technical Expertise: Builders must handle systems like 100% outside air HVAC, HEPA filtration, and precise pressure cascades. MEP systems alone can make up 40%-60% of the budget.
  • Regulatory Knowledge: Familiarity with FDA cGMP, ISO 14644, and other standards is non-negotiable.
  • Reliability: Owners value contractors who deliver projects on time and within budget while minimizing risks.
  • Scalability: Facilities should be designed to accommodate future growth without major overhauls.
  • Team Strength: Builders with in-house MEP experts, commissioning specialists, and preconstruction teams are preferred.

Builders who integrate compliance into the design phase, use advanced tools like BIM and CFD modeling, and adopt efficient delivery methods like design-build stand out. Owners also assess hiring practices, ensuring the builder has skilled professionals for complex lab projects.

Key takeaway: Choose a builder with a strong track record in life science facilities, focusing on technical skills, regulatory compliance, and project reliability. A low bid isn’t worth the risk of delays or non-compliance.

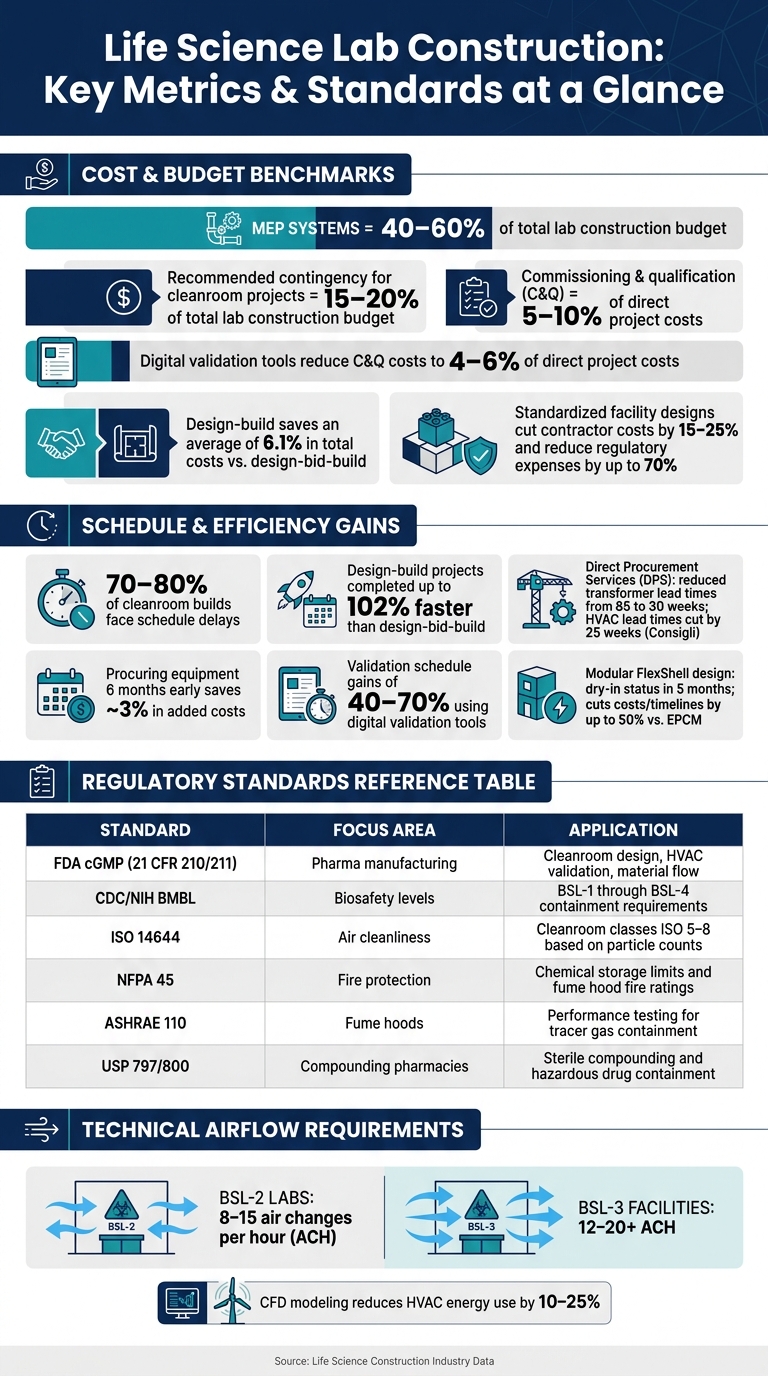

Life Science Lab Construction: Key Metrics & Standards at a Glance

Life Science Lab Construction: Key Metrics & Standards at a Glance

Technical Expertise and Regulatory Compliance

When it comes to life science facilities, owners expect builders to bring extensive technical knowledge and a clear understanding of regulatory requirements. Builders who grasp the science behind these projects can avoid costly errors and ensure smooth operations. This section focuses on the importance of experience, regulatory knowledge, and technical skills in lab construction.

Prior Experience with Life Science Projects

A builder’s portfolio speaks volumes. Owners want to know: Has this team successfully delivered GMP manufacturing suites? Have they built validated cleanrooms? Do they have experience with BSL-2 or BSL-3 containment facilities? These questions help assess whether a builder is equipped to meet the unique challenges of life science projects.

McCarthy Building Companies serves as a prime example of this expertise. Project Director Seth Kelso led the construction of the National Bio and Agro-Defense Facility (NBAF), a 707,000-square-foot BSL-4 complex in Kansas, designed to study diseases that threaten both animals and public health. This facility is the only one of its kind in the United States. Kelso’s team has been involved in over 25% of all BSL-4 high-containment facilities in the country. Such a track record demonstrates the ability to handle the technical and regulatory demands of these intricate projects.

"Building these facilities is like building a Swiss watch with Lincoln Logs. It is very complicated, very precise work." - Seth Kelso, Project Director, McCarthy Building Companies

Standardizing designs across projects is another key factor. Consigli Construction highlights that standardized facility designs can cut contractor costs by 15–25%, boost operational efficiency by 25–35%, and lower regulatory expenses by up to 70%. This approach not only saves money but also ensures consistency and reliability.

Familiarity with Regulatory Standards

Understanding regulations is one thing; applying them effectively is another. Experienced builders don’t just know the rules - they build with compliance in mind from the start. Here’s a breakdown of the core standards lab builders must master:

Standard Focus Area Application
FDA cGMP (21 CFR 210/211) Pharma manufacturing Cleanroom design, HVAC validation, material flow
CDC/NIH BMBL Biosafety levels BSL-1 through BSL-4 containment requirements
ISO 14644 Air cleanliness Cleanroom classes (ISO 5–8) based on particle counts
NFPA 45 Fire protection Chemical storage limits and fume hood fire ratings
ASHRAE 110 Fume hoods Performance testing for tracer gas containment
USP 797/800 Compounding pharmacies Sterile compounding and hazardous drug containment

Top builders integrate compliance into the design phase rather than treating it as an afterthought. For example, Pharma Access implemented Commissioning, Qualification, and Validation (CQV) early in the design of a turnkey aseptic facility, ensuring it was ready for USFDA inspections from day one.

"When compliance drives design, certification becomes a milestone rather than a hurdle." - C1S Group

This proactive approach not only simplifies certification but also ensures the facility operates smoothly from the start.

Technical Capabilities That Set Lab Builders Apart

Life science facilities demand specialized technical expertise, particularly in MEP systems, cleanrooms, and utility infrastructure. Builders must be proficient in managing 100% outside air HVAC systems, maintaining precise pressure cascades, and installing HEPA filtration systems. These elements are critical for meeting compliance and ensuring operational efficiency. For example:

  • BSL-2 labs typically require 8–15 air changes per hour (ACH).
  • BSL-3 facilities demand 12–20+ ACH.

Builders who fail to meet these airflow requirements risk breaching compliance and halting operations.

Using advanced tools like Computational Fluid Dynamics (CFD) modeling gives builders an edge. CFD modeling allows teams to simulate airflow patterns and identify potential issues, such as pressure dead zones, before construction begins. This kind of analysis can reduce HVAC energy use by 10–25% by optimizing airflow designs. Additionally, expertise in Insulated Metal Panel (IMP) installation is crucial for creating the sealed environments required for ISO 5–8 cleanrooms and cGMP manufacturing.

Delivering Mission-Critical Lab Projects on Time and on Budget

When it comes to life sciences facilities, meeting deadlines and staying within budget are just as important as technical and regulatory expertise. For life science owners, delays aren't just inconvenient - they can stall drug approvals, disrupt clinical schedules, and cost millions in lost revenue. That’s why owners carefully evaluate a builder’s track record in managing schedules and controlling costs, alongside their technical qualifications. A good place to start is by understanding construction project delivery methods to see how builders structure their commitments. Let’s dive into strategies for handling tight schedules and phased deliveries.

Managing Tight Timelines and Phased Delivery

Here’s a staggering statistic: 70–80% of cleanroom builds face schedule delays. This is why owners demand more than vague promises of efficiency - they want clear strategies to avoid setbacks.

Leading builders tackle potential delays before construction even begins. For example, Consigli Construction used early BIM coordination and off-site prefabrication to kick off construction six weeks ahead of schedule.

"Faster project deliveries aren't achieved by adding more resources in the construction phase. They result from collaborative planning in conjunction with a design that meets the user requirements and schedule parameters." - Consigli Construction

Another effective approach is Direct Procurement Services (DPS), where builders handle equipment purchasing during the schematic design phase instead of waiting for trade awards. Messer Construction applied this method on a university project, cutting transformer lead times from 85 to 30 weeks. On another project, they reduced HVAC lead times by 25 weeks by opting for packaged systems. Procuring equipment six months earlier can also save 3% in added costs, especially when escalation averages 0.5% per month.

Cost Control and Risk Mitigation

With MEP systems accounting for 40–60% of lab construction costs, overruns can quickly derail a project. That’s why successful builders focus on cost control during the design phase, rather than scrambling to react during construction.

Realistic contingency planning is a strong indicator of a builder’s experience. For cleanroom projects, a 15–20% contingency is often necessary due to the complexity and likelihood of unforeseen requirements. Builders proposing lower contingencies without justification are likely underestimating risks.

"Most cleanroom projects don't fail during construction - they fail during planning. A missed requirement early on can lead to costly redesigns later." - ACH Engineering

Messer Construction’s work with Catalent highlights effective cost management. In 2026, Messer used its DPS approach to source all equipment for a capital project under budget and below estimates by prequalifying manufacturers that met both technical and timeline needs.

"Messer has been a great partner in providing their Direct Procurement Services. They have kept bidders in line with specifications and made it possible to have equipment ordered to prevent any schedule impacts to the project." - Jake Trimpe, Manager, Capital Projects and Technology, Catalent

Strong cost control also lays the groundwork for a smooth commissioning and turnover process.

Commissioning and Turnover Readiness

Delivering a project on time and within budget is only part of the equation - it also needs to be fully operational at turnover. Commissioning and qualification (C&Q) typically account for 5–10% of direct project costs on large-scale projects, and owners expect builders to treat this phase with precision.

The best builders involve commissioning teams during the design phase, not after construction is complete. Validation steps like Installation Qualification (IQ), Operational Qualification (OQ), and Performance Qualification (PQ) should be integrated into the project schedule from the outset. These processes can take 8–12 weeks, far longer than the 2–4 weeks many teams initially plan for.

Digital Validation Tools (DVTs) are becoming a game-changer in this space. Transitioning from paper to digital workflows has shown schedule gains of 40–70% for validation tasks and can reduce C&Q costs to 4–6% of direct project costs, down from the usual 5–10%. Owners should ask builders directly: Do you use digital commissioning tools, and can you provide documentation from a past project? A builder who delivers a clean, digital turnover package - complete with verified pressure cascades, airflow data, and automation baselines - demonstrates that the facility is ready for operations, not just structurally complete.

Scalability and Long-Term Planning in Lab Construction

A lab that only meets immediate needs but doesn't allow for future growth can quickly turn into a hindrance. Today, lab owners expect builders to think ahead and deliver spaces that can evolve over time. This requires careful planning around flexibility, energy use, and comfort for those working in the space.

Designing for Flexibility and Future Expansion

Planning for an uncertain future is no small task. As research focuses and equipment needs shift, labs must be designed to adapt and expand in stages.

One effective method is phased construction and turnover, where lab spaces are delivered in overlapping stages. This allows owners to start using finished sections while construction continues on others. A great example of this is DPR Construction’s work on GSK's 150,000-square-foot expansion at 200 Cambridgepark Drive in Cambridge, MA. The project was completed in nine overlapping phases across six floors in an active facility. Using tools like Virtual Design and Construction (VDC) and 3D laser scanning, the team mapped the existing mechanical, electrical, and plumbing (MEP) infrastructure to design new systems around it. This approach helped avoid costly surprises and disruptions. They even installed a temporary heat loop to ensure uninterrupted operations during critical system transitions. The result? The project was delivered on time and on budget, with zero lost-time incidents over more than 300,000 labor hours.

Another approach gaining popularity is modular shell strategies. For instance, ARCO Design/Build’s "FlexShell" system offers a scalable core-and-shell design that can reach dry-in status just five months after construction begins. This integrated design-build method has been shown to cut project costs and timelines by up to 50% compared to traditional Engineering, Procurement, and Construction Management (EPCM) models.

"ARCO's ability to design and construct a flexible facility within an already aggressive timeline was impressive. When you combine that with the cost that they were able to deliver it for, it became an easy game changer for our business." - Pharmaceutical Client Program Director, ARCO Design/Build

But flexibility isn’t the only priority - energy efficiency is just as critical for long-term success.

Energy Efficiency and Sustainability in Lab Design

Labs are some of the most energy-demanding buildings, largely due to the need for high volumes of fresh outdoor air for safety. Because of this, energy strategies play a major role in how owners choose their builders.

Leading builders kick off energy modeling within the first 90 days of a project to set Energy Use Intensity (EUI) targets and guide early decisions on procurement. Julie Janiski, a partner at Buro Happold, sums it up well:

"The first 90 days determine the next 30 years." - Julie Janiski, Buro Happold

Take the 100 Chestnut project in Somerville, MA, for example. This 200,000-square-foot life sciences facility was designed with electrification-ready infrastructure and a landlord-tenant matrix to manage ventilation needs across diverse tenant types, including vivariums and incubator spaces. The result? The project achieved LEED Platinum certification, a rare feat for energy-intensive labs.

Material selection also plays a big role in sustainability. At the FORUM project in Boston Landing, which opened in January 2026, the team used 90% recycled steel and replaced 20–40% of Portland cement with fly ash. This reduced embodied carbon by 10%. The 350,000-square-foot facility is 97% electric and includes a 15,000-gallon cistern for rainwater harvesting.

Lab Layouts That Support Research and Occupant Comfort

Energy efficiency is just one part of the equation. Thoughtful layouts ensure that labs are functional, comfortable, and adaptable for researchers.

Builders are increasingly using modular casework, movable benches, and overhead carriers to create spaces that can be reconfigured without requiring major renovations. This adaptability is key to meeting changing research needs.

Environmental stability is another priority. Advanced building management systems monitor and control temperature and humidity, safeguarding sensitive experiments and ensuring occupant comfort. Features like central staircases, open sightlines, and optimized daylighting - balanced with high-performance glazing to reduce heat gain - promote wellness and encourage collaboration.

Even ceiling heights are carefully considered. Builders who balance aesthetics with the need for proper air circulation show the kind of forward-thinking that lab owners value.

Assessing the Builder's Team, Processes, and Hiring Practices

When it comes to life science construction, the people behind the project are just as important as the design itself. Owners evaluating construction companies want to know who's leading the charge, how the team operates as a unit, and whether the builder has a track record of attracting top-tier talent. A strong team is the foundation for smooth execution and dependable results.

Leadership and Key Roles in Life Science Construction

Life science construction isn't your typical building project - it requires specialized expertise from the start. Owners look for builders with dedicated professionals who understand the unique demands of these projects.

One key area is MEP (mechanical, electrical, and plumbing) engineering. Missteps in airflow or utility planning can lead to failed inspections or even millions in lost productivity. Builders with in-house MEP teams experienced in handling 100% outside air systems, pressure cascades, and HEPA filtration are far better equipped to deliver labs that meet strict compliance standards.

But it doesn’t stop at MEP. Owners should also prioritize builders with:

  • Preconstruction specialists: These experts provide early feasibility studies and ensure cost predictability.
  • Validation and commissioning experts: They know the ins and outs of IQ/OQ/PQ protocols, which are essential for FDA and cGMP compliance.
  • Directors of Life Science: This leadership role focuses on specialized preconstruction activities and modular strategies, signaling a commitment to life science projects as a core discipline.

Having these experts on board ensures the project not only meets compliance standards but also supports long-term functionality and efficiency.

Collaboration and Process Integration

Expertise is vital, but how a builder integrates that expertise into a cohesive process is just as critical. Owners should assess how well the builder coordinates architects, MEP engineers, and validation consultants into a seamless workflow.

Top builders rely on tools like early BIM (Building Information Modeling) coordination and off-site prefabrication to align all disciplines before construction begins. These methods help avoid costly on-site conflicts and rework. For owners managing multiple sites or planning future projects, standardizing facility designs can save 15%–25% on contractor costs and reduce regulatory compliance expenses by up to 70%.

The choice of project delivery method also plays a major role. Design-build models, where engineering and construction teams collaborate from the start, can shorten lab construction timelines by 15%–30% compared to traditional design-bid-build approaches. Builders should be ready to share examples of how these methods have worked in similar projects.

"Nimble, quick, and responsive are three qualities that come to mind when I think of ARCO. Their life science experience and hard-charging attitude has been a clear differentiator for us, our future tenants, and our developments." - Jon Keener, Principal, Helix Ventures

Hiring the Right Talent for Life Science Construction

How a builder approaches hiring says a lot about their commitment to quality. Leading firms treat staffing as a critical-path activity, starting the process 4–6 months in advance and ensuring key roles are filled 2–3 months before mobilization.

"Staffing is a critical-path activity, not an HR task. Contractors who treat hiring like procurement or scheduling consistently deliver stronger results." - The Birmingham Group

Finding the right talent is no small task. Builders often recruit from industries like semiconductor fabrication and medical device manufacturing, where workers are already familiar with strict cleanliness and process control standards. However, the demand for these specialists is intense:

"The demand for pharmaceutical facilities is outpacing the ability to properly staff the project teams building them with skilled tradespeople." - Courtney Skunda Hall, Vice President, Client Growth + Strategies, BE&K Building Group

Builders who partner with specialized recruitment firms like iRecruit.co gain access to pre-qualified talent pipelines. These firms focus on sourcing construction professionals for complex environments, such as pharmaceutical manufacturing, ensuring that critical roles are filled on time. For owners, a builder's relationship with a recruitment partner is a strong indicator of their ability to maintain consistent staffing quality. Reliable hiring practices are directly linked to delivering compliant, high-performing lab projects.

Conclusion: What to Look for When Choosing a Lab Builder

When selecting a lab builder, focus on the essentials: technical know-how, budget management, and future-proofing. A builder with real-world experience in handling complex MEP systems, navigating regulatory standards like FDA cGMP and ISO 14644, and managing validation protocols will ensure your lab is ready to operate from day one.

Budget and schedule discipline are equally vital. Builders who adopt integrated design-build models tend to deliver better results. In fact, design-build projects are completed up to 102% faster and save an average of 6.1% in total costs compared to the design-bid-build approach. Ask potential builders about their strategies for managing long-lead equipment procurement, phased delivery, and maintaining cost transparency. These practices are key to delivering a compliant and adaptable facility.

Scalability is another crucial factor. The most effective builders design labs that can grow with your needs. Features like modular casework, scalable utility manifolds, and infrastructure designed for expansion can save you from costly retrofits in the future.

The success of your project also depends on the builder's team. Look for strong leadership in preconstruction, expertise in validated commissioning, and disciplined hiring practices. These qualities distinguish reliable builders from those who may fall short.

"Selecting the right lab build-out contractor is one of the most critical decisions in any laboratory construction project." - Jim Hopper

When making your choice, prioritize proven experience over lower bids. A contractor with a strong track record in GMP or ISO environments will always be a better investment than one without.

FAQs

What should I ask to confirm a builder can deliver a compliant lab?

When discussing regulatory standards and validation processes, it’s crucial to dig into specifics. Start by asking: “Have you worked with compliance standards such as cGMP, BSL, or ISO?” This will help you understand their familiarity with industry regulations.

Next, dive into how they handle validation protocols by asking: “How do you approach IQ, OQ, and PQ processes?” These protocols are vital for ensuring systems and equipment meet operational requirements.

Another key area to explore is their knowledge of environmental controls. Ask: “What experience do you have with systems like HVAC or HEPA filters?” These systems are critical for maintaining controlled environments in many industries.

Finally, don’t just take their word for it. Request references or case studies that demonstrate their track record of delivering compliant projects on time. This step will give you confidence in their ability to meet regulatory requirements while staying on schedule.

How can I tell if a lab construction schedule is realistic?

To determine whether a lab construction schedule is practical, look for thorough planning elements like a Work Breakdown Structure (WBS) and clearly defined system specifications. The schedule should also consider critical factors such as permitting processes, equipment lead times, and the time required for system testing.

Check if the timeline incorporates buffers for potential delays, aligns with procurement timelines, and tackles specific challenges like managing vibrations or addressing complex HVAC systems. A schedule created with input from seasoned lab construction experts is far more likely to stay on track.

What design choices make a lab easier to expand later?

Designing a lab with future expansion in mind means prioritizing versatility and growth potential. Modular layouts are a smart choice, as they allow for adjustments without overhauling the entire space. Incorporating flexible utility connections - covering essentials like water, gas, and electricity - ensures that the infrastructure can handle evolving needs.

It’s also crucial to plan ahead by documenting physical limitations and utility capacities early in the design process. This foresight helps avoid bottlenecks when scaling up. Features such as movable partitions and adjustable workstations make it easier to reconfigure the space when needed, allowing the lab to adapt and expand without requiring extensive reconstruction.
