May 22, 2026

Hyperscale Data Center Construction Management: The Owner's Playbook

By:
Dallas Bond

Building hyperscale data centers is a massive challenge. These facilities, starting at 20 MW and scaling to over 1.2 GW, require precise planning and execution to meet deadlines and avoid costly delays. Owners face three major risks: power constraints, supply chain delays, and labor shortages - all of which can derail projects if not addressed early.

Key strategies for success include:

  • Governance: Define roles, responsibilities, and delivery models upfront. Multi-prime risk-sharing models are gaining traction for their speed and trade alignment.
  • Talent Strategy: Assemble experienced teams early, focusing on critical roles like MEP leads and commissioning managers. Use specialized recruitment services to secure top talent.
  • Execution: Prioritize phased delivery, modular construction, and integrated scheduling. Early procurement of long-lead equipment (e.g., transformers, switchgear) is critical to avoid delays.
  • Risk Management: Address risks proactively by freezing designs early, managing utility interconnections, and coordinating trade handoffs effectively.

Owners must treat each project as part of a larger program, standardizing processes and leveraging lessons learned to improve efficiency. Early decisions on equipment, utilities, and team coordination are essential to delivering these mission-critical projects on time and within budget.

Hyperscale Data Center Explained | How the World’s Largest Data Centers Are Built

Governance: Building the Right Foundation

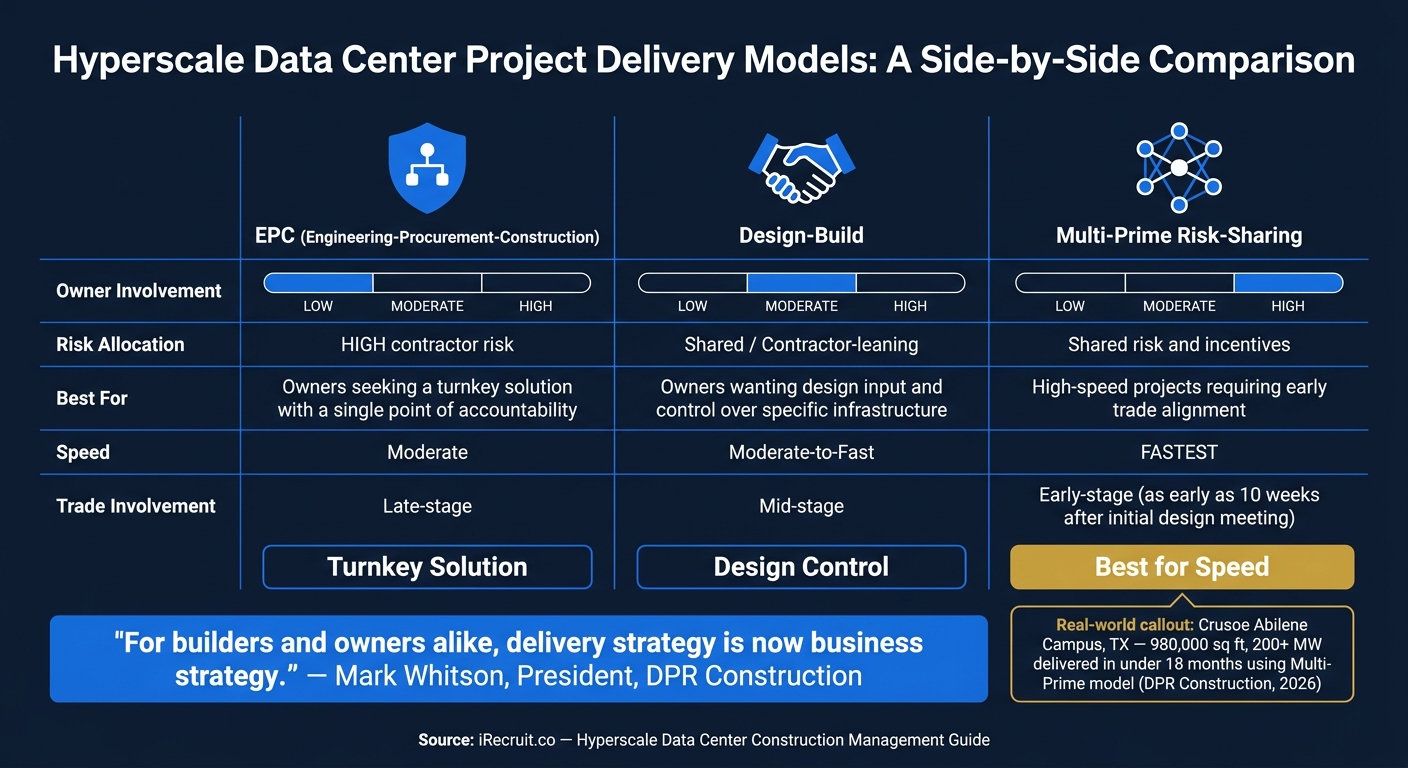

Hyperscale Data Center Delivery Models: EPC vs Design-Build vs Multi-Prime

Hyperscale Data Center Delivery Models: EPC vs Design-Build vs Multi-Prime

Strong governance is the backbone of hyperscale projects that meet deadlines and avoid costly delays. At its core, governance is about clearly defining responsibilities - who manages the budget, oversees the schedule, handles field execution, and coordinates technical aspects - right from the start. When roles and handoffs between owners, general contractors, and MEP contractors aren't clearly defined, large-scale projects are at risk of chaos and inefficiency. This clarity is essential before deciding on the best delivery model.

Choosing the Right Project Delivery Model

The delivery model you choose determines the pace, risk distribution, and level of control for your project. For hyperscale builds, three key models dominate:

Model Owner Involvement Risk Allocation Best For
EPC (Engineering-Procurement-Construction) Low High contractor risk Owners seeking a turnkey solution with a single point of accountability
Design-Build Moderate Shared/contractor risk Owners wanting input on design and control over specific infrastructure
Multi-Prime Risk-Sharing High Shared risk and incentives High-speed projects requiring early trade alignment

The multi-prime model is gaining momentum for good reason. Take the Crusoe Abilene Data Center Campus in Abilene, Texas, as an example. In April 2026, DPR Construction used this approach to tackle a massive 980,000 sq. ft., 200+ MW project. By involving trade partners like Rosendin and Southland Industries just 10 weeks after the initial design meeting, the team achieved initial turnovers in 11 months and completed all data halls in under 18 months.

"For builders and owners alike, delivery strategy is now business strategy." - Mark Whitson, President, DPR Construction

The choice of model boils down to how much control you want versus the risk you're willing to shift to others. If speed is your priority, the multi-prime structure - with its early trade involvement - is hard to beat. Once this decision is made, the next step is to standardize data and processes across projects.

Standardizing Data and Processes Across Projects

For owners managing multiple sites, treating each build as a standalone effort leads to inefficiency. Recreating standard assemblies, reporting dashboards, or training materials for every project wastes time and resources. The solution? Owner-driven standardization applied across all projects.

This involves rolling out enterprise-wide digital templates using platforms like Autodesk Construction Cloud (ACC). With these templates, cost and schedule dashboards maintain consistency, no matter the general contractor or project location. Standardization also extends to MEP coordination plans, commissioning documentation, and change management workflows. According to IMAGINiT, this kind of enterprise standardization can improve cost predictability by 1–2% - a small percentage with a big financial impact for hyperscale projects. For more details, check out this guide on data center construction programs and repeatability.

"Repeatability compounds. Crews move from one building to the next with greater confidence, fewer surprises, stronger safety performance, and more predictable outcomes because they are building on proven patterns rather than starting over." - Mark Whitson, President, DPR Construction

Setting Key Performance Indicators (KPIs)

KPIs are what bring governance to life. Without them, project reviews risk becoming vague discussions instead of objective, data-driven evaluations. For hyperscale construction, the most critical metrics include cost per megawatt, schedule reliability, and change order volume - all key indicators of whether a project is on track or quietly veering off course.

Another crucial metric is commissioning readiness, which measures how prepared systems are for integrated systems testing (IST) before energization. This shifts the focus from traditional "substantial completion" (is the building ready for occupancy?) to operational readiness (are systems energized, validated, and ready to generate revenue?). By tying KPIs to operational milestones, stakeholders stay aligned on the ultimate goal: getting the facility up and running to start generating revenue.

Talent Strategy: Assembling a Mission-Critical Team

A solid governance framework might lay the groundwork for a project, but it’s the right team that truly drives execution. In hyperscale construction, talent isn’t just a supporting factor - it’s a critical element of delivery. Specialists like commissioning professionals and MEP (Mechanical, Electrical, and Plumbing) experts with data center experience are in high demand and often booked far in advance. Any gaps in leadership can lead to delays, misaligned workflows, and costly schedule compressions that could result in millions of dollars in lost revenue. This focus on talent is essential to the execution and risk management strategies discussed later in this guide.

"In mission-critical construction, workforce availability is no longer a downstream consideration. It is a primary factor in whether projects stay on schedule, maintain quality, and achieve operational readiness." - iRecruit.co

Key Roles Needed for Hyperscale Delivery

For hyperscale projects, assembling the right team before construction begins is non-negotiable. Delaying key hires until after mobilization can jeopardize the entire program. Below is a breakdown of the essential roles and their responsibilities:

Role Core Responsibility Minimum Experience
Program Director Oversees multi-site portfolios, governance, budgets, and executive-level reporting 15+ years; 5–7 in data centers or complex MEP-heavy projects
Project Director / Senior CM Manages individual campus operations, including GC coordination, schedule, cost, and quality 10–15+ years; 2–3 mission-critical facilities delivered
MEP Lead / Critical Systems Manager Manages electrical, mechanical, and power/cooling systems from design to final testing 8–12+ years with high-density power and cooling systems
Commissioning Manager Leads Levels 1–5 commissioning and ensures smooth vendor and operations turnover 8–10+ years commissioning complex MEP systems
Construction Planner / Scheduler Develops and maintains integrated schedules, running scenario analyses as needed 7–10+ years; modular and fast-track experience preferred
Supply Chain / Procurement Lead Oversees long-lead equipment and global procurement timelines 7–10+ years with global vendor management experience
Cost Manager / Project Controls Lead Manages budgets, forecasts, and cross-site cost reporting 7–10+ years on large capital projects

While generalist construction project managers might handle basic schedules and budgets, they often lack the expertise in redundancy designs, Tier classifications, and integrated systems testing that mission-critical specialists bring.

Using Specialized Recruitment Services

Finding the right talent for hyperscale projects is easier said than done. General job boards tend to yield slow results, and most experienced professionals aren’t actively seeking new roles - they’re already engaged in long-term projects. That’s where specialized recruitment firms like iRecruit.co come in.

iRecruit.co focuses exclusively on recruiting for critical infrastructure projects, including data centers and advanced manufacturing facilities. They pre-screen candidates for both technical qualifications (e.g., knowledge of critical power systems or modular construction) and their ability to thrive in high-pressure, fast-paced environments. For large-scale, multi-site projects, they can run parallel recruitment campaigns across regions, leveraging past data to speed up hiring for repeat roles. To maximize this partnership, project owners should provide a clear 12–36 month project roadmap, identify target locations, and define role requirements upfront. Service-level agreements (SLAs) such as delivering a shortlist of 3–5 pre-qualified candidates within 10 business days can help streamline the process.

Workforce Planning for Multi-Site Operations

Hiring on a site-by-site basis often leads to overlapping projects that compete for the same limited talent pool. Instead, program-level planning allows for better talent allocation across all projects, ensuring smoother operations.

This involves forecasting workforce needs 12–24 months in advance based on the capital plan and project timelines. Flexible staffing models, like commissioning teams that can rotate between sites during different project phases, are also effective. Critical roles - such as Commissioning Managers and MEP Leads - should have clear succession plans to avoid disruptions. Long-term strategies include investing in internal training programs and partnerships with universities to develop MEP, controls, and commissioning expertise internally, reducing reliance on the already limited external talent pool.

"What differentiates high-performing teams is not size, but... prior exposure to similar project types [and] ability to anticipate downstream impacts." - iRecruit.co

Retaining top talent requires more than just competitive pay. Offering performance bonuses tied to schedule and safety metrics, as well as long-term completion incentives, can make a difference. Additionally, providing clear career progression opportunities - like moving from Site Manager to Regional Program Director - and investing in training and certifications signals that the organization values its team as long-term assets, not just temporary resources. These strategies play a key role in reducing risk and ensuring continuous improvement, which are explored further in the next sections.

Execution: Controlling Cost, Schedule, and Quality

With a strong governance structure and a skilled team in place, the next critical step in hyperscale projects is execution. These large-scale projects often stumble not just because of delayed decisions but also due to fragmented schedules and overlooked supply chain priorities. Successful execution begins long before construction starts. Below are strategies to effectively manage time, cost, and quality in hyperscale projects.

Phased Delivery and Modular Construction

Running factory production and on-site work at the same time can dramatically reduce timelines - sometimes by as much as 50%. A great example of this is the Crusoe Abilene Data Center Campus in Texas. In April 2026, DPR Construction shared how they collaborated with Digital Building Components during the design phase. This partnership allowed them to install more than 600 prefinished wall panels in just seven days. Ultimately, they delivered Phase 1 - spanning 980,000 square feet and over 200 megawatts of capacity - in less than 18 months.

"Speed depends on how the work is set up, how decisions get made, and how well teams execute together from the start." - Mark Whitson, President, DPR Construction

To maintain the advantages of prefabrication, it’s essential to lock in interface decisions early. A single late change in scope can disrupt the entire production chain, erasing weeks of progress. Once modular construction sets the pace, the next challenge is keeping schedules in sync.

Integrated Scheduling and Field Coordination

Traditional CPM schedules aren’t enough for hyperscale projects. Managing multiple work fronts, often involving peak workforces of up to 9,500 people, requires a more adaptable approach. 4D scheduling, which combines BIM with the project timeline, lets teams visualize workflows and spot potential access issues before they cause delays. Real-time updates from the field can also flag schedule deviations within days.

To avoid bottlenecks, owners should use constraint logs that tie pending decisions, permits, and material deliveries directly to specific schedule activities. This approach ensures potential delays are identified and addressed before they escalate into critical issues.

Managing Long-Lead Equipment and Supply Chain Visibility

Delays in long-lead equipment are a frequent challenge in hyperscale builds. For instance, utility-grade transformers currently have lead times of 60–90 weeks, medium-voltage switchgear takes 52–78 weeks, and generator sets require 40–60 weeks. On a 100 MW campus, even a 30-day delay can translate into $1 million to $5 million in lost rental income. This makes early procurement a top priority, not just an administrative task after design wraps up.

Component Current Lead Time (Weeks)
Utility-grade Transformers 60–90
Medium-voltage Switchgear 52–78
Generator Sets 40–60

Design plans should prioritize early interface freezes to allow for timely procurement of these critical items. Including factory acceptance testing (FAT) for packaged systems in the project sequence can also reduce field debugging time and prevent commissioning delays caused by last-minute equipment issues.

Risk Management and Continuous Improvement

Common Risk Categories and How to Address Them

Even the most carefully managed projects can falter without active attention to risks. Just like governance and talent planning, managing risks early and effectively is essential for success in hyperscale construction. The most damaging problems often arise quietly - through delayed decisions, missed transitions, or gaps in procurement.

Here’s a quick look at some common risks and how to tackle them:

Risk Category What Goes Wrong How to Address It
Decision Latency Delayed design or procurement decisions lead to costly rework Make decisions early and establish clear authority
Power & Utility Constraints Complex grid interconnections delay site readiness Treat power planning as a dedicated workstream with clear milestones
Long-Lead Procurement Delays in sourcing equipment like transformers or generators disrupt timelines Start procurement early, even before finalizing design, to avoid redesign costs
Handoff Gaps Poor coordination between teams (e.g., electrical and mechanical) impacts commissioning Involve commissioning teams from the design stage onward
Technical Density Shifts Changes in AI hardware (like NVIDIA B200/GB200) require mid-project cooling redesigns Finalize cooling strategies early to avoid electrical system adjustments

As Broadstaff Global emphasizes, "A missed handoff between electrical and mechanical teams can affect commissioning. A late equipment decision can delay energization". The key isn’t adding oversight after problems occur - it’s embedding coordination into the process from the beginning. Owners should involve commissioning teams in shaping design requirements rather than waiting for them to verify work at the end. This proactive approach can prevent costly delays and create a more synchronized construction process.

Safety Culture and Workforce Stability

Safety is just as critical as risk management when it comes to keeping projects on track and maintaining workforce stability. For example, at the Crusoe Abilene campus in Texas, the workforce peaked at around 9,500 workers. High worker density can lead to trade stacking, which increases both safety risks and productivity challenges.

One effective strategy is reducing on-site work. At Abilene, the DPR Construction team moved over 600 exterior wall panels to an off-site manufacturing facility. This shift cut installation time from 8 weeks to just 7 days. Fewer workers on-site not only reduced the risk of incidents but also sped up the project.

"Schedule reliability is largely determined upstream by decisions that eliminate rework and procurement ambiguity." - Mark Whitson, President, DPR Construction

Another critical strategy is zone-based sequencing. Breaking the site into distinct access zones with specific entry rules for trades helps reduce congestion. Schedules should be tested against actual labor availability and space constraints, not just theoretical timelines. For those managing multi-site programs, incorporating these labor and space assumptions into the baseline schedule from the outset is crucial.

Applying Lessons Learned to Future Projects

Risk management and safety practices don’t just benefit the current project - they lay the groundwork for better outcomes in the future. Owners who consistently meet deadlines often treat each project as part of a larger program rather than a one-off effort. When teams can reuse proven methods, the learning curve shrinks, and predictability improves.

Standardizing assemblies and interface details can shift the focus from reinventing solutions to simply validating them. For example, creating a commissioning prerequisite matrix during the design phase helps track which punch-list items are critical for commissioning and which are merely cosmetic. This prevents delays to start dates.

AI-driven tools can also play a role by identifying subtle risks - like tasks with minimal float that could erode schedule buffers. By flagging these early, teams can address issues before they escalate. The ultimate goal is to make closeout and documentation an ongoing process rather than a last-minute rush. This continuous improvement mindset helps keep costs, schedules, and quality on target.

Conclusion: Putting the Owner's Playbook into Practice

Hyperscale data center construction is more than just a field challenge - it’s a complex systems issue. By early 2026, the trailing twelve-month U.S. data center construction starts had reached an impressive $103.7 billion. In January 2026 alone, these starts accounted for $25.2 billion across 20 projects. At this pace, owners who approach each project as a standalone effort will struggle to keep up with those leveraging repeatable, program-level delivery systems.

This guide outlined four key pillars - governance, talent strategy, execution, and risk management - that work together to create a solid foundation for success. Governance establishes clear rules for decision-making, talent strategy ensures the right people are in place, execution streamlines operations, and risk management minimizes delays. Together, these elements create a program-level approach that’s critical for delivering mission-critical projects. As Mark Whitson, President of DPR Construction, aptly said: "Delivery strategy is now business strategy."

One of the biggest challenges remains the data center construction workforce and talent landscape. For example, Meta’s West Texas AI campus, a $10 billion project requiring over 3,000 workers at its peak, highlights how resource-driven scheduling has become a central factor in project planning. Staffing is no longer just an HR function - it’s now a critical project controls discipline that can provide a competitive edge for owners.

Successful owners take a proactive approach by making key decisions early. Finalizing equipment selections, utility interconnections, and how construction teams prepare for trade coordination before mobilization reduces downstream uncertainties. This kind of early decision-making has proven essential for rapid mobilization and on-time capacity delivery.

FAQs

When should owners lock design decisions to protect modular schedules?

Owners should make final design decisions as early as possible - preferably before fabrication and procurement kick off. By locking in designs at this stage, interfaces can be finalized, which minimizes the chances of delays and costly rework. This approach ensures the project stays on schedule and keeps modular construction workflows running smoothly.

How can owners secure transformers and switchgear without delaying design?

Owners can keep their projects on track by addressing transformer and switchgear procurement early in the process. Starting procurement planning during the initial design phases - sometimes even before securing final permits - can help avoid delays tied to long-lead equipment like transformers. Close coordination with utilities is also key. By conducting early coordination studies and phased utility planning, including addressing protection and metering standards, owners can ensure accurate forecasting and proper sequencing of tasks. Leveraging advanced modeling tools and proactive planning further supports maintaining the project schedule.

What roles should be hired first to prevent commissioning and turnover delays?

To keep hyperscale data center projects on schedule and avoid commissioning and turnover delays, focus on bringing in the right talent early. Key roles to prioritize include project managers, senior construction managers, MEP coordinators, and commissioning specialists.

For the best results, hire senior project managers and directors 4–6 months before mobilization. This gives them enough time to manage critical tasks like design, procurement, and commissioning. Additionally, bringing in MEP leaders and commissioning specialists early helps streamline system design, prevents delays, and reduces the need for last-minute troubleshooting during crucial phases.
