If you want data center construction work in 2026, focus on five places: Northern Virginia, the South, the Midwest, the West, and the Northeast. The biggest hiring is tied to power-ready sites, not just project demand.
Here’s the short version:
Across all five regions, I see the same pattern:
If you’re hiring or job hunting, the message is simple: follow the power, then follow the phased campus work.

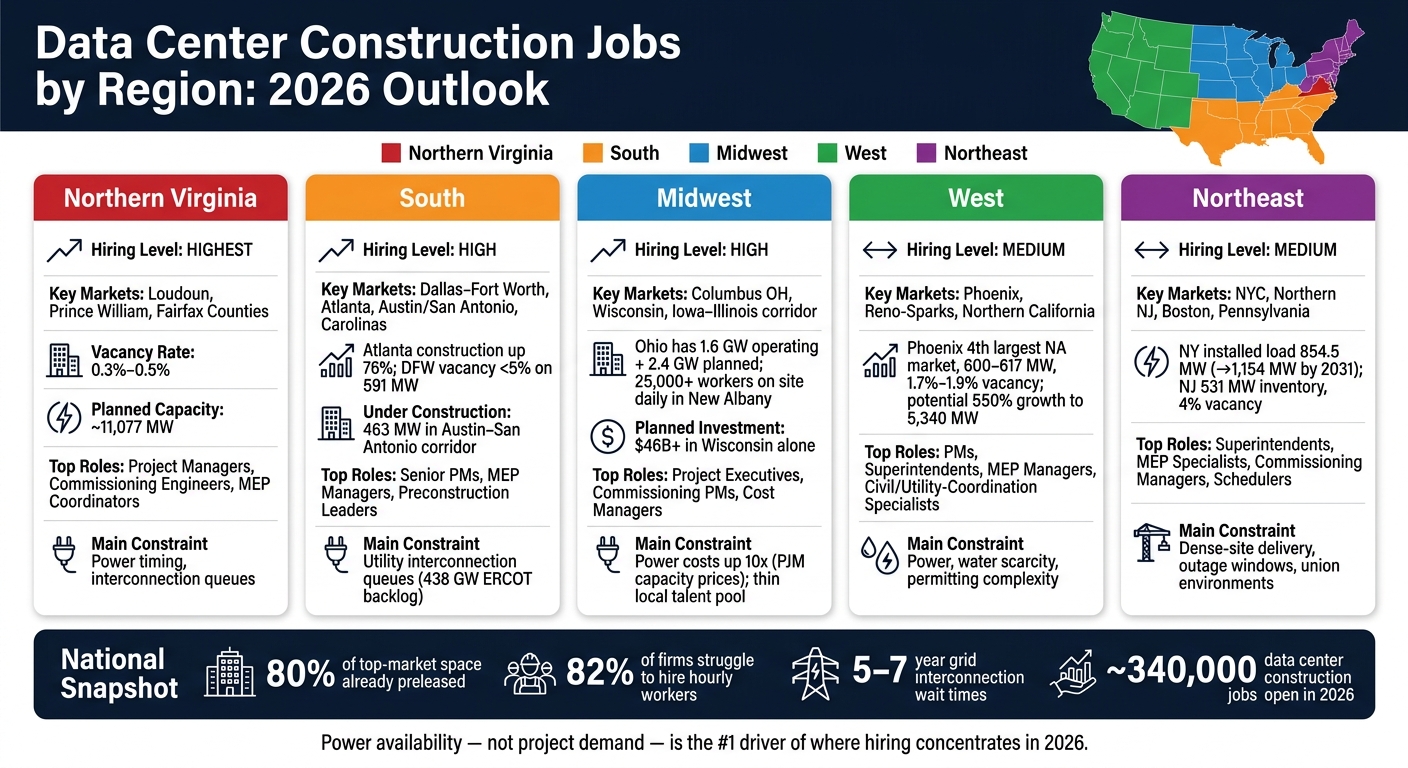

Data Center Construction Hiring by Region 2026
| Region | Hiring level | Main work type | Main hiring pressure |
|---|---|---|---|
| Northern Virginia | Highest | Hyperscale clusters, campus expansions | Power timing, nonstop overlap between phases |
| South | High | Hyperscale, rural greenfield, colocation | Utility queues, multi-phase delivery |
| Midwest | High | Large inland campuses, phased megaprojects | Power cost strain, thin local talent pool |
| West | Medium | Hyperscale, greenfield, retrofits | Power, water, permitting |
| Northeast | Medium | Retrofits, densification, colocation | Dense-site delivery, outage windows, utility access |
Bottom line: if you work in mission-critical construction, the best job odds are in markets where power is already lined up and delivery is already under contract.
Hiring in the South is clustered in Dallas–Fort Worth, Austin/San Antonio, Atlanta, and the Carolinas. At the same time, rural Texas and North Carolina are adding new greenfield demand [14][12]. That puts the South in the spotlight as one of the clearest places to watch data center hiring scale in 2026.
Atlanta is one of the busiest markets in the region. Data center construction there was up 76% by mid-2024, and leased space grew by 706 MW in 2024 [9]. AWS has also committed roughly $11 billion to data center campuses in Butts County and Douglas County near Atlanta, supporting about 550 jobs [9].
Dallas–Fort Worth is tight on available space. The market has 591 MW of inventory sitting at under 5% vacancy [13]. One planned campus there spans 768 acres and includes multiple buildings [8].
The Austin–San Antonio corridor is moving fast too. It had 463 MW under construction in 2024, which was four times the prior year's level [13]. North Carolina is starting to look like a major corridor in its own right, with Duke Energy projecting that data center power demand in the state will rise from roughly 3 GW to nearly 6 GW within a decade [5].
The South's project mix leans heavily toward hyperscale campuses, high-density AI campus builds, rural greenfield development, and projects shaped by available utility capacity.
About 67% of planned U.S. data centers are set for rural areas [3][11]. You can see that pattern showing up in rural Texas and North Carolina. GCON's West Texas hyperscale project is one clear example of large AI and cloud campuses moving into rural Texas [15]. In the Carolinas, Duke Energy's grid planning is also driving parallel work on transmission reinforcement and substation expansions alongside data center construction [5].
That mix of work has a direct effect on hiring. Southern projects tend to be bigger, more rural, and more limited by power, so some roles are much tougher to fill.
Power is the main constraint across the South, and it's changing how projects are delivered. ERCOT is tracking more than 438 GW of large-load requests, with nearly 89% tied to data centers, while only 7.5 GW had actually been connected as of 2025 [4][10].
That gap between requested demand and delivered power is pushing owners to break projects into smaller phases. The goal is simple: line up construction with incremental power releases. In practice, that means more pressure on schedulers and preconstruction leads who can re-sequence data hall delivery and adjust scopes on the fly [4][6][7].
In the Carolinas, Duke Energy's capacity expansion adds another layer. Substation and transmission work has to move in step with data center construction, which makes utility-coordination PMs and seasoned civil leads especially important [5].
In the South, power timing now drives phasing, staffing, and delivery dates.
The Midwest faces similar hiring pressure, but with different siting and power constraints.
The Midwest is shaping up as one of the top hiring markets for 2026. Central Ohio leads the pack, with Wisconsin, Indiana, and the Iowa–Illinois corridor close behind. Unlike the South, where activity is spread across more markets, the Midwest’s hiring push is packed into a smaller group of dense inland campus hubs.
Ohio now ranks third in the U.S. for total data center capacity, with 1.6 GW already operating and 2.4 GW planned. More than 60% of that capacity sits around Columbus [2]. In New Albany, more than 25,000 construction workers are on site each day, including about 9,000 on Meta's Beech Road campus alone [19][20]. Columbus also added about 5,700 construction jobs between April 2025 and April 2026, with part of that growth tied directly to data center work [18].
Wisconsin is also moving fast. The state has at least $46 billion in planned hyperscale investment, with 10 projects set to add more than 2,190 MW [21][22]. Microsoft’s AI datacenter campus in Mount Pleasant, built on the former Foxconn site, employed more than 3,000 workers at peak construction. That crew included electricians, pipefitters, carpenters, steel workers, and concrete crews [16].
Iowa’s central cluster around Altoona, Waukee, and Ankeny is growing too. Meta’s Altoona campus continues to expand, while Apple’s $1.4 billion Waukee facility is still under development [23][24].
The Midwest is led by hyperscale campuses and phased megaprojects. New Albany’s International Business Park covers about 12,000 acres, with roughly 40 data centers already open and another 28 planned or under construction across 15 corporate tenants [25][27]. That kind of scale changes the hiring picture. Teams aren’t just filling one project at a time. They’re staffing long delivery pipelines.
Vantage’s New Albany campus (OH1) is a good example. It spans 70 acres and includes three data centers totaling 1.5 million square feet, with phased delivery running through 2028 [26]. In Illinois, a planned Lake County campus has secured 1.55 GW of power from ComEd and has room for up to 20 data center buildings [28].
These projects need people who can keep phased delivery on track, manage redundancy, and stay tight on costs. Across Ohio, Wisconsin, and the Iowa–Illinois corridor, owners and CMs are hiring for roles such as:
In Columbus, commissioning senior project managers and cost managers stay in demand because hyperscale work calls for deep MEP knowledge and strong redundancy experience [17]. Safety specialists with multi-site backgrounds are also hard to find, especially when campuses are this large and the risk profile is this high.
Power has become a major schedule risk across the Midwest. In the PJM market, which covers parts of Illinois, Indiana, and Ohio, capacity prices jumped from $28.92/MW-day for 2024–25 to $329.17/MW-day for 2026–27. That’s more than a 10x increase, driven in large part by forecasted data center load [17].
Wisconsin has its own pressure points. Analysts warn that the planned pipeline will need major water and energy resources, which means utility coordination timelines could push on construction schedules [21][22]. In Iowa, data centers already use about 11% of the state’s electricity, adding strain to grid upgrades as new campuses come online [29].
That puts extra weight on utility coordination, scheduling, and preconstruction leadership. This preparation is similar to how teams prepare for DOE data center projects by focusing on energy and land use. On paper, these may sound like back-office functions. In practice, they can make or break delivery when power is tight and campus buildouts are moving at full speed.
That mix of giant campuses and utility strain sets up the West, where power and permitting are tighter still.
The West is a tight market for 2026. Hiring is clustered in Phoenix, Reno-Sparks, and Northern California, and each one needs a different kind of team. Phoenix leans heavily toward hyperscale work. Reno-Sparks is driven by big power-backed campuses. Northern California is more about retrofits and adding capacity to existing sites.
What ties the region together is simple: power, water, and permitting are steering hiring. That’s the big difference from the Midwest. In the West, labor demand often follows infrastructure limits as much as project demand.
Phoenix is the 4th-largest data center market in North America, with 600–617 MW and just 1.7%–1.9% vacancy [36][40][54]. One forecast says the market could grow 550% to about 5,340 MW [47]. That kind of pipeline sounds huge on paper, but contractors in Phoenix are still having a hard time finding mission-critical builders [2][50][51][55][52].
Reno-Sparks is moving fast too. Vantage Data Centers announced a $3 billion campus in Sparks that is expected to employ more than 1,200 people across construction and operations, with the first facility due in Q2 2026 [44]. Tract’s Peru Shelf Technology Park at the Tahoe Reno Industrial Center also locked in a deal for 2 gigawatts of power from NV Energy starting in 2026 [53].
That project flow is creating more greenfield campus work than urban infill.
Phoenix is led by large hyperscale campuses, with 42 data center projects totaling more than 10,255 MW queued in one major utility territory alone [48]. Reno-Sparks looks similar, with greenfield hyperscale campuses concentrated around the Tahoe Reno Industrial Center [32][35]. Switch’s Tahoe Reno campus is designed for up to 7.2 million sq. ft. of data center space and 650 MW of renewable-powered capacity [49].
Northern California is still a major established market at around 2,010 MW, but the work profile is different [30]. Instead of sprawling new campuses, hiring is tied to:
That shift matters. Building on an open site is one thing. Upgrading a live facility is a whole different game.
The hardest roles to fill depend on the submarket.
In Phoenix, the pressure is on project managers, superintendents, MEP managers, and commissioning engineers because the hyperscale pipeline is so large [2][50][51][55]. In Reno-Sparks, the toughest searches are for construction managers, MEP leads, and civil and utility-coordination specialists, largely because power and water limits affect how projects are planned and sequenced [31][32][33][35].
Northern California has its own hiring pattern. Firms are looking for senior PMs, schedulers, commissioning and QA leaders with live-facility upgrade experience, and preconstruction talent that knows local permitting and seismic rules [30][34]. In other words, it’s not just about general data center experience. It’s about people who’ve dealt with tricky site conditions before.
Power limits are shaping this region from the top down. Arizona’s governor’s 2026 energy plan warns that data centers in the state could require 29,000 MW of power, driven in large part by AI workloads [42]. In California, Santa Clara stopped approving new data centers after reaching its power-supply ceiling, which is pushing operators toward Phoenix and Reno [45].
At the same time, legislative proposals such as AB 222 and AB 1577 add more front-end complexity through energy-efficiency standards and grid-impact assessments [37][38][41]. Reno-Sparks faces a similar constraint set. Power and water availability shape project phasing there, and data centers have been identified as the main driver of future load growth against current peak demand of around 2,100 MW [39][43].
Those grid limits don’t stay in the utility room. They show up in hiring. Teams need schedulers, commissioning leads, and utility-coordination PMs who can manage phasing from the earliest stages of a project.
The Northeast shifts the hiring picture from western power scarcity to dense-site delivery, urban permitting, and retrofit work.
Unlike the West, the Northeast is mostly a retrofit and densification market. Hiring is centered in New York City, Northern New Jersey, Boston, and a few parts of Pennsylvania and New England, where colocation, retrofits, and denser buildouts account for most of the work. That creates a smaller market, but it's also a very competitive one.
New York's installed IT load is 854.5 MW in 2025 and is projected to hit 1,154.2 MW by 2031. New Jersey has 531 MW of inventory, 4% vacancy, 19 MW under construction, and 124 MW planned [58][60][61]. With supply this tight, much of the work shifts to existing buildings and submarkets where power is already easier to access.
In the Northeast, most projects focus on making existing sites work harder.
In Midtown Manhattan, older commercial buildings are being converted into high-density colocation sites [58]. Brooklyn, Queens, and Long Island are drawing new colocation development because land costs less and power access is better than in Manhattan [58]. In Northern New Jersey, a new ~138,000-square-foot colocation facility opened in Secaucus, built for AI workloads and high-density rack layouts [56].
Boston and nearby markets are seeing steady densification through enterprise, edge, and colocation footprints rather than new hyperscale campuses [59]. At the same time, Upstate New York and Pennsylvania are starting to attract interest for hyperscale campuses as power limits push some future demand into nearby markets [60][62].
That project mix drives a pretty specific hiring pattern.
The hardest roles to fill are superintendents, MEP specialists, and commissioning managers with live-facility retrofit experience [1]. In New York and New Jersey, companies are also looking for project managers who have handled multi-phase retrofits [57]. Preconstruction leaders and cost managers with mission-critical experience are needed to price dense retrofit work the right way [1][57].
Schedulers and owner's reps are also high on the list, especially those who know how to work around outage windows, permitting timelines, and utility coordination [1]. In this market, that kind of background can make or break a project.
Site selection is being shaped by existing substation capacity. Developers are leaning toward sites in parts of New Jersey and New York's outer boroughs where substation access already exists, instead of sites that would need new transmission infrastructure [56][58].
That puts extra weight on schedulers, preconstruction leaders, and owner's reps who understand interconnection issues and outage windows. In a market like this, power access isn't just one more box to check. It's often the whole game.
Those constraints become even more concentrated in Northern Virginia.
If the Northeast runs into retrofit limits, Northern Virginia runs on a different set of pressures: huge campuses, tight power timelines, and nonstop delivery.
Loudoun, Prince William, and Fairfax counties alone hold nearly 80% of Virginia's data centers, which is why the area is often called "Data Center Alley" [64][67]. Colocation vacancy is as low as 0.3%–0.5%, and more than 90% of inventory with power agreements and site-plan approval is already claimed through 2026–2028 [63][1][66]. Put those numbers together, and the result is plain: builders with data center experience are in a constant tug-of-war across planning, construction, and turnover.
Demand stays high because committed campuses move through long delivery cycles that often overlap. Teams aren't just finishing one phase and moving on. They're handling multiple phases at the same time, often under tight deadlines.
More than 80% of construction firms nationwide are having trouble filling hourly and salaried roles [2]. In Northern Virginia, that pressure hits even harder. Hiring usually takes longer, and pay pressure tends to run above what many other U.S. markets see [65][66].
Most active work falls into three buckets:
Virginia's data center incentive program now runs through 2035, and qualifying projects must include more than $150 million in capital investment and 50 qualifying jobs [67]. One campus can drive parallel demand across civil, structural, electrical, mechanical, and commissioning scopes. That's a big reason staffing stays tight from early planning through final startup.
The most in-demand roles include project managers, senior superintendents, MEP coordinators, commissioning agents, schedulers, preconstruction leaders, and field engineers. That is even more true for people with hyperscale or high-density experience, since those teams often deal with phased delivery and energization sequencing.
For field positions, electrical and mechanical depth matter most. For management roles, the line between average and stand-out talent usually comes down to handling accelerated schedules and energization sequencing without losing control of the job.
Temporary connection pauses through January 2026 have split the market in two: projects that already have power move first, while greenfield sites sit in interconnection queues [63]. In plain English, some jobs can keep moving, while others are stuck waiting on utility timing.
That shift puts even more weight on preconstruction leaders, schedulers, and commissioning professionals, who are often the toughest hires to replace.
From here, the hiring picture shifts from regional hotspots to national recruiting support.

About 340,000 data center-specific construction jobs may sit open in 2026, on top of a broader 439,000-worker construction shortfall [68]. That kind of gap is too big for any single city to solve on its own.
The pressure is spread across the South, Midwest, West, Northeast, and Northern Virginia. So employers need reach that goes past one local labor market. iRecruit.co recruits across hyperscale, colocation, and powered-shell markets nationwide, including Northern Virginia, Dallas–Fort Worth, Phoenix, Atlanta, Chicago, Columbus, Salt Lake City, and more. That’s why national recruiting support matters in every major market.
iRecruit.co centers its work on the roles that keep data center projects moving: project managers, field superintendents, schedulers, MEP specialists, commissioning professionals, and preconstruction leaders [68].
These are the people who help keep delivery lined up across civil, structural, electrical, and commissioning scopes. When one of those seats stays open too long, the whole job can start to slip.
iRecruit.co supports employers through several models, including RPO, embedded recruiting, executive search, and role-by-role search [69]. That gives a GC ramping up for a multi-phase campus room to add recruiting support without building an internal team from scratch.
That flexibility matters even more because pay is moving fast in this sector. In data center construction, specialized trade pay runs 25% to 30% above similar construction roles, and top electricians can earn more than $200,000 in 2026 [68].
iRecruit.co tracks permits and capital announcements so workforce planning can start 6 to 18 months before groundbreaking. That head start matters as hyperscaler capex is projected to top $600 billion in 2026 [68].
National recruiting can widen the talent pool, but regional power and permitting limits still shape where hiring gets hardest.
Market-by-market differences create very different staffing conditions. Every region has upside. But each one runs into a different bottleneck: power, land, permitting, or talent.
Here’s the main tradeoff by region:
| Region | Strengths | Constraints |
|---|---|---|
| South (TX, GA) | Strong greenfield pipelines; hyperscale campus volume; relatively affordable land; long-term multi-phase programs | Growing power interconnection queues near Dallas–Fort Worth and Atlanta; rising competition for senior PMs and commissioning leads |
| Midwest (OH, IA) | Abundant land; attractive power rates; long-term campus stability from hyperscale operators; lower operating costs | Limited local pool of specialized data center talent; fly-in/fly-out rotations often required for MEP and commissioning roles |
| West (AZ, UT, NV) | Fastest growth forecast through 2030–2031 [71]; high hyperscale and colo volume; secondary markets emerging fast | Water scarcity, grid stress, and environmental regulations extend preconstruction timelines; complex utility coordination |
| Northeast (NY, NJ) | Dense retrofit and expansion activity; high-value projects; strong demand for preconstruction and commissioning specialists | Tight land availability; complex permitting; union environments; intense labor competition; high delivery complexity |
| Northern Virginia | Largest single hub, with about 11,077 MW of planned capacity [46]; unmatched pipeline depth across hyperscale and colo | Severe land and power constraints; lengthy entitlement processes; intense competition for senior PMs, campus directors, and commissioning leads |
Even with those local differences, the hiring crunch looks pretty similar across all five regions. The same jobs stay tough to fill: senior project managers, commissioning professionals, and MEP specialists.
That lines up with the AGC’s data. The group found that 82% of construction firms struggle to hire hourly craft workers, and 80% struggle to hire salaried workers. Going into 2026, labor availability, not project demand, is the main factor limiting growth [72].
Those regional tradeoffs lead straight to the next issue: how employers staff ahead of the next wave of starts.
Across the regions above, one thing stands out: power, not demand, decides where hiring piles up. In 2026, demand stays high because active projects are packed into a small number of power-ready regions. That makes job demand big, fast-moving, and uneven from one market to the next.
Northern Virginia is still the largest hub. But the center of hiring is moving inland, especially toward Texas and the Midwest. Texas and the Midwest already make up 33% of operational U.S. hyperscale capacity and are expected to account for 53% of new capacity in the next few years.[73] At the same time, most new U.S. data centers are expected to go up in rural areas, with much of that buildout happening in the South and Midwest.[3]
For job seekers and recruiters, the most mobile roles are commissioning engineers, project managers, controls technicians, mechanical pipefitters, journeyman electricians, and HVAC installers. These profiles show severe or critical demand across many hyperscale markets.[70] Put simply, these are the skills that travel well from one major build market to another.
The quick reference below condenses the regional readout into the roles and markets most likely to hire first.
| Market | Best-Fit Roles | Primary Driver |
|---|---|---|
| Northern Virginia | project managers, commissioning engineers, controls technicians | Largest single hub; deepest pipeline |
| Texas | Project managers, mechanical pipefitters | DFW hyperscale pressure |
| Georgia / Atlanta | Mechanical pipefitters, commissioning engineers | High-volume planned capacity |
| Midwest | Controls technicians, commissioning engineers, project managers | Inland hyperscale shift |
| West | HVAC installers, journeyman electricians | Power-constrained growth |
| Northeast | Commissioning engineers, project managers | Specialized retrofit delivery |
The biggest bottleneck isn't project demand. It's labor. In 2025, 40% of North American data center projects were delayed by three months or more because the workers weren't there.[70] For contractors, recruiters, and staffing teams, that changes the game. The groups that lock in mobile mission-critical talent early are likely to have the clearest edge in late 2026.
Focus on regions where developers care more about existing transmission infrastructure and plentiful power than being close to big metro areas.
That shifts attention toward secondary and up-and-coming markets like Columbus, Des Moines, Reno, and parts of Indiana. These places can make more sense when the grid picture is better, even if they don't sit next to a major city.
It also helps to follow high-voltage transmission networks and state-level interconnection queues. That’s often where you spot areas with open capacity, less grid congestion, and a smoother path for new projects.
The roles moved most often are project managers, MEP managers, and commissioning professionals.
These jobs call for specialized mission-critical experience that many growing secondary markets still don’t have on the ground. So companies often bring in senior talent from more established hubs.
That makes sense. These leaders are the people teams lean on when a project involves complex systems, cross-discipline coordination, and integrated testing across regions.
Retrofit markets repurpose existing industrial sites to ease power constraints and stay close to major metro areas. Greenfield campus projects, on the other hand, are built from the ground up on large parcels of land, often in up-and-coming regions, for hyperscale facilities.
Greenfield sites are usually chosen for two main reasons: available land and dependable power. Retrofit projects are more about upgrading or cleaning up existing infrastructure in places where power and space are tight.
