If I had to sum this up in one line: SMR-powered data centers fail on staffing long before they fail on hardware.
I’m looking at a build type that blends two worlds: mission-critical data centers and NRC-regulated nuclear plants. That means the hiring plan has to start early, follow the project phase, and cover roles most data center teams don’t have today. With U.S. data center power use set to nearly double by 2030, TerraPower breaking ground on its 345 MW Natrium plant in April 2026, and DOE pointing to 375,000 more advanced nuclear workers needed by 2050, the staffing gap is easy to see.
Here’s the short version:
A standard hyperscale org chart is not enough here. If I were planning an SMR-backed campus, I’d build the team in four steps: leadership, licensing and engineering, construction and commissioning, and readiness for day-one operations.
| Area | Standard data center build | SMR-powered data center build |
|---|---|---|
| Main regulator | Local building dept., utility | NRC plus local and utility review |
| QA standard | Building-code / ISO style QA | ASME NQA-1 with full traceability |
| Power setup | Grid + diesel backup | Dedicated nuclear unit, grid tie, and site power interface |
| Main hiring gap | Trade and commissioning talent depth | Nuclear licensing, safety, QA, and interface control |
| Biggest risk from late hires | Rework and schedule slip | Rework, schedule slip, and license impact |
If you want the plain answer, it’s this: the right hires depend on when the project is in motion. In this article, I’d focus on which roles matter most, when to bring them in, and where the nuclear-data center handoff tends to break down.
Owners make their biggest mistake when they staff SMR projects like standard builds. That approach doesn’t hold up here. On these programs, the leadership team carries a huge share of the risk.
These roles need to be in place before scope locks. If they’re not, licensing, procurement, and schedule issues start stacking up fast. Early gaps in leadership can add 12 to 24 months and hundreds of millions of dollars on large programs. So program leadership isn’t a late staffing move. It’s the first hiring group.
The Nuclear Project Director is accountable for the full program, not just the reactor and not just the data center. This person ties SMR licensing milestones to data hall design, utility interconnection, and go-live dates. That alignment doesn’t happen by accident. It has to be managed on purpose.
In the U.S., the best candidates usually come from large nuclear or DOE projects, paired with work on multi-billion-dollar EPC programs under strict regulatory regimes. TerraPower's Natrium project in Kemmerer, Wyoming is a good example. The project mobilized about 1,600 workers after receiving its NRC construction permit in March 2026. It also cleared its safety review ahead of schedule and under budget, in part because disciplined program leadership and early workforce planning were in place before mobilization began [1].
The Nuclear Project Director should be hired before or at the start of feasibility. That’s when technology choices, siting decisions, and early commercial structures with utilities and SMR vendors are still taking shape. Waiting until the EPC contract is signed is too late.
With program leadership in place, the next job is making sure scope, budget, and risk stay under owner control.
These roles get lumped together all the time. That’s a problem, because each one has a different job. If one is missing - or if two people think they own the same lane - projects drift.
| Role | Core Duties | Typical Employer | Primary Phase Focus | Schedule Impact |
|---|---|---|---|---|
| Nuclear Project Director / Program Manager | Program governance, integrated master schedule, capital planning, risk management, alignment of SMR vendor, EPC, utility, and data center stakeholders | Owner, utility, or joint-venture program entity | Concept through turnover (full lifecycle) | Sets realistic schedule baseline; integrates nuclear licensing durations |
| Owner's Representative / Owner's Engineer | Protects scope and quality; translates owner's requirements into contracts and design criteria; ensures reporting discipline and decision readiness | Owner, or an independent engineering/consulting firm hired by owner | Feasibility through preconstruction, with oversight during construction | Reduces redesign and change orders by catching misalignment early |
| EPC Manager | Coordinates multi-discipline engineering, long-lead procurement, construction sequencing, site logistics, contractor and subcontractor management | EPC contractor or construction manager | Preconstruction through construction and early commissioning | Directly influences field productivity and critical-path activities |
The Owner's Rep/Owner's Engineer turns owner requirements into technical and contract standards before RFPs go out. Miss that timing, and nuclear safety needs can clash with data center resilience standards halfway through design. That’s when projects get hit with redesign, change orders, and months added to the critical path.
The EPC Manager also needs a seat at the table during feasibility, not just once preconstruction starts. Early EPC input helps test the in-service date, run constructability reviews, and spot long-lead items before procurement starts to slide. Reactor modules, large transformers, and nuclear-grade switchgear can carry 18 to 24 month lead times.
Project Controls is the layer that connects the nuclear program to the data center campus. The Project Controls Lead builds one Integrated Master Schedule that links licensing, design, procurement, interconnection, and fit-out into a single critical path.
This team uses tools like Primavera P6, Monte Carlo risk analysis, and EVM to track performance against cost and schedule baselines in real time. One monthly integrated report gives executives and investors the view they need to make fast, informed decisions.
The timing rule here is simple and firm: Project Controls must be mobilized during feasibility, not after construction starts. Once the site breaks ground, licensing durations, procurement lead times, and workforce ramp-up curves are already shaping the critical path.
Once leadership and controls are in place, the next gate is licensing, safety, and QA.
This is where the project shifts from early planning to the hard technical work that makes it licensable, buildable, and ready for NRC review. These roles sit in the middle of design choices, supplier demands, and field checks.
Licensing Specialists and Regulatory Affairs Leads handle NRC submissions, responses, and license conditions from siting through operations. You need them in place during siting and concept design, before layouts and safety assumptions get locked in. Emergency Planning Zone boundaries, campus layout, security concepts, and safety-system routing all affect what the NRC will accept. Set those too late, and redesign costs can hit hard.
They also own document control so design changes stay traceable and version-controlled. If a change could trigger a license amendment, they need to catch it before that change reaches the field. That's the job.
NuScale's initial SMR design review took 41 months, which shows just how long licensing work can take. [3][7]
Once the license path is clear, the next step is showing that the reactor and the campus can run safely inside that path.
These roles work best as one unit. Safety analysts confirm the reactor safety basis. Systems engineers guard design integrity. Power integration engineers make sure the campus lines up with both utility and reactor needs.
Together, they protect the handoff between reactor output and data center uptime needs. They also check that campus demand doesn't eat into safety margin or push the plant outside its licensed operating envelope.
Systems Engineers manage design integrity across mechanical, electrical, controls, and safety systems. The point is simple: a change in one area can't create a problem in another. That matters most at the interface between the nuclear island and the energy island feeding the data center.
Power Integration Engineers work with utilities and reactor vendors to make sure power quality, redundancy, and fault isolation match the uptime commitments mission-critical loads demand. In plain English, they make sure the plant can support the data center without creating headaches for either side.
After the design holds up on paper, QA/QC has to make sure it holds up in the field.
On a nuclear build, documentation is part of the deliverable, not just the steel, cable, or concrete in place. Nuclear QA/QC Leaders run the NQA-1 program: qualifying suppliers, checking field work, and closing nonconformances before defects hit the critical path. [2][4][5][6]
They set inspection hold points during installation and manage nonconformance reports when something drifts from spec. That means catching problems at the source before an out-of-spec transformer shows up on site or a misrouted cable gets buried in conduit.
Bring QA/QC leaders in 6 to 12 months before vertical construction starts.
The table below shows how these three roles split responsibility across the regulatory and quality landscape:
| Role | Primary Focus | Regulatory Interface | Documentation Burden | Key Risks Mitigated |
|---|---|---|---|---|
| Licensing Specialist | Permit & license strategy | High - direct NRC liaison | High - applications, SARs, license amendments | Regulatory delays, permit denials, siting non-compliance |
| Safety Analyst | Reactor safety basis & hazard analysis | Moderate - technical support for NRC safety reviews | High - Safety Analysis Reports, PRA documentation | Design non-compliance, safety-related rework, loss of safety margin from load swings |
| Nuclear QA/QC Leader | NQA-1 compliance, supplier oversight, field verification | Continuous - manages NRC inspections and site audits | Extreme - traceability of every material, weld, and installation | Fabrication rework, undocumented deviations, construction stop-work orders |
With licensing and QA set, the project moves off the page and into the field. At that point, the handoffs between the nuclear plant and the data center often become the critical path. That's why field leadership and commissioning move to the top of the staffing list.
Construction managers run the full field execution plan. Civil, structural, MEP, and nuclear-adjacent trades all report into that plan. Site managers handle day-to-day coordination, including permit compliance, local inspections, and sequencing work around high-risk zones such as switchyards, substations, and cooling tie-ins. Superintendents handle the technical field work itself.
On an SMR-enabled campus, the build sequence does not look like a standard data center project. High-voltage and substation work has to happen first, before large IT load comes online or the mechanical plant starts up at scale. That changes the staffing need. You need electrical and mechanical superintendents who understand both the nuclear interface and data center redundancy design. If they don't, the job can get bogged down by rework, energization delays, and handoff failures.
Electrical superintendents lead the power path from the SMR switchyard through the main substations, UPS systems, PDUs, branch circuits, and into the data hall fit-out. During energization, they check testing results, relay settings, grounding, and protection coordination across utility and nuclear-linked systems.
Mechanical superintendents own the cooling plant and heat-rejection systems. They sequence flushing, leak testing, and pressure testing so contamination or mechanical failure doesn't show up right before first startup. In a setup like this, that kind of discipline isn't a nice-to-have. It's the difference between a clean startup and a rough one.
Once installation settles down, the job changes. The focus is no longer just building systems. It's proving those systems work together.
Commissioning should begin by late design, not after construction is mostly done. That gives the team time to build testability into the design before turnover. It also closes the loop on the traceability and verification work established during licensing and QA.
A solid commissioning plan moves through a few clear stages:
The goal is simple: show that power, cooling, controls, safety systems, and IT loads all perform together under both normal and fault conditions.
After integrated testing, the last major gap is operational control. Before go-live, the operations, reliability, and maintenance teams need to own the procedures, recovery plans, maintenance approach, spare parts, training, and turnover package.
One role tends to get missed: the interface leader, sometimes called a boundary manager or liaison engineer. This person defines and enforces the handoff procedures between the nuclear plant and the data center. That includes who can initiate load changes, request outages, or approve maintenance on shared assets. If that role is vague, confusion shows up fast - usually at the worst moment.
Getting these teams in place before first IT load helps avoid first-load failures and unstable startup.
| Role | Scope | Project Timing | Interaction with SMR Systems | Contribution to Uptime |
|---|---|---|---|---|
| Mechanical Superintendent | Chilled water plants, cooling towers or dry coolers, heat exchangers, AHUs, CRAH/CRAC units, piping, and valves | Most active from structural completion through MEP rough-in, equipment setting, and startup; continues through early operations stabilization | Coordinates mechanical interfaces between SMR condenser systems and data center thermal management; ensures mechanical changes do not compromise nuclear safety margins or heat rejection capacity | Ensures sufficient, reliable cooling capacity with proper redundancy (N+1/2N) and startup/shutdown sequences that avoid thermal excursions |
| Electrical Superintendent | HV/LV switchgear, transformers, UPS, PDUs, busways, grounding, power distribution, and control wiring from the SMR switchyard to the data hall fit-out | Intensively engaged during electrical rough-in, feeder pulls, terminations, pre-energization, phased power-up, and early load ramp | Manages interfaces between SMR generation, grid interconnection, protection relays, and data center loads; ensures selective coordination and safe energization strategy | Prevents faults, miscoordination, and unsafe energization, and ensures redundancy works as designed |
| Commissioning Manager | Commissioning plan, test scripts, pre-functional checks, functional performance tests, IST, deficiency tracking, and turnover readiness across mechanical, electrical, and controls systems | Ideally engaged from late design through construction and testing; peak activity during pre-functional, startup, IST, and turnover | Coordinates testing of SMR interfaces - power delivery, protection, and heat rejection - with data center systems; aligns test outcomes with regulatory and utility expectations | Validates full system performance under normal and fault conditions, catches design and installation issues before go-live, and delivers reliable, documented systems to operations teams |
Superintendents manage installation. The commissioning manager proves the integrated system works.

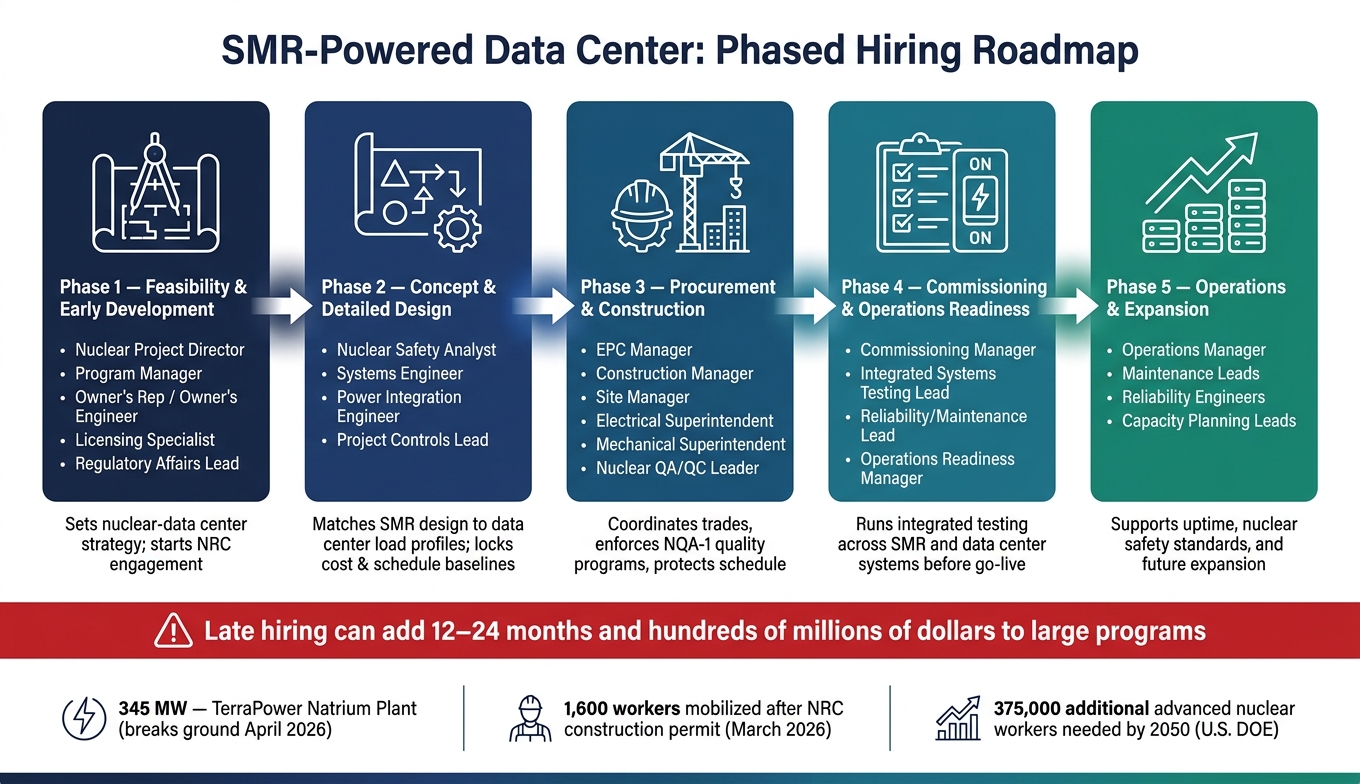

SMR Data Center Hiring Phases: When to Hire Each Role
SMR-powered data centers need a phased hiring plan, not the usual data center staffing playbook. The role map from the earlier phases only works when the right people show up at the right moment. In SMR-enabled data center projects, hiring late does more than slow progress. It can trigger rework and regulatory risk that adds months to the schedule. That’s why sequencing key hires matters just as much as finding them in the first place.
The next move is simple: match each role to the phase where delay does the most damage.
A late-hiring approach on nuclear-adjacent projects is a direct path to schedule risk.
Use the phase map below to sequence hiring, not just fill vacancies.
| Project Phase | Priority Hires | Why Timing Matters |
|---|---|---|
| Feasibility & Early Development | Nuclear project director, program manager, owner's rep, owner's engineer, licensing specialist, regulatory affairs lead | Sets the nuclear-data center strategy, guides site selection, and starts early NRC/local engagement |
| Concept & Detailed Design | Nuclear safety analyst, systems engineer, power integration engineer, project controls lead | Matches SMR design to data center load profiles and redundancy needs while keeping cost and schedule baselines realistic |
| Procurement & Construction | EPC manager, construction manager, site manager, electrical superintendent, mechanical superintendent, nuclear QA/QC leader | Coordinates trades, enforces quality and safety programs, and helps protect the schedule |
| Commissioning & Operations Readiness | Commissioning manager, integrated systems testing lead, reliability/maintenance lead, operations readiness manager | Plans and runs integrated testing across the SMR, auxiliary systems, and data center infrastructure before energization and go-live |
| Operations & Expansion | Operations manager, maintenance leads, reliability engineers, capacity planning leads | Supports uptime, nuclear safety standards, and future expansion readiness |
Once the timing is clear, the next screen is candidate fit.
Screening for these roles is not the same as screening for a standard hyperscale data center build. The review has to cover nuclear and mission-critical IT environments at the same time, and most candidates lean hard in one direction.
The screening focus should stay tight: NQA-1 experience, NRC familiarity, integrated commissioning experience, and field leadership with a low-rework track record. The best candidates don’t treat the NRC like a one-time permitting checkpoint. They treat it as a continuous project partner. Just as important, they escalate deviations right away instead of letting issues sit. In the field, that habit can be the difference between a clean handoff and a painful delay.

One SMR-enabled data center project is a major workforce mobilization. Multi-site delivery takes more than that. It needs a repeatable talent pipeline.
That means shifting away from reactive, requisition-by-requisition hiring and toward a program-delivery model. In plain English, role families, competency profiles, and candidate pools get built once, then reused across projects. That saves time, cuts friction, and keeps hiring tied to delivery needs instead of last-minute scrambling.
iRecruit.co supports this through executive search, specialized recruiting, and RPO built for nuclear-adjacent and mission-critical infrastructure programs. For leadership roles like nuclear project directors, owner's reps, and EPC managers, the work centers on targeted market mapping and discreet outreach into a thin candidate pool that includes operating nuclear plants, naval nuclear programs, DOE facilities, and large hyperscale builds.
For field-critical roles like QA/QC leaders, commissioning managers, and superintendents, the focus shifts to pre-qualified candidate screening against standardized competency frameworks built around NQA-1 experience, commissioning depth, and regulatory familiarity. For high-volume field hiring across multi-site deployments, RPO provides the structure to standardize job profiles, screening criteria, and onboarding workflows so each new project can pull from an existing, validated talent pool instead of starting over.
This model keeps sourcing, screening, and onboarding tied to project-phase risk.
Taken together, these roles make up the delivery chain behind SMR-powered data centers. When these projects stall, the cause is often missed hires, not weak tech or weak funding. That’s the clearest lesson from every phase in this guide, and it’s also the hardest problem to fix once a project is already moving.
The hiring sequence mirrors the delivery sequence. Bring in program leadership before design locks. Add licensing and QA before procurement. Put commissioning in place before test strategy. Build operations readiness before go-live. Miss one of those windows, and the setback can stretch into months.
The U.S. DOE estimates that reaching 200 GW of advanced nuclear capacity by 2050 will require an additional 375,000 workers [1]. That number makes phased hiring part of program delivery, not something to handle in the background.
For developers planning resilient nuclear-adjacent data center programs across the U.S., talent sequencing needs to sit inside the delivery plan. For iRecruit.co, that means building the pipeline before the project hits the market. Scalable SMR-powered data center delivery comes down to hiring the right people at the right phase, every time.
A standard data center team usually doesn’t have the specialized know-how needed for nuclear construction. The gap isn’t just technical. It also shows up in regulation, quality control, and documentation.
SMR projects must meet ASME NQA-1 standards. That means full traceability for every material, weld, and inspection. In plain terms, every part of the job needs a paper trail.
Teams also have to work under ongoing NRC oversight. And in that setting, even a small undocumented deviation can trigger reviews and major schedule delays. That’s a big shift for teams used to standard data center builds, where the documentation burden is far lighter.
There’s also the human side of it. Many standard teams need 6 to 12 months of specialized training before they can work safely in controlled nuclear areas.
For nuclear-powered data center projects, the first priority is nuclear leadership roles. These projects hinge on NRC compliance and NQA-1 quality standards, so those hires need to be in place before preconstruction wraps up. That’s how you protect the critical path.
Start with nuclear construction project managers, along with nuclear safety engineers and NRC licensing and regulatory affairs specialists. Their expertise is needed for permitting, safety analyses, and documentation that can’t be patched up later.
Teams often use Integrated Project Delivery to bring owners, technology providers, and EPC firms into a single agreement. The goal is simple: cut down on fragmentation and keep decisions moving in the same direction.
Clean handoffs also rely on interface management coordinators. They link factory module deliveries to on-site foundation work, so one side doesn’t get ahead of the other. Commissioning engineers play a different but equally important role. They check and verify systems before final turnover.
It also helps to involve commissioning and operations teams early, while the project is still in design. That gives teams time to define test readiness and sort out who owns failover sequences before those issues turn into last-minute problems.
