Per-MW pricing, regional variance, and cost drivers for owners scoping hyperscale & AI builds.
Salary benchmarks across the 14 mission-critical disciplines.
If you wait to staff fab roles until field work ramps, you’re already late. In 2026, fab projects will compete in a labor market that needs about 300,000 more skilled workers for U.S. semiconductor projects and 349,000 net new construction workers overall. For me, the takeaway is simple: staffing has to be planned like equipment, permits, and long-lead materials.
Here’s the short version:
I’d break the article down like this:
A simple way to look at it: if you miss early hires like a project executive, lead superintendent, MEP manager, process utility lead, OEM coordinator, or commissioning manager, that delay keeps moving downstream. One late role can turn into missed hook-ups, idle tools, rework, and later wafer starts.
My bottom line: the article is not just about hiring more people. It’s about hiring the right people, in the right order, with enough lead time to protect tool set, turnover, and 2026 production dates.

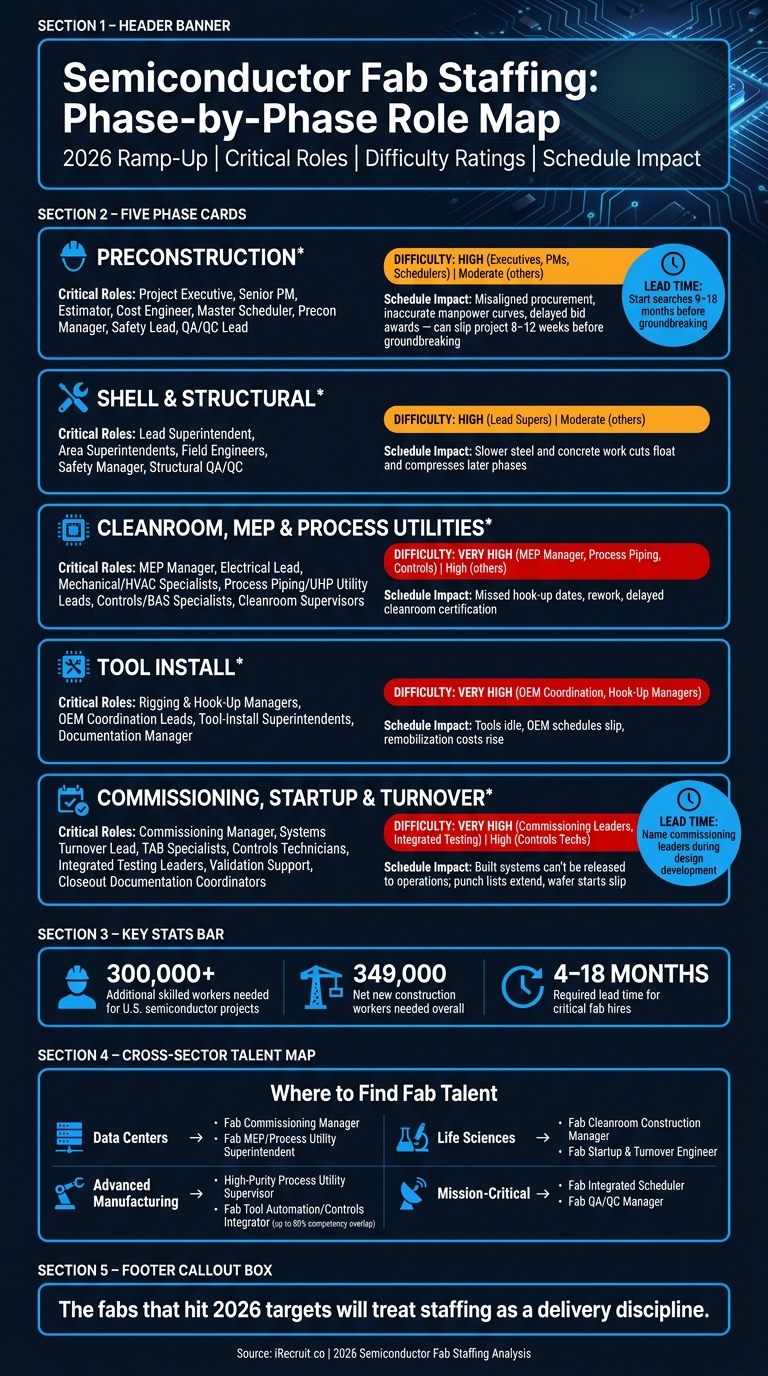

Semiconductor Fab Construction: Critical Roles, Lead Times & Staffing Risks by Phase
Fab staffing works best when you track it across four phases: preconstruction, shell and structural, interior build-out, and commissioning. The interior phase then breaks into four staffing tracks: cleanroom, MEP, process utilities, and tool install. If one key hire is late in the wrong phase, the damage doesn't stay contained. It rolls forward and hits the next phase harder. So this isn't just about total headcount. It's about filling the right roles before they become the critical path. Regional labor pressure only turns into a schedule problem when it hits these jobs.
Use the map above to put leadership hires ahead of trade labor.
Preconstruction hires shape procurement, labor loading, and risk control, so they need to be in place before design gets too far down the road. If master scheduling starts at 60% design, bid packages can fall out of sync and long-lead equipment can slip by 8–12 weeks. Those early roles set labor curves, procurement timing, and release dates for shell, MEP, and tool install.[4][6]
The toughest early searches are usually project executives and lead superintendents with cleanroom or microelectronics experience. Start those searches 9–18 months before groundbreaking. That may sound early, but these people often stay with a small group of major EPCs or GCs. In many cases, it takes a strong relocation package or a broader program role to get them to move.[6]
Once the shell is enclosed and cleanroom build-out starts, the pressure shifts fast. MEP managers, ultra-high-purity (UHP) pipefitters and welders, cleanroom supervisors, controls and BAS specialists, and OEM coordination leads become the main choke points. And they usually stay that way through tool install.
A UHP piping lead handles orbital welding, cleanliness verification, pressure testing, and documentation. A cleanroom supervisor deals with contamination control, airflow and filtration rules, and access logistics across multiple trades in a live clean-build setting. TSMC's Fab 21 in Arizona also highlighted the shortage of cleanroom labor that meets fab standards.[5] OEM coordination leads help keep tools from sitting idle while utilities and hook-ups catch up. When that role is missing, vendor schedules and owner milestones both take the hit.
Commissioning talent is tough to line up because these roles mobilize late, while the strongest candidates are often already tied up on other mega-projects.[1][3]
In semiconductor work, commissioning goes well beyond standard commercial commissioning. It calls for tight coordination across owners, trade partners, QA/QC, and validation teams inside a regulated manufacturing setting.[3] TAB work by itself can stretch across interstitial and subfab levels above and below the cleanroom, which adds a layer of difficulty that doesn't show up on paper.[1] Automation-heavy fabs also need robotics test and programmer-technician hybrids.[2] These roles help protect tool readiness and start-of-production dates. That's why owners and GCs should name commissioning managers and systems turnover leads during design development, not when installation is almost done.
These phase-specific gaps shape the hiring plan in the next section.
A phased hiring plan protects permit-to-tool timelines by linking each hiring move to a project milestone: permit release, steel start, dry-in, and tool set. When that link is tight, labor demand and labor supply move together.
On fab jobs, staffing sits on the critical path from permit release to tool set. So the job isn’t just to “hire fast.” It’s to hire in the right order, at the right time, based on what the field will need next.
Start with leadership. Then bring in field engineers and superintendents before shell work hits its peak. After that, add specialty leads before installation demand climbs. Tool-move and commissioning crews should be in place ahead of tool arrival.
This staggered approach keeps labor lined up with field demand instead of forcing the project to scramble later.
That sequence should shape the manpower curve for each trade package.
Build manpower curves from work sequence and production rates, not square-foot ratios or budget percentages. That’s the difference between a hiring plan that looks fine on paper and one that holds up in the field.
Electrical and mechanical staffing climbs as shell completion opens more work fronts. Piping and controls grow during MEP rough-in and process utility tie-ins.
Cleanroom and process utility scopes need more labor packed into a smaller window, along with tighter quality control. Weekly manpower forecasts, installed-quantity tracking, and earned-progress reviews give teams a way to recalibrate labor demand as the job changes, instead of sticking with old assumptions that no longer match field conditions.
The table below turns common staffing risks into schedule language so teams can react before the hit shows up on the timeline.
Once the labor curve is set, the next step is figuring out how to source and keep the people who can fill it.
Local hiring helps, but it won’t cover every specialty role. In most 2026 fab locations, commissioning leads, process utility leads, controls specialists, and tool-install coordinators will need travel labor, temporary assignment packages, or full relocation support.
Use per diem for short assignments. Use relocation for long-duration roles. Use retention incentives for positions tied directly to milestone dates.
The bigger problem is bringing in travelers too late. Once a critical hire lands after the project is already under strain, unclear assignment length and unstable schedules can push turnover up fast. And when a commissioning manager or process utility lead leaves midstream, the disruption doesn’t stay in one lane. It ripples across downstream work in several scopes.
Make travel and relocation calls before offers go out.
That sets up the talent channels in the next section.
Hiring for a mission-critical build? Get a pre-qualified shortlist.
iRecruit.co specializes in construction recruiting for data center, energy, and advanced-manufacturing projects — project managers, MEP coordinators, commissioning leads, and more. We pre-screen every candidate so only qualified professionals reach your hiring team.
Get Started
Success-based pricing · 90-day replacement credit · No upfront fee on single roles
Once leadership roles are clear, the fastest hires usually come from nearby industries. For 2026 ramp-ups, adjacent-sector hiring is the fastest path.
A broader search helps protect the 2026 ramp schedule. The reason is simple: people from sectors that already work in mission-critical, tightly controlled settings can get productive faster in fab work.
Data center teams are a strong source for commissioning managers and MEP superintendents. They already know integrated systems testing, documentation-heavy turnover, and startup sequences that run on tight schedules. Life sciences brings in cleanroom construction managers who have GMP contamination control and strict turnover documentation in their background. Advanced manufacturing is a fit for process utility and automation roles, where there can be up to 80% competency overlap with semiconductor technician work, especially in mechatronics and automation-adjacent scopes.[8]
The table below shows where these hires can come from, what fab role they map to, and what training closes the gap.
The practical move is to map the role first, then close the gap with short fab-focused onboarding. Train transfers on cleanroom standards, high-purity systems, and fab turnover rules. After that, pair them with an experienced fab mentor. That kind of handoff can save a lot of time.
After leadership and specialist hires, local pipelines supply the long-duration craft base. This is urgent because the scale is huge: TSMC's Arizona investments are expected to create around 40,000 construction jobs over four years.[10]
The strongest local pipeline plans usually combine three channels:
Veterans are another channel that often gets missed. Military specialties can map well into MEP, commissioning, and logistics roles. Programs like Helmets to Hardhats and advanced manufacturing transition initiatives already provide paths into construction trades.[7][9] Fast-track training into commissioning technician or construction foreman paths can help, especially when paired with the multi-year job stability that large fab programs offer.
When internal sourcing slows during peak mobilization, outside recruiting support helps keep offers moving. Project-specific recruiting is especially useful during cleanroom build-out and tool install, when hiring demand can spike all at once.
iRecruit.co provides construction recruiting support with experience across data centers, advanced manufacturing, and pharmaceutical manufacturing facilities. For fab projects, that includes sourcing and screening project managers, project executives, estimators, schedulers, MEP leads, commissioning managers, and field-level construction talent across cleanroom, process utility, and tool install scopes.
Its RPO model covers job postings, candidate sourcing, initial technical screening, and interview coordination. That gives project leadership more time to stay focused on delivery. Pre-qualified candidate screening also filters for fab-specific fit, such as mission-critical experience, exposure to cleanroom or high-purity systems, and relocation or travel readiness. That cuts down on mismatched hires and helps shorten time-to-offer when schedule pressure is at its highest.
Recruiting capacity can expand during peak mobilization and then contract as staffing levels settle down. That gives teams support when they need it without carrying permanent overhead across the full program lifecycle.
Milestone-based staffing works better than reactive backfilling. That’s why a phase-based role map should be the starting point.
The toughest roles to hire - MEP and process utility leaders during shell and build-out, tool-install managers during hook-up, and commissioning engineers plus cleanroom QA/QC specialists during startup and turnover - usually need 4–9 months of lead time before peak activity.[11] Cross-sector sourcing can help, but only if it comes with fab-specific onboarding and training.
Those hires stay on track when labor demand is tied to each project phase. Use manpower curves, phase-based role maps, early forecasting, relocation support, and retention incentives to protect tool-set, startup, and turnover dates.
Turn that playbook into action:
The fabs that hit 2026 targets will treat staffing as a delivery discipline.
Fab staffing should begin well before construction starts - ideally before contracts are even signed.
That early team should include core leaders such as project executives, development managers, and commissioning leaders. Getting those people in place early helps the project move faster through key early-stage decisions like land acquisition, utility commitments, and long-lead equipment procurement.
It also pays to spot skill gaps 6–12 months ahead of time. If you wait until the pressure is on, hiring turns into a scramble.
Roles like MEP leaders and commissioning experts should come in during the design phase, not later. That timing helps teams catch issues early and avoid delays once work is underway.
The toughest fab jobs to fill are the ones that call for deep technical skill and direct experience in regulated settings. That’s especially true for Process Piping Specialists, Commissioning Managers, and MEP trades like electricians, pipefitters, and mechanical engineers who know how to work in ultra-cleanroom conditions.
There’s also strong demand for Senior Project Managers, Lead Superintendents, and metal fabricators. These roles aren’t easy to step into. They usually take years of hands-on training to meet strict fab standards.
Use a Build-Buy-Borrow approach: train internal staff through apprenticeships, hire from outside, and bring in temporary staff when you need more flexibility.
Look for skill gaps 6–12 months in advance through workforce audits and hiring forecasts. If local shortages keep dragging on, go after passive candidates from data centers, life sciences, and advanced manufacturing who can bring over transferable MEP, commissioning, and cleanroom experience. And when key deadlines are on the line, be ready to add traveling crews to keep critical milestones on track.
