If you want the short answer: a Commissioning Manager runs testing and turnover for the project team, while a CxA checks the work for the owner. That split changes scope, authority, schedule pressure, travel, credentials, and pay.
I’d break it down like this:
If I were choosing between them, I’d use one simple filter:
| Criteria | Commissioning Manager | Commissioning Authority (CxA) |
|---|---|---|
| Who they work for | GC, EPC, CM, MEP firm, or trade partner | Owner or owner’s rep |
| Main job | Run testing and turnover | Check that systems meet the OPR |
| Authority | Moves startup and turnover work | Supports acceptance and owner sign-off |
| Project phase | Late design to turnover | Pre-design to early operations |
| Daily focus | Field execution | Verification and documentation |
| Common background | MEP PM, startup, controls, field ops | M/E engineering, field commissioning, owner-side review |
| Travel | Often site-based | Often 60%–90% for field roles |
| 2026 U.S. pay | $175,000–$240,000 base | $110,000–$215,000 base |
Bottom line: I see these as two separate career tracks on the same project. One gets systems ready to hand over. The other makes sure the owner gets what was asked for.
The Commissioning Manager (CxM) leads field testing and turnover from inside the project team, most often for the GC, EPC, CM, or a major trade partner. The goal is simple: keep testing, deficiency closeout, and turnover moving together so energization and occupancy don't slide. This is an execution-heavy role centered on sequence, coordination, and turnover pace.
On mission-critical projects, the CxM owns the commissioning schedule, lines up pre-functional and functional testing, manages OEM startup, and tracks deficiencies from the moment they show up to final closure. On a data center job, that usually means generator load testing, UPS and switchgear sequences, chilled water plant validation, and BAS/EPMS point-to-point verification.
Integrated Systems Testing (IST) shows whether systems operate together under simulated outage conditions. In mission-critical settings, backup systems have to respond the way the design says they should. The CxM is the person on the hook for confirming that readiness before turnover.
At closeout, the CxM pulls together the turnover package: final commissioning reports, as-built drawings, maintenance manuals, and compliance certificates. A project can have systems ready to go, but late paperwork can still hold up turnover.[5]
The CxM usually reports to a Project Director or Construction Manager and is most active from late design through turnover. They don't own the OPR, but they should review it early to spot design gaps that could stall commissioning before construction locks the design in place.[5] Getting involved early cuts down on late rework and helps keep energization dates intact.
Strong CxMs often come from MEP project management, electrical startup, controls, or military technical leadership, including Navy Nuclear. Field-based mission-critical operations experience is also a solid path into the role.
A CxM needs hands-on fluency with switchgear, UPS systems, generators, transfer sequences, chilled water plants, and BAS/EPMS point-to-point verification. Just as important, they need the trade coordination and documentation discipline to keep complicated turnover sequences from drifting off course. On U.S. mission-critical sites, safety credentials such as NFPA 70E and OSHA 30/510 are standard expectations.
Common tools include CxAlloy, BlueRithm, Facility Grid, Primavera P6, and Procore.
In 2026, CxM base pay usually falls between $175,000 and $240,000, with senior total compensation reaching $210,000 to $310,000.[4] Liquid cooling experience carries a 15%–20% premium.[4]
| Project Type | Key Duties | Primary Deliverables |
|---|---|---|
| Data Center | Generator load testing, UPS/switchgear sequences, IST coordination | IST reports, load bank results, deficiency logs |
| Power/Utility | Protection relay testing, transformer startup, NETA coordination | NETA-certified reports, energization plans |
| Healthcare | Air pressure regime testing, life safety integration, med-gas verification | Certification packages, sequence of operations validation |
| Advanced Mfg. | Process cooling validation, cleanroom balancing, BAS point-to-point | Turnover packages, TAB reports, systems manuals |
That field execution role is different from the owner-side CxA, whose job is to verify the work and govern acceptance.
The Commissioning Authority (CxA) serves as the owner's independent verifier. In plain terms, the CxA checks that the project meets the OPR and contract requirements, while staying separate from the construction team and design engineer. That owner-side role changes the job in a big way: it affects what the CxA is responsible for, when they get involved, and how they decide whether a system is ready for acceptance.
The CxA often comes on board before schematic design. At that stage, they may help define the OPR, then review the Basis of Design, commissioning specs, submittals, and shop drawings for commissionability. The goal is simple: catch scope gaps before equipment is installed and problems get expensive. From there, the CxA builds the commissioning plan and schedule. [1]
During construction, the CxA writes functional performance test (FPT) procedures, witnesses testing, and tracks deficiencies through closure. On data center projects, that usually means progressive commissioning and integrated systems testing, including outage simulation for backup power and cooling. At turnover, the CxA delivers the final commissioning report, systems manual, updated O&M documentation, and training materials. Each of those items supports cleaner acceptance and faster turnover. [1]
That scope also affects who the CxA reports to and what kind of background employers want to see.
The CxA reports to the owner or the owner's representative. That reporting line helps protect objectivity during acceptance decisions and keeps the verification role separate from construction pressure. Employers often want a mechanical or electrical engineering background, plus 7 to 15+ years of field experience and familiarity with mission-critical systems such as power chains like UPS, generators, and switchgear, along with cooling/HVAC and complex control systems such as BMS/EPMS. [3][1]
Engagement usually starts in pre-design and continues through early operations, including staff training and post-occupancy follow-up. In 2026, employers commonly look for BCxA, ACG CxA, or ASHRAE BCxP credentials. A Professional Engineer (PE) license often adds about $12,000 to $25,000 in salary leverage. In practice, hiring managers often care more about sector-specific mission-critical experience, especially in data centers, power generation, or advanced manufacturing, than credentials alone. [4]
The CxA's value does not come from hands-on installation work. It comes from systems thinking, tight documentation, and the ability to coordinate a complex verification process across many trades without losing sight of the full picture. Strong CxAs write clear FPT procedures, lead technical meetings, manage owner communication, and keep issue logs moving toward closure while staying independent from construction pressure. [1][3]
For field-based CxAs, travel is a big part of the job. Many should expect 60% to 90% travel, often in 3- to 5-week on-site rotations with one week at home. Pay reflects that level of commitment. Mid-level CxA roles usually land in the $110,000 to $155,000 base range, while senior and lead engineers reach $165,000 to $215,000 base. Total compensation can climb to about $260,000 with bonuses and overtime. [4] Base pay also shifts by market, with the top end often found in Silicon Valley, Northern Virginia, and Seattle.
Those gaps stand out even more when you compare CxA decision-making authority with CxM execution.

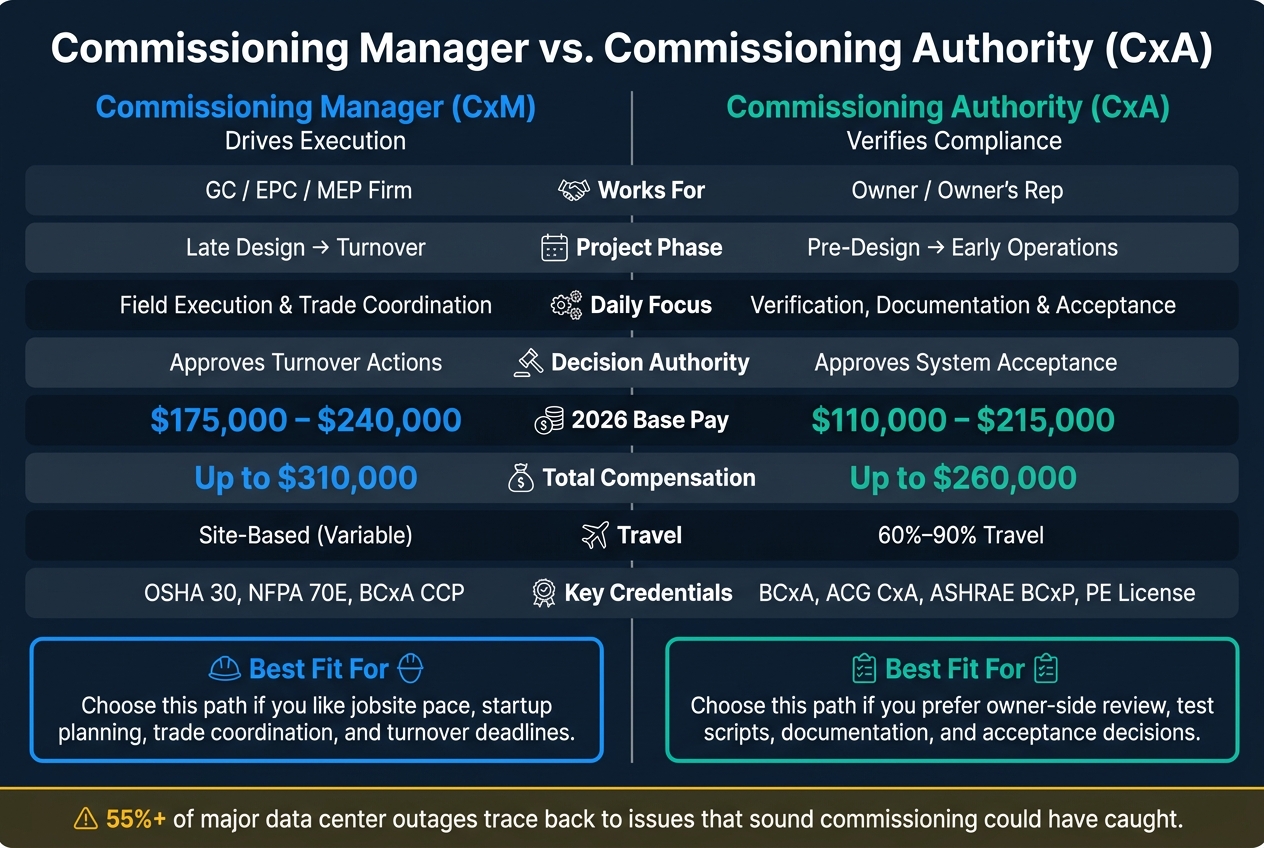

Commissioning Manager vs CxA: 2026 Salary, Role & Career Comparison
The most useful way to compare these roles is pretty simple: look at who they serve, what they own, and how their work gets judged.
The biggest difference comes down to employer and accountability. A Commissioning Manager usually works for a general contractor, MEP subcontractor, or commissioning firm. That role is tied to startup and turnover readiness. A CxA usually works as an independent third party for the owner. That role is there to verify that building performance lines up with the design intent and the OPR.
Side by side, the gap is easier to see.
| Category | Commissioning Manager | Commissioning Authority (CxA) |
|---|---|---|
| Employer | General Contractor / MEP Firm / Cx Firm | Owner / Developer |
| Accountability | Reports to GC or Project Executive | Reports directly to Owner |
| Focus | Field execution, startup, schedule certainty | Independent verification, governance, OPR compliance |
| Decision Authority | Approves turnover actions | Approves acceptance |
| Project Phase | Mid-construction through turnover | Pre-design through first year of operations |
| Field Presence | High; daily trade leadership | High during testing and inspections |
| Deliverables | Startup checklists, punch lists, IST coordination | Cx Plan, FPT scripts, Final Cx Report |
| Success | Systems operational by turnover date | OPR compliance and IST readiness confirmed |
| Independence | Part of the project delivery team | Third-party, independent advocate |
For candidates, the better question isn’t which title sounds stronger. It’s which kind of work fits the way you like to operate.
Go toward the Commissioning Manager path if you like fast-moving field coordination, hands-on troubleshooting, and keeping turnover under control when the schedule gets tight. It tends to suit people who are comfortable in the middle of jobsite pressure and daily trade coordination.
The CxA path makes more sense if you prefer getting involved earlier in design, working on the owner side, and handling verification and documentation with care. Many CxAs begin in Commissioning Engineer or Commissioning Manager roles, then move into the owner-side review role later.
On paper, the line between the two roles looks clean. On big projects, it often isn’t.
On large mission-critical jobs, both roles can overlap during integrated systems testing, deficiency closeout, and turnover. If issue-log ownership isn’t spelled out, teams often end up with duplicate logs and clashing test scripts.
The most common friction points show up around unclear control of outage simulation tests and late OPR alignment. Clear ownership of issue logs and test script reviews usually cuts down these problems before they hit the schedule.
Most mission-critical commissioning careers begin in the field. People usually start as Commissioning Engineers or technicians, then spend 5–8 years building working fluency across power, cooling, controls, and integrated systems testing before stepping into more senior commissioning roles [3][4].
Some U.S. markets stand out right now: Northern Virginia, Phoenix, Dallas-Fort Worth, Columbus, and Atlanta. Northern Virginia also tops the pay charts, with a median base salary of $148,000 in 2026 [4].
Credentials can help, but they matter most when they line up with hands-on project work. BCxA CCP and ACG CxA are strong signals. Add OSHA 30 and NFPA 70E, and a candidate often looks more attractive in hyperscale and liquid-cooling work. Those same signals also make screening easier for employers.
For employers, the hiring screen should move past credentials alone and focus on project depth. The big thing is fit: fit for the asset class, fit for the testing scope, and fit for the pace of the job.
A few markers tend to tell the story better than a résumé summary:
That matters because experience doesn’t always transfer neatly. A healthcare commissioning background does not automatically prepare someone for data center IST. And hyperscale experience, while strong, does not always map cleanly to every other complex facility type.
For CxA hires, one point is non-negotiable: they must remain independent from the contractor team [3][1].
The split between these roles comes down to a simple choice: own execution or own verification.
The Commissioning Manager sits on the contractor side. This person drives startup, coordinates trades, and pushes systems to operational status by the turnover date. The CxA, by contrast, serves as the owner’s independent advocate from pre-design through occupancy. Their job is to confirm that the facility meets the Owner's Project Requirements and the design intent [3][1].
If you want field execution and turnover control, the Commissioning Manager path makes sense. If you want owner-side verification and governance, the CxA path is the better fit. Both roles are in high demand, and both reward deep technical skill.
Choose based on whether you prefer project execution or independent oversight.
A Commissioning Manager (CxM) works as part of the project team. They coordinate testing, manage schedules, and help solve issues as they come up.
A Commissioning Authority (CxA) acts as the owner’s independent representative. They check that the project meets the design intent and that contractors do what they’re supposed to do.
A lot of people spend 5 to 8 years as a Commissioning Engineer before moving into one of these two paths.
Yes. A lot of professionals start with hands-on testing, move into management, and later step into a Commissioning Authority (CxA) role.
A Commissioning Manager can build that path through work in Integrated Systems Testing, stakeholder communication, system performance verification, and operational readiness. A certification such as Certified Commissioning Authority (CxA) can also help confirm that move.
For Commissioning Authorities (CxA), the certifications people recognize most often are CxA, CCP, and BCxP. They show commissioning know-how and are often required on federal or state-regulated projects.
Commissioning Managers often hold the same certifications, along with a PE license. Other useful credentials include LEED AP, OSHA 30, NETA, and manufacturer-specific training for mission-critical equipment like UPS and switchgear.
