Building biotech cleanrooms requires strict adherence to ISO classifications, which dictate air cleanliness levels critical for producing cell therapies, vaccines, and biologics. Here's what you need to know:
Takeaway: Early alignment on ISO requirements, careful cost management, and hiring experienced teams are critical for biotech cleanroom success.

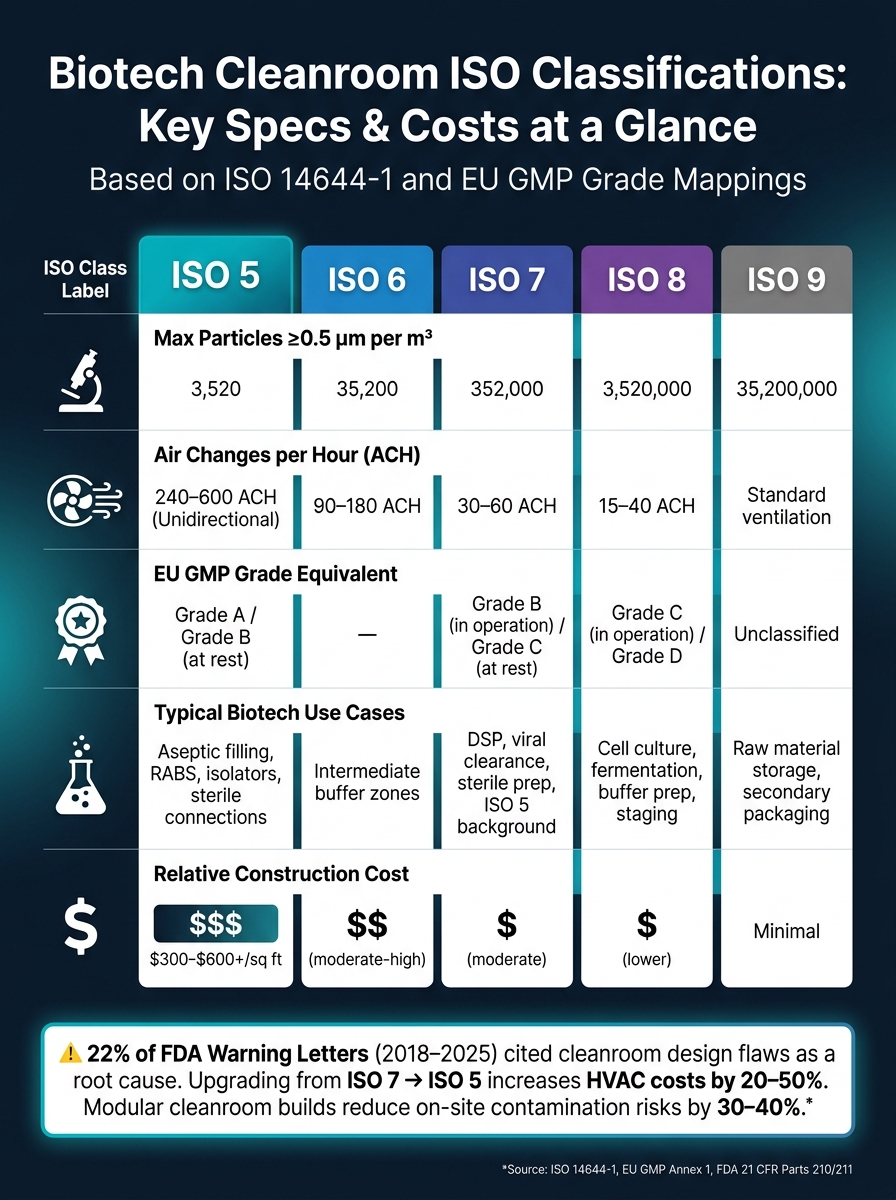

Biotech Cleanroom ISO Classifications: Key Specs & Costs at a Glance
ISO 14644-1 lays out the standards for cleanroom classifications, defining nine levels based on the maximum allowable concentration of airborne particles per cubic meter of air. These range from ISO Class 1 (the cleanest) to ISO Class 9 (essentially normal room air). Measurements are taken using discrete-particle counters, which sample various points within the cleanroom to ensure compliance.
For biotech applications, the focus is primarily on ISO Classes 5 through 8, as shown in the table below:
| ISO Class | Max Particles ≥0.5 µm per m³ | Max Particles ≥5.0 µm per m³ | Fed Std 209E Equivalent |
|---|---|---|---|
| ISO 5 | 3,520 | 29 | Class 100 |
| ISO 6 | 35,200 | 293 | Class 1,000 |
| ISO 7 | 352,000 | 2,930 | Class 10,000 |
| ISO 8 | 3,520,000 | 29,300 | Class 100,000 |
| ISO 9 | 35,200,000 | 293,000 | Room Air |
Table 1: ISO 14644-1 Particle Limits
Each increase in ISO class represents a 10-fold jump in allowable particle levels. These thresholds influence critical aspects of cleanroom design, including HVAC system capacity, air change rates, and construction requirements, all of which impact costs.
In biotech, each ISO class corresponds to specific activities, determined by the level of contamination risk the process can handle. Understanding these mappings early in the design phase helps avoid costly modifications later. For further insights into construction strategies for critical facilities, check out this construction project delivery guide.

For biotech facilities, aligning ISO classifications with regulatory frameworks like EU GMP and cGMP is essential, especially for global operations. While ISO 14644-1 focuses solely on particle counts, EU GMP Grades A through D introduce microbiological limits and procedural requirements such as gowning and airflow specifications.
A key difference is that EU GMP evaluates cleanrooms in two states: at rest (equipment running, no personnel) and in operation (active production with personnel present). This distinction significantly impacts HVAC design, as the system must ensure compliance under both conditions.
| EU GMP Grade | ISO Class (At Rest) | ISO Class (In Operation) | Microbial Limit (CFU/m³) |
|---|---|---|---|
| Grade A | ISO 5 | ISO 5 | <1 |
| Grade B | ISO 5 | ISO 7 | <10 |
| Grade C | ISO 7 | ISO 8 | <100 |
| Grade D | ISO 8 | Not Defined | <200 |
Table 2: EU GMP Grades Mapped to ISO Classes
For example, Grade B areas must meet ISO 5 standards at rest and ISO 7 during operation. Bridging this gap is a critical function of the HVAC validation protocol. As the KVRM Engineering Team points out:
"The bridge between ISO 14644 and EU GMP Grade A/B/C/D is the HVAC validation protocol, not the specification sheet."
In the U.S., FDA cGMP regulations under 21 CFR Parts 210/211 reference ISO 14644-1 for classification but don’t require compliance with EU GMP grades. However, facilities intending to distribute globally should design with EU GMP standards in mind. Retrofitting for additional monitoring or compliance measures, like viable particle tracking or pressure cascade documentation, can be far more expensive than incorporating these elements during initial construction.
ISO classification isn't just a technical label - it shapes how a cleanroom is built and operated. A key factor in cleanroom design is the air change rate (ACR), which measures how often the HVAC system replaces air to remove contaminants. The difference between ISO classes is striking: an ISO 5 cleanroom requires 240–600+ air changes per hour (ACH) with unidirectional (laminar) airflow, while an ISO 8 gowning room only needs 15–40 ACH with non-unidirectional (dilution) airflow.
Higher ACH requirements mean more complex HVAC systems. As ACH Engineering points out:
"Decisions about ISO classification, construction method, and HVAC design made in the first 60 days determine 70–80% of your total cost and schedule."
Over-engineering to meet ISO 5 standards when ISO 7 is sufficient can inflate HVAC costs by 20–50% without adding value. A more efficient solution could involve using an ISO 5 biosafety cabinet within an ISO 7 room, which reduces costs significantly while maintaining functionality.
Pressure differentials are another critical design element. To prevent cross-contamination, adjacent rooms of different classifications must maintain a pressure difference of 10–15 Pascals (Pa). This pressure cascade must hold steady under both at-rest and in-operation conditions, adding complexity to HVAC planning. Addressing these requirements from the start ensures smooth construction management (CM) execution. For project teams, understanding these interconnected systems early can help avoid delays and keep everything on track.
Once design parameters are set, the cleanroom's structure and mechanical, electrical, and plumbing (MEP) systems must align with these standards.
The FDA's cGMP regulations under 21 CFR 211.42 mandate that surfaces - walls, floors, and ceilings - must be smooth, hard, and easy to clean to avoid particle buildup and microbial growth. This typically involves:
HVAC systems often account for 25–40% of total project costs. ISO 5–7 cleanrooms require HEPA filtration (99.97% efficiency for particles 0.3 µm in size), while more stringent environments may need ULPA filters. Redundancy is critical in biotech facilities where HVAC failures in ISO 5 areas could jeopardize entire production batches. Incorporating an Environmental Monitoring System (EMS) during construction helps track temperature, humidity, pressure, and particle counts.
The construction sequence itself is crucial. Clean build protocols require HVAC ductwork to be installed before wall finishes, and the building envelope must be sealed before HEPA filters are added. Activities like on-site cutting and drywall installation can introduce contaminants, delaying progress. Prefabricated modular cleanroom systems help mitigate these risks by manufacturing panels in controlled environments, reducing on-site particulate generation by 30–40% compared to traditional methods. Following these protocols minimizes compliance risks and simplifies project validation.
Construction is only part of the process - achieving ISO compliance requires rigorous validation. A cleanroom must pass a structured qualification process before it can be used for production. Missteps in design or material selection can result in certification failures, costing $50,000–$200,000 and delaying projects by 3–6 months.
The qualification process includes four key phases:
| Phase | Purpose |
|---|---|
| Design Qualification (DQ) | Ensures the design meets the User Requirements Specification (URS) and ISO 14644 standards before construction begins. |
| Installation Qualification (IQ) | Confirms systems like HVAC, filters, and sensors are installed according to design specifications. |
| Operational Qualification (OQ) | Tests particle counts and pressure differentials in an "at-rest" state (equipment running, no personnel). |
| Performance Qualification (PQ) | Verifies compliance in an "in-operation" state with active equipment and personnel. |
Before ISO certification tests, the HVAC system should run continuously for 24–72 hours. For ISO 5 zones, smoke studies are also required to confirm that unidirectional airflow effectively removes contaminants from critical work areas.
Certification is not the end of the road. ISO 14644-2 mandates particle count retesting every 6 months for ISO Class 5 and cleaner, and every 12 months for ISO Classes 6 through 9. Building this requalification schedule into the operational plan from day one helps avoid compliance gaps. It's worth noting that cleanroom design or construction defects were identified as root causes in about 22% of U.S. FDA Warning Letters issued between 2018 and 2025.
For construction management (CM) teams working on ISO-driven projects, addressing ISO classifications right from the start is non-negotiable. It all begins with a well-defined User Requirements Specification (URS) - a document that outlines the intended use, target ISO class, and environmental conditions before the design phase even kicks off. Without this, teams risk inaccurate engineering estimates, overbuilt designs, and validation headaches.
An early Design Qualification (DQ) review ensures the design aligns with the URS, significantly reducing the chances of costly last-minute changes. During the conceptual phase, developing a Contamination Control Strategy (CCS) is crucial. This approach helps identify design flaws - like poor airflow paths or problematic structural penetrations - when adjustments are still manageable. Instituting clear milestones, such as a "Design Freeze" and "HVAC Freeze", ensures engineering and validation stay aligned, avoiding expensive disruptions later on.
Involving key stakeholders - production, quality, maintenance, and engineering - early in the process can prevent over-specification that might inflate budgets by 30–50%. The ultimate aim is to deliver a cleanroom that meets compliance standards without being oversized or overengineered.
For CM teams managing the entire project delivery process, understanding how various construction delivery methods impact team roles and accountability is key. With meticulous planning in place, the focus can shift smoothly to disciplined execution in the field.
When construction begins, contamination control moves from theory to practice. A phased clean-build protocol becomes essential to maintain positive pressure and control contamination. The sequence is critical: finish all "dirty" tasks - like framing, utility rough-ins, and core drilling - before moving on to final finishes. Seal the building envelope before installing HEPA filters, and activate HVAC systems progressively as each zone is completed.
Entry control measures play a big role in keeping contamination at bay. Use tacky mats, controlled access points, dedicated gowning areas, and supervised material staging. Every component entering a classified zone should be cleaned beforehand and stored in a controlled staging area away from active construction.
Paul Wilson, Global Director of Protoclean Protocol at ACM, describes the process succinctly:
"Protoclean is quality control for clean-build construction of cleanrooms."
Real-time environmental monitoring is another critical tool. Tracking factors like particle levels, temperature, humidity, and pressure can flag issues early, preventing contamination from becoming a certification roadblock. Addressing pressure differential challenges during construction also helps avoid delays during Operational Qualification.
Executing field protocols effectively requires the right expertise, which leads to the next critical component: hiring specialized talent.
Even with strong planning and field protocols, the success of cleanroom projects depends on having the right people on the team. The technical demands of biotech cleanroom construction are intense. HVAC systems, for instance, must handle up to 360 air changes per hour, and the facility must pass IQ, OQ, and PQ validations before production can begin. A single compliance failure could lead to an FDA Official Action Indicated (OAI), halting operations entirely.
Anthony Horsfield, Senior Project Manager at ISO Cleanroom, emphasizes this point:
"In this industry, if you don't get it right the first time, the cleanroom won't be certified and the client cannot begin their work."
Key roles include project managers with experience in GMP facilities, MEP coordinators who grasp the critical link between ISO air cleanliness and mechanical systems, and commissioning leads who can oversee the 6–12 month validation process. These positions require specialized knowledge, and filling them with the wrong candidates can result in costly setbacks.
Specialized recruitment becomes a vital tool for project success. Companies like iRecruit.co focus on placing professionals in regulated, high-stakes environments, helping project owners and EPCM firms find the right commissioning leads, MEP coordinators, and cleanroom project managers. With the biopharmaceutical cleanroom construction market projected to grow from $9.03 billion in 2024 to $27.80 billion by 2034, having the right talent from the start is essential - not just for meeting deadlines but for ensuring compliance.
ISO classification is just the start; planning for future growth is equally important. One smart strategy is to oversize utility infrastructure by 20–30%. This includes electrical capacity, process gases, and waste handling systems, ensuring that future expansions won't require expensive retrofits.
Modular cleanroom PODs make phased expansions easier. These systems allow companies to add new zones - like viral vector areas or processing rooms - without disrupting validated spaces. Modular builds typically take 3–6 months to complete, cost 15–30% less than traditional methods, and reduce on-site contamination risks by 30–40% .
The ISO 14644-4:2022 standard has shifted from fixed air change rates to performance-based metrics like Air Change Effectiveness (ACE) and Contaminant Removal Effectiveness (CRE). This gives design teams more flexibility to create HVAC systems that can adapt as process needs change.
A scalable cleanroom design not only supports future growth but also ensures consistency across multiple facilities.
Scalable designs pave the way for standardization, which simplifies operations and compliance. For biotech companies with multiple sites - such as Eli Lilly’s $4 billion expansion at Research Triangle Park or Biogen’s $2 billion facility for antisense oligonucleotide synthesis - consistent design isn't just practical; it’s a compliance priority.
Standardization starts with a strong User Requirements Specification (URS) and Design Qualification (DQ) framework applied across all locations. Prefabricated POD systems help reinforce this consistency by delivering identical components, no matter the location .
As G-CON explains:
"Modular cleanrooms offer fixed pricing, standardized components, and streamlined project management - making budgeting and timeline adherence far more reliable."
This uniformity also simplifies FDA inspections. Consistent contamination control strategies and standardized documentation reduce the chances of site-specific deviations, making audits smoother and less risky.
Building a cleanroom is just the first step; maintaining it over its lifecycle is key to staying compliant and efficient. ISO 14644-2 requires regular requalification, and missing these deadlines can have serious consequences. Between 2018 and 2025, about 22% of FDA Warning Letters cited cleanroom design or construction flaws - like inadequate airflow or pressure failures - as contributing factors.
Thoughtful design can make long-term maintenance easier. Features like walkable ceiling plenums and service chases outside the cleanroom allow for HEPA filter replacements and utility maintenance without compromising the classified environment. Material choices also matter. For example, 316L stainless steel for equipment and epoxy or high-pressure laminate (HPL) for walls can withstand frequent disinfection without breaking down or shedding particles .
Energy efficiency is another major factor. Cleanrooms use up to 15 times more energy than standard buildings, with HVAC systems consuming over 50% of the electricity. Variable Air Volume (VAV) systems can cut energy use by up to 25% while maintaining ISO pressure requirements. For teams managing these facilities, understanding long-term operational needs is just as critical as getting the initial build right.
ISO classification plays a major role in shaping the cost, timeline, and complexity of biotech cleanroom construction. For example, upgrading from ISO 7 to ISO 5 can increase HVAC complexity and costs by 20–50%. These factors make early, well-informed decisions essential.
As Encompass Cleanrooms explains:
"The decision to go to ISO 5 'just in case' is one of the most common and expensive assumptions in this space."
For construction management professionals, three key principles emerge. First, challenge default specifications early - an ISO 7 background paired with an ISO 5 biosafety cabinet often achieves the same level of protection at a lower cost. Second, allocate a 15–25% budget contingency for pharmaceutical-grade requirements, as validation processes (IQ/OQ/PQ) alone can extend the project timeline by 6–12 months beyond mechanical completion. Third, insist on consistent and comparable bids - differences between "turnkey" and "shell-only" quotes for the same room can exceed $200,000. These strategies align with earlier advice on balancing design, validation, and cost management. Alongside careful planning, having the right team in place is equally important.
Skilled talent is as critical as technical know-how. Cleanroom construction demands crews with documented GMP experience, expertise in ISO 14644 standards, and strict adherence to contamination control protocols during the build. As Connor Construction points out, "A cleanroom that fails certification or can't support your operations costs more than money: it stalls research, production, and compliance audits." Partnering with a specialized recruitment firm, such as iRecruit.co, can be a game-changer. They focus on mission-critical construction hiring, including pharmaceutical manufacturing facilities, helping project teams find pre-qualified candidates with proven expertise.
With the biopharmaceutical cleanroom market expected to grow from $9.03 billion in 2024 to $27.80 billion by 2034, early strategic decisions are critical. Teams that succeed will be those who define ISO requirements upfront, plan for future scalability, and staff their projects with experienced professionals who understand the unique demands of cleanroom construction.
Picking the appropriate ISO class hinges on a few key factors: particle sensitivity of your process, regulatory requirements, and your operational goals.
Start by evaluating the cleanliness levels your operations demand. For instance, aseptic filling processes often require ISO 5 environments. Next, review relevant regulations, such as FDA cGMP or EU GMP, to ensure your setup aligns with industry standards.
While stricter classifications can improve cleanliness, they also come with higher costs and added complexity. Finding the right balance is crucial. Additionally, make sure to comply with validation protocols like IQ (Installation Qualification), OQ (Operational Qualification), and PQ (Performance Qualification).
Finally, implement ongoing monitoring systems to consistently meet required standards and maintain compliance over time.
An ISO 7 room paired with an ISO 5 cabinet works well when ISO 5 conditions are necessary only at the work surface or in the critical process area. This setup typically uses equipment like laminar airflow hoods or isolators to create localized ISO 5 conditions, while the surrounding room maintains ISO 7 standards. This approach is perfect for processes that demand high cleanliness levels in targeted areas.
The User Requirements Specification (URS) should clearly define the intended use, regulatory requirements, target cleanliness class, environmental conditions, and critical process needs. By addressing these elements, you can ensure compliance and reduce the chances of costly rework during construction or validation.
