Construction Cost Estimating for Mission-Critical Projects: Methodologies Owners Should Demand

By:
Dallas Bond

Mission-critical facilities like data centers, hospitals, and energy plants operate under extreme stakes. A two-hour delay or cost miscalculation can lead to shutdowns, millions in losses, and safety risks. Accurate cost estimates are not just numbers - they're tools for managing risk, aligning budgets, and avoiding overruns.

Key Takeaways:

  • Costs Are Higher: Mission-critical builds range from $600 to $1,000/sq. ft., far above standard commercial projects.
  • Delays Are Costly: A missed shutdown window could delay operations by 6 weeks.
  • Precision Matters: Estimates must factor in redundancy, long-lead equipment (16–40 weeks), and commissioning.
  • Lifecycle Costs: Total Cost of Ownership (TCO) includes construction, energy, maintenance, and staffing.

Estimating Methods:

  1. Conceptual Estimating: Early-stage, rough budgets using metrics like cost per square foot or megawatt.
  2. Parametric Estimating: Links costs to capacity (e.g., $12M–$25M per megawatt for data centers in 2026).
  3. Detailed Estimating: Breaks down costs into components like MEP systems, commissioning, and labor.
  4. Risk-Informed Estimating: Uses tools like Monte Carlo simulations to quantify uncertainties.

Risk Management:

  • Avoid generic contingencies; instead, create targeted risk plans for shutdowns, commissioning, and material price volatility.
  • Track every contingency draw by category to refine future estimates.

Talent and Tools:

  • Use RSMeans Data and City Cost Indexes for reliable estimates.
  • Hire certified professionals (CPE, CCP) with expertise in mission-critical systems.

Without precise estimates, mission-critical projects risk delays, overruns, and operational disruptions. Owners must demand detailed assumptions, risk-focused contingencies, and skilled estimators to protect their investments.

Mission Critical Construction with Suffolk's Mike Mallon (Director of Preconstruction)

Suffolk

Core Principles of Cost Estimating for Mission-Critical Projects

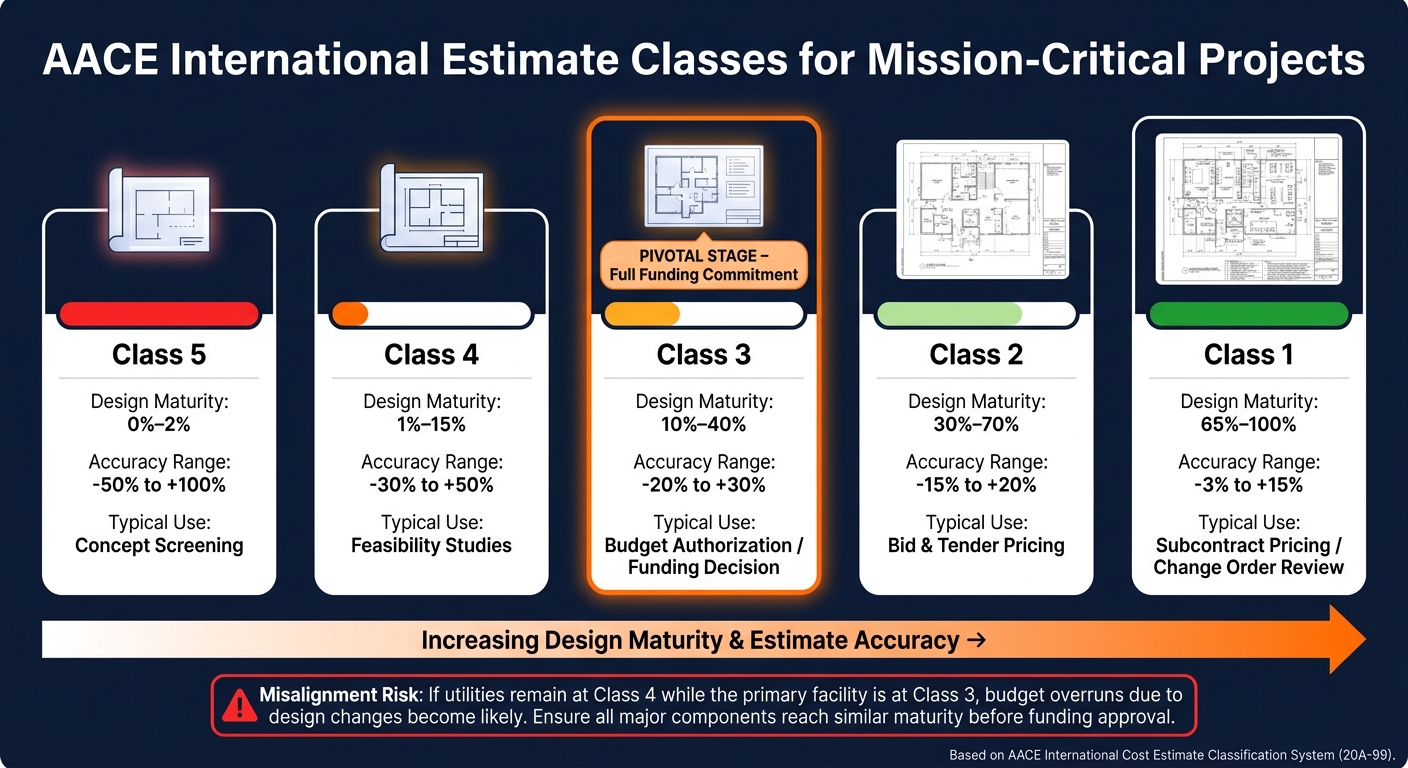

AACE Estimate Classes: Accuracy & Design Maturity for Mission-Critical Projects

AACE Estimate Classes: Accuracy & Design Maturity for Mission-Critical Projects

Cost estimating for mission-critical projects must account for the unique factors driving facility costs as well as the broader lifecycle ownership expenses.

AACE International Estimate Classes Explained

AACE International

The Association for the Advancement of Cost Engineering (AACE International) developed a classification system that ties estimate accuracy to the level of project definition. Essentially, the more complete the design, the more accurate the estimate.

"The maturity level of definition is the sole determining (i.e., primary) characteristic of class." - AACE International [7]

Here's a breakdown of the five estimate classes, showing how they align with design maturity, accuracy, and their typical applications:

Estimate Class Design Maturity Accuracy Range Typical Use
Class 5 0%–2% -50% to +100% Concept screening
Class 4 1%–15% -30% to +50% Feasibility studies
Class 3 10%–40% -20% to +30% Budget authorization / funding decision
Class 2 30%–70% -15% to +20% Bid and tender pricing
Class 1 65%–100% -3% to +15% Subcontract pricing / change order review

For mission-critical projects, Class 3 is a pivotal stage. This is when industries typically commit full funding to a project [7][8]. However, a significant risk arises if key systems like utilities remain at a less-defined stage (e.g., Class 4) while the primary facility estimate is at Class 3. Such misalignment can lead to budget overruns due to design changes [7]. To avoid this, owners should ensure that all major components of the project achieve similar levels of maturity before funding approval. This classification system provides a structured approach to aligning estimates with the demands of mission-critical projects.

Cost Drivers Specific to Mission-Critical Facilities

Mission-critical facilities come with distinct cost pressures, driven by redundancy, complex mechanical/electrical/plumbing (MEP) systems, and commissioning needs.

Redundancy is a major cost factor. Configurations such as N+1 or 2N require fully duplicated systems, which often necessitate additional structural support. Failing to account for these extra elements can result in underestimated costs [2][3].

MEP density also adds complexity. The mechanical, electrical, and plumbing systems in mission-critical facilities are far more intricate than those in standard buildings. For example, electrical systems often require detailed takeoffs for distribution intent, not just device counts. Overlooked items like housekeeping pads, equipment curbs, specialty hangers, and penetrations can significantly increase labor and material costs [2].

Finally, commissioning and systems testing are essential and should be priced into the estimate. Long-lead items, if not accounted for, can cause scheduling delays and cash flow issues [1][6]. These factors highlight the importance of a thorough, lifecycle-focused approach to cost estimation.

Lifecycle Costs and Total Cost of Ownership (TCO)

Construction costs are only a piece of the puzzle when it comes to mission-critical facilities. Total Cost of Ownership (TCO) includes not just construction and equipment expenses but also commissioning, energy consumption, maintenance, equipment replacement, and staffing over the facility's lifespan.

McKinsey & Company projects that global data centers will require approximately $7 trillion in capital by 2030, with construction costs alone estimated between $1.7 trillion and $1.9 trillion [6]. Even small improvements in estimation accuracy can have a huge financial impact:

"Trimming capital spending by even 10 percent could yield roughly $170 billion to $190 billion in potential savings by 2030." - McKinsey & Company [6]

For project owners, this means TCO should be considered as early as the Class 4 or Class 3 estimating stages. By integrating operational and long-term costs into the initial financial framework, owners can make more informed decisions about the project’s overall viability and sustainability.

Cost Estimating Methods Owners Should Require

Mission-critical projects, like those involving data centers and advanced manufacturing facilities, demand precise estimating methods tailored to each stage of the project. Applying the right method at the right time ensures accuracy as project details evolve. Here's how different estimating techniques can guide project success.

Conceptual and Order-of-Magnitude Estimating

Conceptual estimating is where it all starts. This method is used before any detailed designs are available, offering a rough budget range to determine if a project is even financially viable. Historical data and high-level metrics, such as cost per square foot or cost per megawatt, form the backbone of this approach.

"Conceptual estimating provides early cost projections based on preliminary project data prior to creating detailed designs." - Procore [9]

For example, in 2026, the cost of AI-ready data centers ranges from $12 million to $25 million per megawatt, depending on location. Nebraska falls on the lower end of the spectrum ($12M–$15M/MW), while California represents the higher end ($18M–$25M/MW) [10]. These figures give project owners an essential reference point for early budgeting. As designs progress, these initial estimates must be updated to reflect market trends and conditions.

Parametric Estimating for Capacity-Driven Assets

Parametric estimating takes things up a notch by linking costs directly to a project’s capacity or output. For instance, data center costs might be calculated based on megawatts of IT load, while advanced manufacturing facilities could use the cost per square foot of cleanroom space. This method is particularly useful for assessing long-term total cost of ownership (TCO).

The reliability of parametric estimates hinges on high-quality data. Leveraging software that stores historical project data - adjusted for current labor and material costs - is crucial. Engaging specialty contractors early in the process also ensures market pricing is realistic [9]. Additionally, owners should require sensitivity analysis to test how variables like power density or cooling methods impact costs. For instance, liquid cooling can add approximately $3 million to $5 million per megawatt compared to traditional air-cooled systems [10], a significant factor that could dramatically shift budgets if not accounted for early.

Detailed and Bottom-Up Estimating

As designs reach 30%–70% completion (AACE Class 2), detailed estimating becomes essential. This method involves breaking down costs into their smallest components through quantity takeoffs (QTO) and unit cost buildups for all project elements - structural, civil, MEP (mechanical, electrical, plumbing), commissioning, and specialty systems.

For mission-critical projects, MEP systems require extra attention. Electrical distribution, for example, should be estimated based on distribution intent rather than just counting devices. Similarly, commissioning costs should be explicitly priced at this stage, rather than being tacked on as a percentage. Owners should also insist on constructability reviews during this phase, bringing specialty contractors into the process to identify and address potential issues before designs are finalized [9].

Hybrid and Risk-Informed Estimating

When uncertainty looms, a hybrid method becomes invaluable. This approach combines traditional estimating techniques with probabilistic tools like Monte Carlo simulations and three-point estimating. Rather than simply acknowledging risks, these tools quantify uncertainties, offering a clearer picture of potential cost impacts.

"In conceptual estimating, risk analysis helps to identify potential cost drivers and uncertainties. By quantifying and prioritizing these risks as well as including contingency budgets, estimators are able to mitigate adverse potential impacts on project budgets." - Kassy Slaughter, Senior Manager of Industry Transformation, Procore [9]

This method is especially important for unpredictable factors such as cost escalation, subsurface conditions, and long-lead equipment. For example, hyperscale construction inflation is currently running about 38% above the 2020 baseline [10]. Additionally, lead times for critical equipment are significant - large power transformers average 128 weeks, while generator step-up units stretch to 144 weeks [10]. Risk-informed estimates help identify these challenges early, allowing owners to take proactive steps, like reserving equipment slots well in advance.

Risk, Contingency, and Schedule in Cost Estimates

For mission-critical projects, managing risks and aligning schedules are just as important as estimating costs. Without factoring in these elements, even the most detailed cost estimate can fall short. In high-stakes projects like mission-critical construction, treating contingency as a vague safety net while sidelining schedule considerations is a recipe for trouble.

How to Build a Contingency Plan That Works

Simply increasing the contingency percentage won’t solve the problem.

"Mission-critical projects do not need more contingency. They need a different risk distribution." - Quoteloc Team [1]

The issue lies in lumping all risks into one generic contingency buffer. Minor risks, like small material price changes or minor labor fluctuations, fit within a contingency buffer, typically sized between 3.5% and 4% when other risks are properly addressed [1]. However, more complex risks - such as delays that cause cascading costs - require a different approach.

Take, for instance, missing a shutdown window. In an operational setting like a data center or hospital, a short delay can lead to significant downstream costs, often necessitating a complete reschedule.

"A 2-hour slippage on a shutdown window does not cost 2 hours of overtime. It costs a full reschedule to the next outage window, which may be 6 weeks out." - Quoteloc Team [1]

In a hospital electrical upgrade, missing such a window could lead to remobilization costs of around $14,200 per occurrence [1]. Instead of hiding these risks in a general buffer, contractors should clearly define assumptions. For example: "Pricing assumes a single uninterrupted 6-hour shutdown window; remobilization if interrupted is priced at $X per occurrence." This shifts risks from ambiguous buffers to transparent, costed scenarios.

The same principle applies to commissioning. Labor for commissioning should be quoted separately from general installation hours to reflect its unique requirements [1]. If a contingency buffer exceeds 6% on a mission-critical project without a detailed breakdown, it’s often a red flag that unresolved scope or operational risks are being masked [1].

For projects where equipment makes up over 30% of the total cost and procurement stretches beyond price guarantees, escalation clauses are a smarter tool than simply increasing the contingency buffer [1]. For example, steel, copper, and specialty mechanical pricing saw more than an 8% increase in the 12 months ending March 2026 [12].

Here’s a breakdown of how different risks should be handled in mission-critical projects:

Risk Type Standard Handling (Ineffective) Mission‑Critical Best Practice
Access/Shutdown Constraints Absorbed in contingency Named assumption with costed consequence [1]
Commissioning Complexity Buried in installation labor Separate pricing section with its own assumptions [1]
Long‑Lead Equipment Fixed price + contingency Escalation clause with defined index/threshold [1]
Material Price Volatility Generic buffer Escalation language for items >30% of cost [1]
Uncontrollable Site Conditions Contractor worst-case premium Owner allowances to avoid inflated bids [11]

This kind of targeted risk allocation creates a foundation for accurate, schedule-linked cost planning.

Time‑Phased Estimating for Schedule Alignment

Building on a risk-focused contingency plan, linking cost estimates to project milestones ensures greater accuracy. A cost estimate that isn’t tied to a schedule is incomplete. Costs don’t occur all at once - they follow the project’s timeline, and that timeline has real financial implications.

Owners should demand time-phased estimates that align costs with when they will actually be incurred. This approach not only improves cash flow planning but also exposes risks that flat estimates might overlook. For instance, accelerating a project timeline by six months could increase labor costs by 20%–40% due to overtime and reduced crew productivity [4].

Aligning costs with schedules also sharpens financial planning in labor-constrained markets. Labor rates tend to rise by 3% to 8% annually [4], and in regions with high demand for mission-critical construction, a shortage of skilled labor can become the primary bottleneck.

"10 percent is not a number. It's a reflex. Stop reflexive budgeting." - Terrapin Construction Group [12]

The table below, based on AACE estimate class stages, shows how contingency levels should decrease as a project progresses:

Project Phase Design Contingency Construction Contingency Total Contingency
Conceptual 15–25% 5–10% 20–35%
Schematic Design 10–15% 5–7% 15–22%
Design Development 5–10% 3–5% 8–15%
Construction Docs 2–3% 3–5% 5–8%
Construction 0% 3–5% 3–5%

Source: Trueleveler Cost Estimating Guide [4]

During construction, every contingency draw should be tracked by category - whether it’s for design clarification, unforeseen conditions, or schedule recovery. This level of detail not only keeps the project on track but also provides valuable data for refining future estimates [12]. It’s this disciplined approach that separates well-managed projects from those plagued by constant cost overruns.

Standards, Data Sources, and Talent Needed for Reliable Estimates

To create effective contingency plans and time-phased schedules, you need a solid foundation for your estimates. This means relying on standardized cost codes, trusted data sources, and skilled professionals. Without these, even the best risk plans can crumble under inaccurate numbers.

Consistent Cost Codes and Reliable Data Sources

Reliable estimates for mission-critical projects depend on CSI MasterFormat, a widely used work breakdown structure. By ensuring every line item aligns with a consistent code, project owners can easily compare estimates, identify scope gaps, and audit changes without starting from scratch.

When it comes to pricing, RSMeans (Gordian) is the go-to reference in the U.S., covering more than 97,000 unit cost line items across 16 CSI divisions. It’s trusted by over 85,000 estimators. When adjusted for location, RSMeans data typically delivers estimates within 5%–10% of actual costs [15]. However, national averages need to be localized. For example, construction costs in New York City are 31.2% higher than the national average, while Birmingham, AL, is 17.3% lower [15]. Estimators should use City Cost Indexes (CCI) to adjust costs with this formula:
Local Cost = National Average Cost × (Local CCI / 100) [15].

For data centers and other facilities with significant mechanical, electrical, and plumbing (MEP) systems, RSMeans datasets like "Facilities Construction Costs" and "Mechanical/Electrical Costs" are especially relevant [15]. However, RSMeans doesn’t cover everything - custom systems and soft costs (like architecture and financing) require separate sourcing [15].

"Line-item estimating is the most effective cost estimating method for what we do. RSMeans Data is a trusted resource and has helped in the successful bidding of our work." - Peggy Togioka, Project Manager [14]

Top-performing teams don’t just rely on published databases - they also use internal data from past projects to validate assumptions [14]. As one analyst explained:

"We compare our in-house data with RSMeans Data. [We] also use it to complement our analysis for locations where our in-house data is scarce." - Ramziya Shakirova, Associate Research Analyst [14]

Owners should also insist on auditable digital takeoffs, where every quantity is tied to a drawing markup or BIM model element. This transparency allows anyone to verify what was counted and why. For example, in early 2026, Solid Earth Civil Constructors conducted a digital audit of a paper-prepared bid and found a $50,000 quantity error [13]. That kind of oversight is only possible with transparent, reviewable takeoffs.

"The firms that build a feedback loop between the estimate and the field get more accurate over time. Everyone else keeps guessing at the same rate." - Bluebeam Guide [13]

Once you have a standardized data framework, the next step is finding an expert estimator who knows how to apply these tools effectively.

Key Traits of a Mission-Critical Cost Estimator

Mission-critical projects come with unique challenges: dense MEP systems, long-lead equipment, tight commissioning schedules, and extended procurement timelines. The right estimator approaches the job like a forecaster, not just a number cruncher. They interpret design intent, anticipate construction sequencing, and flag inconsistencies in architectural, structural, and MEP drawings before those issues turn into costly change orders [13]. They also dig into the full specification book - Division 1 requirements alone can add 2%–5% to total costs in ways that aren’t visible on drawings [17].

Credentials are another important factor. Look for certifications like Certified Professional Estimator (CPE) from the American Society of Professional Estimators or Certified Cost Professional (CCP) from AACE International [13]. For projects like data centers or advanced manufacturing facilities, familiarity with 5D BIM (linking 3D models to costs and schedules) is becoming increasingly important [16].

"An experienced estimator with a spreadsheet will outperform a novice with a $50,000 platform every time." - Bluebeam [13]

Market awareness is also critical. As of April 2026, tiered tariffs on materials like steel, aluminum, and copper can reach up to 50% [13]. Estimators need to stay updated on market trends through trade relationships, not just static databases, to avoid outdated cost projections. These qualifications ensure estimators can execute risk and contingency frameworks with precision.

Hiring Mission-Critical Cost Estimators

Finding the right talent is just as important as the tools and methods they use. The construction industry will need around 349,000 new workers in 2026 to meet demand [13], and experienced cost estimators for mission-critical projects are among the hardest roles to fill. Compounding the issue, nearly 20% of construction workers are over 55, leading to a significant loss of institutional knowledge [13].

This is where iRecruit.co steps in. Founded by Dallas Bond and Tanya Runholt, iRecruit.co specializes in recruiting for mission-critical construction roles, including cost estimators, project managers, and commissioning specialists. They focus on pre-screened candidates and offer a success-based pricing model, along with a 90-day search credit for replacements. For owners who need to quickly build preconstruction teams without sifting through unqualified applicants, this targeted approach can make a measurable difference.

Conclusion: What Owners Should Take Away

Mission-critical projects leave no room for error. Overlooking a scope detail, using outdated labor rates, or underestimating commissioning costs can derail a facility's launch, disrupt operations, and erode ROI. The numbers back this up: studies spanning 70 years reveal that 85% of projects exceed their budgets, with average overruns hitting 28% [18]. For facilities like data centers or advanced manufacturing plants - where delays directly impact revenue - there’s simply no buffer for missteps.

The estimating methods discussed in this guide - conceptual, parametric, detailed bottom-up, and risk-informed hybrid approaches - each play a distinct role during project development. What unites them is the discipline of adhering to AACE International's Class 5 to Class 1 framework, ensuring estimates become increasingly precise as designs evolve rather than relying on early-stage assumptions.

Risk management is just as critical. As one expert succinctly put it:

"Generic contingency becomes a poor container when downside risk is concentrated in schedule access windows, commissioning sequences, procurement phasing, and owner-interface coordination." - Quoteloc [1]

Owners should prioritize detailed assumptions, escalation clauses tied to indices, and itemized commissioning costs. A flat percentage buffer often hides the real risks. Should-cost modeling offers a practical solution here, with potential savings of 5%–10% on most projects [6]. By combining precise estimating methods, robust risk management, and well-informed assumptions, owners can better protect their projects from costly setbacks. However, even the best systems only work when paired with experienced professionals.

Securing top talent is the next critical step. As highlighted in this guide, none of these practices succeed without the right people driving them. With 41% of the U.S. construction workforce expected to retire by 2031 [5], finding experienced mission-critical estimators is becoming increasingly challenging. Owners who integrate talent acquisition into preconstruction planning consistently achieve better outcomes.

FAQs

What estimate class should I require before approving full project funding?

Before committing to full project funding, it's crucial to secure a highly reliable estimate - usually a Class 1 or Class 2 estimate as defined by AACE International standards. While conceptual and parametric estimates are helpful during initial planning stages, they lack the precision required for major, high-stakes projects. For these, a detailed, bottom-up estimate (often referred to as engineered or definitive) is essential. This type of estimate ensures greater accuracy, clear scope definition, and better risk management.

How do I tie cost estimates to schedule milestones and cash flow?

To effectively manage project budgets, integrate cost data directly with project schedules using tools like model-based estimating platforms. These tools connect BIM data with cost databases, offering a more streamlined approach to tracking expenses.

When addressing schedule risks - such as access limitations or the order in which equipment is used - be specific. Highlight these as named assumptions or separate line items in your cost breakdown, rather than lumping them into a general contingency percentage. This approach provides better clarity and helps pinpoint potential problem areas.

Additionally, make sure to update your cost models whenever key project elements, like capacity needs or schedules, shift. Aligning estimates with project milestones ensures more precise cash flow planning and reduces the risk of unexpected financial surprises.

When should I use escalation clauses instead of adding more contingency?

Escalation clauses are a practical way to tackle specific and measurable risks, such as fluctuations in material prices or delays in procuring long-lead items. Unlike contingency funds, which account for unexpected changes, escalation clauses set clear pricing windows and predetermined trigger points. This method allows you to directly address escalation risks, tie them to procurement timelines, and build a structured budget that's well-defined and justifiable - avoiding the pitfalls of relying on broad cost buffers.

Related Blog Posts

Keywords:
mission-critical estimating, construction cost estimating, data center cost, AACE estimate classes, contingency planning, parametric estimating, lifecycle cost, long-lead equipment
Free Download

Data Center Construction Labor Trends in 2026

Thank you! Your submission has been received!
Oops! Something went wrong while submitting the form.

More mission critical construction news

Construction Procurement for Long-Lead Equipment: Switchgear, Chillers, and Generators
June 4, 2026

Construction Procurement for Long-Lead Equipment: Switchgear, Chillers, and Generators

Plan and track procurement for switchgear, chillers, and generators to avoid schedule delays and site-impact risks.
Cost Per Square Foot: Data Center, Cleanroom, Lab, and Fab Compared
June 4, 2026

Cost Per Square Foot: Data Center, Cleanroom, Lab, and Fab Compared

2026 cost comparison per sq ft for data centers, cleanrooms, labs and fabs — ranges and top drivers: MEP, equipment, power, and location.
Data Center Commissioning and Testing: IST, Integrated Systems, and Pull-the-Plug
June 4, 2026

Data Center Commissioning and Testing: IST, Integrated Systems, and Pull-the-Plug

How to plan and run IST and pull-the-plug tests to validate power, cooling, ATS, and controls — safety, roles, and common failures.
Best Data Center Commissioning Companies: How to Evaluate Cx Firms
June 3, 2026

Best Data Center Commissioning Companies: How to Evaluate Cx Firms

Evaluate data center commissioning firms: criteria, testing levels, certifications, and proposal tips to reduce downtime and risk.
