NFPA 70E and Arc Flash: Why Mission-Critical Sites Need Certified Pros

By:
Dallas Bond

If the people doing electrical work on a mission-critical site are not properly trained and assigned, safety problems can turn into outages, delays, and lost money fast.

I’d sum it up like this: NFPA 70E is not just paperwork. It sets the rules for de-energized work, energized work permits, arc flash studies, labels, PPE, training, and field controls. But those rules only work when the right people apply them on site. In places like data centers, hospitals, utilities, and manufacturing plants, one arc flash event can injure workers, damage gear, stall commissioning, and threaten uptime.

Here’s the plain-English version of what matters most:

  • Arc flash is a high-heat electrical event that can burn people, damage equipment, and shut down parts of a facility.
  • NFPA 70E says de-energize first unless shutdown creates a greater hazard or is not feasible.
  • Labels and studies must match the actual system. If settings, equipment, or layout change, old labels can point workers to the wrong PPE or wrong boundaries.
  • Qualified status is task-specific. A person can be cleared for one type of equipment and not another.
  • Mission-critical sites need more than electricians alone. They also need supervisors, energized work planners, and study or protection engineers.
  • Staffing gaps cost money. The article notes that 41% of firms report missing credentials tied to arc flash or high-voltage work, and 60% of data center operators struggle to find qualified commissioning engineers.
  • On large builds, poor labor use adds up fast. At $11.3 million per MW in 2026, even a 5% labor-efficiency loss on a 100 MW project can mean $5 million to $10 million in waste.
  • Good site execution is visible. I’d look for current labels, documented training, tested gloves, rated tools, lockout/tagout gear, barricades, and controls like remote racking or fast-tripping protection.
  • When incident energy gets very high, the message is simple: de-energize, operate remotely, or redesign the work.

Bottom line: I’d treat certified electrical staffing as a risk-control decision, not just a hiring task. The article’s core point is simple: the right people help protect workers, uptime, schedules, and project spend at the same time.

Arc Flash vs NFPA 70E Training: What You Need to Know

NFPA 70E

The Problem: Where Mission-Critical Projects Break Down Without Qualified Electrical Safety Coverage

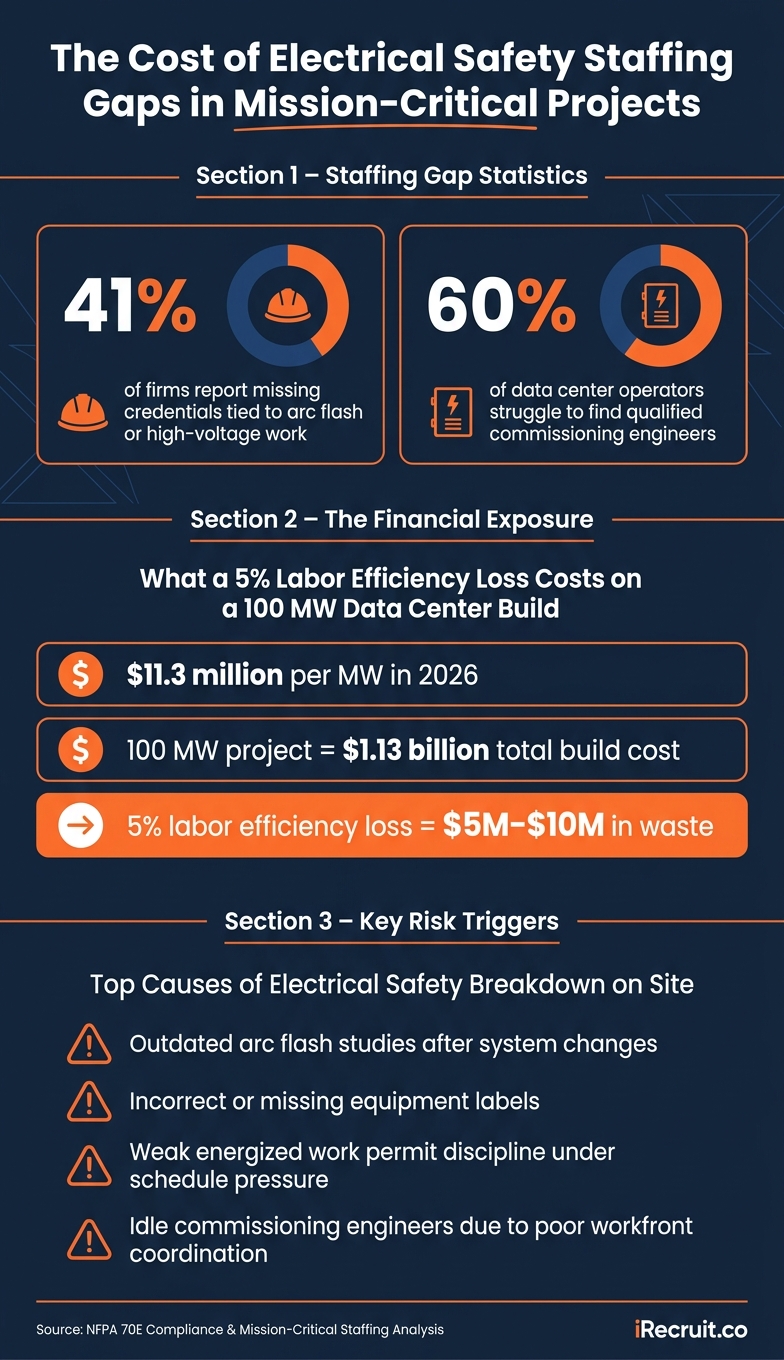

Arc Flash & Electrical Safety Staffing Gaps: The Hidden Cost to Mission-Critical Projects

Arc Flash & Electrical Safety Staffing Gaps: The Hidden Cost to Mission-Critical Projects

When a site doesn’t have certified electrical people in the right seats, mission-critical work starts to wobble. Energization windows get missed. Inspections fail. Specialists stand around waiting. And in the worst cases, teams end up dealing with unplanned shutdowns. That gets expensive in a hurry when the people on site can’t carry out the work the right way.

Unplanned Energized Work, Outdated Studies, and Missing Labels

A lot can change in the field, but the arc flash study doesn’t always keep up. New equipment gets added. System configurations shift. Protective device settings change. Yet the study stays frozen in time, which means the equipment labels are wrong too.

That creates a clear problem: a worker may look at a label and make a safety call based on bad information. Instead of lowering risk, the label points them in the wrong direction.

Permit practices for energized work often slip in the same way. Once schedule pressure kicks in, teams start cutting corners. If there isn’t an NFPA 70E-trained supervisor holding the line, weak permit discipline can turn into the normal way of working. [4] And once labels and permits stop matching site conditions, the schedule usually starts to slide.

How These Gaps Hurt Schedule, Uptime, and Capital Performance

The hit shows up fast on mission-critical projects. Phased commissioning depends on verified electrical work at each handoff. When field verification is weak, commissioning engineers can show up ready for electrical testing and find that mechanical or low-voltage work still isn’t done. Then the team has to redeploy, and the whole turnover window moves back. [4]

The staffing picture makes this harder. Hiring is still tight. 41% of firms report missing credentials such as arc flash and high-voltage training, and 60% of data center operators have trouble finding qualified commissioning engineers. [4] So when those specialists finally make it to the site, poor coordination can still leave them idle because the workfront isn’t ready.

The money at stake is hard to ignore. At $11.3 million per MW in 2026, even a 5% labor-efficiency loss on a 100 MW build can burn $5 million to $10 million. [4] For owners and GCs dealing with numbers like that, weak electrical safety coverage isn’t just a safety problem. It’s a capital performance problem.

Closing that gap starts with certified electrical talent in the right roles.

The Solution: Certified Roles Employers Need to Hire or Subcontract

The answer isn't one hire. It's a coordinated electrical safety team.

For hiring managers trying to decide whether to build this skill set in-house or bring in outside help, the first step is simple: know what each role does on the job. On mission-critical sites, that matters fast.

Qualified Electrical Workers, NFPA 70E-Trained Supervisors, and Energized Work Planners

One of the biggest hiring mistakes is treating qualified like a broad job title. Under NFPA 70E, qualification is tied to the task and the equipment. A worker may be qualified for one system and not qualified for another. [2] And the employer, not the training vendor, has to verify that the person can do the work and formally designate qualified status. [14]

A qualified electrical worker on a mission-critical site needs documented NFPA 70E electrical safety training and hands-on skill with the exact equipment involved. That includes test-before-touch and lockout/tagout practices. [2][5][12]

NFPA 70E-trained supervisors run the field program day to day. They make sure work is planned de-energized whenever feasible, enforce arc flash boundaries, confirm PPE selection, and review energized work only when there's a valid reason. [2][6][11] That kind of control helps keep commissioning on track while cutting the risk of unplanned shutdowns.

Then there's the energized work planner. This role keeps energized work from becoming "just how we do things here." The planner checks whether energized work is justified, looks at de-energization options, prepares or reviews the energized electrical work permit, and documents the shock and arc flash risk assessment, PPE needs, boundaries, and approved controls before work starts. [8][9][11][13]

On a live data center floor or inside an operating hospital, that approval chain can stop informal "just open the panel" work from turning into an incident or an outage.

That field discipline protects uptime, not just compliance.

Arc Flash Study Specialists and Protection-Focused Electrical Engineers

Arc flash study specialists and protection-focused electrical engineers figure out what field crews are up against. Using IEEE 1584 calculation methods, they perform short-circuit studies, coordination studies, and incident energy analyses. Their work identifies available fault current, clearing times, arc flash boundaries, and PPE requirements at each piece of equipment. It also drives equipment labels. [7][10]

Their job doesn't stop at math. These engineers also recommend ways to cut exposure, such as:

  • Adjusting protective device settings
  • Adding arc-flash reduction maintenance switches
  • Using zone-selective interlocking
  • Applying differential protection
  • Installing current-limiting devices

The goal is to lower exposure without creating nuisance trips or slowing turnover. [7][10]

When employers screen people for these roles, they should look for NFPA 70E training, familiarity with IEEE 1584, OSHA electrical safety training, and, when required, a PE license. [6][7][10]

For most mission-critical owners and contractors, a hybrid model makes the most sense. Internal teams manage routine NFPA 70E compliance and day-to-day field controls. Outside specialists step in for major system changes, new facility commissioning, and periodic study updates. [6][7][10][11]

How iRecruit.co Helps Employers Find Mission-Critical Electrical Talent

iRecruit.co

This is where many hiring processes stall. Plenty of candidates list NFPA 70E on a resume. Far fewer can show that they understand how it works in the field.

iRecruit.co serves as a recruiting partner for construction managers, MEP leaders, commissioning managers, and electrical supervisors who need pre-qualified talent for high-consequence sites, including data centers, healthcare facilities, energy and utility infrastructure, defense, and advanced manufacturing.

The pre-screening process centers on what matters on these jobs: current NFPA 70E training, OSHA electrical safety training, hands-on experience with energized work permits and lockout/tagout, and direct project history on mission-critical sites. [2][6][7][10][11]

For each candidate, iRecruit.co gathers examples of prior work, including job briefings led, boundaries enforced, and arc flash studies used or supported. That gives hiring managers a faster way to see who can reduce exposure, not just who has the right keywords on paper.

Those hires only matter when PPE, labels, and work controls are in place on site.

What Strong NFPA 70E Execution Looks Like on Site

Strong compliance isn't paperwork. You can see it on the job when qualified people run the work the right way. On site, that usually shows up in three places: labels, PPE, and work controls.

PPE Programs, Equipment Labeling, and Documented Training

Every arc flash PPE program starts with the label. Under NFPA 70E Article 130.5(H), equipment that requires energized work must be labeled with at least the nominal system voltage, arc flash boundary, and either the available incident energy at a stated working distance or an arc flash PPE category.[17][10][20][21] Put simply, the label must show voltage, arc flash boundary, and either incident energy or PPE category. That information drives PPE selection in the field.

The 1.2 cal/cm² threshold is the minimum point for arc-rated PPE.[22][23][1] Category 2 protection will usually mean arc-rated clothing, face protection, insulating gloves, and hearing protection.[16][10][18][19]

Strong programs also track PPE inspection and replacement. Rubber-insulating gloves should be visually checked before each use and electrically tested on a tracked schedule. Any garment with holes, heavy soiling, or visible wear should come out of service right away.[1][19] It also helps to keep spare PPE on hand, so a failed inspection doesn't bring the job to a halt.

Training matters too. Workers should be trained at assignment, and refresher training should be documented every three years.[1][19] Many mission-critical sites go a step further with annual refreshers and field drills.

Those records mean a lot more when the crew also has the right tools in hand.

Jobsite Tools and Engineering Controls That Reduce Exposure

PPE is only part of the picture. The tools and equipment on site tell you just as much about how seriously a team treats exposure reduction.

Properly rated test instruments confirm de-energization before anyone touches a conductor. Insulated hand tools help cut the chance of an accidental short circuit when work near energized parts can't be avoided. Lockout/tagout hardware, including lock sets, hasps, standardized tags, and clear LOTO stations, helps enforce zero-energy states before maintenance starts. Temporary barricades mark the arc flash boundary using the distance shown on the equipment label, which keeps non-essential personnel out of the hazard zone during live work.[1][16]

Engineering controls go even further. Remote racking and switching devices let operators open or close breakers and rack switchgear from a safe distance. In many cases, that keeps the worker outside the arc flash boundary during the highest-risk moments.[16][1] Infrared windows on switchgear and motor control centers let teams perform thermal inspections with doors closed. That cuts exposure to live parts while still spotting hotspots that can lead to failures and unplanned downtime.[1]

Current-limiting fuses and fast-tripping relays cut fault current magnitude and clearing time. That lowers calculated incident energy on labels and can reduce PPE needs for routine tasks.[15][10][18] In plain terms, better controls don't just protect people. They also help protect uptime during commissioning and maintenance.

PPE helps limit injury, but engineering and administrative controls cut incident energy, outage risk, and schedule disruption. Above 40 cal/cm², de-energize, remote-operate, or redesign.[10][3] The goal is simple: reduce exposure first, then use PPE for what's left.

When those controls are in place, field work is safer, faster, and easier to check. That leads to safer commissioning, fewer shutdowns, and cleaner turnover.

Conclusion: Certified Electrical Talent Protects Safety, Uptime, and Project Delivery

Labels, PPE, controls, and planning all matter. But when the work starts, it still comes down to people.

On mission-critical sites, NFPA 70E compliance depends on qualified workers doing the job the right way. Studies, planning, and control measures set the stage, but they don’t mean much if the people in the field lack the right credentials or the skill to carry them through.

That’s why staffing quality has such a direct effect on project outcomes. One gap in studies, credentials, or commissioning discipline can lead to outages, delays, and costly rework. In mission-critical work, certified talent isn’t a nice-to-have. It’s the floor, from commissioning through day-to-day operations.

On projects like these, hiring is part of risk management. Hiring certified electrical professionals is a form of risk control. It helps protect workers, preserve uptime, keep the project on schedule, and make sure the facility delivers what it was designed and contracted to deliver. A weaker staffing model puts more risk on safety, uptime, and delivery.

FAQs

How often should arc flash studies and labels be updated?

Arc flash studies and labels should be updated at least every 5 years.

They also need to be updated whenever major system changes happen, like changes to a feed, transformer, or protective device setting. Keeping this information current helps electricians see incident energy levels and arc-flash boundaries so they can pick the right arc-rated PPE.

Who can be designated a qualified electrical worker?

A qualified electrical worker has shown the skill to work with electrical equipment and installations, plus safety training on the hazards involved.

The big point here is simple: qualification is task-specific, not general. If someone is qualified to work on one asset, that does not mean they’re automatically qualified for other equipment or different voltage levels.

Employers need to confirm documented training and proven ability for each exact scope of work. A license or card by itself isn’t enough.

When is energized work allowed under NFPA 70E?

NFPA 70E says electrical equipment should be de-energized and put into an electrically safe work condition whenever you can.

Working on energized equipment is allowed only in limited cases. That usually means de-energizing isn't feasible, or turning power off would create an added hazard. Common examples include voltage testing or situations where a shutdown would increase risk.

If energized work is justified, there are a few non-negotiables:

  • Complete a risk assessment
  • Use the right arc-rated PPE
  • Put an Energized Electrical Work Permit in place
  • Follow the 40 cal/cm² incident-energy limit

Related Blog Posts

Keywords:
NFPA 70E, arc flash, electrical safety, qualified electrical worker, energized work permit, arc flash study, mission-critical staffing, commissioning
Free Download

Data Center Construction Labor Trends in 2026

Thank you! Your submission has been received!
Oops! Something went wrong while submitting the form.

More mission critical construction news

Data Center Superintendent vs Project Manager: Roles and 2026 Pay
July 16, 2026

Data Center Superintendent vs Project Manager: Roles and 2026 Pay

Compare superintendent vs project manager on data center builds: who runs the site, who handles contracts, and 2026 pay ranges.
Owner Rep Talent: How Developers and Firms Build Their Bench
July 15, 2026

Owner Rep Talent: How Developers and Firms Build Their Bench

Define core owner-rep roles, centralize where needed, build succession and hire by milestone to avoid costly delays.
Data Center Commissioning Levels 1 to 5: Careers in Cx Startup
July 15, 2026

Data Center Commissioning Levels 1 to 5: Careers in Cx Startup

Hire to the commissioning level, not the title: Levels 1–5 reveal who can start, test, and lead data center handoffs.
PMP, CCM, LEED: Certification Salary Benefits Explained
July 15, 2026

PMP, CCM, LEED: Certification Salary Benefits Explained

Compare PMP, CCM & LEED pay in construction: PMP offers the clearest salary lift; CCM aids owner-side leadership; LEED opens green projects.
