NFPA 70E Electrical Safety on Construction Sites

By:
Dallas Bond

If live electrical work is part of your jobsite, NFPA 70E matters right away. On U.S. construction sites, the core rule is simple: de-energize first, lock it out, verify zero voltage, and use live work only when shutdown is not possible or creates more risk.

Here’s the short version of what I’d want any crew leader, PM, or superintendent to know:

  • NFPA 70E is about safe work practices, while the NEC covers installation rules and OSHA sets the legal floor.
  • Arc flash can hit 35,000°F in milliseconds, and U.S. electrical hazards kill about 130 workers per year.
  • Qualified and unqualified workers are treated differently. That line affects access, training, and who can cross shock boundaries.
  • An electrically safe work condition takes more than opening a breaker. I need to identify all power sources, apply lockout/tagout, release stored energy, and verify absence of voltage with a live-dead-live test.
  • On construction sites, temporary feeders, generators, UPS units, transfer switches, and phased turnover can create backfeed risks that crews miss.
  • If energized work must happen, I need a shock risk review, an arc-flash review, the right PPE, clear barricades, and in many cases an energized electrical work permit.
  • Arc-flash labels must match the current system setup. Changes to switchgear or temporary distribution can make old labels wrong.
  • PPE is the last layer, not the first. And simple mistakes - like wearing melting base layers under arc-rated gear - can make injuries worse.
  • Hiring and field leadership matter. A card or license alone does not prove someone can apply NFPA 70E on an active project.

A few jobsite facts stand out:

  • 480V limited approach boundary: typically 3 ft 6 in
  • Arc-flash boundary: where incident energy reaches 1.2 cal/cm²
  • Label review cycle: at least every 5 years, or after major system changes
  • OSHA penalties: serious violations can top $16,000; willful violations can top $160,000
Standard Main job on site What I use it for
NEC (NFPA 70) Installation rules Wiring, grounding, overcurrent protection
OSHA 29 CFR 1926 Subpart K Legal minimum Enforcement and employer duties
NFPA 70E Safe work practices LOTO, boundaries, PPE, permits, job planning

So if I had to sum up the full article in one line, it would be this: NFPA 70E on a construction site is about controlling live electrical risk before work starts, not after something goes wrong.

Introduction to NFPA 70E (2021), Part 1: The Electrically Safe Work Condition

NFPA 70E

Establishing an Electrically Safe Work Condition

If de-energizing is possible, that comes first. Before installation changes, terminations, maintenance, or troubleshooting, the equipment should be de-energized. Energized work is allowed only when shutting power off creates a greater risk or when the task depends on live power, such as voltage testing or diagnostics [4][5].

Establishing an Electrically Safe Work Condition means doing the whole job, not just flipping a breaker. You need to identify every source, de-energize the circuit, open disconnects, visually verify open blades when it's safe to do so, release stored electrical and mechanical energy, apply lockout/tagout, verify absence of voltage with the live-dead-live test, and add grounding when induced voltage or accidental energization is possible [4][8]. Workers also need arc-rated PPE during absence-of-voltage verification, because the equipment is not electrically safe until that test is finished [10].

On construction projects, the hard part usually isn't the rule. It's dealing with temporary sources, shared systems, and phased turnover without missing something.

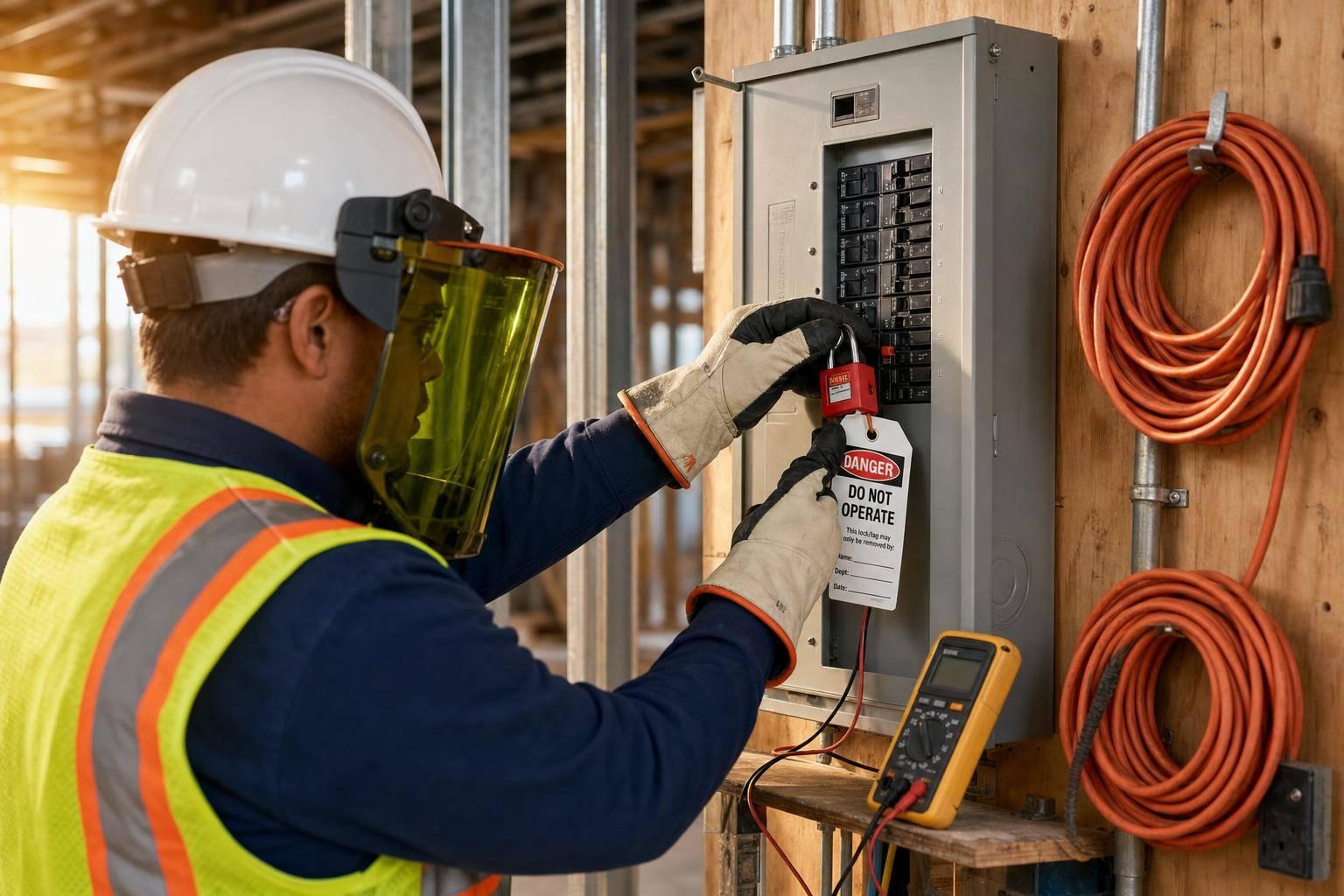

Lockout/Tagout Steps for Construction Power Systems

Construction power systems can fool people. A temporary feeder, portable generator, transfer switch, or UPS unit can backfeed a circuit that looks isolated. That's why updated one-line drawings matter after any temporary distribution change. If the drawing is out of date, a source can get left out of LOTO [4]. Temporary grounding is also required when induced voltage or accidental energization is possible [4][8].

Coordinating Simple and Complex LOTO Across Trades

On a large commercial or mission-critical project, LOTO is rarely just one person locking one breaker. Phased turnover, commissioning work, and multiple trades working from shared distribution panels can turn a simple procedure into a coordination issue fast. At that point, the weak spot isn't the lock. It's the handoff between people.

Feature Simple LOTO Complex LOTO
Scenario Single energy source; one crew or craft Multiple sources, multiple trades, phased turnover, or shift changes
Documentation Standard LOTO log or tags Formal written LOTO plan and equipment-specific procedures
Approvals Authorized employee performing the lockout Designated Person in Charge
Common Failure Points Missing a secondary source, such as a battery backup Communication gaps between trades, backfeeds from generators, or unauthorized lock removal during shift changes

A designated Person in Charge, along with equipment-specific procedures, helps close those coordination gaps [2][8].

Shock and Arc-Flash Risk Assessment Before Energized Work

When live work can't be avoided, the risk assessment shapes every call you make. On construction sites, temporary distribution, generators, and reworked switchgear can change available fault current and clearing times [11][6]. That means the plan can't be based on guesswork. First, lock down access. Then match the work method to the hazard.

NFPA 70E uses a six-step hierarchy of controls: elimination, substitution, engineering controls, awareness, administrative controls, and PPE as the last line of defense [5][4]. That order matters. PPE helps, but it doesn't remove the hazard.

The stakes are high. An arc flash can reach 35,000°F, and arc-blast pressure can exceed 2,000 pounds per square foot [7]. In the United States, electrical hazards kill an average of 130 workers each year, and about 2,000 workers suffer arc-flash burns annually [7].

Shock Boundaries and Access Control on Active Jobsites

Shock protection under NFPA 70E centers on two boundaries. The Limited Approach Boundary marks the point where a shock hazard begins. For 480VAC systems, that's typically 3 feet, 6 inches [4]. Unqualified workers must stop there unless a qualified person escorts them.

Only qualified persons with the right PPE and a documented plan may enter the Restricted Approach Boundary. Work there usually calls for an Energized Electrical Work Permit [6][1].

On busy jobsites, these controls need to be plain and physical, not just written on paper. Common measures include:

  • Physical barricades
  • Warning signs
  • Barrier tape
  • Attendants [7][6]

This matters even more when crews are working on panelboards, switchgear, generators, or temporary distribution equipment. Other trades nearby may not spot the hazard zone until they're already too close. Once the area is under control, the equipment label tells the crew what PPE to use and what working distance applies.

Arc-Flash Studies, Labels, and PPE Category Use

If an arc-flash hazard is present, the next step is to find the arc-flash boundary and choose the protection method. The Arc-Flash Boundary is the distance where incident energy reaches 1.2 cal/cm², which is the threshold for a second-degree burn [11][5].

Severity is determined in one of two ways:

  • Incident Energy Analysis, which calculates the exact cal/cm² value
  • The PPE Category method, which uses NFPA 70E tables to assign PPE levels 1 through 4

Use one method or the other for a given piece of equipment. Don't mix them [5][1].

Arc-flash labels must show the nominal system voltage, the arc-flash boundary, and either the incident energy at a stated working distance or the required PPE category [2][5]. On projects where switchgear is modified, or where temporary distribution changes the system setup, those labels can go stale fast.

NFPA 70E requires labels to be reviewed every five years or after major system changes [2][5]. Maintenance condition also plays a big part. NFPA 70E Annex S notes that poor maintenance can increase clearing times and push incident energy higher [5]. If the task still involves live contact, the exception needs to be documented before the work begins.

When an Energized Electrical Work Permit Is Required

NFPA 70E takes a plain stance: de-energize first. Energized work is allowed only when shutting equipment down creates a greater hazard, or when the task can't be done without live power, like voltage testing or troubleshooting [11][6].

The permit is there to show why live work can't be avoided. It must identify the equipment, explain why de-energizing is infeasible, document the shock and arc-flash analysis, list the safe work practices and access controls, confirm that a job briefing was completed, and include a signature from a responsible management representative [6][1].

Task EEWP Required? Controls Approving Role
Voltage testing / troubleshooting No (exception) Qualified person, PPE, insulated tools, job briefing Supervisor / qualified person
Repair or alteration (energized) Yes Full PPE, barricades, attendant Responsible management representative
Work inside the restricted approach boundary Yes Documented plan, full PPE Responsible management representative
Switchgear racking (energized) Yes Arc-rated suit, remote racking if possible Responsible management representative

Pre-load incident energy and boundary data into permit templates so crews are working from current values [6].

PPE, Temporary Power, and Common Equipment Scenarios

NFPA 70E Arc-Flash PPE Categories: Protection Levels at a Glance

NFPA 70E Arc-Flash PPE Categories: Protection Levels at a Glance

Once the risk assessment is done, crews need task-specific PPE and tight control over temporary power. After shock and arc-flash boundaries are set and permits are in place, PPE becomes the last line of defense for energized work. It has to match the task and the equipment. It should never be the first move.

Selecting Arc-Rated PPE and Avoiding Common Field Mistakes

Select arc-rated PPE with either the Incident Energy Analysis Method or the PPE Category Method. For any one piece of equipment, use one method, not both.

Here’s the basic PPE Category breakdown:

  • Category 1 starts at 4 cal/cm² and usually includes an arc-rated shirt and pants or a coverall, safety glasses, a hard hat, and leather gloves.
  • Category 2 starts at 8 cal/cm² and adds an arc-rated face shield and balaclava, along with leather gloves.
  • Category 3 starts at 25 cal/cm² and calls for a full arc flash suit with a hood.
  • Category 4 starts at 40 cal/cm² and calls for a multi-layer arc flash suit system.

If incident energy is above 40 cal/cm², the equipment should be de-energized [5].

Some field mistakes keep showing up, and they can turn a bad day into a disaster fast. One of the biggest is wearing melting synthetics like polyester, nylon, or spandex under arc-rated clothing. Another is using the wrong PPE for the label, like showing up in Category 2 gear when Category 3 is required. There’s also task expansion - what starts as troubleshooting drifts into repair work, but no one stops to get an Energized Electrical Work Permit. And hearing protection gets missed more often than it should.

Applying NFPA 70E to Switchgear, Panels, Generators, and Temporary Distribution

NFPA

Temporary systems can shift the hazard picture in a hurry. Before work starts, crews need to check the label, the source, and the grounding status.

Switchgear and switchboards often call for Category 3 or 4 PPE during energized tasks like breaker racking or bus testing. When switching breakers or disconnects, stand to the side of the opening path. That small habit can matter a lot.

Panelboards at 480 VAC are common on active construction sites. Troubleshooting and adding circuits while energized also happen a lot. “Normal operating condition” only applies when the equipment is properly installed, maintained, and closed, with no signs of impending failure. If maintenance is overdue or there’s visible damage, crews need to re-check PPE under Annex S [5].

Generators and transfer equipment add another layer because they can bring in multiple power sources. Work on transfer switches requires lockout/tagout on both the normal feed and the emergency feed before anyone goes inside. Paralleling gear can also hold capacitor energy, and that energy has to be discharged before contact.

Temporary power - spider boxes, temp panels, and cord-fed distribution - leans heavily on GFCI protection and daily inspection. NEC Article 590 requires GFCI protection on 125-volt, 15-, 20-, and 30-ampere temporary receptacles. An Assured Equipment Grounding Conductor Program (AEGCP) can be used as an administrative alternative, but it requires documented continuity testing and does not trip a circuit automatically the way a GFCI does. Construction-grade cords must be rated for hard or extra-hard use, and they need daily inspection for cuts, abrasions, and damaged plugs [9].

The key point for crew leaders is simple: match protection to the actual equipment state, not just the equipment type.

Equipment Task Required Protection Minimum PPE Common Mistakes
Switchgear / Switchboards Breaker racking, bus testing Category 3 or 4 Arc flash suit, hood, AR gloves, AR footwear Assuming "normal condition" when maintenance is overdue
Panelboards (480V) Troubleshooting, circuit additions Category 2 (typical) Arc-rated shirt and pants, face shield, balaclava, leather gloves Non-insulated tools; skipping live-dead-live verification
Generators / Transfer Switches Paralleling, diagnostic testing Incident Energy Analysis Arc flash suit, hood, voltage-rated gloves Not accounting for back-feeding; skipping capacitor discharge
Temporary Panels / Spider Boxes Daily setup, cord connection Category 1 or 2 Arc-rated clothing, leather gloves, safety glasses Damaged cords; bypassed GFCI
Any Equipment Removing covers to expose live parts Category 2 to 4 Arc-rated suit/hood per label, voltage-rated gloves Wearing melting synthetics such as polyester or nylon under PPE

These equipment-based rules should be the starting point for field training and crew qualification.

Training, Field Execution, and Hiring for NFPA 70E Competence

After the equipment rules, the last variable is the person applying them. Rules on paper don't keep anyone safe by themselves. LOTO, boundaries, PPE, and permits only work when the crew in the field knows how to use them the right way. That's why NFPA 70E compliance comes down to workforce capability. If you're building mission-critical facilities like data centers, hospitals, and semiconductor plants, this is something to verify before mobilization.

Role-Based NFPA 70E Expectations by Position

NFPA 70E makes qualification task- and equipment-specific, and the employer designates qualified persons based on demonstrated performance [3].

Role-based expectations help turn NFPA 70E from a written policy into day-to-day field behavior.

Role Knowledge Depth Signs of Strong Execution
Electrician / Qualified Person High - task and equipment specific Refuses energized work without a permit; applies LOTO without prompting
Foreman / Field Leader High - process and oversight Documents every job briefing; flags abnormal equipment conditions before work starts
Superintendent Medium - coordination and policy Prioritizes de-energization in the master schedule; ensures all trades respect barricades
Project Manager Medium - compliance and risk Rejects permits with weak justifications; verifies subcontractor training records

Retraining should happen at least every three years, and sooner if audits find unsafe behavior or new equipment is introduced [12][5].

How Hiring Leaders Can Evaluate Electrical Safety Competence

The same habits that keep crews safe in the field are the ones you should test for in interviews.

A certificate by itself doesn't make someone qualified [3]. Ask electricians to walk through how they verify absence of voltage. That answer should be clear, specific, and grounded in actual field practice. For foremen and superintendents, ask them to explain the required parts of an Energized Electrical Work Permit. They should quickly mention task justification, hazard analysis, and management sign-off [13][6].

For project managers, one question cuts through the noise: have they ever pushed back on a permit request because the justification was weak [13]? That tells you a lot about how they handle risk when schedule pressure starts to build.

When hiring for mission-critical environments - data centers, healthcare facilities, life sciences, or industrial plants - look for documented experience with complex switchgear, UPS systems, backup generators, and commissioning around live systems. Résumé claims are easy to make. Demonstrated competence is what counts.

Conclusion: What Strong NFPA 70E Execution Looks Like on a Construction Site

Strong NFPA 70E execution isn't a checklist. It's a set of repeatable habits across every role on the site. The point isn't just knowing the rules. It's using them the same way, every day, under field pressure.

"The through‑line from 1979 to 2024 is a steady shift from 'What PPE should we wear?' to 'How do we plan, maintain, and execute work so the hazardous exposure doesn't occur?'" - Laura Brown, NFPA 70E Specialist [5]

Better field execution reduces incidents, protects project schedules, and gives employers a clearer view of the safety competence they need when making hiring decisions. On high-stakes jobs, that kind of clarity matters most.

FAQs

Who is a qualified person under NFPA 70E?

Under NFPA 70E, a qualified person has shown the skills and knowledge tied to the construction and operation of electrical equipment and installations. That person also has training to spot the hazards involved and avoid them.

This isn’t about job title or having a license. A person is qualified for a specific task on specific equipment. That means someone may be qualified for one type of electrical work but not another.

Employers also can’t rely on paperwork alone. They need to verify that the person can perform the work safely through hands-on demonstration.

When is energized electrical work allowed?

Energized work is allowed only when shutting equipment off isn't feasible or would create a greater hazard, like losing life-safety systems or damaging equipment. Inconvenience is never a valid reason.

When energized work is justified, it must be done by a qualified person who follows safe work practices and uses the right PPE. Testing, troubleshooting, and voltage measuring don't require a formal energized work permit, but the same safety rules still apply.

How often should arc-flash labels and studies be updated?

NFPA 70E says arc-flash risk assessments and labels must be reviewed at least every five years.

That five-year mark is the outer limit. It is not a promise that your site stays safe or compliant for the whole period without a check.

The review has to happen sooner if changes to the electrical system could affect the results. That includes things like equipment modifications or distribution changes.

If those system changes happen, the assessment and labels need to be updated immediately.

Related Blog Posts

Keywords:
NFPA 70E, electrical safety, construction safety, lockout tagout, arc flash, energized work permit, temporary power, PPE
Free Download

Data Center Construction Labor Trends in 2026

Thank you! Your submission has been received!
Oops! Something went wrong while submitting the form.

More mission critical construction news

AI Construction PM Tools 2026: Buyer's Guide
July 4, 2026

AI Construction PM Tools 2026: Buyer's Guide

Pick AI construction tools by your project's biggest bottleneck—scheduling, documents, field tracking, or staffing, with costs and limits.
NFPA 13 Sprinkler Standards: The Construction PM's Guide
July 4, 2026

NFPA 13 Sprinkler Standards: The Construction PM's Guide

Practical NFPA 13 checklist for construction PMs: hazard class, water flow tests, ceiling coordination, testing, and turnover control.
NFPA 72 for Construction Managers: What You Need to Know
July 4, 2026

NFPA 72 for Construction Managers: What You Need to Know

Checklist for construction managers to meet NFPA 72: coordination, submittals, testing, battery sizing, AHJ approval, and turnover.
The Uptime Institute Credential Career Path for Data Center Engineers
July 4, 2026

The Uptime Institute Credential Career Path for Data Center Engineers

Compare ATS, ATD, AOS and M&O to choose the right Uptime Institute credential for technicians, engineers, and site leaders.
