June 3, 2026

Energy Storage Construction Management: BESS Scope, Risks, and Schedule

By:
Dallas Bond

Battery Energy Storage Systems (BESS) are transforming the U.S. energy grid, with utility-scale battery storage capacity growing by 66% in 2024 and projections showing 90 GW of additional capacity by 2030. But building these systems is no easy task. Construction professionals must manage complex technical requirements, long equipment lead times, and strict safety regulations - all while staying on schedule and within budget.

Key Takeaways:

  • Scope Definition: Clear project boundaries and documents (e.g., Battery Limits, RACI matrix) prevent delays and disputes.
  • Risk Management: Integration challenges, not equipment failures, are the top cause of early BESS issues. Proactive testing and clear contracts mitigate risks.
  • Scheduling Challenges: Long lead times for equipment (e.g., transformers, batteries) and utility approvals often cause delays. Early planning and tools like Primavera P6 help maintain timelines.
  • Safety Compliance: Updated U.S. codes (e.g., NFPA 855, UL 9540) require early engagement with authorities to avoid costly redesigns.
  • Specialized Teams: Roles like MEP Leads and Commissioning Managers are essential for handling the technical and regulatory complexity of BESS projects.

Bottom Line: Early planning, clear scope, risk mitigation, and the right talent ensure BESS projects are delivered efficiently and safely.

The Ultimate Guide to BESS with Drew Lebowitz and Sean Daly | TLD 032

Defining the Scope of BESS Construction Projects

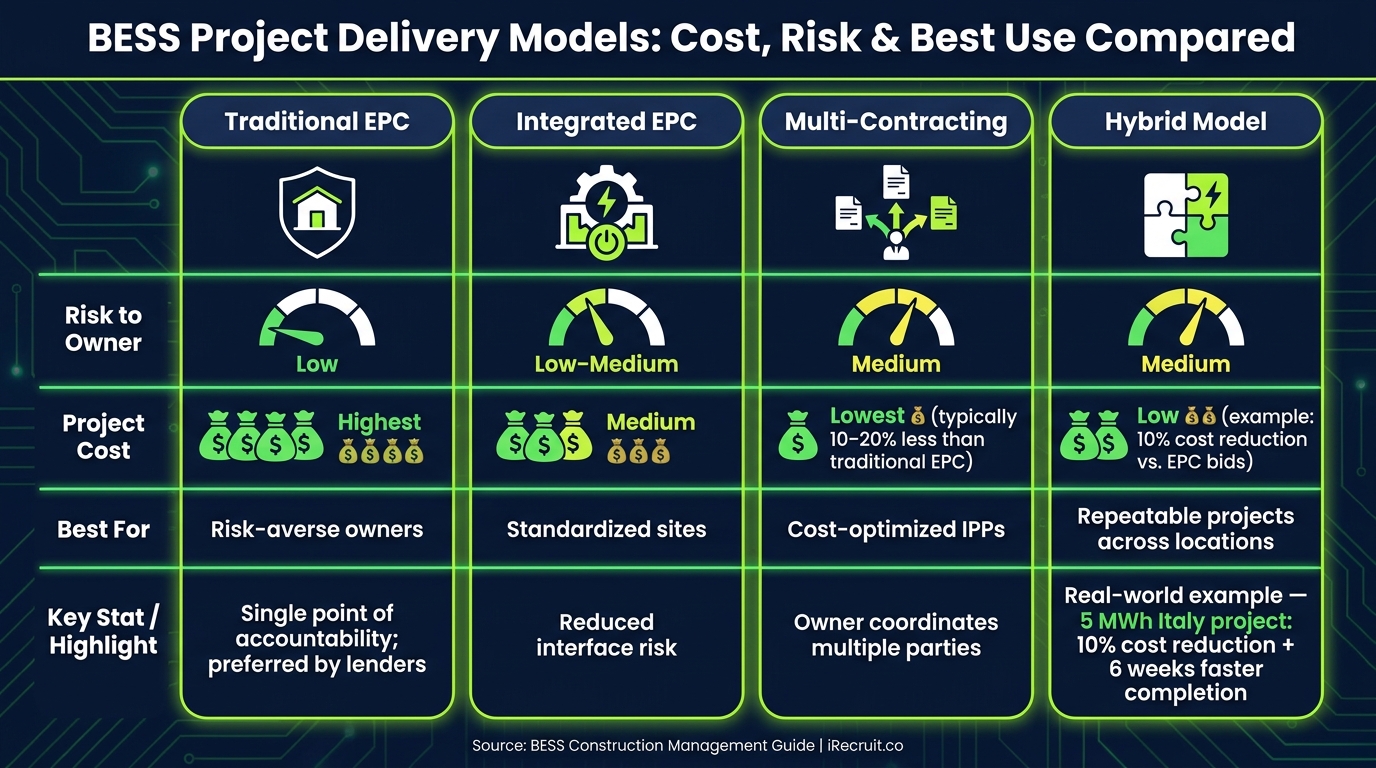

BESS Project Delivery Models: Cost, Risk & Best Use Compared

BESS Project Delivery Models: Cost, Risk & Best Use Compared

Getting the project scope right from the start is critical to avoiding delays and unexpected costs. A well-outlined scope isn't just paperwork - it's the backbone of the project, guiding contractors, engineers, and procurement teams. It also lays the groundwork for effective risk management and scheduling, which are discussed later in this guide. For more insights into how delivery models influence outcomes in the power sector, check out iRecruit's guide to power and energy infrastructure.

Key Components of a BESS Project

A Battery Energy Storage System (BESS) project is built around four main technical areas:

  • Battery System: Includes cells, modules, racks, and the Battery Management System (BMS).
  • Power Conversion System (PCS): Responsible for converting DC power to AC.
  • Energy Management System (EMS): Manages system operations and grid interactions.
  • Balance of Plant (BOP): Covers civil works, cabling, transformers, and site preparation.

Before construction begins, three essential documents need to be finalized:

  1. Battery Limits Definition: Defines the physical and functional boundary between the BESS supplier and the BOP contractor.
  2. Interface Management Plan: Addresses technical details like cable sizing, foundation loads, and communication handoffs.
  3. Responsibility Matrix (RACI): Clearly assigns tasks and ownership.

Skipping these steps can lead to scope gaps, which often result in disputes and additional expenses mid-project.

Commissioning is another critical aspect of the scope. This includes Factory Acceptance Testing (FAT), Site Acceptance Testing (SAT), performance testing, and a Baseline Capacity Test to determine the initial State of Health (SOH). The chosen delivery model will dictate how these components are managed and integrated.

Delivery Models: Integrated EPC vs. Split-Scope

The delivery model chosen for a BESS project has a significant impact on how the scope is managed. Here’s a breakdown:

  • Traditional Integrated EPC: A single entity oversees design, procurement, construction, and commissioning, offering one point of accountability. Lenders often favor this model due to reduced interface risk [5].
  • Split-Scope (Multi-Contracting): Separates the BESS supplier from the BOP contractor, requiring the owner to coordinate between multiple parties. While this approach can save costs (typically 10–20% less than traditional EPC), it increases the owner's responsibility [5].
  • Hybrid Model: Combines elements of both approaches. For example, the owner contracts directly with a BESS manufacturer for the system while hiring a local contractor for civil and electrical work. A 5 MWh project in Italy demonstrated the benefits of this model - FFD POWER supplied the BESS system, while a local contractor handled site work, leading to a 10% cost reduction and a six-week faster completion compared to initial EPC bids [5].

"This hybrid approach combines the reliability of a fully engineered BESS system with the flexibility of local EPC execution - removing cost without adding unmanaged risk." - Ang Li, CEO, FFD POWER [5]

Delivery Model Risk to Owner Project Cost Best For
Traditional EPC Low Highest Risk-averse owners
Integrated EPC Low–Medium Medium Standardized sites
Multi-Contracting Medium Lowest Cost-optimized Independent Power Producers (IPPs)
Hybrid Model Medium Low Repeatable projects across locations

How U.S. Codes and Standards Shape BESS Scope

U.S. codes and standards play a significant role in shaping BESS project requirements. Beyond safety guidelines, they define essential build and test protocols.

  • NFPA 855 (2026 Edition): This standard governs fire protection, ventilation, commissioning, and decommissioning for BESS installations. It requires a minimum separation distance of 3 feet between units and walls. The 2026 edition also mandates a Hazard Mitigation Analysis (HMA) for nearly all energy storage systems unless explicitly exempted [6].

"HMA is now the default requirement for virtually all ESS installations within the scope of NFPA 855, unless later chapters specify an exemption." - Engineering Fire Protection [6]

  • UL 9540: Requires the entire BESS system - batteries, PCS, and EMS - to be certified as one integrated unit.
  • NEC Article 706: Covers electrical installation elements like wiring, disconnects, grounding, and labeling.
  • NFPA 68 and 69: Add explosion prevention measures, including deflagration venting panels that release pressure within 200 milliseconds and systems to keep flammable gas levels below 25% of the lower flammable limit [4][2].

Budgeting for HMA early in the project is essential. Failing to address these compliance requirements upfront often leads to permitting delays and costly redesigns on U.S. projects [6].

Managing Risks in BESS Construction

Risk management in Battery Energy Storage System (BESS) projects is not a one-and-done task. It’s an ongoing process that accompanies every stage of construction, from the initial design to the final commissioning. Once the project’s scope is defined and the delivery model is chosen, the next step is to pinpoint potential failure points and establish safeguards to address issues before they arise. For a broader perspective on risk allocation in major power projects, check out iRecruit's guide to construction project delivery.

Technical and Execution Risks

Many assume that equipment quality is the biggest concern in BESS construction. But the actual challenge lies in system integration. As Kamil Talar, MSc., a BESS commissioning expert, explains:

"The cell is the easy part. The 800-odd integration points that connect cells through BMS, racks, container HVAC, PCS, transformer, protection, SCADA and EMS - those are the failure surface." [2]

System-level issues are a major driver of early BESS failures.

For instance, poorly configured HVAC systems and flawed airflow modeling can speed up battery degradation and even lead to thermal runaway. To address this, Site Acceptance Testing (SAT) should include charging the system to 80% State of Charge (SOC) and holding a full discharge for 60 minutes. This ensures that cell-level temperature spreads stay within the manufacturer’s specifications, typically 3–5°C (around 5–9°F). Additionally, communication mismatches between the EMS, PCS, and SCADA platforms can result in incorrect dispatch or operational instability. A step-by-step validation process - from individual components to subsystems and then full simulations - can help catch these software issues early.

But technical challenges aren’t the only hurdles. Commercial and contractual risks are just as critical.

Commercial and Contract Risks

The integration risks mentioned earlier significantly influence commercial exposures, depending on the chosen delivery model. In a traditional wrapped EPC (Engineering, Procurement, and Construction) contract, a single contractor is held accountable for delays and defects. However, split-scope arrangements can complicate matters. For example, delays by the Balance of Plant (BOP) contractor might lead to claims from the Battery OEM, and vice versa, without one party shouldering the full impact. Liquidated damages (LDs) are often capped at the value of each specific contract. This means that for a relatively low-cost component like an Energy Management System, the LDs may fall short of covering revenue losses caused by project delays.

A real-world example of this risk is the 2022 Australian Federal Court case, Australian Energy Regulator v. Hornsdale Power Reserve Pty Ltd. A firmware update by the battery supplier reduced the system’s maximum response capacity, violating the National Electricity Rules and resulting in a $900,000 penalty [9]. Contracts must clearly define who controls software and firmware updates and outline the consequences if those changes impact grid compliance.

To navigate these risks, construction teams can use a detailed Division of Responsibility (DOR) matrix. This tool assigns every scope element and interface point to a specific party and ties milestones to project progress. For instance, BESS commissioning could be linked to "X days after notice of cold commissioning completion" instead of fixed calendar dates. This approach minimizes the risk of one contractor’s delay triggering breaches for others.

While technical and contractual risks demand careful management, safety and regulatory compliance require proactive planning from the start.

Safety and Regulatory Compliance

High-energy DC systems come with unique hazards that go beyond standard electrical construction concerns. These include off-gassing lithium-ion cells, high-voltage DC disconnects, and the possibility of thermal runaway spreading across battery racks.

Two incidents illustrate the stakes. In May 2024, a fire at the Gateway Energy Storage Facility in San Diego involving 15,000 NMC batteries required seven days of active monitoring for flare-ups, followed by EPA-mandated environmental monitoring and battery disposal planning [7]. Similarly, in January 2025, a BESS fire at the Moss Landing facility in Monterey County, California, prompted a 24-hour evacuation of 1,200 residents before the fire was contained [7]. These events emphasize that safety planning must go beyond regulatory checkboxes.

Mitigation efforts need to start early in the design phase. Engaging the local Authority Having Jurisdiction (AHJ) and fire department early allows teams to address clearance requirements, determine fire-rated wall placements, and design suppression systems while changes are still cost-effective. Many modern installations now include integrated gas detection systems with electrochemical sensors for CO, hydrogen, and volatile organic compounds (VOCs). These systems can trigger emergency ventilation when gas concentrations reach 25% of the lower explosive limit (LEL) [8].

"You pay for a proper commissioning process today or you pay considerably more for the consequences later." - Kamil Talar, MSc., BESS Field Expert [2]

Ensuring Schedule Certainty for BESS Projects

Delays in Battery Energy Storage System (BESS) projects often stem from small, cumulative setbacks - like late transformer deliveries, utility interconnection hold-ups, or foundation crew delays. These challenges require a well-defined approach to safeguard timelines. By establishing clear scopes and managing risks effectively, project schedules can be better controlled. For a deeper dive into how schedule management ties into workforce planning in energy infrastructure, check out iRecruit’s guide to power and energy infrastructure.

Critical Path Drivers for BESS Projects

When it comes to BESS projects, the main scheduling hurdles are tied to long-lead equipment and grid interconnection approvals. High-voltage transformers and switchgear often take 40 to 60 weeks to arrive, which directly impacts the commissioning phase. Battery modules add another layer of complexity, with delivery lead times ranging from 26 to 52 weeks [1]. Any delays in procurement can push back the entire project timeline. Engaging with utilities early is also crucial, as grid interconnection processes frequently outlast physical construction schedules. Aligning foundation work with transformer delivery dates ensures civil crews remain productive and the project stays on track.

Another factor to consider is Balance of Plant (BoP) coordination. Delays in tasks like cable routing, high-voltage terminations, and handoffs between the BESS supplier, power conversion systems, and transformer can disrupt the schedule. These issues might not always show up on a high-level Gantt chart but can significantly affect timelines if not addressed proactively.

How to Reduce Schedule Risk

The best way to avoid scheduling issues is to tackle them before construction begins. Tools like Front-End Engineering and Design (FEED) studies or Early Work Agreements (EWAs) with OEMs and contractors help teams lock in long-lead orders and resolve technical questions early on. FEED studies, which typically cost about 2% of a project’s total budget, can reduce overall costs by as much as 30% [3]. During the 26-to-52-week battery module lead time, teams can focus on site preparation, foundation work, and civil tasks so that systems can be installed as soon as equipment arrives.

Using precast concrete foundations is another time-saving measure. These can be installed in just a few days, compared to the weeks required for cast-in-place concrete [1].

"Speed in energy projects does not come from pushing harder during the construction phase. Rather, it comes from early control and coordination." - Reynard [10]

For multi-contracting models, maintaining schedule integrity relies on three critical documents:

  • Battery Limits Definition: Clearly outlines physical and functional boundaries between the BESS supplier and BoP contractor.
  • Interface Management Plan: Ensures smooth coordination between stakeholders.
  • Integrated RACI Matrix: Covers all parties’ roles and responsibilities.

Without these, commissioning delays become much more likely. Advanced scheduling tools can further help keep projects on track.

Tools and Practices for Schedule Control

Primavera P6 is widely recognized as the go-to software for Critical Path Method (CPM) scheduling in utility-scale BESS projects. Its ability to handle thousands of activities across multiple phases, manage resource leveling, and track Earned Value Management (EVM) metrics makes it indispensable for complex builds [11].

"Primavera P6 is a robust tool that supports project managers in planning, scheduling, and controlling large-scale projects like the EPIC of BESS... The software's ability to manage thousands of activities across multiple phases makes it ideal for handling the complex and multidisciplinary nature of BESS projects." - Oseghale Okohue, BEngr. Msc. MBA. NEC AccPM [11]

The NEC4 Early Warning System is another valuable tool, offering a structured way to identify and address potential issues before they disrupt the critical path. Pairing this with compliance-focused layout tools like RatedPower - which incorporates regulatory spacing and manufacturer-specific logic - helps prevent last-minute design changes that can delay permitting [12].

For larger projects, phased commissioning is increasingly common. For example, the Thorpe Marsh BESS project in South Yorkshire - a 1.6 GW/3.3 GWh build led by Sungrow and Fidra Energy - used a five-phase commissioning approach. Functional tests (hot commissioning) for one array ran in parallel with mechanical and cable checks (cold commissioning) for the next. Sungrow’s logistics team also conducted two road surveys of rural access routes before deliveries began, avoiding the need for police escorts and reducing potential bottlenecks [13].

Adopting an early-phase commissioning mindset is another effective way to minimize errors.

"Commissioning is not simply that final checkbox at the end of the project. Instead, effective commissioning begins at project initiation." - Lynn Appollis-Laurent, Director of Owners' Engineering, Camelot Energy Group [14]

Start commissioning efforts at the very beginning of the project. After energization, implement a 90-day stabilization period with daily reviews of cell temperature spreads and BMS-to-EMS data integrity. This approach helps catch and address installation errors before they lead to operational issues [2].

Building and Deploying BESS Construction Teams

Getting the right team on-site is a make-or-break factor for success. BESS (Battery Energy Storage System) projects require specialized technical know-how that general construction crews often lack. That’s why workforce planning is a critical step before mobilization begins. For a deeper dive into how workforce planning ties into energy infrastructure, check out iRecruit's guide to power and energy infrastructure. Below, we’ll explore the essential roles and skills needed to execute a BESS project effectively.

Core Roles in BESS Construction

Utility-scale BESS projects hinge on a few key roles.

  • The Project Manager oversees the entire lifecycle, from grid interconnection schedules and financial metrics like IRR and NPV to managing stakeholder communication.
  • The MEP Lead handles the integration of complex systems like liquid cooling, high-voltage cabling, and fire suppression. This role has become even more demanding with the shift to 1500V architectures and liquid-cooled designs for systems exceeding 5 MWh.
  • The Commissioning Manager ensures the system’s reliability by conducting Factory Acceptance Tests (FAT) and Site Acceptance Tests (SAT), mitigating balance-of-system issues that often lead to early-life failures [2].

Other critical positions include the QA/QC Manager and Safety Manager. Safety leads must be well-versed in NFPA 70E regulations for high-voltage electrical work and the 2026 update to NFPA 855, which now includes large-scale fire test data requirements for container separation [2]. For projects using multi-contract or hybrid delivery models, an Interface Manager is indispensable. They manage the physical and functional transitions between the BESS supplier and the Balance of Plant (BoP) contractor.

These roles require not just technical skills but also leadership qualities and experience that align with the unique challenges of BESS projects.

Skills and Experience Requirements for Leadership Roles

Technical knowledge is just one piece of the puzzle. Leaders on BESS projects need to navigate "battery limits" - the clearly defined boundaries between the responsibilities of the BESS supplier and the BoP contractor. Without clear boundaries, commissioning delays are almost guaranteed [5].

"The performance you bought is gated by the install you delivered." - Kamil Talar, MSc. [2]

Commissioning leaders, for instance, must have hands-on experience with L1–L5 testing sequences and view commissioning as an integrated, ongoing process rather than a final step. Supply Chain Managers should be familiar with FEOC (Foreign Entity of Concern) regulations, as these can determine whether a project qualifies for federal tax credits. As hybrid delivery models - where BESS supply is separated from local civil and electrical work - become more common, leaders skilled in managing these split structures can help save 5–12% in overall installed costs [5].

Recruitment Support for Mission-Critical Projects

Finding top-tier talent for these roles is no easy task. Senior BESS construction positions often take over 90 days to fill [15], while the best candidates are usually snapped up in less than 21 days [16], as they are often already employed and not actively job hunting.

"A slow recruitment process is currently the #1 reason for project delays." - EPG [16]

This is where iRecruit.co comes into play. The firm specializes in recruiting for high-stakes construction projects like BESS, data centers, and energy infrastructure. They focus on sourcing pre-qualified candidates for roles such as Project Manager, MEP Lead, Commissioning Manager, and field positions. Their proactive approach involves leveraging specialist networks and filling senior roles 6 to 12 months before mobilization begins, reducing the risk of last-minute hiring. With a success-based pricing model and a 90-day search credit for replacements, iRecruit.co ensures that projects stay on schedule by securing the right expertise.

Core BESS Role Critical Competency Project Impact
Commissioning Manager L1–L5 testing & SAT execution Prevents majority of early-life failures [2]
MEP Lead 1500V systems & controls coordination Defines the project critical path [16]
Supply Chain Manager FEOC regulation & domestic content Secures federal tax credits [16]
Interface Manager Battery limits & BoP handoff management Prevents commissioning delays [5]
Safety Manager NFPA 70E & NFPA 855 (2026 edition) Ensures code compliance and site safety [2]

Conclusion and Key Takeaways

Bringing together the discussions on scope, risk, and scheduling, here are the main insights to ensure a successful BESS project.

Summary of Best Practices

Defining a clear scope, actively managing risks, and sticking to a disciplined schedule are critical for any successful BESS project. One of the smartest moves an owner can make is investing in FEED studies early on. These studies help cut down on costs and reduce risks significantly [3].

Attention to detail during construction is equally vital. Everything from precise site grading to solid foundation work and well-planned trench layouts can impact long-term operations. Interestingly, many early failures in BESS projects are tied to balance-of-system issues that arise during installation and commissioning [2].

"Most commissioning failures stem from organisational, contractual, and procedural lapses rather than technical issues." - Lynn Appollis-Laurent, Director of Owners' Engineering, Camelot Energy Group [14]

To avoid these pitfalls, using an integrated RACI matrix that includes all key players - EPCs, OEMs, and owners - is a proven strategy.

Why Specialized Construction Talent Matters

The technical complexity of BESS projects makes having the right talent on board non-negotiable. With around 800 integration points connecting systems like cells, BMS, HVAC, PCS, and EMS [2], hiring the wrong people can lead to delays, costly rework, and compliance headaches that are tough to fix mid-project. Considering that balance-of-system components and installation account for 25–40% of total turnkey costs [17], poor execution in these areas can drive up expenses significantly.

Roles like Commissioning Manager, MEP Lead, and Interface Manager are crucial for keeping schedules on track and managing costs. iRecruit.co’s expertise in construction recruiting ensures that these positions are filled with skilled professionals, ready to contribute well before the project kicks off.

Final Thoughts

BESS construction is no small feat - it requires meticulous planning that balances scope clarity, risk management, and precise scheduling. Success hinges on blending expertise in electrical and civil engineering, regulatory compliance, and procurement. Developers and owners who prioritize FEED studies, formalize interface management, and start commissioning planning early consistently outperform their peers.

Ultimately, the projects that stay on schedule and within scope share one key factor: the early deployment of the right talent. Addressing leadership gaps from the start can be the difference between a smooth project and one riddled with setbacks.

FAQs

What’s the best way to define “battery limits” on a BESS project?

Defining battery limits in a Battery Energy Storage System (BESS) project means making sure that all construction and supply contracts collectively cover every part of the project without leaving any gaps. Often, a balance-of-plant contractor is brought in to manage all necessary activities, including support for owner-supplied equipment. It's crucial for the contractor to ensure their work complies with manufacturer specifications and integrates smoothly with other components of the project. This approach helps reduce risks and ensures the project runs efficiently.

How do you reduce integration risk before commissioning starts?

To minimize integration risks before commissioning, it’s crucial to adopt a systems-focused strategy early in the project. Here’s how you can approach this:

  • Run lab tests: Test battery and inverter interactions in a controlled environment to identify and fix communication issues before deployment.
  • Validate device responses: Check controller responses, data formats, and threshold settings for all connected devices to ensure seamless operation.
  • Review firmware updates: Work closely with vendors to verify that firmware logic and configurations align with your system’s requirements.
  • Confirm compatibility: Perform detailed design reviews and formalize contractor coordination using an interface deed to ensure all components work together effectively.

By addressing these steps early, you can avoid costly delays and ensure a smoother integration process.

What early steps prevent long-lead equipment from delaying COD?

To keep the commercial operation date (COD) on track, especially when dealing with long-lead equipment like transformers, it's crucial to establish procurement responsibilities early - ideally before making final investment decisions. Here’s how to stay ahead:

  • Define a clear scope during the preconstruction phase to avoid misunderstandings later.
  • Secure early work agreements to kickstart critical tasks without delay.
  • Develop a master project plan that includes vendor lead times and schedules for factory acceptance tests (FAT).

By syncing procurement efforts with site readiness, these steps help sidestep costly delays and ensure everything runs smoothly.
