June 10, 2026

The 5 Levels of Data Center Commissioning Explained (L1–L5)

By:
Dallas Bond

Data center commissioning is a structured process to ensure that all critical systems - power, cooling, security, and IT infrastructure - function as intended before operations begin. Skipping any of the five levels (L1–L5) can lead to costly mistakes, as over 55% of major outages stem from issues that proper commissioning could have prevented. Here's a quick breakdown of the five levels:

  • L1: Factory Acceptance Testing (FAT) – Verifies equipment meets specifications before leaving the factory.
  • L2: Site Acceptance – Inspects delivered equipment for damage and ensures all parts are accounted for.
  • L3: Pre-Functional Testing – Confirms proper installation before systems are powered up.
  • L4: Functional Performance Testing – Tests individual systems under load conditions.
  • L5: Integrated Systems Testing (IST) – Simulates failures to ensure all systems work together seamlessly.

Each step builds on the previous, ensuring the facility is ready to meet uptime demands and avoid disruptions. Proper commissioning typically costs 1–3% of the project budget but significantly reduces the risk of outages and operational inefficiencies.

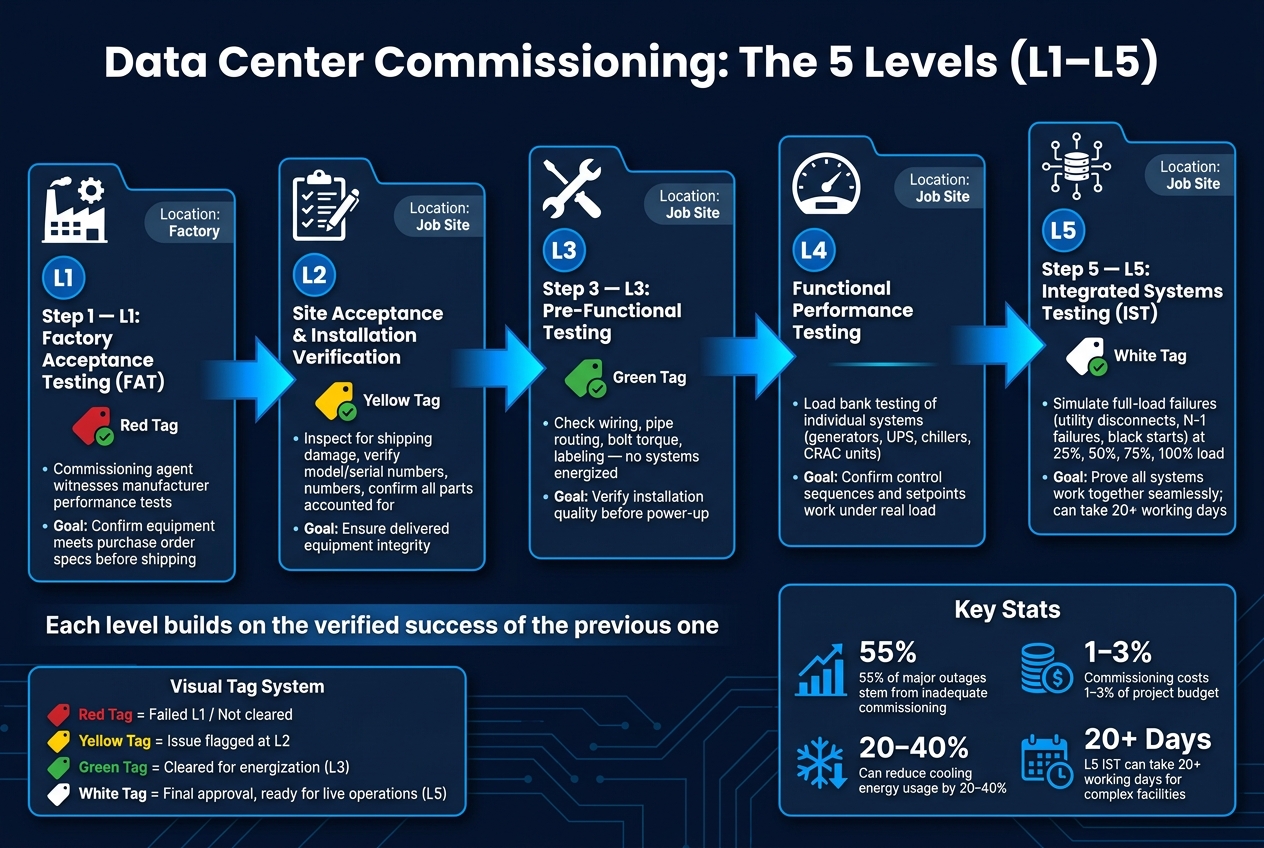

Data Center Commissioning Levels L1–L5: A Visual Guide

Data Center Commissioning Levels L1–L5: A Visual Guide

The 5 Levels of Data Center Commissioning (Explained)

Overview of the Five Commissioning Levels

The L1–L5 framework is a step-by-step process where each level builds on the verified success of the previous one. Skipping any stage compromises the reliability of the entire system. These levels guide a data center from raw equipment at the factory to a fully operational and resilient facility. Understanding each stage helps construction teams plan effectively, assign the right expertise, and avoid costly delays. For more on how commissioning fits into the overall construction process, check out iRecruit's guide to data center construction.

Commissioning Level Location Primary Focus Key Activity
L1: Factory Acceptance Testing Factory Equipment specs Witnessing manufacturer performance tests [1]
L2: Site Acceptance Job site Delivery integrity Inspecting for shipping damage and missing parts [1]
L3: Pre-Functional Testing Job site Installation quality Conducting static checks, bolt torquing, and wiring verification [1]
L4: Functional Performance Testing Job site System performance Testing individual control sequences and setpoints [1]
L5: Integrated Systems Testing (IST) Job site Facility resilience Simulating full-load failure by disconnecting power [1]

Below is a closer look at each commissioning level, including its purpose and key activities.

Level 1: Factory Acceptance Testing (FAT)

This stage takes place at the manufacturer's facility before equipment like UPS units, generators, and switchgear are shipped out. The goal is to confirm that the equipment matches the specifications outlined in the purchase order. Early detection of any issues here can prevent costly fixes later [1]. A commissioning agent or the owner's representative typically attends these tests in person to ensure the results are accurate and not just recorded on paper.

Level 2: Site Acceptance and Installation Verification

When the equipment arrives at the job site, Level 2 involves a thorough inspection to confirm that all components - including spare parts - match the purchase order and the documentation from FAT [1]. This step ensures that incomplete or damaged equipment doesn’t disrupt the construction timeline.

Level 3: Start-Up and Pre-Functional Testing

Level 3 focuses on verifying the quality of the installation. Technicians check that wiring is properly connected, pipes are routed as designed, bolts are torqued to the correct specifications, and labels align with the design documents [1]. No system is energized at this stage, acting as a safeguard to prevent errors that could impact performance later [1].

Level 4: Functional Performance Testing

After the systems are safely started, Level 4 tests each one individually under load conditions. For example, a single chiller, UPS, or generator is run through its full operational cycle to confirm that control sequences and setpoints function as intended [1]. Involving the operations team at this stage helps reduce the risk of errors once the facility is handed over.

Level 5: Integrated Systems Testing (IST)

Level 5 is the ultimate test of the facility, simulating real-world failure scenarios to ensure that all systems work together seamlessly. This includes testing responses to a full load failure by disconnecting power. Every subsystem - power distribution, cooling, fire suppression, and more - must operate in sync [1]. For complex facilities, this process can take 20 or more working days to complete [2]. The result is proof that the data center can deliver the expected 99.999% uptime for operators and tenants.

Detailed Breakdown of Each Commissioning Level (L1–L5)

This section dives into the practical steps for each commissioning level, highlighting the activities, responsibilities, and clear benchmarks for completion. For construction professionals, understanding these details is essential to ensure every phase is executed without costly errors.

Level 1: Factory Acceptance Testing

Factory Acceptance Testing (FAT) happens before equipment like UPS systems, generators, and chillers ever leave the factory. During this stage, the commissioning agent (CxA) or owner's representative witnesses performance tests to confirm the equipment meets the purchase order specifications. Catching misconfigured components here is much cheaper than fixing them on-site.

Pro Tip: Schedule FATs with enough time to allow for re-testing if defects are found. Rushing this process to meet shipping deadlines is a frequent - and expensive - mistake on large projects. Many teams use a Red tag system at this stage to identify equipment that hasn’t passed Level 1 inspection.

For more context on commissioning's role in project delivery, check out iRecruit's guide to construction project delivery.

Level 2: Site Acceptance and Installation Verification

When equipment arrives on-site, the focus shifts to inspecting its condition and confirming proper installation. The CxA and site contractors check for physical damage, verify firmware versions, and ensure all components - like spare parts and pressure gauges - are accounted for. Any issues result in a Yellow tag, and the equipment is held until resolved.

A detailed QA/QC checklist is critical at this stage. It should include:

  • Checking for shipping damage
  • Verifying model and serial numbers
  • Ensuring storage conditions are appropriate for sensitive equipment
  • Confirming installation locations match design drawings

Skipping these steps can lead to damaged or incorrect equipment being energized, a mistake that’s much harder (and more expensive) to fix later.

Level 3: Start-Up and Pre-Functional Testing

Level 3 focuses on verifying installation quality before powering up systems. Technicians check electrical connections, pipe routing, bolt torque, and labeling accuracy. Breaker settings are matched against short circuit studies, and resistance in bus ducts and breaker connections is tested to prevent heat-related failures.

At this stage, OEM startup reports are essential. These signed reports from equipment vendors confirm their systems are ready for energization. The CxA reviews these reports before issuing a Green tag, signaling readiness for the next level. Without a green tag, no system gets powered up.

Once Level 3 confirms the installation’s quality, attention shifts to testing system performance under load in Level 4.

Level 4: Functional Performance Testing

With systems safely started, Level 4 tests each one under real load conditions. Load bank testing is commonly used to ensure generators, UPS units, chillers, and CRAC units respond correctly to control sequences and setpoints [2]. During this phase, controls vendors and the BMS team fine-tune control loops and validate sensor responses.

Including the future operations team during Level 4 testing is a smart move. This hands-on exposure helps operators understand how systems behave under load and failure conditions, reducing the likelihood of errors during live operations [1].

"Individual assets can pass and the facility can still fail as a system." - Build Team [3]

This insight underscores why Level 5 testing is so important.

Level 5: Integrated Systems Testing

After individual systems pass Level 4, Level 5 shifts to verifying how all systems work together under simulated failure conditions. This includes power distribution, cooling, fire suppression, BMS, and IT infrastructure. A scenario matrix is used to simulate events like utility disconnects, N-1 failures, black starts, and security incidents at various load levels - 25%, 50%, 75%, and 100% [2].

It’s critical to define acceptance criteria before testing begins. Test results should be categorized clearly: passed with no exception, passed with documented exception, failed and retested, deferred, or accepted by the owner despite an open issue. This ensures transparency and provides the owner with a defensible record during handover.

Equipment that passes all Level 5 tests earns a White tag, marking the final approval that the facility is ready for live operations.

Integrating Commissioning into Project Delivery

Commissioning isn’t a last-minute addition; it’s a process that begins in the pre-design phase and continues all the way through project handover. Bringing a Commissioning Agent (CxA) on board early ensures that the Owner’s Project Requirements (OPR) and Basis of Design (BOD) are clearly defined before final drawings are completed. This early involvement helps integrate commissioning milestones smoothly into each phase of project delivery. (For a more detailed examination of commissioning’s role in construction, check out iRecruit's guide to data center construction.)

Aligning Commissioning with Project Milestones

Commissioning milestones are tied directly to construction phases, which helps keep the project on schedule. For instance, Level 1 Factory Acceptance Testing (FAT) happens while the facility is still under construction, addressing equipment issues before they can disrupt critical timelines. Levels 2 and 3 take place as equipment is delivered and installed, while Levels 4 and 5 occur after construction is substantially complete. Level 5 Integrated Systems Testing (IST), especially for complex facilities, can take 20 or more working days [2].

It’s essential to plan for buffer time to handle retesting. For example, if a generator fails a load bank test during Level 4, the schedule should allow time to fix the issue and retest without delaying the overall project. By aligning commissioning milestones with these phases, you ensure the facility’s systems are reliable and meet the standards discussed earlier.

Documentation and Handover Requirements

Each stage of commissioning generates key documentation that becomes part of the final turnover package. The table below outlines the expected deliverables at each level:

Commissioning Level Key Documentation Output
L1: Factory Acceptance FAT test results, compliance certificates
L2: Site Acceptance Inspection reports, deficiency logs
L3: Pre-Functional PFT checklists, startup records, punch lists
L4: Functional Performance data, control loop tuning records
L5: Integrated Systems IST reports, final reliability results

Building this documentation incrementally is essential to reducing risk during project turnover. Scrambling to gather everything at the last minute can lead to errors or missing information. O&M manuals should reflect the actual installed systems, including specific setpoints and control sequences, rather than relying on generic manufacturer documents.

"A data center is not delivered when the shell is complete. It is delivered when the critical infrastructure can carry load, fail safely, recover cleanly and support the tenant's uptime requirements." - Build Team [3]

How the Right Talent Reduces Commissioning Risk

Commissioning a data center requires a team with a unique mix of skills: independent CxAs, MEP engineers, controls specialists, and OEM technicians. The demand for experienced commissioning professionals is high, making it critical to involve the right talent early. A knowledgeable CxA can catch costly design errors before they escalate, while skilled MEP professionals on-site during Levels 2 and 3 can spot installation issues before systems are energized. Investing in experienced specialists minimizes the risk of failed Level 5 tests or operational disruptions, saving both time and money in the long run.

Conclusion and Key Takeaways

The L1–L5 commissioning framework is designed to ensure that a data center operates as intended before it’s fully operational. Each level plays a critical role: identifying defects during manufacturing (L1), verifying proper delivery and installation (L2–L3), testing system logic (L4), and demonstrating full-facility performance under simulated failures (L5). Skipping or rushing through any of these stages can lead to costly consequences - over 55% of major outages are linked to issues that thorough commissioning would have identified [1].

Commissioning typically accounts for 1% to 3% of a project’s budget, translating to around $500,000 to $1.5 million for a $50 million data center. While this may seem like a significant cost, it’s a fraction of the potential expenses from unplanned outages, which can run into the millions. Additionally, commissioning improves efficiency, often reducing cooling energy usage by 20% to 40% [1].

"The result [of commissioning] is a facility that works the way the design documents said it would work, not the way someone assumed it would work." - Data Center Geeks [1]

Achieving this level of performance requires skilled professionals, which is becoming increasingly challenging in today’s competitive job market. With 127 new hyperscale data centers expected by 2026 and 58% of operators reporting difficulties in hiring qualified technicians [1], staffing shortages pose a serious risk. For construction teams navigating this issue, working with specialized recruiters like iRecruit.co can help secure the necessary talent and avoid delays or costly rework.

To mitigate these risks, commissioning should be prioritized from the very beginning of the project. Engaging your commissioning agent early, allocating time for retesting, and involving your operations team during L4 and L5 testing are key steps to ensure a smooth transition. A disciplined approach combined with access to skilled personnel is essential for delivering a high-performing data center.

FAQs

Who owns L1–L5 testing responsibilities on a project?

Testing responsibilities are structured around a gated, collaborative approach to maintain clear accountability throughout the process.

  • Data Center Owner: Defines performance goals by creating the Owner's Project Requirements (OPR), which serve as the foundation for the entire process.
  • Commissioning Team: Led by a Commissioning Authority, this team oversees everything. They review designs, guide the process, and ensure all tests align with the established goals.
  • Vendors: Responsible for conducting factory testing to confirm equipment meets specifications before it’s shipped.
  • Contractors: Manage installation and startup tasks. They work under the guidance of the commissioning team to ensure all systems operate within the required performance standards.

This collaborative structure ensures every party plays a clear role in achieving the desired outcomes.

How do you decide pass/fail criteria for Level 5 IST?

Defining pass/fail criteria for Level 5 IST early in the project is critical. These criteria should directly align with the Owner's Project Requirements (OPR) and the Basis of Design (BoD) to maintain consistency with the project's goals.

Validation tasks will differ depending on the type of facility but must confirm that redundant systems and facility-wide responses operate as expected during simulated failure scenarios. Establishing clear and measurable standards ensures all stakeholders are on the same page, helping to drive the project toward success.

What’s the biggest reason projects fail IST the first time?

The main reason data center projects often fail Integrated Systems Testing (IST) on the first attempt is a mismatch between the Owner’s Project Requirements (OPR) and the Basis of Design (BoD). When these two key documents are unclear or not in sync, inconsistencies tend to surface - usually during the late stages of commissioning. To prevent problems during this intense final phase, it’s essential to ensure these documents are properly aligned from the very beginning.
