How to Benchmark Data Center PM Pay

By:
Dallas Bond

If I want to benchmark data center PM pay well, I need to do six things: define the pay metric, match the role to the right market, adjust for metro pressure, level the title by scope, split base/bonus/relocation, and control approvals.

That is the whole job in plain terms. If I skip any one of those steps, the pay band can drift fast - especially in tight U.S. data center markets like Northern Virginia, Phoenix, Dallas-Fort Worth, and Atlanta. The article makes one point clear: a generic construction benchmark is not enough for mission-critical PM roles.

Here’s the short version:

  • Benchmark one pay measure at a time: base salary or total cash
  • Price the right role: data center PM, not general commercial PM
  • Use local market pressure: top metros can run 10%–20% above national figures
  • Level by actual scope: PM, Senior PM, and Project Executive are not the same job
  • Keep pay parts separate: base, bonus, and relocation should each have their own rules
  • Require approval for out-of-band offers: especially above 105% of range max

A few numbers show why this matters. The article points to 1.4% vacancy in primary markets at year-end 2025, $148,000 median total compensation in Northern Virginia versus $133,000 in Columbus, and Phoenix PM base pay of $180,000–$225,000 in live-campus hiring. It also notes that bonus often makes up 15%–30%+ of cash pay for upper levels, while relocation can add tens of thousands more once tax gross-up is included.

If I were building a pay band from this article, my takeaway would be simple: start with role match, then market pressure, then level, then package design, then approvals. That keeps offers clear, easier to defend, and less likely to miss the market.

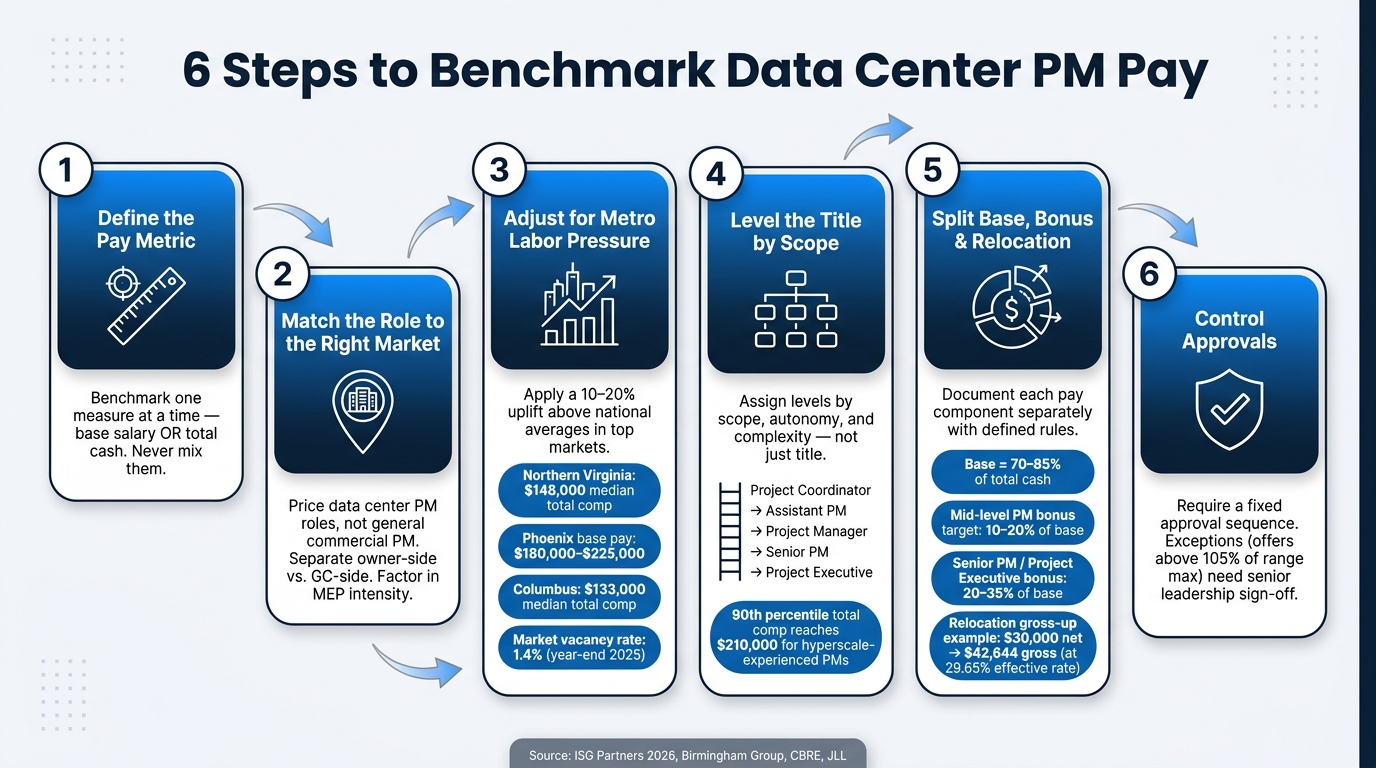

6-Step Data Center PM Pay Benchmarking Process

6-Step Data Center PM Pay Benchmarking Process

1. Map the role to the right market

Before you look at a single data point, get clear on what the job actually is. The title won’t tell you much. A Project Manager at one company may run one $50 million-$100 million building. At another, that same title may cover a $500 million+ campus with multiple phases and parallel commissioning. Same title, very different job. And those jobs sit in different pay markets.

That matters even more in today’s hiring climate. The data center construction labor landscape shows why this is such a high-stakes issue. CBRE later reported a record-low vacancy rate of 1.4% at year-end 2025 in primary markets.[3] When demand is that tight, bad role mapping gets expensive fast.

Match roles by scope, complexity, and reporting level

Start with a short role profile before you open a survey. Write down the usual project budget range, whether the PM owns one building or a multi-facility campus, and whether the role sits on the owner/developer side or the GC side. That last piece matters a lot.

Owner-side PMs often manage several GCs and vendors at the same time. GC-side PMs own day-to-day construction execution and subcontractor management. Those are not the same job, and pay should reflect that.

You should also document MEP intensity. Look at how much of the scope ties back to mechanical, electrical, plumbing, UPS, generators, and cooling systems. In high-MEP settings, the skill set is harder to find, and pay tends to run higher. Add in direct reports, change-order authority, and signature limits too. Then use that profile to line the role up with the right survey data and live-market data.

Choose the right comparison group by industry, geography, and project type

Once the role is defined, narrow the market. First, confirm the delivery setting: hyperscale cloud, colocation, or enterprise. That points you to the right industry cut - mission-critical construction competencies, not general commercial PM. Advanced manufacturing and pharmaceutical facilities can also work as comparison points when MEP complexity is close.

Then get specific about location. National all-construction averages often understate pay in the busiest U.S. hubs. JLL reported that the largest development pipelines in mid-2025 included Northern Virginia at 7 GW, Phoenix at 5 GW, and Dallas at 5 GW.[1] CBRE reported that Atlanta added 969.4 MW of inventory in H1 2025, the largest year-over-year growth among major markets.[4] It also reported that Dallas-Fort Worth absorbed 470.8 MW in 2025.[2] In markets like these, employers may need a 10-20% uplift above national mission-critical averages to stay competitive.[7]

One more filter helps: make sure the comparison roles come from organizations with active, steady data center pipelines. A firm that only touches mission-critical work once in a while is a weak match.

Separate survey data from live-market signals

Survey data gives you a starting point and helps support the pay band. But it comes with a lag. In many cases, the numbers reflect pay levels from the prior year, or even earlier. That can leave you behind the market in places like Northern Virginia or Phoenix.

Bloomberg reported that skilled-labor shortages were already forcing some builders to turn away work or poach crews.[6] That’s a strong sign that published benchmarks can go stale fast.

That’s where live-market data comes in. Track offer activity, candidate pullouts, and actual pay levels for PMs hired in the last 6-12 months. Keep it in a simple log or dashboard so you can compare it quarter by quarter against formal survey data.

If accepted offers keep landing at the survey 75th percentile, that’s your cue to move the midpoint up for that market. Use this market map to make that adjustment next. The baseline is what tells you how much local pressure should shift the midpoint.

2. Adjust the midpoint for local labor pressure and title level

A national midpoint is just the starting line. The final number should come from two things working together: local labor pressure and title level.

Compare labor pressure by metro

Start with the market. In some metros, hiring is a dogfight. In others, you still need to pay well, but the pressure isn't quite as intense.

Adjust for labor tightness and active project volume, commute burden, and relocation dependence. This tiering helps show how far above the national midpoint an offer should move.

Metro Pay Pressure Likely Premium Level Relocation Support Commonly Needed?
Northern Virginia Very high - hyperscale concentration and competition High Yes
Phoenix Very high - rapid build volume and talent demand High Often
Dallas–Fort Worth High - strong builder competition Medium-high Sometimes
Atlanta High - growing project volume Medium-high Sometimes
Chicago High - active infrastructure and project competition Medium-high Sometimes
Columbus / Central Ohio Moderate relative to top hubs Moderate Less often

ISG Partners' 2026 compensation data shows median total compensation of $148,000 in Northern Virginia versus $133,000 in Columbus for a Construction Project Manager.[9] The Birmingham Group's live-campus figures put Phoenix PM base pay at $180,000–$225,000, Atlanta at $165,000–$210,000, and Dallas at $155,000–$195,000.[8] Those gaps should push the midpoint up or down by market.

The Birmingham Group also identifies Virginia, Texas, Arizona, California, Illinois, Ohio, Georgia, Iowa, Nebraska, and Nevada as the states with the highest concentration of large projects and tight labor conditions.[5] If you're hiring in any of these states, assume the midpoint needs some upward movement before you put an offer in front of a candidate.

Level titles from project coordinator through project executive

After metro pressure, title level is the next adjustment. This matters because title inflation can squeeze pay bands and blur the line between solid performers and people carrying much bigger scope.

Assign level based on scope, autonomy, decision-making authority, and project complexity. A project coordinator works under close direction. An assistant PM supports field and vendor coordination. A PM owns delivery for one or more projects. A senior PM handles larger, higher-risk work and may mentor other PMs. A project executive works across a portfolio, oversees multiple PMs, and drives commercial outcomes.

Use this matrix to keep leveling and pay bands lined up.

Use a leveling matrix to set range spread

Title Scope Decision-Making Authority Typical Project Complexity Supervisory Responsibility Pay Level
Project Coordinator Task support, works under direction Routine, limited Lower complexity None or minimal Entry
Assistant PM Defined workstreams, vendor/field coordination Moderate, escalates to PM Small to moderate Limited Junior
Project Manager Owns delivery of one or more projects Moderate autonomy Moderate to high May coordinate others Mid
Senior PM High-risk work, may mentor PMs Higher autonomy High Often mentors PMs Senior
Project Executive Portfolio-wide delivery, executive relationships Strategic, commercial outcomes Portfolio-wide Leads PMs or site teams Executive

Use the matrix to set both midpoint and range spread. Keep ranges tighter at the coordinator and assistant PM levels. Open them up more at senior PM and project executive, where performance differences tend to be bigger.

ISG Partners notes that the 90th percentile for Construction Project Manager total compensation reaches $210,000, concentrated among PMs with completed hyperscale builds.[9] A leveling matrix helps account for that spread without letting every hire bargain their way to the top of the band.

Once the midpoint and level are set, build the full offer structure.

3. Build total compensation: base pay, bonus, and relocation

Once you’ve set the midpoint and level, the next move is building the full offer. Base salary is the starting point. But for data center PMs, a strong package usually also includes a bonus plan and, in many cases, relocation support. Write down each part so offers stay consistent and easy to justify.

Design bonus plans around measurable project outcomes

Use the same scope and market logic that set the midpoint to shape bonus and relocation terms. Tie bonuses to performance instead of handing out discretionary year-end awards. Employers are linking payouts to measurable outcomes like schedule adherence, safety, cost, quality, and client satisfaction, with schedule and commissioning readiness often carrying the most weight.[10][12]

Base salary usually makes up 70–85% of total cash compensation for construction PM roles, with the rest coming from bonuses.[10] For mid-level PMs, annual target bonuses often fall in the 10–20% range. Senior PMs and project executives who run multi-site portfolios or carry P&L responsibility often land in the 20–35% range.[10]

A practical setup is to split the annual bonus between company results and project-level KPIs the PM can directly influence - usually 40–60% to each side.[10][12] Common KPIs include:

  • Schedule adherence
  • Safety performance
  • Cost at completion versus budget
  • Punch-list and quality metrics
  • Commissioning defect rates
  • Client satisfaction

Document the measurement period, data sources, who validates performance, and when payment happens. That keeps expectations clear and cuts down on disputes later.

Project completion bonuses are showing up again in data center work, tied to energization, integrated systems testing, and handover.[11] Construction salary data show project completion bonuses in the range of $3,000–$8,000 per project, with larger project bonuses running 10–25% of base for major builds.[13] Safety milestone bonuses of $2,000–$5,000 per injury-free period are also common on active hyperscale sites.[13]

For multi-year campus programs, retention bonuses can help keep senior PMs and project executives in place through back-to-back phases. These are often paid at 24 or 36 months, or at phase completions, and usually range from 10–30% of annual base salary per event.[10]

Bonus Type Primary Trigger Typical Payout Timing Best-Fit PM Levels
Annual Performance Corporate results + project KPIs (schedule, safety, cost, quality, client) Q1 following performance year PM, Senior PM, Project Executive
Project Completion Defined milestone achieved with cost, safety, and quality thresholds At substantial completion or split across completion and stabilization PM, Senior PM, Project Executive
Retention / Stay Bonus Tenure on program and/or multi-phase campus performance Pre-set dates (e.g., 24/36 months) or phase completions Senior PM, Project Executive

Benchmark relocation support as part of the offer

Relocation support should be a targeted decision, not a default add-on. Size it based on local labor pressure, project urgency, and how specialized the candidate’s background is. A senior PM with hyperscale commissioning experience moving into Northern Virginia for an immediate start may call for a very different package than a mid-level PM relocating for a project with a flexible timeline.

Most employer-paid relocation benefits are taxable wages reported on Form W-2.[16][17] That makes tax gross-up a key part of a competitive package. At a combined effective rate of 29.65%, a $30,000 net relocation benefit requires a $42,644 gross payment to keep the employee whole.[15]

Core domestic relocation support often includes lump-sum cash, moving services for household goods, temporary housing, and one or two house-hunting trips.[14][15] Household goods moves can run about $3,000–$15,000, with broader corporate full-service moves reaching $25,000.[14][15] Temporary housing is often set at 30–90 days of support, with corporate calculators showing about $2,800–$3,300 per month at the typical end and up to $10,000 per month at the high end.[14][15] House-hunting trips usually run $1,500–$7,500 each.[15]

For senior PMs and project executives relocating to high-pressure metros like Northern Virginia or Phoenix, packages often need to sit near the top of those ranges, especially when full tax gross-up is included.[10]

A simple tiering framework can keep approvals consistent:

  • Tier 1 for local moves with minimal support
  • Tier 2 for regional moves with a standard package
  • Tier 3 for national moves to high-cost or high-pressure markets with enhanced support and full gross-up

Each tier should have defined components and dollar caps.

Once the package is set, route any exception through the approval sequence.

4. Approve the offer and keep the process controlled

After the band, level, bonus, and relocation rules are set, the last job is simple: keep the offer process under control. A benchmark only does its job if people actually follow it. That matters even more in tight data center labor markets, where hiring teams can start making up rules on the fly.

Once the band, midpoint, and total comp are set, the next step is making sure every offer follows the same path.

Follow a fixed approval sequence for exceptions

The standard path should stay fixed. The recruiter or talent lead checks the band, the hiring manager confirms title and scope, and finance clears the budget. If those checks pass, the written offer goes out.

Exceptions need a stricter path. An exception starts when an offer goes above the band, often above 105% of the range maximum[24], or when the package includes a nonstandard term, like a larger sign-on bonus or an expanded relocation package. In those cases, add a market review that shows why the exception makes sense. After that, get senior leadership approval before anything is sent.

Relocation belongs inside the offer decision. It should not be treated like a last-minute add-on.

Relocation requests should be approved at the same time as base pay. Ask for a written reason that explains why the role is hard to fill in the local market, the proposed amount as a share of base salary, and any service agreement terms tied to the payment.[18][19][20][21][22][23] Keeping relocation in the same approval flow helps keep total comp inside the documented band.

The written offer is the point where the benchmark turns into an actual hiring decision, so every term needs to match the approved band. That includes:

  • base salary
  • bonus eligibility
  • relocation support, if it applies
  • start date
  • reporting line, if needed
  • any conditions tied to the offer

If project bonuses apply, the offer should also state the measurement period, the criteria, and when the payout happens. Vague offer letters are a common reason for delayed acceptances and disputes after hire.

For employers hiring across multiple metros, a centralized offer review process helps keep similar candidates priced under the same rules, no matter which hiring manager is involved.[25][26] If one market has more labor pressure than another, that adjustment should be stated clearly and documented. It should not be handled informally. A periodic review of accepted offers against the band can catch pay drift early, before it turns into compression or internal equity issues later.

With approvals documented, the band is ready to be used the same way across hires.

Conclusion: Build pay bands that are market-priced and ready to use

The full process comes down to six steps: define the right compensation measure, map the role to the right market and comparison group, adjust the midpoint for metro labor pressure, level titles before pricing, document bonus and relocation terms in writing, and require approvals before any offer goes out. Each step answers a clear question, so nobody is improvising at the end.

A fixed sequence cuts rework, speeds up decisions, and helps prevent pay drift, compression, and post-hire equity problems.

FAQs

How do I set a pay band for a data center PM?

Benchmark regional market data first. Then adjust it for project complexity, commissioning scope, and local labor pressure. Build the pay band around total compensation, not salary alone.

That means looking at the full package:

  • Annual bonuses, which are often 10%–25% of base pay
  • Retention bonuses tied to build milestones
  • Vehicle allowances
  • 401(k) matches

You should also add premiums for credentials like PMP, CxA, or NICET. On top of that, factor in local cost-of-living differences. In Northern Virginia, for example, a 10%–20% premium is common.

If you skip those extras, the range can look fine on paper and still miss the market.

When should I adjust pay above the national midpoint?

Adjust pay above the national midpoint when local labor pressure, project complexity, or specialized technical skill make it necessary.

That often happens in places like Northern Virginia and Phoenix, where pay premiums of 10% to 15% or more are common. The same goes for candidates with hyperscale data center experience, key credentials like PMP, CxA, or OSHA 30, and roles that demand heavy site presence, frequent travel, or added energization and commissioning risk.

What should a PM offer package include?

A data center project manager offer package should go beyond base salary. It should show total compensation early, so the full picture is clear from the start.

That usually means including a competitive base salary, performance bonuses of 10%–25%, and completion bonuses in the $15,000–$40,000 range. If the role involves travel or a move, spell out travel support and relocation help too.

Benefits matter here as well. Common pieces include:

  • 401(k) matching
  • Health insurance
  • Stock options or RSUs

When you put these parts together up front, the offer feels more concrete and easier to judge.

Related Blog Posts

Keywords:
data center PM pay, project manager compensation, data center salaries, pay benchmarking, relocation packages, bonus structure, labor market adjustment, leveling matrix
Free Download

Data Center Construction Labor Trends in 2026

Thank you! Your submission has been received!
Oops! Something went wrong while submitting the form.

More mission critical construction news

Georgia Power starts Plant Bowen gas unit construction
August 5, 2026

Georgia Power starts Plant Bowen gas unit construction

Georgia Power begins construction of two 1,500 MW gas units and a 500 MW battery at Plant Bowen.
DOE unveils $100B Paducah AI data center project
August 5, 2026

DOE unveils $100B Paducah AI data center project

DOE and partners plan a $100B+ Paducah AI data center campus with 1.8GW computing, 2GW gas generation and battery storage.
Texas orders grid audits for data center connections
August 5, 2026

Texas orders grid audits for data center connections

Texas Gov. Abbott orders PUCT and ERCOT to audit data centers seeking grid connection; noncompliant projects will be denied.
MEP Talent Supply Study: Data Center Hiring
August 5, 2026

MEP Talent Supply Study: Data Center Hiring

U.S. data center MEP demand outpaces supply—electricians, commissioning, controls, and leaders are hardest to fill; hire 6-12 months early.
