September 28, 2026

Kansas Data Center Construction Jobs 2026: Hutchinson & De Soto

By:
Dallas Bond

If I had to pick one Kansas market for 2026 data center construction work, I’d pick De Soto. It already has confirmed job activity, while Hutchinson still has no filed project, no approved site, and no public hiring timeline.

Here’s the short version:

  • De Soto is the active market
    • Beale Infrastructure started its first phase in May 2026
    • Reported local construction employment is about 400 to 800 jobs
    • Digital Realty’s Astra North could add more work later, but it still has no confirmed start date
  • Hutchinson is still a watchlist market
    • As of June 2026, the city reported no project filing or permit request
    • No developer, GC, or approved site has been confirmed
    • Any 2026 hiring there should be treated as unconfirmed
  • The roles most likely to be tight in De Soto

That means if I’m a candidate, contractor, or recruiter, I’d treat De Soto as the place to act now and Hutchinson as the place to track.

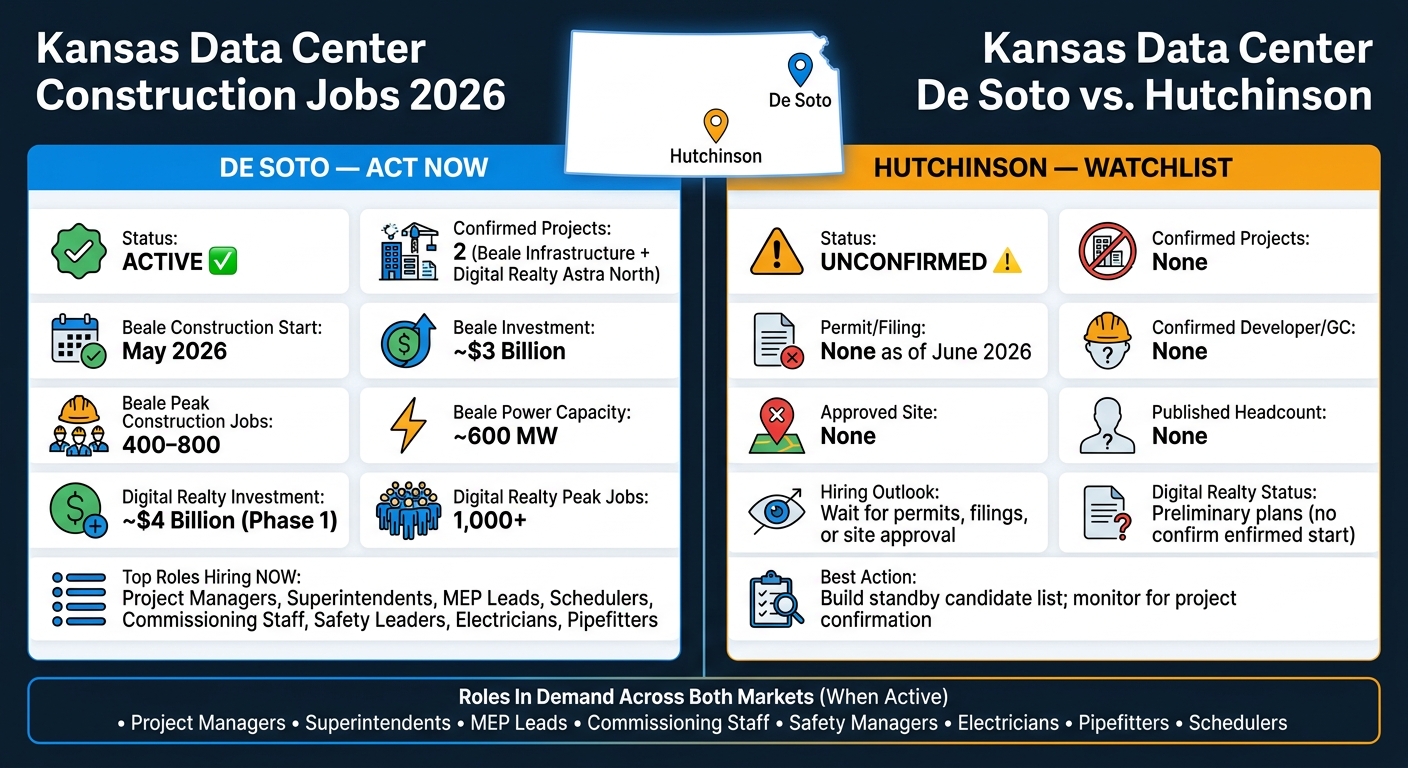

De Soto vs Hutchinson: Kansas Data Center Construction Jobs 2026

De Soto vs Hutchinson: Kansas Data Center Construction Jobs 2026

Quick Comparison

Market 2026 status Confirmed project activity Reported construction demand Hiring outlook and trends
De Soto Active Yes 400–800 local jobs reported for Beale; 500–600 workers projected for a Digital Realty first phase Near-term hiring is real
Hutchinson Unconfirmed No No published headcount Wait for permits, filings, or site approval

In plain terms: De Soto has work in motion , despite broader hyperscale hiring challenges. Hutchinson does not. If you need the best shot at Kansas data center construction jobs in 2026, the safer bet is De Soto.

1. De Soto, Kansas

De Soto has two projects that matter for 2026 hiring: Beale Infrastructure's campus at Flint Commerce Center and Digital Realty's proposed Astra North development at Astra Enterprise Park.

Here's the simple split. Beale is moving now. Astra North is still in the planning stage. So if you're looking at 2026 hiring, De Soto breaks into one project that's already putting people to work and one that's still a pipeline play.

Beale Infrastructure: Active and Advancing

Beale announced its first phase in April 2026, with construction beginning in May 2026. That opening phase covers roughly 1.16 million square feet across at least two facilities. The full campus is planned at about $3 billion across four buildings on roughly 290 acres, with about 600 megawatts of capacity.[6][7]

That kind of buildout creates demand early, and most of it starts with site prep, utilities, and core infrastructure. Beale is privately funding project-specific roads, power, water, and wastewater improvements,[4] which means hiring starts on the ground before the full building systems come into play.

Early demand falls into three main groups:

  • Civil and site: project managers, site superintendents, earthwork and utility foremen, surveyors, equipment operators, and concrete crews
  • MEP and power: electrical and mechanical project managers, MEP superintendents, BIM/VDC coordinators, electricians, pipefitters, sheet-metal workers, and controls technicians. Priority work includes high-voltage distribution, medium-voltage systems, emergency power, and substation work
  • QA and safety: quality managers, safety professionals, and commissioning authorities

Local construction employment has been estimated at 400 to 800 jobs, depending on the phase and source.[2] In practice, civil and site roles come first. After that, MEP and commissioning demand picks up as the project moves into enclosure and systems installation.

Digital Realty / Astra North: Large-Scale but Earlier-Stage

Digital Realty acquired about 1,440 acres at Astra Enterprise Park near West 103rd Street and Lexington Avenue for about $475 million.[9] Astra North's preliminary first phase would span about 280 acres and include up to nine data center buildings and two substations.[5][8]

If permits and contract awards move ahead, hiring would likely unfold in stages. The first wave would center on preconstruction leaders, permitting specialists, estimators, schedulers, and owner's representatives. Then you'd expect demand for general superintendents, construction managers, and civil engineers. After that, the focus would shift to MEP leads, commissioning authorities, safety leaders, quality-control staff, and skilled trades.

Because the plan includes nine buildings and two substations, the top recruiting priorities would likely be power infrastructure, medium-voltage electrical work, and controls expertise.[5][8]

The big catch is timing. Astra North presented preliminary plans to the De Soto City Council in June 2026, but there is still no confirmed construction start and no public detailed phasing schedule.[8] So this is a project to track closely, not a near-term 2026 hiring engine.

Factor Beale Infrastructure Digital Realty / Astra North
Construction status In progress - first phase announced April 2026, construction beginning May 2026[6] Proposed - preliminary plans presented June 2026[8]
Reported investment scale About $3 billion for the full campus[6] About $4 billion for Astra North's first phase, excluding equipment[8]
Peak construction jobs 400–800 (reported local estimate)[2] More than 1,000 at peak[5]
Operating jobs About 50 initial on-site jobs, with growth in later phases[2] About 250 operating jobs[5]
Power capacity About 600 MW across the full campus[7] About 600 MW in the first phase[5][8]

Beale is the place where 2026 hiring is already taking shape. Astra North is the project with the bigger long-range labor upside, which means firms that start making connections now may have an edge once contracts start landing. That split carries into the Hutchinson market, where 2026 demand is still unconfirmed.

2. Hutchinson, Kansas

Hutchinson is in a very different spot. There’s no confirmed project, no approved timeline, and no sign of near-term hiring. In June 2026, the City of Hutchinson said it had received no project filing or permit request for either a data center or a utility-scale battery storage project.[12] People are talking about possible sites near East Fourth Avenue and East 43rd Avenue, but neither location has been confirmed.[13]

So why is Hutchinson still in the mix at all? At this point, it comes down to policy and land-use prep, not boots on the ground. The city has been working on zoning rules that would bar large-scale data centers from residential districts and require a Conditional Use Permit in commercial and industrial zones.[14]

Why Hutchinson Could Eventually Draw a Project

Kansas Senate Bill 98 gives qualifying data center projects a 20-year sales-tax exemption. That said, Hutchinson still has no confirmed developer and no project that qualifies today.[11]

If that changes, hiring would likely follow the same mission-critical pattern seen in other data center builds. Early demand would probably center on project managers, superintendents, schedulers, estimators, civil teams, MEP leads, commissioning staff, safety, quality, and skilled electrical and mechanical trades. The hiring challenge would be obvious: with no named developer, no GC, and no set schedule, much of that mission-critical labor would likely need to come from outside Hutchinson.

Category Hutchinson Status (as of June 2026)
Formal project application None reported[12]
Confirmed developer or GC None identified
Approved project sites None; two locations discussed locally, unconfirmed[13]
Verified construction headcount No published estimate

What Employers Will Prioritize in Each Market

De Soto needs active, at-scale hiring. Hutchinson needs readiness hiring.

That difference matters because it changes where sourcing should begin.

In De Soto, the clearest near-term demand is in project leadership and MEP execution. The campus is being built in phases, which means repeated hiring waves for in-demand mission-critical roles. Employers should start with people who know how phased data center construction works in practice, especially project managers and superintendents who have handled long-lead equipment, multiple prime contractors, and the handoff from construction into commissioning.

One regional commissioning posting asked for candidates with at least 12 years of general construction experience and five years of commissioning experience.[15] That level of seniority tells you a lot about this market. Employers aren’t just filling seats. They want people who can step into a tough job and keep a large, complex build moving.

In Hutchinson, the hiring focus is more practical. Instead of building out a large active team right away, employers should keep a standby bench of professionals with transferable mission-critical experience who can mobilize fast if a project gets confirmed.

Here’s where that points hiring teams in each market:

Role Group De Soto Priority Hutchinson Priority Key Proof Points
Project Leadership Multi-building PMs, program executives Superintendents, project managers Phased campus delivery, owner reporting, change-order control
MEP & Commissioning MEP managers, Primavera P6 schedulers, BIM/VDC coordinators, commissioning program leads MEP coordinators, commissioning and turnover support Medium/high-voltage distribution, UPS, chillers, switchgear, level 0 through level 5 testing, integrated systems testing experience
Safety Site safety managers with large multi-contractor site experience Safety manager with transferable industrial experience Safety record, subcontractor audit results, OSHA 30, energized-work controls
Skilled Trades Electricians, pipefitters, ironworkers, HVAC techs, controls specialists Electricians and mechanical techs Licenses, trade certifications, manufacturer training, backup-power or cooling system experience

In both markets, the strongest candidates will be the ones who can show project value, peak workforce, scope, schedule result, and commissioning outcome - and prove it with clean project documentation.

Pros and Cons for Recruiters, Contractors, and Candidates

These hiring trends create very different recruiting risks in each market. Treat De Soto as an active hiring market and Hutchinson as a watchlist market.

De Soto is likely to draw heavy competition from Panasonic and other industrial employers, especially for electricians, safety staff, mechanical specialists, and supervisors. Job-count estimates also depend on the phase. Digital Realty's first phase has been reported at about 500 to 600 construction workers[1], while broader campus estimates have gone above 2,500[10]. So recruiters shouldn't assume the highest number is locked in. And there’s a catch: construction hiring peaks don’t last forever. Once commissioning is done, headcount drops.

Hutchinson is a different story. There’s less immediate pressure, but more uncertainty. The local talent pool is thinner for specialized roles, and there’s still no confirmed project or timeline[11]. A smart move here is to build a standby candidate list and keep regional specialists engaged until the project is confirmed.

De Soto Hutchinson
Pros Larger proposed investment; multi-year phasing; hundreds of construction jobs estimated; nearby industrial workforce from Panasonic and other employers; clear outreach target for project managers, superintendents, MEP leads, and skilled trades[1][2][3] Less saturated labor market; transferable industrial talent; access to candidates before they are locked into larger projects; lower direct competition for senior field leadership
Cons Talent competition with Panasonic and other industrial employers; job-count estimates vary by source and phase; construction jobs are temporary compared with the smaller operating workforce[1][2] No confirmed project or hiring timeline; smaller specialized talent pool; likely need for relocation or commuting support; fewer immediate openings for commissioning, scheduling, or MEP roles[11]

For candidates, the choice mostly comes down to timing and risk tolerance.

De Soto offers a better shot at near-term work in MEP, commissioning, supervision, and skilled trades. Hutchinson may fit people who want to get in early in a less crowded market, especially those with industrial experience they can apply to mission-critical work before a long data center track record becomes a must-have.

Before accepting any role, verify the employer, the project phase, the start date, and whether the job is tied to construction, commissioning, or operations. Project verification should come first before any offer.

Conclusion

For 2026, the comparison is pretty clear: De Soto is the market you can act on now; Hutchinson is the one to monitor. De Soto already has confirmed work in motion. Hutchinson does not. Public reporting still has not confirmed the same timeline, scope, or hiring volume seen in De Soto.[11] So for now, Hutchinson belongs on the watchlist, not the hiring list. That distinction shapes the next move for candidates, contractors, and recruiters.

The move is different for each group. Candidates should go after De Soto now, show mission-critical project results, and keep an eye on Hutchinson without treating it like active hiring. Contractors should lock in De Soto packages and subcontractors early. This includes preparing for emergency staffing needs to prevent labor-driven delays. Recruiters should build De Soto pipelines around PMs, superintendents, schedulers, MEP leads, commissioning staff, safety leaders, and skilled trades, while keeping Hutchinson prospects engaged with clear updates about its unconfirmed status. It also helps to plan around job-count ranges instead of headline totals. Phase-specific construction numbers, peak workforce estimates, and permanent operating roles are not the same thing.

In De Soto, early positioning matters because each phase brings another wave of hiring.

FAQs

How can I verify a De Soto job is tied to active construction?

Check local permitting activity and capital announcements. They often show up 6 to 18 months before groundbreaking.

You should also keep an eye on city documents for project-specific names like Project Jayhawk, along with utility coordination, energy service agreements, and site-specific due diligence or predevelopment agreements. Those details usually mean a project is moving through planning or feasibility.

When might Hutchinson become a real hiring market?

Hutchinson turns into a real hiring market when a specific data center project moves out of the study phase and into active development.

Right now, most hiring activity in Kansas is centered in De Soto. For Hutchinson to become a hiring hub, it would need to line up a developer, lock in utility power agreements, and reach a notice to proceed.

What experience matters most for data center construction roles?

Direct data center experience carries the most weight. That said, employers also value transferable work from semiconductor, pharmaceutical, healthcare, and power projects.

The strongest backgrounds usually include complex MEP systems, commissioning, fast-track scheduling, phased energization, mission-critical standards, and Primavera P6.

Certifications can help. But when hiring teams look at candidates, proven results on complex, MEP-heavy projects tend to matter most.
