Mission-Critical Construction Labor Shortage 2026: Numbers by Sector

By:
Dallas Bond

If you hire for data centers, fabs, hospitals, labs, nuclear/SMR, or battery storage in 2026, the labor gap is already here. I see the same pattern across the data: the U.S. construction industry needs 349,000 net new workers in 2026, 87% of firms have open craft roles, 82% have open salaried roles, and 42% say labor shortages have already delayed projects.

Here’s the short version:

  • Data centers and semiconductor fabs are fighting over the same electricians, controls techs, MEP leaders, and superintendents.
  • Healthcare and life sciences need people with jobsite experience in regulated settings, which shrinks the hiring pool.
  • Nuclear/SMR and energy storage put even more pressure on electricians, pipefitters, welders, commissioning teams, and QA/QC staff.
  • The hardest roles to fill are the same across sectors: superintendents, project managers, electricians, commissioning leads, MEP managers, QA/QC managers, and pipefitters/welders.

If I boil the article down to one point, it’s this: the national labor shortage matters, but mission-critical work feels it harder because demand is packed into a few sectors and a small set of roles.

What the numbers say right away:

  • 349,000 net new workers needed in U.S. construction in 2026
  • 456,000 net new workers projected in 2027
  • 599,700 electricians employed nationwide in 2025
  • 305,170 construction managers employed nationwide in 2025
  • 81% of firms with electrician openings report hiring trouble
  • 75% of firms report superintendent hiring difficulty
  • Only 1,232 active Certified Commissioning Authorities were counted in the U.S. as of January 1, 2025

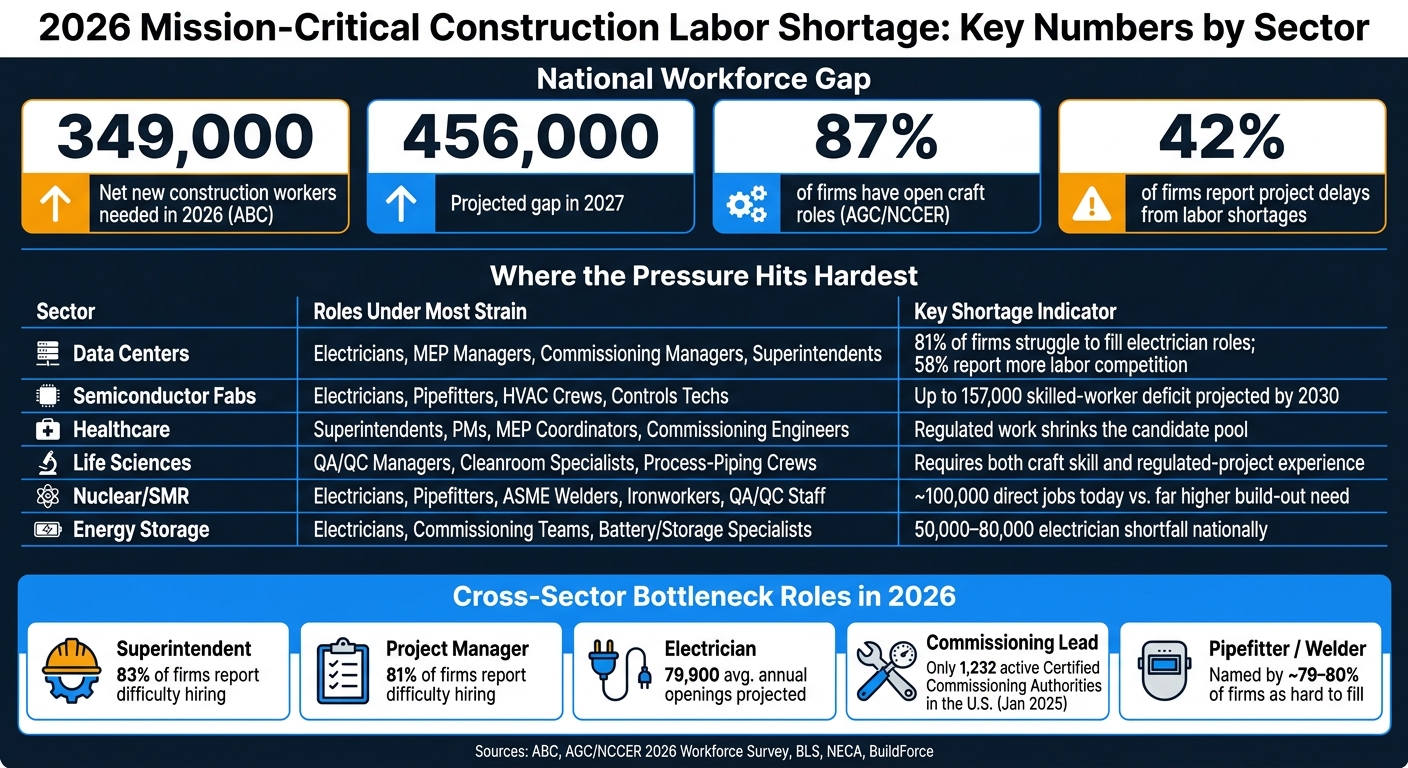

2026 Mission-Critical Construction Labor Shortage: Key Numbers by Sector

2026 Mission-Critical Construction Labor Shortage: Key Numbers by Sector

Skilled Labor Shortages Threaten U.S. Construction as AI Boom Creates New Demand

Quick Comparison

Sector Main labor pressure Roles under the most strain Main hiring problem
Data centers Fast schedules and heavy electrical/mechanical scope Electricians, MEP managers, commissioning managers, superintendents, controls techs Multi-project competition in the same markets
Semiconductor fabs Cleanroom work and dense process systems Electricians, pipefitters, HVAC crews, controls techs, field leaders High skill bar plus CHIPS-driven demand
Healthcare Strict codes and active-facility work Superintendents, PMs, MEP coordinators, commissioning engineers, medical gas installers Regulated work cuts the candidate pool
Life sciences Cleanrooms, process piping, validation QA/QC managers, cleanroom specialists, process-piping crews, commissioning staff Hiring needs both craft skill and regulated-project experience
Nuclear/SMR Tight quality rules and heavy craft needs Electricians, pipefitters, ASME welders, ironworkers, millwrights, QA/QC staff Small labor pool and heavy quality staffing needs
Energy storage Heavy demand for licensed electrical and commissioning talent Electricians, commissioning teams, battery/storage specialists Same talent pool as grid, industrial, fabs, and data centers

So if you’re planning hiring for a 2026 mission-critical project, the takeaway is simple: hire earlier, line roles up to project phases, and expect the hardest pressure in MEP, field leadership, commissioning, and quality. That’s the core of what this article shows.

U.S. Construction Workforce Gap in 2026

Mission-critical employers aren't hiring in a separate market. They compete for the same people as the rest of construction. So the national labor gap is the starting point, not the full story. And that's a big deal, because mission-critical work pulls from the same workforce as general commercial projects.

ABC, AGC, and BLS: 2026 Shortage Figures Compared

ABC estimates a 349,000-worker gap in 2026, with more than half of that demand tied to replacing retirees. Then the gap grows to 456,000 in 2027.[3][8][12]

The AGC/NCCER 2026 Workforce Survey shows what that looks like on the ground. The survey included 1,830 respondents in July and August 2026.[9][10][11] The results are hard to ignore: 87% of firms report open hourly craft positions, 82% have openings for salaried roles, and 42% say workforce shortages have already caused project delays.[13]

BLS employment data add hard occupation counts to the picture. In 2025, the U.S. employed 305,170 construction managers and 599,700 electricians nationwide.[4] That may sound like a lot at first glance. But for MEP-heavy projects, it's still a tight pool of seasoned talent, especially when owners need superintendents, MEP managers, commissioning staff, electricians, and QA/QC leads.

These figures set the baseline. The table below shows how that baseline turns into hiring pressure for mission-critical work.

Source Year Key Figure Scope Why It Matters for Mission-Critical
ABC 2026 349,000 net new workers needed All U.S. construction Sets the national baseline; mission-critical sectors compete within this pool[3][12]
ABC 2027 456,000 net new workers needed All U.S. construction Gap grows as spending rebounds; plan hiring now[3][8][12]
AGC/NCCER 2026 survey 87% craft openings; 82% salaried openings Broad construction firms Hiring pressure hits both field and leadership roles[13]
AGC/NCCER 2026 survey 42% report project delays from shortages Contractor and subcontractor labor Labor shortages are already affecting schedules[13]
BLS 2025 305,170 construction managers National occupation benchmark Shows the limited pool of experienced field leadership[4]
BLS 2025 599,700 electricians National occupation benchmark Electricians are a core bottleneck trade for MEP-heavy mission-critical builds[4]

Why Mission-Critical Projects Face a Harder Hiring Environment Than General Commercial Work

The national numbers are already tight. Mission-critical projects make that pressure worse for four main reasons.

First, schedule sensitivity changes the stakes. In mission-critical construction, delays don't just push back a handoff date. They can affect tech rollouts, production targets, or hospital capacity. AGC/NCCER data show that 42% of firms are already dealing with delays tied to workforce shortages.[13]

Second, MEP intensity piles on more pressure. Data centers, fabs, hospitals, and life sciences labs need dense electrical systems, precision cooling, process piping, and complex controls. In plain English, these projects lean hard on the exact trades that are already tough to hire. AGC/NCCER points to electricians and mechanics as part of that pressure point.[6]

Third, regulatory requirements shrink the hiring pool even more. Healthcare and life sciences projects come with infection control rules, pharmaceutical quality standards, and cleanroom requirements. Nuclear/SMR projects add nuclear safety culture expectations and strict permitting. Employers aren't just looking for people who can do the work. They need people who've already worked in regulated settings, which cuts the candidate pool inside an already strained market.

And then there's the skills issue. Half say applicants lack the skills, certifications, or licenses required.[13] For mission-critical employers, the problem isn't just headcount. It's finding people with the right credentials and jobsite experience.

That baseline gets tighter in the sector breakdown below, where demand clusters in data centers, fabs, healthcare, life sciences, nuclear/SMR, and energy storage.

Sector Shortages: Data Centers and Semiconductor Fabs

The national labor shortfall gets even tighter in data centers and semiconductor fabs. In 2026, these sectors are set to compete hardest for electricians, MEP managers, controls technicians, and superintendents, often in the exact same metros. Data centers usually feel the hit first because demand is concentrated, moves fast, and tends to pile up in a few hot markets.

Data Center Construction Labor Gap in 2026

Hyperscale and AI data centers need big craft crews and fast schedules. That combination creates significant staffing challenges on large-scale construction projects, and electricians and mechanical trades often become the bottleneck when teams try to run multiple builds at once.[14]

AGC's 2026 survey puts numbers behind that strain. 81% of firms with electrician openings say they're having trouble filling them. And among firms that worked on data centers last year, 58% reported more competition for skilled labor, while 49% pointed to wage pressure.[5][7][20]

Superintendent hiring isn't any easier. About 75% of firms say this role is hard to fill, and commissioning managers with direct commissioning experience are still tough to find.[5] Here's what role-by-role demand looks like.

Role Typical Demand on Hyperscale Projects Shortage Indicator Hiring Impact
Electrician (Journeyman) Several hundred at peak on a single campus phase Very High - 81% of firms with electrician openings report difficulty filling them[5] Longer time-to-fill; multi-market recruiting
MEP Manager Multiple dedicated leads per building or phase High - hyperscale scope narrows the pool[14] Coordination risk across electrical and mechanical systems
Commissioning Manager At least one lead plus system leads for large campuses High - commissioning experience is hard to source[14] Longer lead time to secure commissioning teams
Controls Technician Dozens at peak for BMS, EMS, and PLC work High - shared demand from fabs, utilities, and industrial projects[14] Delays in testing and turnover milestones
QA/QC Leader Central manager plus discipline-specific inspectors High - mission-critical work requires experienced field oversight[14] Higher pressure on documentation and verification
Superintendent (MEP/General) Multiple area superintendents plus one or more general superintendents High - roughly 75% of firms report difficulty filling superintendent roles[5] Out-of-sequence work and schedule risk

Semiconductor fabs are dealing with much of the same pressure, but the hiring bar is even higher because of strict process demands and cleanroom work.

Semiconductor Fab Labor Gap and Trade Competition

CHIPS-funded fab construction is turning up the heat on the same labor pool used by data centers and utility work. Industry research projects a skilled-labor deficit of up to 157,000 workers by 2030 across engineering, technician, and trade roles.[21][22][2] At the same time, roughly 67,000 jobs could still go unfilled even if the workforce keeps growing.[24][23]

On the construction side, fabs need a deep bench across several trades:

  • Electricians for high-purity power and tool hookups
  • Pipefitters for ultra-pure water and process gas systems
  • HVAC and sheet metal crews for cleanroom air handling
  • Controls technicians for automation and monitoring[1][17][19]

Location makes the problem worse. Texas, California, Arizona, New York, and Ohio are expected to feel the most strain.[15][16][18] Those states also have major data center, grid, and power-generation work in motion, so electricians, mechanical trades, and controls technicians are getting pulled by several sectors at the same time.

The same labor crunch also spills into healthcare, life sciences, nuclear/SMR, and energy storage, where strict compliance rules make hiring even harder.

Sector Shortages: Healthcare, Life Sciences, Nuclear/SMR, and Energy Storage

Healthcare and Life Sciences: MEP-Heavy Builds and Compliance-Driven Staffing Gaps

The labor squeeze gets even tighter in regulated sectors, where teams don’t just need craft skill. They also need people who can work inside strict compliance and validation rules. That’s why healthcare and life sciences stay tight in 2026. These projects rely on dense MEP scopes, medical gas, cleanrooms, and commissioning work, and they draw from the same limited labor pool as data center construction and fabs.

Staffing them is tough for a simple reason: the work is denser, more regulated, and far less forgiving. Hospitals and life sciences facilities need redundant power, specialized HVAC for infection control, medical gas systems, and cleanroom-grade finishes for labs and biotech/pharma spaces. On top of that, employers need people who can tie those systems into hospital life-safety codes, accreditation rules, cGMP standards, and cleanroom validation protocols.

The hardest roles to fill include:

  • MEP coordinators
  • Superintendents
  • Project managers
  • Commissioning engineers
  • QA/QC managers
  • Medical gas installers
  • Cleanroom and process-piping specialists

And the staffing challenge doesn’t stop there. It gets tougher again in nuclear/SMR and battery storage, where licensed trades and commissioning staff are even harder to line up.

Nuclear/SMR and Energy Storage: Craft and Field Leadership Shortages

Nuclear/SMR projects face the highest staffing bar in this group because they need both scarce craft labor and strict quality control. The labor pool for nuclear/SMR construction is much smaller, with roughly 100,000 direct jobs today versus a build-out need far above that level.[25][28][32][34]

That leaves very little slack in the market. During active construction, skilled trades - electricians, pipefitters, ASME code welders, ironworkers, and millwrights - can make up 50% to 60% of the total project workforce.[26][27][32] SMR projects can peak at 1,500 to 2,000 construction workers, with QC staff accounting for about 10% of total project staff and QA staff about 1%.[30][31][33] In plain English, field leadership and quality roles aren’t side needs. They’re core staffing needs, and they have to be planned early.

Energy storage is running into a similar wall. It pulls from the same electrician and commissioning talent already stretched by data centers and fabs. Right now, the U.S. is short an estimated 50,000 to 80,000 electricians, with 80,000 openings per year projected and a possible deficit of 107,000 to 224,000 skilled workers by 2030.[35][36][38][39]

Utility-scale battery storage competes for the same licensed electricians and commissioning teams needed in grid and industrial work. Battery storage specialists and commissioning talent are scaling much more slowly than installed capacity, which creates a commissioning and operations bottleneck for utility-scale projects.[37][40] Retirements add even more pressure: utilities could lose 40% to 50% of employees in critical skilled trades - including electricians, pipefitters, welders, and instrumentation and controls technicians - over five years.[29]

Role-Level Bottlenecks and Next Steps for Employers

The Hardest-to-Fill Roles in 2026 Across Mission-Critical Sectors

These sector gaps tend to land on the same handful of jobs. And those jobs often decide whether a project moves smoothly or starts slipping.

Across mission-critical work, a few roles keep showing up as the main choke points. In construction, 83% of firms report trouble hiring superintendents, making them the most commonly cited hard-to-fill leadership role. 81% say the same about project managers and supervisors.[42][46] On the craft side, more than 60% of firms say every trade role they use is hard to fill. Plumbers, electricians, carpenters, and pipefitters/welders are each named by roughly 79% to 80% of firms.[42][44] Commissioning has its own labor crunch too: as of Jan. 1, 2025, the U.S. had only 1,232 active Certified Commissioning Authorities.[41]

Role Sectors Competing for Talent Evidence of Scarcity Typical Consequence of Vacancy
Superintendent All mission-critical sectors 83% of firms report difficulty hiring superintendents[42][46] Delayed mobilization and safety risk
Project Manager / Supervisor All mission-critical sectors 81% of firms report difficulty hiring project managers/supervisors[42] Cost overruns and coordination failures
Electrician Data centers, fabs, healthcare, energy storage, nuclear BLS projects about 79,900 openings per year on average, with 7.1% growth from 2021 to 2031[43] Slower installs, delayed commissioning, higher labor costs
Commissioning lead Data centers, fabs, healthcare, nuclear projects, energy storage Only 1,232 active Certified Commissioning Authorities in the U.S. as of Jan. 1, 2025[41] Handover delays and acceptance issues
MEP Coordinator / Manager Healthcare, life sciences, data centers, fabs Dense MEP scopes require a small pool of cross-trained talent RFI backlogs and rework
QA/QC Manager Nuclear/SMR, fabs, healthcare, life sciences Regulated projects need experienced quality staff, so the candidate pool is small Non-conformance issues and regulatory holds
Pipefitter / Welder Nuclear/SMR, life sciences, industrial Pipefitters and welders are cited by roughly 79% to 80% of firms as hard to fill[42][44] Work stoppages and higher labor costs

Start Building Your Hiring Plan Before Peak Mobilization

That means hiring sequence matters just as much as hiring volume.

The smart move is to line hiring up with project milestones and start before mobilization. Lock in field leadership and MEP management during preconstruction. Then bring electricians, commissioning talent, and quality staff into the pipeline before peak build, so they’re in place when commissioning and turnover start coming into view.

Pay is the other big lever. With the U.S. construction industry needing 349,000 net new workers in 2026 to stay in balance,[3][45] wage pressure is likely to stay strong for electricians, superintendents, commissioning staff, and other hard-to-fill roles. Offers should be checked against the local market, especially in areas where mission-critical demand is clustered.

If you're building a hiring plan for a 2026 mission-critical project, contact iRecruit.co to plan hiring by phase and role before peak mobilization tightens the market even more. If you're a construction professional open to mission-critical work, sign up as a candidate to connect with active projects across these sectors.

FAQs

Why is mission-critical construction hit harder than general construction?

Mission-critical construction gets hit harder because it relies on a highly specialized workforce that you can’t simply replace with workers from the general labor pool.

These projects call for deep experience with complex systems and strict commissioning standards. A small mistake can lead to major financial loss and serious operational trouble. On top of that, these jobs compete for a limited pool of certified professionals, including commissioning agents, MEP managers, and NQA-1-qualified personnel.

Which roles should employers hire first for 2026 projects?

To cut schedule risk in 2026, employers should fill key leadership and technical roles well before mobilization. Start with project managers, construction managers, and project executives.

At the same time, lock in P6 schedulers, commissioning managers, and MEP leads. These roles often slow things down early if they come in late. In specialized sectors like nuclear, it also makes sense to hire QA/QC leads and regulatory affairs specialists early.

Which sectors will face the worst labor shortages in 2026?

In 2026, the toughest labor shortages in mission-critical construction are expected in data centers, advanced manufacturing, especially semiconductor fabs, and energy infrastructure.

Data centers are under the most pressure. The projected worker gap could reach 499,000.

The problem gets worse because these sectors are all chasing the same small group of skilled people. The biggest pinch points include:

  • commissioning managers
  • MEP specialists
  • project managers
  • licensed electricians

Related Blog Posts

Keywords:
construction labor shortage, mission-critical construction, data center construction, semiconductor fabs, electricians, commissioning, MEP, superintendents
Free Download

Data Center Construction Labor Trends in 2026

Thank you! Your submission has been received!
Oops! Something went wrong while submitting the form.

More mission critical construction news

Data Center Superintendent vs Project Manager: Roles, Pay & Path
September 20, 2026

Data Center Superintendent vs Project Manager: Roles, Pay & Path

Superintendent runs the jobsite; project manager owns budgets, contracts, and procurement - choose the path that fits your strengths.
Data Center Manager Salary 2026: Critical Facilities Pay by Tier and Region
September 20, 2026

Data Center Manager Salary 2026: Critical Facilities Pay by Tier and Region

Benchmarks for 2026 data center manager pay by tier and U.S. region—base, bonus, equity, and negotiation levers like MW and team size.
Substation Technician Salary 2026: Utility and EPC Pay Bands
September 20, 2026

Substation Technician Salary 2026: Utility and EPC Pay Bands

Utility roles deliver steadier pay and benefits; EPC roles can pay significantly more through overtime, travel, and per diem.
Preconstruction Salaries 2026: Precon Manager and Scheduler Pay Bands
September 20, 2026

Preconstruction Salaries 2026: Precon Manager and Scheduler Pay Bands

2026 pay bands: Preconstruction Managers $85K–$165K; Schedulers $70K–$135K; adjust for location, experience, and mission-critical work.
