Hyperscale BIM/VDC Manager: Skills, Salary & Career Path

By:
Dallas Bond

If you want this role, here’s the short answer: you need to lead coordination, keep trade models aligned, support field install, and protect turnover dates on data center and advanced manufacturing jobs. In the U.S., pay often lands around $145,000–$195,000 for manager-level roles, with higher ranges in markets like Northern Virginia, Phoenix, and Dallas–Fort Worth.

I’d sum up the article like this:

  • The job: lead BIM/VDC work on hyperscale, mission-critical projects
  • What employers want: model control, clash resolution, 4D planning, CDE discipline, and trade leadership
  • Main tools: Revit, Navisworks, ACC/BIM 360, Revizto, and Synchro
  • Main difference from general commercial BIM: more MEP density, tighter schedules, more prefab, and more pressure around power-on and commissioning
  • Career path: Coordinator → Senior Coordinator/VDC Engineer → BIM/VDC Manager → Director/VP
  • Pay: manager roles often sit above general commercial ranges, with market premiums tied to hyperscale demand

A few numbers stand out. North American inventory in the four largest data center markets grew 33% year over year in Q1 2026. Northern Virginia reached 4,182.0 MW, and Dallas–Fort Worth hit 1,249.4 MW. That growth helps explain why employers pay more for people who can keep coordination clean and field work on schedule.

How to Advance Your BIM Career | Autodesk Construction Cloud

Autodesk Construction Cloud

Quick comparison

Topic Key takeaway
Role focus Keep models, trades, field work, and turnover in sync
Project type Data centers and advanced manufacturing
Top skills Federated models, clash management, 4D reviews, issue tracking, team leadership
Software Revit, Navisworks, ACC/BIM 360, Revizto, Synchro
U.S. manager pay $145,000–$195,000 in many mission-critical roles
High-pay markets Ashburn, Phoenix, Dallas–Fort Worth, Columbus, Atlanta, Reno
Promotion path Coordinator to manager, then program leadership

If I were reading this to plan my next move, I’d focus on one idea: software gets you in the door, but ownership of coordination and field results is what moves you up.

The Hyperscale BIM/VDC Manager Role In Mission-Critical Construction

A Hyperscale BIM/VDC Manager leads model-based delivery on data center and advanced manufacturing projects. The role keeps the model, trade teams, and field work lined up from coordination through turnover.

What 'Hyperscale' Means On Data Center And Advanced Manufacturing Projects

In construction, hyperscale means large, fast-track programs built as repeatable campus expansions or standard prototypes, not one-off buildings. Picture several matching data halls going up in sequence. Or a semiconductor fab where each utility system has to hit the same spec across multiple phases.

The market numbers show just how fast this space is moving. CBRE reported that North American inventory across the four largest data center markets grew 33% year-over-year in Q1 2026. Northern Virginia alone added 1,135.9 MW to reach 4,182.0 MW of wholesale inventory. Dallas-Fort Worth grew 43.7% year-over-year to 1,249.4 MW during the same period.[4]

That kind of scale changes the BIM workflow. It demands tighter coordination and less room for drift than a standard commercial project.

Core Responsibilities: BIM Coordination, Clash Detection, And Trade Leadership

The manager owns the BIM Execution Plan (BEP) and leads the coordination process. They maintain the federated model, which brings together architectural, structural, and MEP submodels that every trade uses. They also run clash detection, assign issues, and help clear conflicts before fabrication or installation. On hyperscale jobs, that rhythm is usually weekly, before work moves forward in the shop or in the field.[5]

A big part of the role is trade leadership. This person keeps mechanical, electrical, plumbing, fire protection, structural steel, and prefab partners working from the same playbook. And it’s not just about geometry. It’s about the build plan too.

That includes lining up trade priorities with:

  • Power-on milestones
  • Equipment setting dates
  • Turnover targets

The manager also connects design consultants, field leadership, QA/QC, and commissioning teams. The point is simple: model decisions have to support installation and closeout, not just design intent on a screen.

That’s where this role starts to split from general commercial BIM.

How This Role Differs From General Commercial BIM Positions

The differences are easiest to see side by side:

Feature General Commercial BIM Hyperscale BIM/VDC
Primary Focus Design coordination & documentation System reliability & MEP density
MEP Complexity Standard HVAC, plumbing High-density liquid cooling, medium-voltage power
LOD Requirement LOD 200–300 LOD 350–400 (ready for fabrication)
Schedule Pressure Standard milestones Aggressive, fast-track (12–18 months)
Turnover Goal As-built drawings Digital handover & commissioning data
Rework Risk Moderate financial impact High impact on uptime and commissioning

On a hyperscale facility, the model has to do more than help teams coordinate. It needs to support fabrication readiness, modularization, phased energization, and commissioning prerequisites at the same time. One clash that slips through can hold up power-on or delay commissioning. And that’s not a small issue when the owner has already tied that turnover date to live operations.

Those responsibilities connect directly to the tools covered next.

Core Skills Employers Hire For

Employers hire for three things: model control, field integration, and leadership. In practice, those show up in the day-to-day standards, workflows, and habits teams expect from a BIM/VDC lead.

BIM Coordination, Federated Models, And Clash Resolution

At the center of the role is federated model management. That means bringing together models from architecture, structure, MEP, fire protection, controls, and specialty systems into one coordinated environment.

That only works if the standards are tight from the start. Shared coordinates need to be locked early in the BEP. Folder structures should be organized by building, level, and discipline so teams aren’t wasting time hunting for the right files or, worse, using the wrong ones.

Model health checks matter more than a lot of teams admit. Weekly reviews for missing links, corrupt families, heavy warning counts, and bloated file sizes help stop minor issues before they snowball into coordination problems. Strong candidates usually don’t speak in general terms here. They can point to the file-size and warning-count limits they enforce, and they can explain what happens when teams go past them.

LOD control is another area where many coordinators stumble. On hyperscale work, LOD targets shift by phase. Coordination packages and fabrication packages need the right level of detail at the right time. If that progression slips, fabrication readiness slips with it. The same goes for phased energization and turnover. Put simply: if trades aren’t modeling to the needed level when it counts, the field pays for it later.

Clash detection in Navisworks or ACC Model Coordination also needs more than a weekly button push. Strong managers structure tests by discipline pair and by zone. They set tolerances based on actual installation limits, not guesswork. They also group clashes into usable issues instead of dumping raw clash totals on trade partners.

The metric that matters isn’t how many clashes the software found. It’s whether open issues are dropping week over week, and whether field RFIs tied to coordination are dropping too.

VDC Workflows, 4D Scheduling, And Field Integration

VDC is the point where the model stops being just a coordination tool and starts shaping field decisions.

With 4D scheduling, teams link model elements to CPM activities in tools like Synchro or Navisworks. That makes it much easier to test whether the planned sequence can actually work in the field. Can two trades work in the same gallery at the same time? Does the duct install window line up with cable tray delivery? Those questions are a lot easier to sort out in a 4D sequence review than in a meeting full of assumptions.

The table below shows how core VDC skills connect to the project outcomes employers care about most:

Core Skill Practical Application Primary Project Outcomes
Model-based scheduling (4D) Link major systems to CPM activities by pod or zone Fewer schedule conflicts, reduced trade stacking
Sequence reviews Weekly 4D reviews with supers and trades before field work begins Better install sequencing, fewer out-of-sequence installs
Logistics and laydown planning Use the model to define material routes, hoist paths, laydown zones, and access paths Reduced site congestion, fewer access delays
Quantity support Extract model-based quantities for long-lead equipment and bulk materials More accurate procurement, smoother install flow
Prefabrication coordination Coordinate spool drawings and rack/skid models with field tolerances and delivery sequences Higher prefab hit rate, less field cutting and retrofit
QA/QC and commissioning integration Tie inspection points and commissioning status to modeled systems and equipment Cleaner turnover, fewer punch items, faster start-up

Prefabrication coordination deserves extra focus. On hyperscale jobs, MEP racks, skids, and modular electrical rooms are often built off-site. That sounds great on paper, but only if the spool drawings and prefab models match field tolerances and delivery sequence. If they don’t, the prefab shows up and doesn’t fit. That kind of rework is exactly what these projects are trying to avoid.

These workflows depend on the software stack covered next.

Digital Delivery Leadership And Trade Collaboration

Technical skill gets someone in the room. Governance and accountability are what keep them effective once the work gets messy.

Employers keep coming back to the same three areas in performance reviews: BEP governance, CDE standards, and issue accountability. Those are the habits that separate strong performers from average ones.

The BEP should be treated like a living standard, not a file that gets written once and ignored. As trade partners join the project, it needs updates. Its rules on file naming, model exchange cadence, and LOD targets need to be enforced. And when standards slip, the BEP should be the basis for the accountability conversation.

The CDE also needs structure people can trust. That means clear folder layouts, clean permission settings, and review workflows that keep the field from working off an outdated model.

Weekly coordination meetings are where leadership is easiest to spot. The best managers run those meetings from the federated model and keep the discussion tied to constructability and access, not just clash totals. They bring superintendents and trade foremen into the room, not only detailers. And they show up with a concrete target, such as:

  • closing the clashes blocking steel release
  • finalizing sequence in a specific pod
  • resolving a routing conflict in the electrical room

Decisions should be documented in the CDE and linked to model views. Action items need owners and due dates. Otherwise, the meeting was just talk.

Mentoring coordinators and junior engineers is part of the role too, even if job postings don’t always say it out loud. The manager who can build a team that enforces standards on its own - without being pulled into every single meeting - is the one who can scale across a multi-phase campus program.

These workflows depend on the software stack covered next.

Tools And Platforms Used By Hyperscale BIM/VDC Managers

Hyperscale BIM/VDC managers lean on a tight group of platforms to keep fabrication, field work, and turnover moving in sync on fast-track, mission-critical projects. Each tool has a clear job. One handles model authoring, another pulls models together for coordination, another manages files and reviews, and another checks whether the planned sequence will work in the field.

Revit And Navisworks: Authoring, Federated Models, And Clash Detection

Revit

Revit is where discipline models are built. Navisworks pulls those models into a federated view for clash detection and constructability review.

On a hyperscale campus, that usually means separate Navisworks files for each building or zone, plus a campus-wide file for site utilities. That setup keeps coordination easier to manage when teams are dealing with a lot of moving parts at once.

Clash tests are usually set up by discipline pair, such as:

  • electrical bus ducts vs. cable trays
  • process piping vs. structure

Tolerances are adjusted to catch high-risk conflicts without flooding the team with noise. Issues are then grouped by system, zone, and responsible trade, so the reports lead to action instead of sitting in someone's inbox.

Once the models are coordinated, the focus shifts to version control and issue tracking.

ACC/BIM 360 And Revizto: CDE Control And Issue Tracking

BIM 360

Use ACC/BIM 360 as the CDE to manage versions, permissions, and review gates. It also gives field teams browser-based access to the model, which matters when people need the latest information on site without jumping through hoops.

Revizto is used for issue tracking across 2D sheets and 3D views. It's especially useful in repetitive spaces, where the same clash can show up again and again across multiple zones. On hyperscale jobs, Revizto's issue templates and cloning features help teams track problems across dozens of identical data hall rooms without creating a coordination backlog.

With model control handled, the next step is testing whether the planned sequence can be built the way the schedule says it can.

Synchro: 4D Sequencing And Schedule Communication

Synchro

Synchro links the coordinated model to the schedule so teams can test phasing, access, crane movement, and turnover sequencing before work starts. The BIM/VDC manager brings a Navisworks or IFC model into Synchro, lines up selection sets with WBS activity codes, and builds 4D sequences that show install order, trade overlap, and spatial conflicts.

On hyperscale data centers, those sequences are especially helpful when teams need to explain phased turnovers and equipment delivery to owners and operations teams. A schedule on its own can be hard to read. A 4D sequence makes the plan easier to see.

The table below shows where each platform fits in the stack:

Tool Primary Use Typical User Project Value
Revit Discipline model authoring Design engineers, trade modelers, detailers Coordinated models that drive coordination, quantities, and fabrication
Navisworks Federated models and clash detection BIM/VDC managers, coordination leads, trade leads Multi-trade clash resolution before fabrication or installation
ACC/BIM 360 CDE, document and model control BIM/VDC managers, project engineers, field teams Version control, permissions, and browser-based model access
Revizto Issue tracking across 2D and 3D BIM coordinators, trade leads, field engineers Model-based issues linked to drawings and field observations
Synchro 4D sequencing and schedule visualization BIM/VDC managers, planners, project executives Sequence validation to prevent bottlenecks on aggressive schedules

In hiring, employers usually treat Revit and Navisworks as baseline skills. ACC/BIM 360 is commonly expected on hyperscale programs, while Revizto or Synchro can stand out on teams that have made those platforms part of their standard workflow.

U.S. Salary Ranges And Career Path Into Leadership

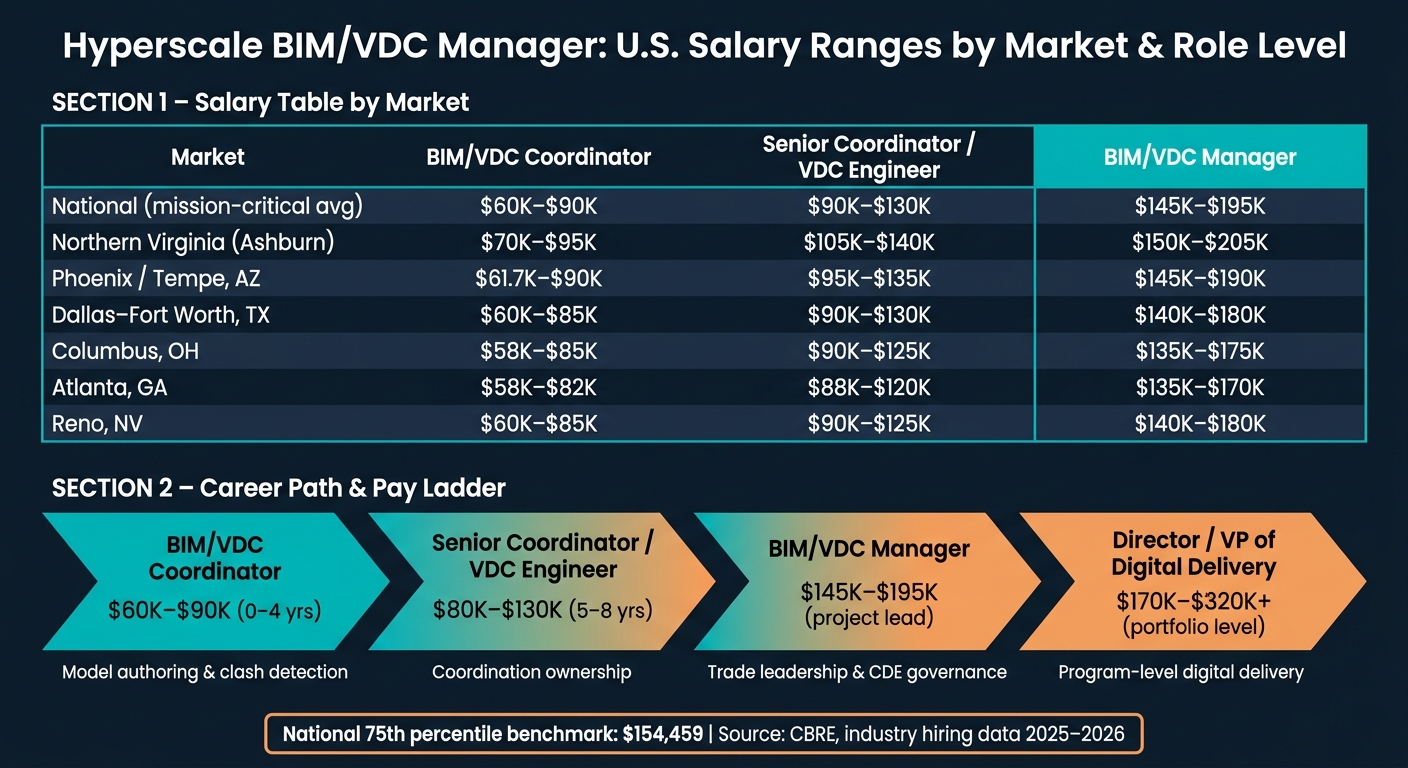

Hyperscale BIM/VDC Manager Salary by Market & Experience Level

Hyperscale BIM/VDC Manager Salary by Market & Experience Level

U.S. Salary Ranges By Experience Level

In hyperscale hiring, pay tends to follow scope of responsibility. The more a role owns coordination, schedule control, and trade leadership, the more it pays. On hyperscale and mission-critical projects, compensation runs well above general commercial construction at every level, and that gap gets bigger as seniority increases. Employers aren’t just paying for software skills. They’re paying for lower coordination risk, faster project delivery, and tighter trade alignment.

Entry-level BIM/VDC Coordinators with 0–4 years of experience usually earn $60,000–$90,000 base on mission-critical work, compared with about $55,000–$75,000 on general commercial projects.[3][10]

Senior BIM/VDC Coordinators with 5–8 years of experience usually earn $80,000–$110,000 base in mission-critical roles. On large data center and advanced manufacturing programs, that often moves up to $95,000–$120,000+.[8][10][3]

VDC Engineer roles generally land around $75,000–$115,000 across the U.S. Many data-center-focused postings go above $100,000 once the job includes model leadership or schedule integration.[12][13][14][16][15]

At the manager level, the gap becomes more obvious. BIM Managers in general commercial construction often earn about $110,000–$140,000, while mission-critical or data center BIM Managers more often fall in the $130,000–$165,000 range.[1] A VDC Manager leading a hyperscale project usually earns $145,000–$195,000, with senior roles reaching the top of that range or going higher when bonus, travel, or program scope is part of the package.[11][3]

Senior leadership roles like Director of Construction Technology or VP of Digital Delivery on portfolio-level programs can reach $170,000–$320,000+ in total compensation.[3] Contract and embedded program roles can pay $85–$170+ per hour or $18,000–$38,000+ per month on multi-site programs.[11][3]

What pushes pay higher? Project scale, mission criticality, travel, employer type, and program-level ownership all matter. Software fluency helps, but leadership scope is what drives the biggest premium. Strong working knowledge of Revit, Navisworks, ACC/BIM 360, Synchro, and Revizto, paired with proven data center delivery experience, often moves compensation above the national 75th percentile of $154,459.[2][8][9][6]


High-Demand Markets And What Drives Pay Premiums

Some markets simply pay more because the work is stacked up and senior talent is hard to find. Northern Virginia, Phoenix, Dallas–Fort Worth, Columbus, Atlanta, and Reno all command premiums because active hyperscale pipelines are competing for a limited pool of experienced people. In plain English: more projects, fewer proven leaders, higher pay.

Market BIM/VDC Coordinator Senior Coordinator / VDC Engineer BIM/VDC Manager (Project Lead)
National (mission-critical average) $60,000–$90,000 $90,000–$130,000 $145,000–$195,000
Northern Virginia (Ashburn) $70,000–$95,000 $105,000–$140,000 $150,000–$205,000
Phoenix / Tempe, AZ $61,700–$90,000 $95,000–$135,000 $145,000–$190,000
Dallas–Fort Worth, TX $60,000–$85,000 $90,000–$130,000 $140,000–$180,000
Columbus, OH $58,000–$85,000 $90,000–$125,000 $135,000–$175,000
Atlanta, GA $58,000–$82,000 $88,000–$120,000 $135,000–$170,000
Reno, NV $60,000–$85,000 $90,000–$125,000 $140,000–$180,000

Career Path: From Coordinator Or Engineer To BIM/VDC Manager

The promotion path usually follows the work itself. In most cases, it looks like this: BIM/VDC Coordinator → Senior Coordinator or VDC Engineer → BIM/VDC Manager → Director of Construction Technology or VP of Digital Delivery. Moving up depends on proving that you can own coordination, make model-based decisions, and lead across disciplines.

That next jump into VDC Manager is where many people get tested. It’s no longer enough to be good in the model. You need to lead across teams, coordinate multiple models, manage a CDE, and keep digital delivery milestones on track with very little room for rework.

Credential stacking can help make that move easier. A common path is to build from Revit first, then Navisworks, then add mission-critical credentials like CDCPM or Uptime ATS.[1][7]

Conclusion: What Matters Most For Hiring And Career Growth

A Hyperscale BIM/VDC Manager plays a central role on mission-critical projects. They keep design, coordination, field work, and digital delivery moving in the same direction across trades and systems. That broad role shapes what employers look for when they hire.

In practice, employers look for people who can lead coordination, solve clashes, run VDC workflows, and manage digital delivery with discipline. They also want proof that the person can use tools like Revit, Navisworks, ACC/BIM 360, Revizto, and Synchro in a way that helps the project team do better work. For candidates, that means one thing: show results, not just software knowledge.

The strongest candidates make their impact easy to see. That can mean:

  • Fewer field clashes
  • Faster issue closure
  • Cleaner handoffs
  • Better trade buy-in

On the employer side, the clearest hiring signal is ownership of the process. If a person can cut rework and help protect schedule reliability, that stands out fast. Those same patterns tend to shape who moves up, too.

Career growth tends to favor leaders who can own coordination, work across disciplines, and make model-based decisions that keep complex projects on track.

FAQs

Do I need data center experience first?

Not always. Hands-on experience matters, sure, but you can still get into this space if you have strong BIM/VDC skills and a clear plan for the shift. Employers want people who can work through complex MEP systems, high-density builds, and tight schedules without getting lost in the weeds.

If you're moving over from commercial construction, a coordination role on a data center project is often the best entry point. It gives you a close-up look at hyperscale delivery while helping you build the right experience on the job.

Which skill matters most for moving into management?

The biggest shift is moving from hands-on production work to leadership.

Yes, you still need strong skills in Revit and Navisworks. That part doesn’t go away. But once you step into management, the job gets bigger. You’re no longer just working inside the model. You’re owning scope, schedule, and team coordination.

That means thinking at the model level, running clash-detection meetings, making system-level calls, and linking digital models to what happens in the field. In plain terms: you’re the person helping turn a coordinated model into work that can actually be built.

A lot of success comes down to handling multi-trade schedules and keeping communication clear across trades, even when the pressure is on. That’s where the role changes most. It’s less about producing and more about leading people, timing, and decisions.

What results should I show on my resume?

Show measurable results, not just a list of tasks.

For each project, include:

  • Project type
  • MW capacity
  • Delivery model
  • Total value

Then tie that project info to clear outcomes. Good examples include clash resolution rate, critical issues tracked and closed, on-schedule spool releases, fewer RFIs, faster commissioning, and better labor productivity.

This matters because numbers tell the story fast. Saying you supported coordination is fine. Saying you helped drive 95%+ clash resolution before install or kept spool packages issuing on schedule hits much harder.

You should also show how the work got done. Briefly connect results to the tools and field workflows behind them, such as:

  • Software used for coordination, issue tracking, reality capture, and model control
  • Certifications that back up your BIM/VDC or trade knowledge
  • Field-first workflows that supported prefabrication, laser scanning, and a model-as-truth process

The goal is simple: make it easy for the reader to see the scale of the project, the way it was delivered, and the impact you had on cost, schedule, and field execution.

Related Blog Posts

Keywords:
hyperscale BIM, VDC manager, data center BIM, BIM salary, Revit Navisworks, 4D scheduling, prefabrication coordination, digital delivery
Free Download

Data Center Construction Labor Trends in 2026

Thank you! Your submission has been received!
Oops! Something went wrong while submitting the form.

More mission critical construction news

How Much Does It Cost to Build a Data Center in 2026?
August 10, 2026

How Much Does It Cost to Build a Data Center in 2026?

2026 U.S. data center cost guide: per‑MW estimates, major drivers (power, cooling, redundancy), lead times and retrofit risks.
Data Center Superintendent Jobs in Dallas: Pay & Path 2026
August 10, 2026

Data Center Superintendent Jobs in Dallas: Pay & Path 2026

2026 Dallas data center superintendent pay ranges, hiring paths, top skills, and market demand for MEP-led candidates.
Data Center Construction Timeline: Hiring at Every Phase
August 10, 2026

Data Center Construction Timeline: Hiring at Every Phase

Hire one phase early: align staffing to milestones to avoid long-lead delays, rework, and commissioning failures.
Electrical Testing Careers: NETA Levels, Pay & Data Centers
August 9, 2026

Electrical Testing Careers: NETA Levels, Pay & Data Centers

NETA levels determine testing scope, data-center roles, and pay, from Level I support to Level IV sign-off, with top earnings over $220K.
