If you can’t staff the field, you can’t hit the schedule. In 2026, data center GCs are short on superintendents, and that puts delivery at risk. The article’s main point is simple: outside hiring alone won’t solve it.
I’d sum up the playbook like this:
The pressure is already clear in the numbers:
For me, the takeaway is straightforward: GCs need to staff the program, not just the current job. That means filling today’s gap while training the next person at the same time.

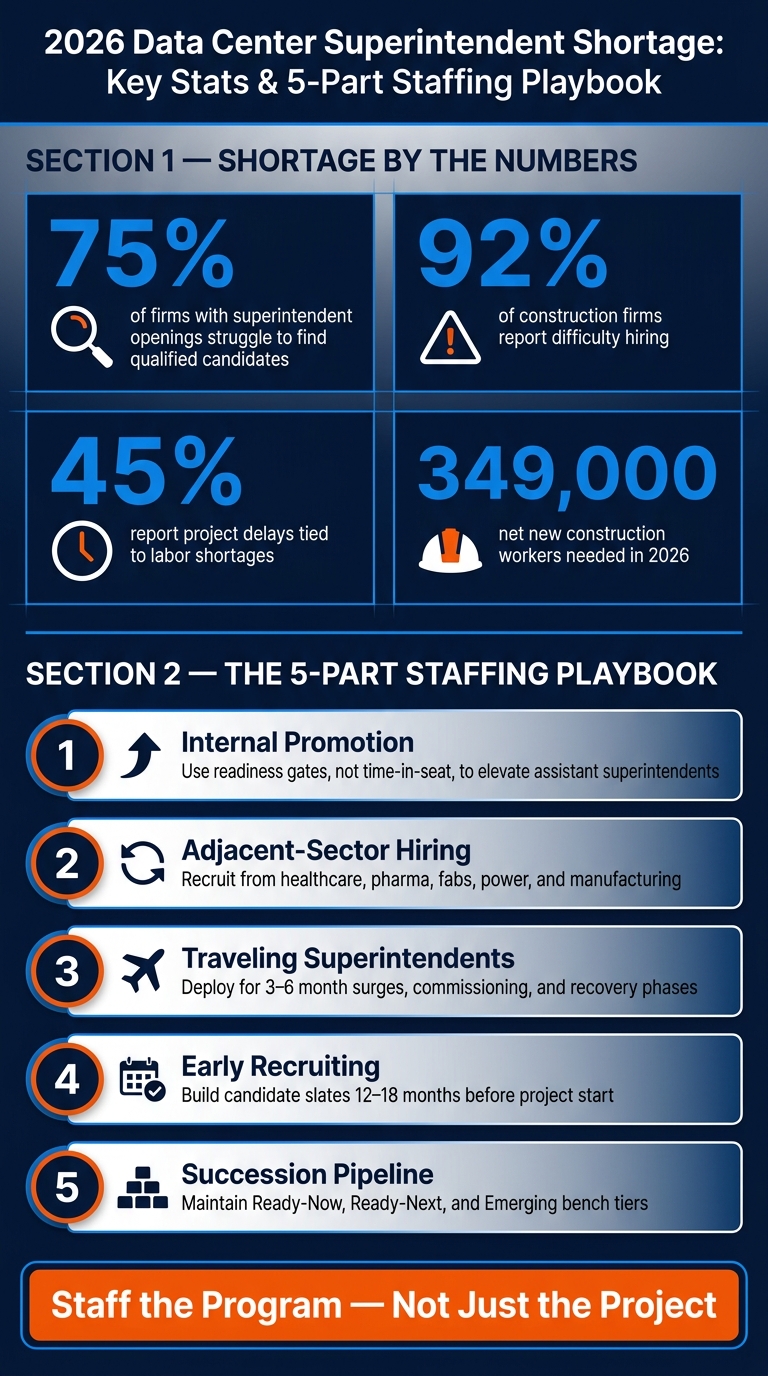

2026 Data Center Superintendent Shortage: Key Stats & 5-Part Staffing Playbook
So if I were reducing superintendent risk on a data center program, I’d use all five at once: promotion, sector conversion, traveler deployment, early recruiting, and bench planning.
Internal promotion is one of the fastest moves a GC can make, especially when outside hiring is slow and the market is tight. That matters now, with 92% of construction firms reporting difficulty finding qualified candidates and 45% reporting project delays related to workforce shortages [3][4]. When you promote a strong assistant superintendent, you solve an immediate opening and create room for the next assistant role at the same time.
There’s another upside: the person already knows your safety rules, reporting systems, project controls, and field culture. But that shortcut only pays off when promotion follows clear readiness gates instead of gut feel.
Readiness should come from key skills for data center construction managers, not time spent in the seat. Start with the outcomes that matter most - schedule, safety, quality, and coordination - then check each one against what the person has done in the field. If someone won’t stop unsafe work, they are not ready. Period.
This kind of scorecard keeps promotion grounded in job performance. It also makes the call easier to defend. Instead of saying, “They’ve been here long enough,” you can point to the work and say, “They already handle the parts of the job that matter most.”
Before you hand someone a full project, give them a defined piece of work to run. That could be an electrical room sequence, a mechanical yard, a data hall fit-out zone, or a site-utilities package. The scope needs to be big enough to test judgment, but contained enough that a senior superintendent can step in before small misses turn into major problems.
Think of this trial period as a promotion screen. It shows whether the person can manage MEP coordination, stay on top of commissioning follow-through, and get a scope ready for turnover without constant backup. If your internal bench still isn’t deep enough after that, the next step is to bring in leaders from nearby sectors.
A promotion does more than fill one hole. When an assistant superintendent moves up, that open role becomes the next training slot. A strong field engineer or junior assistant can step in, learn the job, and keep the line moving.
That’s how bench depth becomes a system instead of a one-off patch. Track each promotion and each backfill so you can see whether the pipeline is working - or where it starts to thin out.
When the internal assistant superintendent bench gets thin, the fastest move is often to hire from nearby sectors.
If internal promotions aren't enough, widen the search beyond people with data center titles on their résumés. Only about 15% of applicants for specialized data center roles meet minimum technical qualifications [1]. So if you hire only for exact data center experience, the bench stays thin and active project schedules take the hit.
Good adjacent talent often comes from:
The traits that make a superintendent strong on a data center construction job don't belong only to data centers. Plenty of adjacent-sector leaders already know how to run crews, manage risk, and keep work moving in high-stakes settings. In most cases, the missing piece is data center context, not field leadership.
That changes how you should screen candidates. Don't get stuck on industry labels. Focus on delivered scope.
Ask questions like:
Also look hard at shutdown planning, cleanroom work, and equipment hookup experience. Those signs often translate faster than a narrow data center title. And that helps keep schedule, quality, and commissioning on track.
Before you place an adjacent-sector hire on a live project, run a structured gap assessment.
Use an interview scorecard that checks MEP knowledge, schedule discipline, multi-trade coordination in active environments, and quality control. Pay close attention to high-voltage experience, liquid cooling awareness, and redundancy knowledge. Candidates with only standard HVAC and low-voltage experience - or thin electrical distribution experience - should be screened out.
After hiring, use a 30-60-90 day conversion model.
In the first 30 days, center the work on safety culture and NFPA 70E electrical safety training. By day 60, shift them into leading MEP coordination meetings and managing VDC/BIM clash resolution for a defined scope. By day 90, they should be ready to own a Level 4 or 5 commissioning sequence, close owner punch list items, and lead turnover documentation for a completed phase.
This is where pairing matters. Match them with a data center-experienced general superintendent who can spot weak points early - before they turn into jobsite problems.
Use the table below to match each background to the best first assignment.
Once adjacent-sector leaders are in the pipeline, GCs can use traveling superintendents and targeted recruiting to cover peak project demand.
Even with assistant promotions and cross-sector hires, active projects still need immediate field coverage. That’s where deployment, recruiting, and retention come in. Together, they help close active project gaps before schedules start slipping.
Use traveling superintendents as short-term reinforcement during commissioning and recovery phases. They’re a strong fit when a project needs help now. But local direct-hire leadership should still stay in place for full-project continuity, owner accountability, and safety culture.
This model only works when the planning is done up front. Budget for per diem, travel, and relocation support before deployment begins. Then match the assignment to the right project phase so you’re not forcing a short-term fix into a long-term leadership role.
Once short-term coverage is in place, the focus shifts to the next problem: making sure the pipeline doesn’t run dry before the next peak hits.
Recruit before demand spikes. Build the candidate slate before award or NTP so the bench is ready when the project moves.
iRecruit.co helps GCs move faster with pre-qualified superintendent candidates, recruiting, RPO, and workforce consulting. In a tight market, waiting until the need is urgent is a gamble. Recruiting early is the most dependable way to avoid schedule risk.
Short-term coverage handles the immediate gap. Retention helps keep the next one from opening up.
Keep direct-hire superintendents in place with stay bonuses, predictable rotations, travel support, and a clear path to lead larger phases. If people can see what’s next - and the day-to-day setup feels workable - they’re far more likely to stay through commissioning and turnover.
The table below links common shortage pressures to the retention responses that help reduce the damage.
Deployment, recruiting, and retention help you cover today's openings. Succession planning deals with the next wave. One fixes the gap in front of you. The other stops the next gap from showing up.
For GCs running fast-growth data center programs, every live project can double as a training ground. The real issue is simple: are you using it that way?
Set up the bench in three tiers based on what people have shown in the field, not their title or how long they've been around.
Each active project and each forecast project should have three names attached to it:
If even one of those spots is empty, the project has a weak point.
From there, the job is to test each tier through field assignments that show who is ready and who still needs work.
Development has to be tied to live work with actual stakes. Give people controlled ownership of a zone, package, or phase. Set clear decision limits. Add a senior reviewer. Start with a smaller scope, then widen it as performance improves.
The best assignments are the ones that make readiness hard to fake. That can include 3- or 6-week look-aheads, recovery plans, package ownership from procurement through turnover, subcontractor meetings, turnover-zone leadership, and owner-facing risk updates. Each assignment needs a deadline, a reviewer, and a plain pass/fail assessment tied to the GC's readiness criteria.
You also need a short list of numbers to tell you if the pipeline is getting better. Track percentage of projects with a named backup and successor, internal promotion rate for superintendent openings, time to fill vacancies, and percentage of upcoming awards that can be staffed from the current bench. The target is straightforward: fewer uncovered roles and shorter transition times.
The 2026 superintendent shortage is a delivery risk, and it will not fix itself. More than 60% of data center providers report difficulty finding qualified candidates [5], while AGC data shows that 75% of firms with superintendent openings struggle to fill them [2]. External hiring by itself can't close that gap as data center programs keep growing.
GCs that stay ahead of the shortage do five things at the same time: promote from within, convert adjacent-sector leaders, deploy travelers for peak demand, recruit early, and build a tiered succession pipeline. That mix helps keep data center programs staffed without giving up schedule, quality, safety, or client confidence.
An assistant superintendent is ready when they can handle mission-critical work based on what they’ve done, not the title on their resume.
What matters most is scope:
That’s the difference between someone who has simply been on a jobsite and someone who can step into work that has no room for drift.
There are also a few red flags worth taking seriously. Watch for people whose background is limited to standard HVAC or low-voltage work. Be careful with candidates who’ve mostly worked on jobs with flexible timelines. And if they haven’t shown sound judgment with owners or on active campuses, that gap can come back to bite you.
A simple, consistent competency scorecard helps cut through guesswork. It also helps when you check references, especially for escalation habits and judgment under pressure. Before any critical-path work starts, assign shadow responsibilities so you can see how the person operates in the field, not just how they interview.
The best superintendent candidates often come from nearby sectors that deal with similar technical demands, dense MEP systems, and fast-track schedules.
Strong talent pools include semiconductor fabrication, pharmaceutical manufacturing, and healthcare construction. Utility substation, life sciences, and industrial projects can also be good places to look. These fields demand tight sequencing, close coordination, and strict compliance in high-stakes settings.
Start recruiting superintendents 12 to 24 months before the project begins, or at least 3 to 6 months before the role becomes time-critical. Lead superintendents should be in place before major structural work starts.
If you wait until the need feels urgent, you’re already behind. Hiring can take months, and the field leadership market is tight. That delay can put the schedule at risk fast.
