From IT PM to Data Center PM: The Skills Gap Most Candidates Underestimate

By:
Dallas Bond

If I move from IT project management into data center project management, I’m not just changing industries. I’m changing from desk delivery to field construction.

That’s the main point.

The gap is usually not planning, budgets, or stakeholder updates. It’s the parts many IT PMs haven’t done before:

  • MEP coordination
  • field safety
  • commissioning
  • construction contracts
  • same-day site decisions
  • long-lead equipment planning
  • owner-side judgment on cost, risk, and redundancy

A few numbers make that clear:

  • Switchgear and transformers can take 8 to 24 months
  • Grid interconnection delays can stretch 8 to 10 years in some markets
  • Electrical systems can make up 45% to 70% of build cost
  • AI-ready data centers can cost more than $20 million per MW
  • 2N redundancy can cost 40% to 60% more than N+1
  • Time-to-fill for a data center construction manager can run 90 to 126 days

If I’m an IT PM, the plain answer is this: I should not expect to step straight into a lead data center PM role without field time. The safer path is to learn P6, Procore, OSHA 30, and L1–L5 commissioning basics, then spend 6 to 18 months in a bridge role such as assistant PM, project engineer, or owner’s rep coordinator. After that, I can start taking on more scope, such as OFCI gear, closeout, and commissioning readiness.

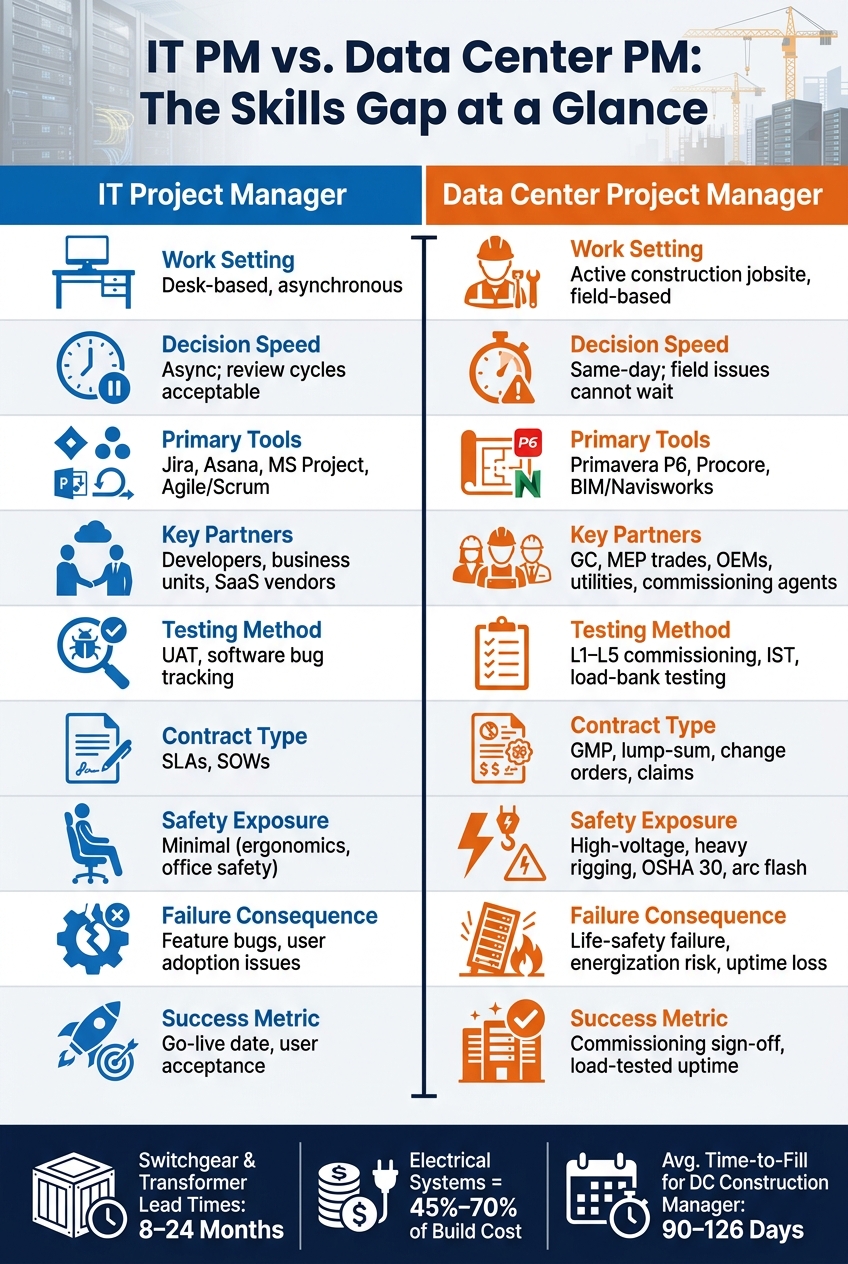

IT PM vs. Data Center PM: Skills Gap Comparison

IT PM vs. Data Center PM: Skills Gap Comparison

Quick comparison

Area IT PM Data Center PM
Work setting Desk-based Active jobsite
Main tools Jira, Asana, MS Project Primavera P6, Procore, BIM/Navisworks
Main risk Bugs, delays, adoption issues Life safety, energization, uptime loss
Main partners Dev teams, business users, SaaS vendors GCs, MEP trades, OEMs, utilities, commissioning agents
Testing UAT L1–L5 commissioning, IST, load-bank testing
Contract work SLAs, SOWs GMP, lump sum, change orders, claims
Success mark Go-live Commissioning sign-off and ready-for-service

My takeaway: this move can work, but only if I treat it as a build-up in field judgment, not as a title swap.

2. IT PM vs. Data Center PM: Role differences candidates underestimate

The gap usually isn’t raw ability. It’s construction time in the field, sound judgment on site, and comfort with contract risk. Someone who’s great at cloud migrations or ERP rollouts may still be a poor fit here, because this job runs by a different set of rules. You see that gap fast in how work gets sequenced, managed, and signed off on site.

Here’s the clearest side-by-side view:

Dimension IT Project Manager Data Center Project Manager
Decision Speed Asynchronous; review cycles acceptable Same-day; field issues cannot wait
Failure Consequence Feature bugs, user adoption issues Life-safety failure, energization risk, uptime loss
Stakeholders Developers, business units, SaaS vendors GC, MEP trades, OEMs, utilities, commissioning agents
Site Exposure Desk-based and asynchronous Field-based; active construction site
Tools Jira, Asana, Agile/Scrum frameworks Primavera P6, Procore, BIM/Navisworks
Safety Minimal (ergonomics, office safety) High-voltage work, heavy rigging, OSHA compliance, dust-control and cleanliness protocols
Success Metric Go-live date, user acceptance testing Commissioning sign-off and load-tested uptime

Office-based delivery versus field-based execution

A cloud migration or enterprise software rollout is mostly run from a desk. A data center build is different. The work happens on site, and site problems don’t wait for next week’s meeting. If a field issue shows up in the morning, the team may need an answer that day.

Procurement timing also hits harder here. Switchgear and transformers currently carry lead times of 8 to 24 months [2], so an early buying call can decide whether the project lands on schedule or drifts.

Vendor management versus contractor and OEM management

Most IT PMs manage software vendors through service-level expectations. In data center construction, the PM is dealing with electrical contractors, mechanical subcontractors, commissioning agents, and OEM equipment partners under contracts shaped by submittals, RFIs, long-lead items, change orders, and claims exposure. That’s a different world.

A missed submittal or late equipment delivery can stall commissioning. And once commissioning slips, the rest of the job can start to wobble.

That contract shift matters even more when the PM is tied to the owner’s long-term outcome, not just day-to-day delivery coordination.

Owner-side PM versus GC-side PM expectations

This is where many IT PMs get blindsided. On the owner side, the PM stands in for the client’s long-term performance interests and weighs design tradeoffs with that lens. On the GC side, the PM runs subcontractors and deals with change orders. The job changes from tracking tasks to making construction calls.

The biggest gap tends to show up in design tradeoffs and operational readiness. Take N+1 versus 2N redundancy. That isn’t just a design preference. A 2N redundant facility costs 40% to 60% more to build than an equivalent N+1 facility [4]. A data center PM is expected to understand that tradeoff, give clear advice on it, and defend that call through commissioning.

3. Where IT PMs fall short: the specific skills gap

These are the gaps that separate IT project coordination from mission-critical construction delivery. The work shifts from managing workstreams to managing construction risk. The biggest misses usually show up in MEP coordination, commissioning, site safety, and commercial control.

Skill Area Typical IT PM Exposure Data Center PM Requirement Transition Difficulty
Technical Scope Software, server racks, networking MEP (switchgear, UPS, chillers, direct-to-chip liquid cooling) High
Scheduling Agile sprints, software releases Integrated Master Schedule (Primavera P6), long-lead procurement High
Testing UAT, software bug tracking L1–L5 commissioning, integrated systems testing (IST), load-bank testing Very High
Contract Management SLAs, SOWs Guaranteed maximum price (GMP), lump-sum, lien waivers, retainage High
Safety/Risk Office ergonomics, data security OSHA, PPE, hazard recognition, arc flash Medium
Commercial Risk SaaS licensing, vendor SLAs Change orders, OFCI long-lead gear High

MEP literacy, construction sequencing, and commissioning

Electrical systems alone account for 45% to 70% of total data center construction costs [2]. That changes the job in a big way. If an IT PM hasn't worked around high-voltage distribution, switchgear, UPS, chillers, or field sequencing, daily coordination meetings can get rough fast. Miss one switchgear or chiller dependency, and you don't just push a task. You can stop commissioning altogether.

The commissioning process runs from Level 1 through Level 5, and each step depends on tight documentation discipline [3]. The point is simple: commissioning proves, under load, that the facility will work before turnover.

Now add AI infrastructure to the mix. AI-optimized facilities now cost more than $20 million per MW, and modern AI racks throw off 60 to 100 kW of heat, which requires direct-to-chip liquid cooling [2]. That's a much tougher mechanical setup than many IT PMs have dealt with. Walking into that setting without fluency in the systems is like trying to run an orchestra when you don't know the instruments. That's why technical fluency needs to come before field leadership.

Safety culture, schedule risk, and field decision making

Safety on a data center site is an operating standard, not a box to check. These projects demand strict OSHA compliance, PPE discipline, hazard recognition, and close attention to arc flash risk.

Schedule pressure also works differently here. Long-lead procurement and grid interconnection delays can run up to 8 to 10 years in some markets [2]. Because of that, the key schedule metric has shifted to Ready-for-Service (RFS), the date the facility is energized, commissioned, and handed to operations [2]. That date is not abstract. It moves when field decisions are late or wrong. An IT PM used to software delivery dates can miss how much one small call in the field can affect energization and readiness-for-service.

Commercial risk, change orders, and owner-rep judgment

Most IT PMs have never managed a guaranteed maximum price (GMP) or lump-sum contract. They also usually haven't had to decide whether a contractor's change order request is fair, avoidable, or just a claim dressed up as something else. At $10 million to $12 million per megawatt [5], that judgment matters fast.

Owner-furnished, contractor-installed equipment adds more moving parts. When the owner buys long-lead gear directly, the PM still has to line up delivery sequencing and installation across several parties. A late design change can turn into claim exposure in a hurry. The owner-rep PM is expected to spot that risk early, before it becomes a formal claim. These gaps can be taught, but not from a slide deck alone. People learn them in the field, with construction-specific tools and day-to-day exposure.

4. How to close the gap: a realistic transition plan

IT PMs shouldn’t jump straight into a lead data center PM role. The main gap is construction judgment: MEP coordination, commissioning, and field decision-making. That gap needs to be closed before someone takes full delivery responsibility. The path is pretty simple: learn the tools, get field exposure, then earn scope.

Learn the tools and standards used in construction delivery

Start with Primavera P6 and Procore. Jira and MS Project aren’t enough when the work shifts from office planning to field coordination. The point here is to close the scheduling and documentation gap.

It also helps to add:

  • OSHA 30
  • Uptime Tier concepts
  • L1–L5 commissioning basics

Get field exposure before pursuing a lead PM role

Tool fluency matters, but it won’t replace site judgment. The best bridge roles are assistant PM, project engineer, or owner's rep coordinator on live data center, healthcare, or semiconductor projects [6]. That’s where people close the sequencing and safety gap.

The exposure that matters most includes punch walks, startup support, commissioning readiness reviews, and real-time subcontractor issue tracking. These aren’t glamorous assignments. But they build the kind of situational awareness that no certification can match.

Build a 3- to 36-month development path

Each stage should close a clear gap. Tools cover scheduling and documentation. Field exposure covers sequencing and safety. Scope ownership builds commercial judgment.

Phase Duration Focus Areas
Foundational 3–6 months Primavera P6, Procore, OSHA 30, CDCPM training
Field Exposure 6–18 months Assistant PM or project engineer role, punch walks, MEP coordination, startup and IST support
Scope Ownership 18–36 months Managing OFCI gear, financial closeout

Credentials help, but usually only after someone has spent real time in the field. CDCPM is the most relevant bridge credential. PMP adds general rigor, and BCxP helps with commissioning credibility [3].

The 18- to 36-month phase is where people move from support work into scope ownership. Skip that step, and the risk tends to land in commissioning. The better question isn’t whether an IT PM can do the job. It’s whether that person has enough construction exposure to lead safely.

5. Hiring and fit assessment: how to evaluate transition risk

When you're hiring for this role, the title matters a lot less than one simple question: can this person run a live construction job without hand-holding?

That’s the test.

Once you know where the skills gap sits, the hiring decision comes down to field readiness. A job title by itself doesn’t prove much. What does matter is project history that shows field execution, MEP coordination, and commissioning depth. The best way to sort that out is with a structured screen that separates three different types of candidates: the pure IT PM, the bridge-role candidate, and the construction-ready data center PM.

A readiness checklist for candidates and hiring managers

The fastest way to screen someone is a commissioning walkthrough.

Ask the candidate to explain pre-functional testing, functional testing, and IST. Then have them map Level 1 through Level 5 commissioning. If they can’t do that, end the screen there [7][3].

After that, get specific. Ask about the MW capacity and redundancy topology on their last two projects. Ask what they did when a change order changed the power path. Ask how they handled a punchlist issue that put turnover at risk. If the answers stay vague, that’s a warning sign, especially when the candidate claims a senior title [7].

You should also check for:

  • OSHA 30
  • Direct experience managing sites with 200+ workers [7]

This scorecard helps sort bridge talent from people who are ready to run delivery:

Criteria IT PM Candidate Bridge-Role Candidate Construction-Ready DC PM
Commissioning Depth Not applicable Familiar with L1–L3; can describe pre-functional steps [7] Maps L1–L5; leads functional testing and IST sign-off [7][3]
MEP Literacy Cannot read one-lines; tracks tasks only [1] Reads basic one-lines; understands redundancy concepts [7] Reads one-lines; manages BMS sequencing and power-path changes [7]
Commercial Judgment No change-order exposure [1] Understands change orders; limited delivery decision-making Evaluates change orders that alter power path; manages OFCI delivery risk [7]
Field Presence No active construction site time [1] Occasional site visits; some punch walk experience [7] Daily trade coordination; leads commissioning readiness reviews [7]

Candidates from healthcare, semiconductor, or industrial construction tend to be the strongest bridge-role fits because they already know how regulated jobs work and how redundancy logic shows up in the field [6]. A pure IT PM, by contrast, usually needs a bridge role or direct field time before taking full delivery ownership [1][7].

How iRecruit.co can help reduce transition risk

iRecruit.co

The average time-to-fill for a data center construction manager is 90 to 126 days [7]. That’s a long time to get the hire wrong.

iRecruit.co lowers that risk by matching a candidate’s project history against mission-critical construction needs, including MW ratings, Tier levels, commissioning depth, and MEP scope, instead of just accepting “data center” as a search term. That matters because if a candidate can’t talk clearly about MW capacity or redundancy topology, there’s a good chance the resume is overstated [7].

For employers, iRecruit.co helps show whether someone is ready for a full PM role or should step into a bridge role first, then shapes the search around that. For candidates, the same process makes the gaps plain before those gaps show up on a live project.

FAQs

Can an IT PM skip the bridge role?

Yes - if they have equivalent experience in complex, high-stakes environments.

The title matters less than the work behind it. What counts is whether they can prove they’ve handled systems-level complexity, power and cooling interfaces, strict commissioning, and the financial, safety, and technical risks that come with mission-critical infrastructure.

Which data center PM skills are hardest to learn on the job?

The hardest skills to pick up on the job are usually the ones tied to mission-critical systems and specialized delivery sequences. Why? Because they call for deep technical judgment, not just broad project management know-how.

The biggest gaps tend to show up in commissioning - including Level 1–5 testing and Integrated Systems Testing - along with complex MEP coordination, understanding electrical distribution topologies, and sequencing long-lead equipment procurement.

These aren’t minor details. A mistake in any of these areas can lead to delays, startup issues, or even operational failure.

How do I know if I’m ready for a lead data center PM role?

You’re ready when you can move past basic task tracking and take charge of mission-critical facility delivery with program-level oversight.

A few clear signs:

  • You’re managing MEP-heavy projects over $50 million
  • You understand commissioning and documentation standards
  • You use Primavera P6 and Procore well
  • You can handle owner-rep decisions, change orders, construction sequencing, procurement, and safety culture under tight deadlines

Related Blog Posts

Keywords:
data center project manager, IT project manager transition, commissioning, MEP coordination, construction project management, Primavera P6, Procore, OSHA 30
Free Download

Data Center Construction Labor Trends in 2026

Thank you! Your submission has been received!
Oops! Something went wrong while submitting the form.

More mission critical construction news

Commissioning, Not Construction: Where Data Center Project Managers Get Stuck
June 20, 2026

Commissioning, Not Construction: Where Data Center Project Managers Get Stuck

Why data center projects stall after install: broken handoffs, out-of-sequence startups, open defects — readiness gates stop delays.
The Hidden Cost of Switching Construction Project Managers Mid-Build
June 20, 2026

The Hidden Cost of Switching Construction Project Managers Mid-Build

Mid-build PM changes cause schedule slips, 5–10% cost overruns and lost owner confidence; fast handoffs, backups and better hiring cut risk.
Why Senior Construction Project Managers Walk Away From Underscoped Projects
June 20, 2026

Why Senior Construction Project Managers Walk Away From Underscoped Projects

Senior PMs reject projects with unmanaged scope risk—blurry budgets, weak procurement, and thin teams that lead to rework and margin loss.
How Data Center Project Managers Coordinate Across IT, Facilities, and Construction
June 20, 2026

How Data Center Project Managers Coordinate Across IT, Facilities, and Construction

PMs align IT, facilities, and construction with RACI, BIM, integrated schedules, commissioning, and change control for reliable turnover.
