September 26, 2026

Owner-Side Data Center Construction Jobs: What Hyperscalers Pay 2026

Updated
By:
Dallas Bond

If you want the short answer: owner-side hyperscaler pay in 2026 is driven more by scope than by title. In this market, single-site roles often land around $120,000–$180,000 base, while multi-site, senior, or special-project roles can move into the $190,000–$311,000+ range before bonus and stock.

Looking for your next project? Register with iRecruit — one profile, matched to mission-critical builds nationwide.

I’d read the article this way: don’t compare titles first; compare control, site count, travel, and package structure. A Construction Manager, Project Manager, Program Manager, Project Controls lead, Cost/Commercial lead, or Commissioning Manager can all look close on paper but pay very differently once you factor in location, level, campus size, travel load, bonus, RSUs, sign-on, housing, and per diem.

Here’s the core takeaway in plain English:

  • Amazon shows many owner-side construction and project roles around $111,300–$186,100, with senior and management roles moving up to $254,500 base.
  • Google runs higher at the top end, with Program Manager roles around $147,000–$216,000 and Senior Program Manager, Special Projects at $221,000–$311,000 base.
  • Meta sits strong in site and lease delivery, with many construction roles around $150,000–$209,000, and broader project-development or area roles at $178,000–$245,000.
  • Microsoft shows very wide posted bands, including $127,600–$253,300 for a data center construction role and up to $303,600 in higher-cost markets for senior construction project management levels.
  • Across role families, PMs, CMs, program leads, controls, cost, commercial, commissioning, and field roles each sit in different pay lanes.
  • Travel support matters. A field-heavy offer with paid housing, flights, rotation, and $125–$200 per diem can beat a higher base salary with weak travel terms.
  • Total compensation matters more than base pay alone. A lower salary can still come out ahead if the bonus target, RSUs, sign-on, and travel package are stronger.

If I were using this as a benchmark, I’d focus on these questions first:

  • How many buildings, campuses, or markets does the role cover?
  • Who owns schedule, cost, commissioning, and turnover?
  • How much travel is required: 10%, 50%, or 75%+?
  • Is the role tied to one site, a lease program, or a national portfolio?
  • What is the full package: base, bonus, equity, sign-on, relocation, per diem, and lodging?

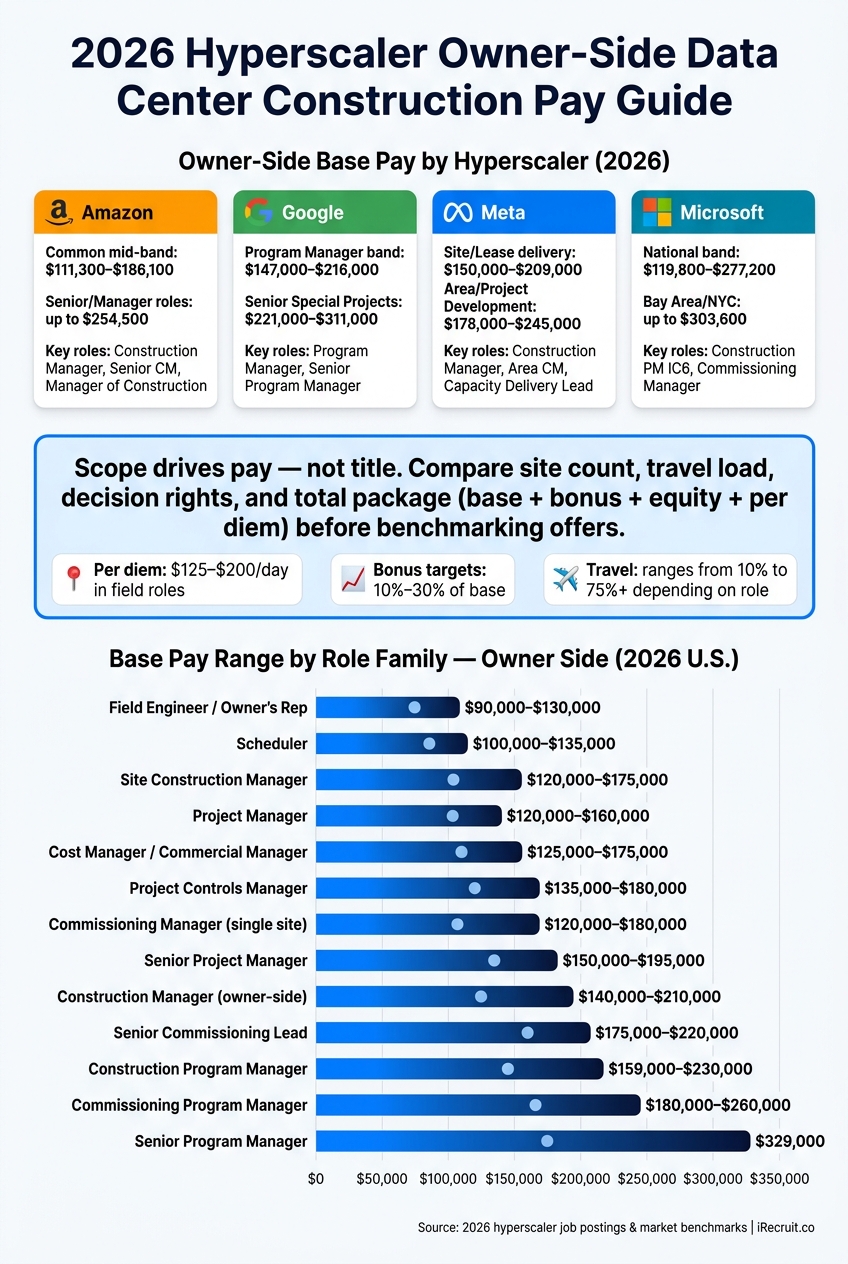

2026 Hyperscaler Owner-Side Data Center Jobs: Pay by Role & Company

2026 Hyperscaler Owner-Side Data Center Jobs: Pay by Role & Company

Quick Comparison

Company Common owner-side role focus Posted base pay snapshot
Amazon Construction delivery, project delivery, controls $111,300–$186,100 common mid-band; senior/manager roles up to $254,500
Google Program-led delivery and special projects $147,000–$216,000 PM band; senior special-project roles $221,000–$311,000
Meta Site delivery, lease delivery, project development Many roles at $150,000–$209,000; broader roles $178,000–$245,000
Microsoft Construction and commissioning lanes Roughly $119,800–$277,200 nationally; up to $303,600 in Bay Area/NYC bands

So the article’s main message is simple: benchmark by responsibility and full offer value, not by title alone. If you’re hiring, changing jobs, or checking an offer in a market like Northern Virginia, Texas, Arizona, Ohio, or Georgia, this is the lens I’d use before I compare one hyperscaler against another.

Hiring for a mission-critical build? Get a pre-qualified shortlist.

iRecruit.co specializes in construction recruiting for data center, energy, and advanced-manufacturing projects — project managers, MEP coordinators, commissioning leads, and more. We pre-screen every candidate so only qualified professionals reach your hiring team.

Get Started

Success-based pricing · 90-day replacement credit · No upfront fee on single roles

1. Amazon owner-side data center construction and delivery roles

Amazon gives a solid starting point for looking at owner-side data center construction pay in 2026. On the owner side, construction pay generally falls into four role families: Construction Manager, Senior Construction Manager, Manager of Construction, and Data Center Project Manager / Critical Project Implementation. As titles move up, so does scope. A Construction Manager may focus on one site, while a Manager of Construction can oversee multiple managers and several projects at once.[1][10][3][2]

Base pay

Amazon lists base salary bands by title, location, and role scope. In 2026 job postings, Construction Manager, Data Center Construction roles often show $111,300–$186,100, though another posted band reaches $98,700–$210,800.[1][15][17] Senior Construction Manager postings range from $125,400–$239,300, with one example in Shreveport, LA.[10][5] Manager of Construction roles go up to $153,200–$254,500 in markets such as New Carlisle, IN.[2][8] Data Center Project Manager, Critical Project Implementation roles have been posted at $111,300–$186,100 in Sterling, VA, while a US-West Critical Projects Implementation posting shows $110,400–$191,200 in Santa Clara, CA.[3][12]

Role Posted U.S. Base Range Example Location
Construction Manager, Data Center Construction $111,300–$186,100 New Carlisle, IN
Senior Construction Manager $125,400–$239,300 Shreveport, LA
Manager of Construction $153,200–$254,500 New Carlisle, IN
Data Center Project Manager, Critical Project Implementation $111,300–$186,100 Sterling, VA
Data Center Project Manager, US-West Critical Projects Implementation $110,400–$191,200 Santa Clara, CA

The posted ceiling can grab attention, but it doesn't tell the whole story. The smarter move is to compare the full offer. Base salary is just one part of it. Sign-on pay, RSUs, and travel terms can change the deal in a big way.

Bonus and equity

Amazon postings also include sign-on pay and RSUs.[11][7] That means base salary alone can be a little misleading. When comparing offers, look at first-year cash, RSU vesting schedule, and any repayment terms tied to the sign-on.

Geography and travel

Location still shapes pay, and travel can change both the cost and the day-to-day feel of the job. Amazon postings show Construction Manager roles with about 25%–50% travel or 50%+ travel, while some Senior Construction Manager roles call for 50%–75% travel.[14][16][18][13] That difference matters. A role with heavy travel may look similar on paper, but the lived experience can be very different.

Before using an offer as a benchmark, candidates should check a few plain-English details:

  • Whether relocation support is included
  • How travel reimbursement works
  • Whether per diem is provided
  • Whether the role is tied to one project or a larger portfolio

Google's roles show how these pay bands move when scope expands across programs, regions, and delivery models.

2. Google owner-side data center construction and delivery roles

Google’s owner-side delivery team revolves around Program Manager and Senior Program Manager roles, along with related jobs in technical delivery, project management, and cost control. These roles sit close to the center of hyperscale data center work: planning, governance, procurement, schedule, cost, commissioning, and turnover all run through them.

Base pay

Google’s posted U.S. base salary ranges show a pretty wide spread depending on level. A Program Manager, Data Center Construction posting shows $147,000–$216,000.[22] A Senior Program Manager, Data Center Construction, Special Projects posting shows $221,000–$311,000, with listed locations including Austin, Texas; Reno, Nevada; Red Oak, Texas; and Midlothian, Texas.[21][6] In both cases, the figures shown are base pay only.

Role Posted U.S. Base Range Midpoint
Program Manager, Data Center Construction $147,000–$216,000[22] $181,500
Senior Program Manager, Data Center Construction, Special Projects $221,000–$311,000[21][6] $266,000

That difference gets much larger once bonus and equity enter the picture. The senior midpoint is 47% higher, which lines up with the broader scope of the role and the added accountability tied to special projects.[21][22]

Bonus and equity

Google doesn’t publish a fixed bonus rate for these roles. Across Google job postings more broadly, target bonuses appear in the 15% to 25% range, while equity varies by role and level.[12][20][23][24] That means equity needs its own conversation. The postings do not spell out a standard grant value, vesting schedule, or refresh-grant policy.[19]

Geography and travel

Google says pay depends on the role, level, location, and the person’s experience.[21][22] That matters here because the senior special-projects role covers more than one market, so the posted range should be read as location-specific, not one flat number across every site.

The postings also do not mention a travel stipend or per diem.[12] That’s worth pressing on during interviews. Good questions include:

  • How is travel reimbursed?
  • Do long site assignments come with relocation support?
  • How much of the job is spent on active construction sites versus remote or office-based work?

Meta’s pay structure shifts again with lease-delivery and portfolio scope.

3. Meta owner-side data center construction and delivery roles

Where Google puts more weight on program leadership, Meta tilts toward on-the-ground site delivery and multi-site execution. Its owner-side construction team sits within the data center design, engineering, and construction (DEC) group and covers site mobilization, contractor management, commissioning, and operational readiness.[29] As you'd expect, pay moves up as the role shifts from running one site to handling a broader delivery portfolio.

Base pay

Meta's owner-side compensation falls into two main buckets: site and lease delivery roles, and broader area or project-development roles.

Site and lease delivery Construction Manager jobs show base pay of $150,000–$209,000.[25][29] Broader roles like Area Construction Manager and Construction Manager, Data Center Project Development show $178,000–$245,000.[27] That works out to about a $32,000 midpoint gap, tied to added scope and decision-making authority. A Capacity Delivery Lead, Data Center Infrastructure role lands at $151,000–$210,000.[30]

Role Location example Posted base range Midpoint
Construction Manager, Lease – Data Center Construction Menlo Park, CA $150,000–$209,000[25][29] ~$179,500
Construction Manager, Data Center DEC Kuna, Idaho $144,000–$201,000[26][28] ~$172,500
Construction Manager, Data Center Project Development El Paso, TX $178,000–$245,000[27] ~$211,500
Area Construction Manager, Data Center U.S. listing $178,000–$245,000[27] ~$211,500
Capacity Delivery Lead, Data Center Infrastructure U.S. listing $151,000–$210,000[30] ~$180,500

Bonus and equity

Meta's job postings show base salary only. So if you're comparing offers, don't stop at the salary band.

Ask the recruiter about:

  • target annual bonus
  • initial and refresh equity grants
  • vesting schedule
  • sign-on terms
  • relocation support

Geography and travel

The Kuna, Idaho role posted at $144,000–$201,000, which is about 4% below the comparable national band at both ends.[26][28] It also includes about 10% travel to Meta headquarters and other sites, plus emergency response duties.[26][28]

The El Paso project-development role posted at $178,000–$245,000.[27] That gap shows why title alone doesn't tell the whole story. Scope, travel, and site demands can shift the picture fast.

Before you compare two Meta offers side by side, confirm the level, role scope, location, and travel cadence. Travel demands and emergency-response coverage should line up with a candidate's availability and the number of sites they may need to support.

Microsoft shows a similar split between site execution roles and broader delivery ownership, but with different title families and pay bands.

4. Microsoft owner-side data center construction and delivery roles

Microsoft splits owner-side delivery into two lanes: construction and commissioning. Construction Managers run the build. Commissioning Managers handle testing, startup, and handoff to operations. The company also uses different job families and career levels across these roles, which can make title-to-title comparisons a little messy. That’s why benchmarking should lean on scope and responsibility, not just the name on the posting. These two lanes line up with the project manager, construction manager, and commissioning roles covered in the next sections.

Base pay

Microsoft’s clearest senior owner-side benchmark is Construction Project Management IC6, with a national base-pay range of $130,900–$277,200 and a Bay Area/NYC range of $165,600–$303,600.[31][34] A Microsoft Data Center Operations Construction Manager posting in Ashburn, Virginia, shows $127,600–$253,300 per year.[33]

On the commissioning side, Microsoft Commissioning Manager postings show a U.S. base-pay range of about $119,800–$258,000. A related Reliability Engineering IC4 commissioning posting lists $119,800–$234,700 nationally and $160,200–$261,000 in the Bay Area and NYC.[32][35] Put simply, these bands fit senior project leadership, site delivery, and commissioning scope.

Microsoft benchmark U.S. base salary Bay Area / NYC base salary
Construction Project Management IC6[31][34] $130,900–$277,200 $165,600–$303,600
Data Center Operations Construction Manager (Ashburn example)[33] $127,600–$253,300 N/A
Commissioning Manager / related commissioning posting[32][35] $119,800–$258,000 $160,200–$261,000

Bonus and equity

These postings do not list role-specific bonus or equity amounts.[36] That missing piece matters. At senior levels, base salary is only part of the story.

Before you compare a Microsoft offer with one from another hyperscaler, ask the recruiter for:

  • annual cash incentive target
  • initial stock award value
  • vesting schedule
  • expected refresh grants
  • sign-on terms
  • relocation support

Those items can shift total compensation by a lot.

Geography and travel

Location has a big effect on Microsoft pay. The Bay Area and NYC range is higher than the national band, so the posting’s main work location matters just as much as the title.[31][34] A national range does not automatically carry over to a high-cost market. The range that counts is the one tied to the primary work location listed in the offer letter.

Travel and site presence add another variable. A role tied to one campus is not the same as one covering a regional portfolio or a large AI build. Microsoft’s large programs can call for heavy on-site staffing, including the Fairwater AI facility in Wisconsin.[9] It’s worth pinning down the travel rhythm, lodging, per diem, and temporary housing terms early, because those details can change how an offer looks day to day.

5. Data Center Project Manager / Senior Project Manager

When you benchmark owner-side PMs, focus on scope, not job title. A PM handling one building, one phase, or one workstream will usually be paid differently from someone running several packages or a full campus program.

For a PM covering a single building, phase, or workstream, pay usually lands around $120,000–$160,000 base, with total cash near $140,000–$190,000.[39] Put simply: scope drives pay more than title inside these ranges.

For 2026, it helps to use two tiers. A Project Manager who owns one building, one phase, or one workstream usually falls in the $120,000–$160,000 base range.[39] A Senior Project Manager with end-to-end delivery responsibility for a major hyperscale facility, several delivery packages, or a campus program lines up closer to $155,000–$195,000 base. Some specialized senior roles go as high as $190,000–$230,000 base.[39][37] Once a PM starts covering multiple buildings or markets, compensation starts to look more like program pay than project pay.

Bonus and equity

A solid planning assumption is an annual bonus worth 10%–20% of base salary, depending on the company, level, and performance.[12] On a $150,000 base, a 15% target bonus adds $22,500, which brings target cash to $172,500 before equity. A senior PM at $185,000 base with a 20% target bonus gets to $222,000 in target cash before equity.[12][38]

Equity can widen the gap in a big way, but it should be modeled on its own rather than folded into cash comp.

Benchmark scenario Base salary Target bonus Cash comp (pre-equity)
Mid-level owner-side PM[38] $145,000 15% ($21,750) $166,750
Senior PM[38] $185,000 20% ($37,000) $222,000
Specialized senior posting[37] $190,000–$230,000 Varies Varies

Geography and travel

Higher-cost markets tend to push pay toward the top of each band. The same goes for roles that require frequent travel or long stretches on-site. In many high-travel PM jobs, part of the tradeoff is that base pay may be balanced against company-paid lodging, airfare, and set rotation terms.

Before you compare offers, lock down the basics:

  • Travel percentage
  • Housing terms
  • Rotation schedule
  • What the company covers on flights and lodging[37]

Next, compare these PM bands with construction manager pay, where site execution and lease-delivery scope shift compensation again.

6. Construction Manager / Lease Construction Manager

Compared with project managers, construction managers tend to be more focused on what happens on-site. The job is narrower in scope, but the day-to-day load is often heavier. On the owner side, CMs run the delivery process for the owner. That means managing schedule, cost, quality, safety, and changes without directly overseeing every trade.

Lease CMs carry even more coordination work. They often have to line up landlords, developers, utilities, and internal teams at the same time. That extra layer is a big reason lease CM pay often comes in above pay for a single-site construction manager.

In 2026, experienced owner-side CMs usually land in the $120,000–$180,000 range. Senior roles, or roles tied to more complex builds, often come in at $180,000–$210,000+. The table below shows the supporting hyperscaler examples.

Bonus and equity

Meta postings leave out bonus, equity, and benefits from the base figure. So a $170,000 base with a 15% target bonus works out to $195,500 in target cash before equity.[4][40]

At publicly traded hyperscalers, equity usually comes as restricted stock units on a multi-year vesting schedule. That means the grant's total value, refresh policy, and vesting terms can matter just as much as the top-line number.

Scope and seniority

Pay tends to move up with scope. Roles tied to one building usually sit around $120,000–$165,000. Senior roles with multiple contractors or phased turnover usually sit around $150,000–$200,000.

The people most likely to land at the top of the range can usually point to completed hyperscale facilities, medium-voltage and utility coordination, integrated systems testing, and landlord handover work.

Geography and travel

For travel-heavy roles, check the support details closely. A lower base can still win if the package covers the road well.

Look at items like:

  • per diem
  • lodging or temporary housing
  • vehicle allowance
  • how weekend time or travel time is paid

A role with a lower stated base but full travel coverage and a solid bonus target can beat a higher-headline offer with very little support.

Role tier Base salary range Additional compensation
Lease Construction Manager $123,000–$176,000 Bonus, equity, benefits (Meta posting)[40]
Construction Manager, Lease – Data Center $150,000–$209,000 Bonus, equity, benefits (Meta posting)[4]
Amazon CM, Data Center Construction $111,300–$186,100 Not specified in posting[1][7][11]

As scope shifts from site delivery to portfolio oversight, pay starts to move into program manager territory.

7. Construction Program Manager / Senior Program Manager

Once the job moves beyond a single project and into portfolio oversight, pay starts to look a lot more like program-manager pay. Construction Program Managers usually handle several projects at once, or one major delivery workstream. That means lining up design, procurement, construction, commissioning, budget, schedule, and contractors so the whole machine keeps moving.

Senior roles sit a level above that. They often run larger portfolios, oversee multiple PMs, and bring more consistency to delivery across different markets.

In 2026, base pay for a Construction Program Manager usually falls between $159,000 and $230,000, while Senior Construction Program Manager roles tend to land between $189,000 and $329,000, depending on scope and location.[12][45] Google examples show the spread pretty clearly: a Senior Program Manager, Data Center Construction role lists $174,000 to $258,000[46], while a Special Projects role reaches $221,000 to $311,000.[6][21]

Bonus and equity

Base salary is just the starting point. A big part of the total offer often comes from bonus and equity.

Bonus targets commonly sit in the 15% to 30% of base salary range. Employer examples include 15% for a Construction Program Manager, 20% for a Senior Program Manager, and 25% for a specialized Senior Program Manager role.[12] Equity usually comes as RSUs that vest over several years, so the number that matters most is the annual vesting value, not just the headline grant amount.[12][45]

Scope, seniority, and travel

Scope changes the math fast. Roles tied to one or two facilities usually benchmark around $159,000 to $210,000 base.[12][41] Once the role covers multiple campuses or a national portfolio, base pay often moves into the $190,000 to $225,000+ range. Special-projects roles can go as high as $300,000 to $329,000.[12][6][21]

Travel can shift a role’s value almost as much as title does. Some jobs call for only 10% to 15% travel, while others stretch to 75% nationwide. That’s a big lifestyle difference, so it makes sense to weigh travel load against base pay, not just job title.[43][44]

Role tier Base salary range Package details
Construction Program Manager $159,000–$230,000 Bonus, equity, and benefits additional[12][45]
Senior Construction Program Manager $189,000–$329,000 Bonus, equity, and benefits additional[12][45]
Senior Program Manager, Data Center Construction $174,000–$258,000 Bonus, equity, and benefits additional[46]
Senior Program Manager, Data Center Construction - Special Projects $221,000–$311,000 Bonus, equity, and benefits additional[6][21]
Senior program manager, California recruiting listing $190,000–$225,000 Bonus and benefits additional[48]
Multi-site program manager, outside California $115,000–$160,000 Market benchmark; about 20% below the California range[47]

8. Project Controls Manager / Scheduler

A Scheduler owns the critical-path schedule, progress updates, milestone tracking, and contractor schedule reviews. A Project Controls Manager goes further, adding cost forecasting, change control, risk management, and executive reporting.

That gap matters. It helps explain why controls roles often pay more than standard project management roles, especially when the job covers a campus or a full portfolio. As the scope grows from one schedule to a campus-level controls function, pay starts to look a lot more like program-management compensation. The safest way to benchmark this role is by what the person is accountable for, not by the title alone.

Amazon’s Project Controls Manager and Project Schedule Manager roles both list a base range of $98,700–$210,800, while Senior Project Schedule Manager reaches $125,400–$239,300. A Senior Schedule Controls Manager posting in Herndon, Virginia narrows that to $139,300–$208,000. Those figures are all before sign-on, RSUs, and benefits.[49][50][51][52][53] These owner-side ranges sit well above broad market averages because hyperscale controls roles usually carry more scope and more delivery risk.

For owner-side data center construction roles, scope is the main pay driver. A scheduler supporting one building will often benchmark between $100,000 and $135,000 base. A senior or lead scheduler who owns the integrated master schedule, recovery plans, and commissioning milestones usually falls into the $125,000–$165,000 range. A Project Controls Manager with responsibility for schedule, cost, risk, and change control on a major campus typically lands between $135,000 and $180,000. Senior or portfolio-level controls leads can reach $165,000–$210,000+, which lines up with Amazon’s senior postings.

Bonus and equity

Compare each piece on its own:

  • base pay
  • target bonus
  • initial equity or sign-on
  • equity refresh

A big base can look great at first glance, but the full package is what tells the story.

Geography and travel

Location can shift a controls offer by more than $100,000 across Amazon’s U.S. pay bands, so candidates should ask for the market-specific range tied to the offer location.[50][51]

Role Indicative 2026 base-pay range
Scheduler $100,000–$135,000
Senior Scheduler $125,000–$165,000
Project Controls Manager $135,000–$180,000+
Senior Schedule Controls Manager, Amazon $139,300–$208,000[49][53]
Senior Project Schedule Manager, Amazon $125,400–$239,300[52]

When controls expands into budget ownership, the role starts to overlap with cost and commercial management.

9. Cost Manager / Commercial Manager

Cost managers handle estimating, forecasting, change control, and budget governance. Commercial managers usually take on more: procurement, subcontractor negotiations, claims, payment certification, and closeout. In hyperscale delivery, that extra authority often pushes pay above roles focused mostly on schedule control.

Typical 2026 U.S. base pay falls between $125,000 and $210,000+. Mid-level cost managers usually land around $125,000–$150,000. Senior commercial managers with direct contract and claims authority can reach $150,000–$210,000+, especially in high-cost markets or on large AI-campus programs. One data-center salary database puts the market at $133,600–$175,300 per year, with a 25th percentile of $120,000 and a 75th percentile of $200,000 across 111 reported jobs.[54]

Hyperscaler job postings back up the high end of the range. Meta's Area Contract Manager, Central - Data Center Design, Engineering & Construction listed a base salary of $150,000–$209,000.[58] Its Commercial Sourcing Manager, Data Center Connectivity role posted $151,000–$210,000.[56] The Manager, Data Center Investment and Partnerships position went even higher, at $170,000–$238,000 in base pay alone.[57] That climb tracks with bigger capex control, more vendor leverage, and more say over closeout.

For context, the BLS reported median pay for construction managers at $114,990 in May 2025.[55] That's lower than most owner-side data center cost and commercial roles, mostly because these jobs oversee larger budgets and carry more weight in vendor decisions.

Location also changes the picture in a big way. A 2026 data-center salary guide shows Silicon Valley at about 34.2% above the national average and Northern Virginia at about 16.0% above.[42] So a $160,000 national benchmark becomes about $214,700 in Silicon Valley and about $185,600 in Northern Virginia using those multipliers. Dallas–Fort Worth, Phoenix, and Salt Lake City usually come in lower.

Use these bands as a working 2026 benchmark:

Role Indicative 2026 base-pay range
Cost analyst / junior cost engineer $90,000–$125,000
Cost manager / project controls manager $120,000–$175,000
Senior cost manager / commercial manager $150,000–$210,000
Senior commercial/investment manager $170,000–$240,000+

The simplest way to size up a specific offer is to look at four things:

  • Years of relevant experience
  • Total project value under management
  • Number of concurrent sites
  • Authority to approve changes or negotiate contracts

Once the role moves beyond budget control and into startup and handoff, pay often starts to look more like commissioning compensation.

10. Commissioning Manager / Commissioning Program Manager

Once the focus shifts from cost control to startup and turnover, commissioning moves into the spotlight on the owner side. The commissioning manager makes sure electrical, mechanical, controls, life-safety, and building systems actually work before handoff. A Commissioning Program Manager takes on more than that - managing commissioning across several buildings or phases, setting the rules, and handling escalations. That extra layer of ownership is a big reason the pay gap exists between the two titles.

Base Pay

A 2026 benchmark places a Commissioning Manager working on a single site or phase at about $120,000–$180,000 in base salary. Senior commissioning leads usually land in the $175,000–$220,000 range. A Commissioning Program Manager covering multiple sites or large AI-campus programs can hit $180,000–$260,000+ in base pay alone.[62][63]

Amazon’s posted Commissioning Area Manager roles in Herndon, Virginia, and New Carlisle, Indiana both showed $136,000–$184,000, which gives a solid mid-level reference point for owner-side commissioning pay.[61]

Role Indicative 2026 base-pay range
Commissioning Manager, single site $120,000–$180,000
Senior commissioning lead $175,000–$220,000
Commissioning Program Manager $180,000–$260,000+

These ranges draw a clear line between single-site execution and multi-site program ownership.

Scope, Seniority, and What Moves Pay Up

Pay tends to climb with IST ownership, tight turnover windows, multiple-building scope, high-density AI loads, and responsibility for multi-site commissioning standards. Hyperscalers tend to pay at the top of the range for people who can point to direct experience with utility energization, emergency-power testing, and controls integration.

Bonus, Equity, Geography, and Travel

Annual bonus targets for commissioning roles usually run 10%–20% of base pay, with bigger percentages at senior program or director levels.[62] Senior commissioning leaders can go past $300,000 in total compensation once bonus and equity are added in.[62][63]

Location can change the numbers more than many people expect. One published commissioning-manager posting listed a base range of $125,600–$188,400, with location premiums of 5% in Denver and Chicago, 10% in Seattle and Portland, and 12.5% in Washington, D.C.[59]

For jobs that require long stretches on site during energization and IST, employers also need to account for per diem, lodging, and rotation schedules. Base salary tells part of the story, but extended site presence can shift the value of an offer in a big way.

That sets up the next pay tier: site construction and owner’s rep roles, where compensation tracks closely with presence, coordination, and field accountability.

11. Site Construction Manager / Field Engineer / Owner's Representative

Once you move below commissioning and into day-to-day site delivery, pay starts to reflect what happens in the field. That includes owner-side roles like field engineer, site construction manager, and owner's representative. They sit close to the work, but they don't all carry the same level of control or risk.

Base Pay

Use this pay order as a starting point when comparing offers:

Role Indicative 2026 Base Range
Field Engineer (owner-side) $90,000–$130,000
Site Construction Manager $120,000–$175,000
Area / Senior Construction Manager $178,000–$264,100
Owner's Representative $140,000–$220,000

Field engineers usually land in the $90,000–$130,000 range. Site construction managers tend to fall between $120,000 and $175,000. Senior area roles sit much higher, at $178,000–$264,100. Owner's representatives often come in around $140,000–$220,000. At the area or campus level, Meta's area construction manager posting listed $178,000–$245,000, and a principal data center construction manager role posted a band of $126,200–$264,100.[66][68] Owner's representative roles also show strong pay. For example, a data center project posting in Eagle Mountain, Utah, listed $140,000–$220,000 per year.[12]

The biggest factor behind pay in these jobs is scope of accountability. That's the part that changes everything.

A field engineer tied to one discipline or one building will usually sit near the low end. A site construction manager handling multiple contractors, phased turnover, and high-voltage work should be priced near the top. An owner's representative overseeing a campus or a group of sites can even outpace a standard construction-manager pay band.

A few details tend to move comp the most:

  • Megawatt capacity
  • Number of buildings
  • Total construction value
  • Greenfield vs. expansion work
  • Live-site limits
  • Utility interconnection
  • Contractor count
  • Whether the role owns only field execution or the full delivery result

This matters because titles can get messy. One company's "site construction manager" may look a lot like another company's "owner's rep" or "field lead." So don't anchor on the title alone. Look at the actual scope, decision rights, project value, and reporting line.

For travel-heavy roles, the extras can change the math in a big way. Per diem, lodging, rotation terms, and completion bonuses can lift take-home pay well beyond base salary. Amazon senior construction-manager listings mentioned sign-on payments and RSUs, while Meta's area construction manager posting included bonus, equity, and benefits.[67][66] One traveling project engineer role offered $150 per day in per diem plus up to $15,000 per project.[69] Market also matters. Offers can shift a lot based on location and project difficulty in places like Northern Virginia, Utah, and other active data center hubs.[12][65][67][68]

Before an offer gets finalized, hiring leaders should put the travel terms in plain English. That means rotation pattern, lodging, flights, vehicle policy, per diem, relocation help, and weekend expectations. Those details aren't small print. They're the baseline for owner-side hiring decisions.

12. iRecruit.co market recruiting perspective for owner-side hiring

In 2026, owner-side hiring is tight because hyperscale experience is hard to find. The people who’ve already delivered mission-critical facilities at hyperscale just aren’t sitting on the market in large numbers. You feel that squeeze most in commissioning, construction management, controls, and site leadership.

The hardest roles to fill are commissioning leadership, senior construction management, project controls, MEP delivery, and site-based owner's-representative roles. A 2026 AGC/NCCER survey found that data center work is increasing competition for workers and pushing wages up.[70] At hyperscale scale, companies often need to come in above general construction pay levels if they want to land qualified candidates without losing time.

Northern Virginia, Texas, Georgia, Arizona, and Ohio are the hottest hiring markets right now. In many cases, overlapping campus builds are chasing the same small pool of people. On top of that, worker shortages across contractor and subcontractor networks drove about 42% of project delays.[71] That helps explain why offer structure matters just as much as title. If a candidate is being asked to relocate or spend a long stretch on-site, the offer has to spell that out in plain terms, not only through base salary, but also through per diem, rotation terms, housing, and travel-home frequency.

One pattern shows up again and again: candidates compare total compensation, not just base pay. A lower base can still win if equity, bonus formula, rotation, and growth path are clear. On the flip side, when a role stacks multiple hard-to-fill factors at once - immediate start, remote site, large campus, commissioning risk, and a requirement for prior hyperscale experience - pay usually has to move higher. In those cases, scarce roles often need a 15% premium over commercial construction, and senior commissioning roles can reach 20%–25% above that market.[60]

Hiring leaders should lock in the compensation range, define the must-have credentials, and put travel terms in writing before sourcing begins. Those hiring pressures set up the offer trade-offs below.

Offer Benchmarking, Trade-Offs, and Pros and Cons

Once you’ve compared role families, the next step is simpler in theory and messier in practice: how do you compare two offers side by side?

Base salary is just the opening number. In 2026, you need to look at guaranteed cash, bonus, equity, and travel support as one package.

The table below gives directional 2026 U.S. benchmarks. Actual offers will vary by employer, market, project scale, and individual experience.

Role Experience Band Base Salary Target Incentive Equity Travel Burden Key Offer Questions
Data Center Project Manager 7–12 years $120,000–$160,000 10%–20% Common at hyperscalers Low to moderate Who owns schedule and cost - you or a contractor?
Senior Project Manager 12–18 years $150,000–$195,000 15%–25% Often meaningful at public hyperscalers Moderate How large is the campus, and who owns energization?
Construction Manager / Lease Construction Manager 10–18 years $140,000–$200,000; some Amazon postings extend to about $254,500 [12] 10%–25% Employer-dependent Moderate to high Is this owner-side oversight or a resident field role?
Construction Program Manager / Senior Program Manager 12–20+ years $190,000–$260,000; some Google postings reach about $329,000 [12] 15%–30% Common Moderate to high How many campuses and delivery partners are in scope?
Project Controls Manager / Scheduler 8–16 years $120,000–$190,000 10%–20% Variable Moderate Does this role control the schedule or just report contractor data?
Cost Manager / Commercial Manager 8–18 years $130,000–$210,000 10%–25% Variable Low to moderate What is the delegated contract authority and claims exposure?
Commissioning Manager / Commissioning Program Manager 10–20+ years $175,000–$240,000 15%–30% Common at hyperscaler level High; long site presence Are shift work, weekend testing, and energization deadlines defined?
Site Construction Manager / Field Engineer / Owner's Representative 3–15 years $90,000–$180,000 5%–20% Less consistent High; may require relocation What are the per diem, rotation, and home-leave terms?

Travel support can change a field offer by a lot. Per diem in Northern Virginia senior roles runs $175–$200 per day, while lower-cost markets usually land around $125–$150 per day. [72] At $150 per day over 220 paid days, that adds up to $33,000 in annual travel support. [72] That’s not small change, and it won’t show up in the base salary line.

So when you review a field-heavy offer, don’t stop at salary. Ask whether housing is paid directly or given as a taxable lump sum. Ask whether per diem covers weekends and travel days, or only overnight site stays. Those details can shift the math fast.

Role trade-offs usually come down to cash, equity, and lifestyle. Here’s how these role types often stack up.

Comparison Advantages Disadvantages
Hyperscaler owner-side vs. site-heavy field Stronger equity, broader internal mobility, capital planning exposure, more predictable benefits High hiring bar, bonus tied to corporate performance, slower decisions, still requires heavy travel during critical phases
Site-heavy field vs. hyperscaler owner-side Higher immediate cash through per diem, paid housing, rotation premiums; fast accumulation of commissioning experience Long hours, extended time away from home, limited equity, benefits may end with the project
Portfolio program role vs. single-project role Cross-project influence, executive visibility, higher base and bonus ceiling More stakeholders, broader travel, accountability that can be hard to measure
Single-project role vs. portfolio program role Deep ownership of one building or phase; clear delivery milestones Narrower scope, lower compensation ceiling, limited internal mobility

There’s a pretty human trade here. One offer may look better on paper because the base is higher. Another may end up paying more once bonus, equity, and travel support are added in. And a third may pay a bit less but keep you home more often. That’s why title alone doesn’t tell you much.

Use posted ranges as anchors, then use market estimates as a gut check. For example, a Google senior program manager posting for data center special projects listed $236,000–$329,000 base, a 25% target bonus, and equity eligibility. [12] That range can cover multiple levels, locations, and scopes. Amazon construction manager postings spanning $153,200–$254,500 [12] show the same pattern.

Before you compare offers, confirm the parts that drive the day-to-day job:

  • project stage
  • site count
  • decision rights
  • bonus trigger

Two offers can share the same title and land in completely different worlds once you dig into those four points.

Conclusion

Across the role families above, 2026 owner-side pay follows one simple rule: scope drives compensation. Directional 2026 U.S. benchmarks put experienced PMs at $120,000-$160,000, CMs at $120,000-$175,000, senior PMs at $150,000-$195,000, and program leaders at $190,000-$260,000. Total take-home value can get close to $350,000 once bonus, equity, and travel support are included.[64][12][73]

That’s why the headline base salary tells only part of the story. A $190,000 base with a 10% bonus target and no equity may end up worth less than a $175,000 base with a 20% bonus target, RSUs, paid housing, a vehicle allowance, and a defined two-year assignment. On paper, the first number looks stronger. In practice, the second offer may pay out more.

Role family matters too. Program managers and senior project managers often earn more because they’re overseeing multiple buildings, campuses, or delivery workstreams. Project controls, scheduling, cost, and commercial roles may land in lower or similar base ranges, but hyperscale experience, claims skill, advanced forecasting, and responsibility for large programs can still push compensation higher.

Pay also shifts across hyperscalers. It’s not as simple as saying one company pays more than another. Level, location, business unit, and scope all change the range. Put plainly: employer names don’t mean much unless you’re comparing the same level, the same market, and the same job scope.

Geography and travel can change the math in a big way. Pay is often higher in major data center markets like Northern Virginia, Phoenix, and Dallas-Fort Worth, while lower-cost markets may lean more on relocation packages, per diem, travel support, or completion pay to bring in hard-to-find talent.[41] Travel-heavy roles can add a lot through housing, rotation schedules, per diem, and trips home. That’s the comparison point that matters for owner-side offers.

All figures here are directional 2026 U.S. benchmarks, not guaranteed offers. Before making any move, check the exact job posting, U.S. work location, level, employment status, bonus target, equity terms, travel requirements, assignment length, and benefits. Benchmark by scope and total compensation, not title alone. A PM running a 100+ MW campus with energization accountability is in a very different market from a general commercial PM.[39]

For hiring leaders, the message is pretty clear: pair solid cash compensation with clear assignment support. Transparent per diem terms, housing, rotation schedules, relocation support, and retention or completion payments can cut down on renegotiation and help offers get accepted, especially in field-heavy roles where candidates are weighing the day-to-day reality of the job as much as the salary.

FAQs

How should I compare two hyperscaler offers?

Compare the total compensation package, not just base salary. Look at bonus, equity or long-term incentives, per diem, vehicle allowance, and relocation support too.

Then place each offer into a market pay band. In many cases, under $130,000 is below market, while $180,000+ with equity tends to sit at the top end.

That said, higher pay isn't automaticly a better deal. Sometimes it reflects a tougher job: more sites to cover, more pressure, longer hours, or a higher burnout risk. A bigger number can come with strings attached.

It also helps to separate guaranteed pay from upside. Base salary is the money you can count on. RSUs and similar stock awards may pay off well over time, but they're still longer-term upside, not cash in hand today.

Which owner-side data center roles usually pay the most?

In 2026, the highest-paying owner-side roles usually sit at the top of the org chart: senior program and executive posts, plus the leaders running the biggest, most complex delivery work.

The clearest examples are Project Director/Executive roles, which often land in the $200,000 to $250,000 base salary range. Senior leaders running multi-site programs can go even higher, with total compensation often reaching $200,000 to $300,000+.

A step below that top tier, Senior Project Managers and General/Senior Superintendents can still hit very similar upper-end pay levels, especially when they oversee large scopes, multiple teams, or high-stakes schedules.

Commissioning leadership is also well paid. That said, it usually comes in a bit under the top executive and delivery roles.

How much can travel, per diem, and RSUs change total pay?

Travel, per diem, and equity can push total compensation well beyond base pay. In many cases, they play a big part in relocation decisions and whether someone says yes to an offer.

Travel-heavy assignments can lift total pay by 10% to 20%, mostly through per diem and travel allowances. Consultant per diem often lands in the $300 to $500 per day range. And at hyperscalers, RSUs can add $20,000 to $80,000 per year.

That said, there’s a catch: RSUs don’t always show up as cash right away. Vesting schedules can delay when you get the full amount, so the headline number may look better than the near-term payout.

Related Blog Posts

Keywords:
data center construction pay, hyperscaler salaries, owner-side compensation, construction manager salary, program manager pay, project controls salary, commissioning manager pay
Free Download

Data Center Construction Labor Trends in 2026

Thank you! Your submission has been received!
Oops! Something went wrong while submitting the form.

More mission critical construction news

Dallas Data Center Jobs 2026: DFW Construction Pay & Hiring
November 10, 2026

Dallas Data Center Jobs 2026: DFW Construction Pay & Hiring

Match pay to project responsibility - role-by-role base-pay benchmarks and negotiation tips for DFW data-center construction.
Power Solutions secures multiyear construction engine deal
November 10, 2026

Power Solutions secures multiyear construction engine deal

PSI amends its supply agreement with HD Construction, securing multi-year engine commitments to support power systems growth.
Georgia governor-elect Bottoms pledges data center pause
November 10, 2026

Georgia governor-elect Bottoms pledges data center pause

Georgia residents say data center projects influenced votes as governor-elect Bottoms calls for a temporary moratorium.
Integra advances $8 billion Texas data center project
November 10, 2026

Integra advances $8 billion Texas data center project

Integra advances $8B Clocktower data center in Quanah, TX, part of a planned 756 MW campus with a 2026–2028 build window.
