September 26, 2026

Data Center Cost Engineer Jobs 2026: Earned Value, EAC & Pay

By:
Dallas Bond

If I had to sum up this role in one line, I’d say this: data center cost engineers are hired to explain where the job is headed on cost before the budget gets hit.

In 2026, that matters more because U.S. data center construction reached $59.3 billion at a seasonally adjusted annual rate, and 73% of capacity under construction was already preleased. That means cost errors, weak forecasts, or late reporting can hit schedule, turnover, and revenue at the same time.

If you’re trying to understand this job fast, here’s the short version:

  • I see this role as the link between estimating, scheduling, accounting, procurement, and field teams
  • The main job is to track budget, actual cost, commitments, changes, accruals, and cash flow
  • Employers want people who can explain EV, CPI, SPI, ETC, EAC, and VAC in plain English
  • A strong forecast is not just a formula; it ties together field progress, buyout status, long-lead gear, pending changes, and turnover dates
  • The job changes by employer:
    • Owners test contractor forecasts and funding impact
    • GCs track control budgets, trade costs, and margin
    • EPC firms tie engineering, procurement, construction, and startup into one forecast
    • Owner’s reps review and report from an outside seat
  • The main tools I’d expect in this market are Primavera P6, Excel, Power BI, and ERP/project-controls systems
  • For pay, the article shows senior owner-side cost engineer / owner’s rep roles at $135,000 to $185,000 base salary

What stands out most to me is that hiring managers are not looking for title alone. They want proof that a candidate has owned the monthly forecast, reconciled commitments to actuals, explained variance movement, and backed up EAC changes with project data.

So if you read the full article, expect a clear look at what the job does, how EAC is built, what employers check, and how pay connects to forecast ownership.

Core Responsibilities on Mission-Critical Data Center Projects

On a fast-track data center build, a cost engineer handles two things all the time: daily cost control and month-end reporting. Those two streams feed earned value, EAC, and closeout forecasting. Put simply, the job starts with the baseline and runs all the way through closeout.

The Cost-Control Cycle from Baseline to Closeout

Everything begins with the baseline budget. Once that number is locked in, the cost engineer tracks cost code charges and WBS/control accounts against it, then updates forecasts as actuals, commitments, and change items shift.

Day to day, the work is pretty hands-on. It usually includes logging POs and subcontracts, tracking long-lead items and trend log items, and checking field progress for pay apps. At month-end, the focus turns to reconciling actuals, commitments, change orders, accruals, invoices, and cash flow.

Responsibility Category Day-to-Day Tasks Month-End Tasks
Budget & WBS Track cost code charges; monitor WBS/control account status Reconcile actuals against baseline; update WBS forecasts
Commitments Log POs and subcontracts; track long-lead logs Reconcile commitment register; validate open POs
Change Management Maintain trend log items; process field directives Finalize change order logs; update contingency burn reports
Financials Verify field progress for pay apps Validate accruals; process owner billings; update cash-flow curves

Data Center Cost Areas That Drive Reporting

The biggest reporting drivers are commitments, long-lead equipment, change orders, and accruals. On mission-critical builds, long-lead power gear and phased turnover can move the forecast fast. That's why these items get so much attention in reporting. A delay, scope shift, or timing change in one area can ripple through the whole cost picture.

Monthly Reports Employers Expect

Employers usually expect a monthly package that includes a current commitment register, change log, cash-flow curve, and baseline-vs.-actual summary. Contractor teams pull this package together from field data, pay applications, and invoices. Owner teams check and confirm it.

These outputs are how employers judge forecast quality and cost control. They also feed the earned value and EAC methods covered next.

Earned Value, EAC, and Forecasting Methods Employers Look For

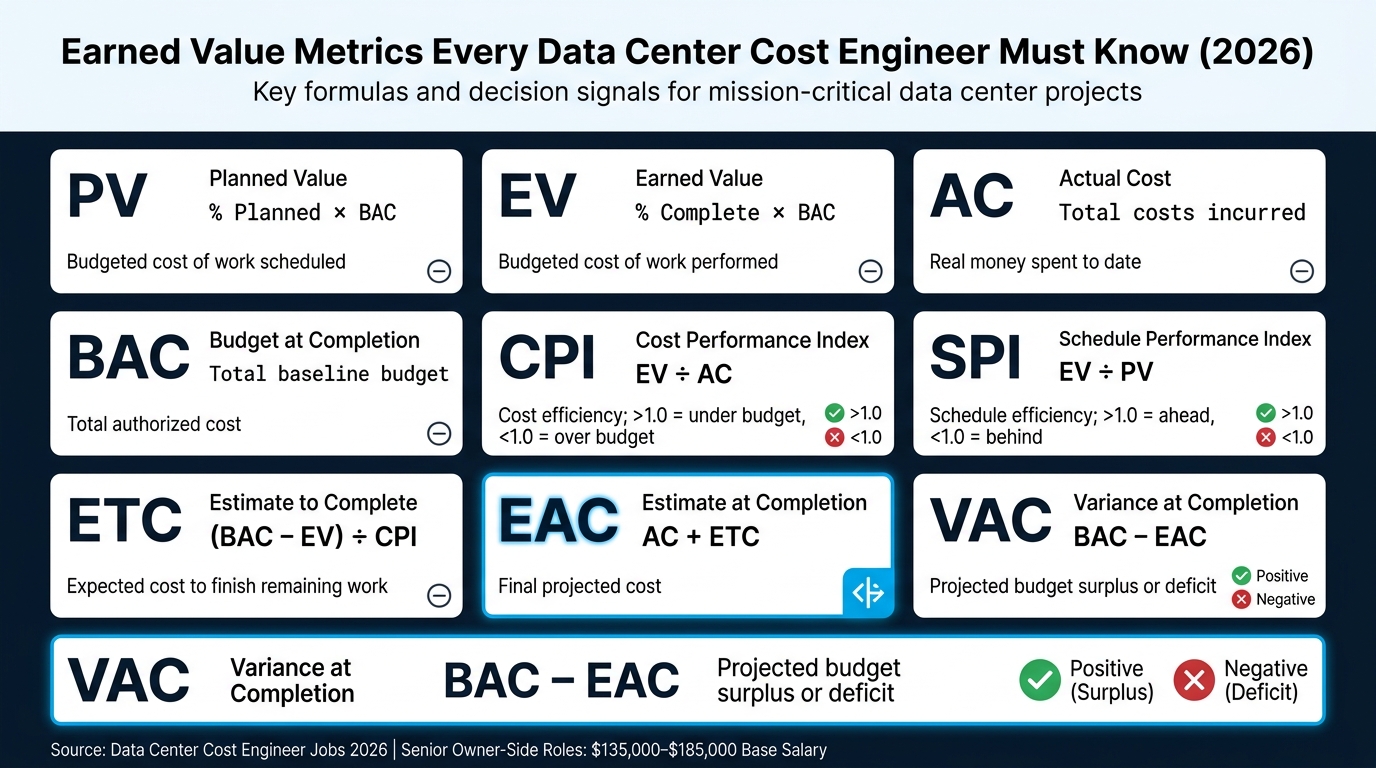

Earned Value Metrics Every Data Center Cost Engineer Must Know (2026)

Earned Value Metrics Every Data Center Cost Engineer Must Know (2026)

Employers want more than a monthly report. They want a forecast they can stand behind when cost and schedule start to drift. On phased data center builds, that usually means reconciling long-lead equipment, turnover milestones, and open changes. That’s where earned value and EAC skill sets start to separate one cost engineer from another.

EV Metrics Every Cost Engineer Should Know

Earned value gives teams a shared way to talk about cost and schedule performance. These are the metrics employers usually expect cost engineers to track, understand, and explain.

Metric Formula What It Measures Decision Supported
PV (Planned Value) % Planned × BAC Budgeted cost of work scheduled Baseline alignment and resource planning
EV (Earned Value) % Complete × BAC Budgeted cost of work performed Progress vs. physical completion
AC (Actual Cost) Total costs incurred Real money spent to date Cash flow and accrual validation
BAC (Budget at Completion) Total baseline budget Total authorized cost Feasibility and funding limits
CPI (Cost Performance Index) EV ÷ AC Cost efficiency of work performed Budget health; >1.0 under budget, <1.0 over
SPI (Schedule Performance Index) EV ÷ PV Schedule efficiency Timeline health; >1.0 ahead, <1.0 behind
ETC (Estimate to Complete) often approximated as (BAC − EV) ÷ CPI Expected cost to finish remaining work Resource reallocation and contingency release
EAC (Estimate at Completion) AC + ETC Final projected cost Funding adjustments and stakeholder reporting
VAC (Variance at Completion) BAC − EAC Projected budget surplus or deficit Final profit/loss projection and risk mitigation

By themselves, these metrics are just signals. What employers care about is how they feed into a forecast that can hold up under scrutiny.

How EAC Is Built on Real Projects

A solid EAC is not just one formula plugged into a spreadsheet. It’s a reconciliation. On a live data center build, that means tying together approved budget, incurred costs, open commitments, approved and pending change orders, subcontractor exposure, and procurement escalation risk at the same time.

Cost engineers often line up more than one forecasting method and compare the results. A CPI-based forecast shows the trend. A bottom-up ETC rebuilds the remaining cost from current scope, productivity, and open commitments. A risk-adjusted scenario adds contingency. The confidence level of the forecast should match how well the project is defined and how much risk is still out there.

On mission-critical builds, long-lead equipment status, phased turnover milestones, and open changes can move the EAC in a big way from one reporting period to the next. If a cost engineer only runs the CPI formula and skips the line-by-line reconciliation, the result may look clean on paper but won’t survive a project controls meeting.

What Separates a Defensible Forecast from a Spreadsheet Update

On mission-critical data center jobs, the real test is simple: does the forecast reflect the current field, procurement, and change picture? That’s the line between a forecast and a spreadsheet refresh. A spreadsheet update changes the actuals. A defensible forecast explains why the numbers changed and what is likely to happen next.

Strong cost engineers push on field inputs before those numbers go into the model. If reported progress doesn’t match site verification, that gap needs to be resolved before the EAC is revised. They also spell out assumptions clearly, including the productivity rate used, which change orders are still pending, and how long-lead equipment, commitments, or schedule risk may affect the remaining cost.

When variance narratives connect straight to labor productivity trends, procurement delays, change order timing, or schedule impacts, project leadership can do something with that information. Vague notes like "scope increased" don’t explain much, and they definitely don’t help a team make a decision.

Tools, Pay, and Hiring Advantage in the U.S. Market

Primavera P6, Excel, Power BI, and Project-Controls Platforms

EAC is only as good as the data behind it. That’s why U.S. employers look closely at the systems that feed the forecast.

In 2026, data center cost engineer job posts keep asking for the same core stack: Primavera P6, Excel, Power BI, and ERP/project-controls systems. These tools sit at the center of EV and EAC reporting on mission-critical builds. Employers don’t just want someone who can work a spreadsheet. They want cost engineers who can move data across systems cleanly and keep reporting in sync.

Primavera P6 connects schedule updates to cost-loaded activities. That means forecast shifts can reflect sequencing, progress, and phasing.

Excel still does a lot of the heavy lifting. It often holds the working cost model, accruals, and commitment tracking.

Power BI pulls data from P6 and ERP sources to show CPI, SPI, EAC, and variance trends for leadership teams and owners.

ERP and project-controls platforms store commitments and actuals, which helps keep forecasts current instead of stale.

What U.S. Employers Pay in 2026

The more forecast ownership a candidate can handle across these systems, the higher the pay band tends to be.

Pay in 2026 depends on a few things: experience, project size, employer type, location, and whether the person can produce reliable EV and EAC forecasts. In plain terms, if you can own the numbers and defend them, your market value goes up.

Role Level Typical Scope Expected Capabilities 2026 Base Salary Range
Senior owner-side cost engineer / owner's rep Capital program oversight Full budget/schedule accountability $135,000–$185,000

How Candidates Show Hiring Value

Hiring managers want proof that these tools were used in live monthly reporting, not just listed on a resume. Recruiters look for evidence of forecast ownership, not title keywords. That’s often where two similar candidates split apart.

A candidate who can show the work has an edge.

Hiring Requirement Proof / Evidence to Provide
Monthly EAC Ownership Anonymized monthly cost reports showing forecast evolution
CPI/SPI Interpretation Power BI dashboard summaries showing trend analysis
Reconciled Commitments Examples of commitment-to-actuals reconciliation logs
Forecast Accuracy Variance narratives explaining historical budget-to-actual performance
P6 Integration Cost-loaded schedules or cash-flow curves exported from P6

These artifacts show actual forecasting ownership.

What Makes a Strong Data Center Cost Engineer in 2026

Once the forecast framework is in place, hiring managers want people who can keep it believable when the job starts moving. And on data center work, it always moves. A strong cost engineer turns field shifts, procurement updates, and schedule changes into defensible EAC movement. They also track how long-lead delays, commissioning, and procurement milestones affect final cost.

This role sits at the intersection of cost control, schedule, procurement, and field execution. In practice, that means the job is less about resume buzzwords and more about how someone handles day-to-day cost calls under pressure.

Skill Area High-Value Traits in 2026
Cost Control Variance analysis, contingency control, auditable takeoffs
Schedule P6 fluency; quantifying delay cost
Procurement Long-lead milestone tracking
Field Execution Cx sequencing; closeout spend control

Hiring teams across data center developers, GCs, and EPC groups also put a lot of weight on earned value reporting, EAC forecasting accuracy, and clear monthly reporting [1][2].

FAQs

What does a data center cost engineer do day to day?

A data center cost engineer manages project finances while the job is in motion, with a sharp focus on cost control and where the final numbers are heading.

On a typical day, they take approved estimates and turn them into cost baselines. From there, they track trend logs and update cost-to-complete forecasts using procurement data and field progress.

They also handle change order registers and contingency burn. On top of that, they connect cost data to Primavera P6 schedules and build variance reports and dashboards in tools like Procore Financials or Excel.

How does EAC differ from earned value metrics like CPI and SPI?

EAC is a forecast of what the project will cost by the time it wraps up. CPI and SPI, on the other hand, show how the project is doing right now by measuring cost and schedule efficiency against the work finished, the money spent, and the original plan.

Put simply, CPI and SPI are today’s performance signals. EAC takes that performance data and uses it to estimate the final project cost, which helps spot budget gaps early.

What skills help a cost engineer earn higher pay in 2026?

In 2026, higher-paid cost engineers stand out because they own project outcomes, not just tasks on a checklist. Experience still matters, of course. But top pay usually goes to people who can connect cost, schedule, and reporting in a way that helps the whole project stay on track.

That’s why salaries often climb above $130,000 for senior project controls professionals who handle owner-facing reporting, earned-value dashboards, and schedule integration in Primavera P6. These roles aren’t just about updating numbers. They’re about turning project data into clear decisions.

The skills that tend to push pay higher include:

  • Technical MEP fluency
  • Accurate EAC and cost-to-complete forecasting
  • Proactive change management
  • Data-driven reporting
  • Mission-critical data center experience
