One open role can push a project off schedule. I’d treat a vacant PM, scheduler, superintendent, MEP lead, or commissioning manager as a schedule problem first. The article’s core point is simple: if a gap stays open too long, it slows procurement, cuts field output, and puts startup and turnover dates at risk.
Here’s the short version:
A few numbers make the risk clear:
If I had to boil the article down to action steps, they would be these:
Bottom line: I’d close labor gaps based on milestone impact, not org chart gaps. That’s the clearest way to protect procurement dates, field production, and final turnover.

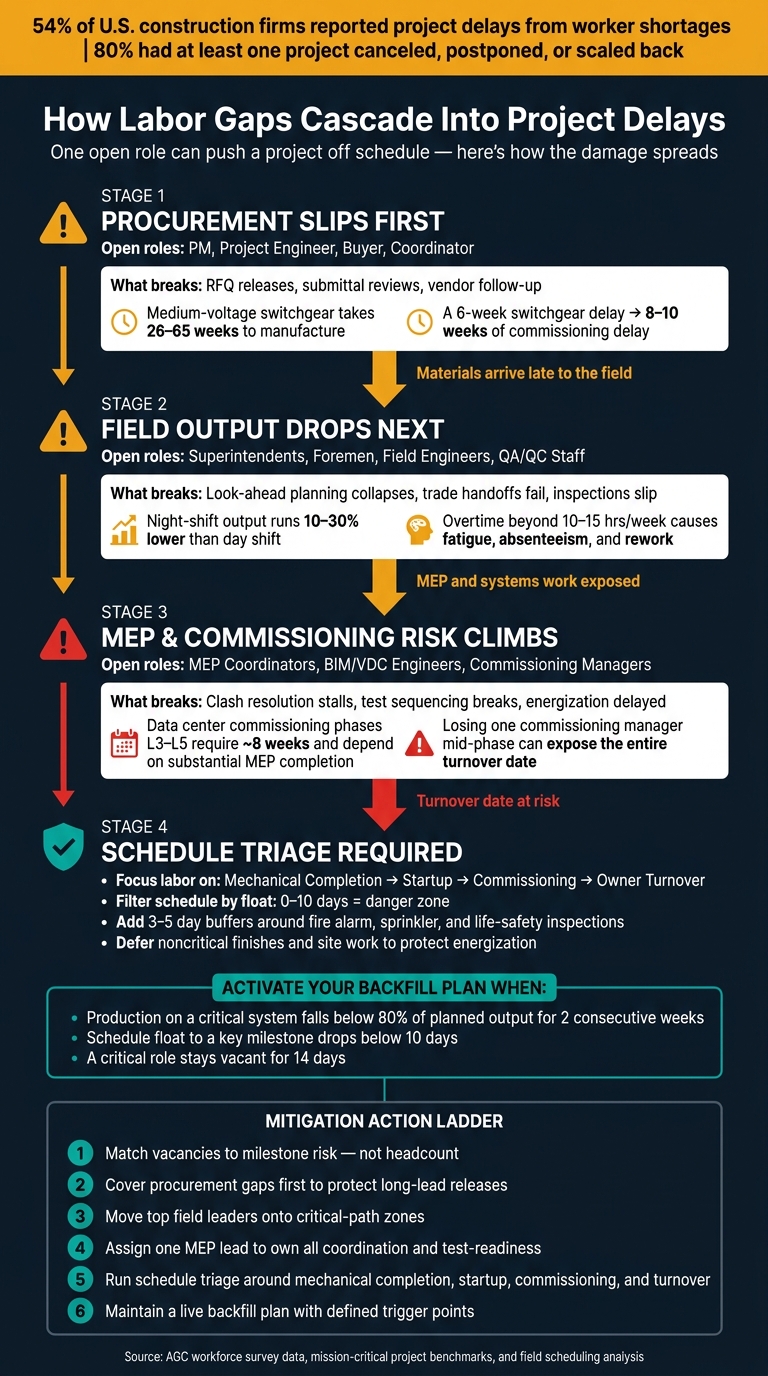

How Labor Gaps Cascade Into Project Delays: A Construction Schedule Risk Framework
When PM, project engineer, buyer, and coordinator seats stay empty, procurement slows down in predictable ways. The first trouble spots are usually RFQ release, submittal review, and vendor follow-up.
These gaps often show up first as late RFQ and bid package releases. If there’s no PM or project engineer in place to lock scope and technical requirements, bid lists don’t get built or sent out on time. And when estimators and buyers are already stretched thin, adding that work usually means something else falls behind.
Once RFQs go out late, the rest of the chain shifts with them. Submittals slide. Review cycles get longer, especially on multi-discipline systems, because fewer coordinators are trying to cover more ground. Change orders stall too. Someone still has to scope the work, price it, and move it through approval, and that takes time people may not have. Vendor follow-up also starts to break down when buyer and coordinator roles are open, so quotes, shop drawings, and manufacturing updates sit untouched.
Long-lead equipment gets hit the hardest. On mission-critical builds, medium-voltage switchgear can take 26–65 weeks to manufacture, while generators, chillers, and transformers can stretch past 40 weeks or more.[1][2][3][4][5] That’s why even a small delay can snowball. A 6-week delay in switchgear procurement alone can turn into 8–10 weeks of commissioning delay because energization sequences have to happen in order.[1] If no PM or procurement lead is there to line up technical approvals, commercial terms, and owner sign-off, release calls get pushed. By the time anyone sees the problem clearly, the fabrication window may already be gone. On mission-critical jobs, that can push energization or startup dates.
When the queue starts piling up, the fastest move is usually to hand clear ownership to someone else instead of waiting for the open role to get filled.
Short-term coverage can take pressure off fast. Temporary project engineers can handle RFQ prep, submittal reviews, and technical clarifications. Contract procurement specialists can run bid solicitation, commercial evaluations, purchase orders, and vendor negotiations. Coordinators can also be moved from closeout or document control into RFQ logging, submittal tracking, and change-order routing.
A simple rule works here:
If the vacancy lasts longer than the backlog, stop treating it like a short-term problem. The role needs a hire.
Temp support can clear work off the table, but it doesn’t replace role ownership. If a PM or procurement lead stays missing, no one fully owns long-lead tracking, vendor negotiations, or release-date protection.
Specialized construction recruiting firms like iRecruit.co work with mission-critical builders and developers and keep networks of pre-qualified candidates for project managers, project executives, cost estimators, schedulers, MEP systems leads, commissioning managers, and field-level supervisors across data centers, infrastructure, energy, defense-tech, advanced manufacturing, and pharmaceutical manufacturing facilities. Their RPO model lets owners and builders outsource parts of the recruiting workflow, and they also offer a 90-day search credit for replacements.
Overstretched teams don’t just slow procurement once. They create delays that stack on top of each other, and that’s why filling the role matters more than just covering the task list.
When procurement slips, the next pain point usually shows up in the field through late materials and broken work sequences.
Once procurement slips, field staffing becomes the make-or-break factor. If materials finally arrive but the site is short on superintendents, foremen, field engineers, or QA/QC staff, the delay doesn’t stay neatly boxed in. It turns into missed daily output, slipped milestones, and on mission-critical projects, the damage stacks up fast.
The first cracks usually show up in look-ahead planning. When superintendents and foremen are stretched too thin, those schedules get shorter, lose detail, or disappear altogether. Then the jobsite starts to drift. Crews arrive without clear priorities, materials aren’t staged where they need to be, and trade handoffs start falling apart.
From there, the problems spread fast. Areas aren’t ready when the next trade shows up. Inspections slip. RFIs sit unresolved. Trades either stand down or push ahead out of sequence, which is how rework sneaks in.
Thin supervision also makes safety coordination harder. Pre-task planning, job hazard analyses, and toolbox talks get skipped or rushed. That’s a big deal, because those checkpoints help stop the kind of mistakes that later show up as rework or commissioning failures.
A weak QA/QC presence makes the situation worse. Without in-process inspections, defects often stay hidden until commissioning or turnover instead of getting caught during installation. That means more rework, more delays, and more pressure at the worst point in the schedule. Night shift adds another layer of strain: productivity can run 10–30% lower than day-shift output because supervision, logistics, and worker fatigue are harder to manage.[6][7][8]
The best recovery move is usually pretty simple: put your strongest field leaders on the critical path first. Shift them into critical-path zones like data halls, clean rooms, and main process lines, and pull them back from lower-priority areas. If needed, pause or combine less critical parallel workstreams so supervision isn’t split across too many fronts.
After that, add limited skilled labor only at clear bottlenecks, such as electrical rough-in in data halls or mechanical piping in process spaces. But there’s a catch: this only works if supervision and logistics are already in place. More workers without enough oversight can make the site feel busier while getting less done.
Temp-to-hire supervisors can help here. They give you field leadership right away without locking you into a long-term hire, and if demand stays up, the best people can stay on.
The right move depends on how long the gap will last and how hard the work is. For a 2–6 week shortfall, limited overtime with current crews often works well. They already know the project, the systems, and the safety rules, so you’re not losing time on onboarding.
That said, overtime has a shelf life. Once weekly overtime gets into the 10–15 hours per worker range for more than a few weeks, fatigue starts to show. Absenteeism tends to climb. Quality starts to slip. Labor cost goes up fast, and overtime by itself usually won’t protect turnover dates.
For structural gaps like multi-month shortages or chronic understaffing, overtime alone won’t hold.
Cross-training tends to work best when it’s tightly scoped. Think of an experienced foreman taking on a narrow set of superintendent duties, or a senior craft worker picking up layout verification and basic QA/QC checks. That can help on repeatable tasks. But safety-critical sign-offs and harder coordination work still need qualified staff. Checklists and digital field tools help keep cross-trained workers focused on repeatable work while supervisors stay focused on coordination.
When execution gaps start slowing rough-in and inspections, MEP coordination and turnover usually become the next schedule risk.
When rough-in slips, MEP coordination and turnover land on the critical path. At that point, the problem is no longer just late installation. It becomes a startup issue. And on many projects, the next thing to break is MEP coordination, where a single open role can stall testing and startup.
MEP vacancies don't just slow the pace. They disrupt the sequence that testing and startup depend on.
MEP coordinators keep clashes, drawings, and field sequencing lined up. When those seats sit empty, clashes stay open, inspections fail, and rework slows rough-in. Once that starts, the job shifts from an installation problem to a turnover problem.
The same goes for specialty supervisors covering critical power, cooling, fire protection, and process systems. If those roles are missing, vendor startups, factory witness tests, and AHJ inspections can fall out of order. That slows energization and pushes turnover.
BIM modelers and VDC engineers keep 3D coordination models current. Without them, spool drawings get stale, prefabrication plans break down, and field crews end up waiting for updates. Commissioning managers hold together pre-functional checks, integrated systems testing (IST), and turnover documentation. If that role is vacant, test sequencing breaks and energization gets delayed.
Data center commissioning phases L3-L5 usually need about 8 weeks and depend on substantial MEP completion before they can start, so any slip in MEP installation either squeezes that window into something risky or pushes the turnover date outright.[9]
The MEP labor pool is still thin. Lose one key commissioning manager or MEP lead in the middle of a phase, and the schedule can get exposed fast.
The fastest way to steady MEP coordination is to put one person clearly in charge. Assign a single MEP lead, whether that's a contract coordinator or a senior PM with deep MEP experience, to own all MEP-related RFIs, submittals, and test-readiness tracking.
That person should keep a priority log tied to the schedule, flag issues affecting critical systems like main switchgear or chilled water plants, and run weekly coordination meetings with clear decisions and named action owners.
Contract MEP coordinators can step in fast to restart clash resolution and move submittal reviews for gear such as switchgear, UPS systems, chillers, and AHUs. On data center projects, that often gets model updates back into a steady rhythm and lets rough-in restart in equipment galleries and white space.
Third-party commissioning specialists help in a different way. They bring standard test scripts, deficiency tracking, and IST planning methods shaped by work on other projects. That's especially useful when the in-house commissioning bench is thin. Pair them with a senior PM who knows MEP well, and you get a setup that can keep RFIs moving, submittals current, and test-readiness milestones on track even when the main team has holes.
Add these roles to the responsibility matrix and the schedule logic. If the vacancy will last longer than the recovery window, it needs a fast backfill.
Contract help buys breathing room, but it doesn't fill the seat. When MEP coordinator and commissioning manager vacancies drag on, coordination meetings start to slip, IST milestones move, and the project loses the know-how needed to close out turnover packages cleanly.
Specialized recruiting matters here because these roles protect the test-and-startup sequence. iRecruit.co works with mission-critical builders and developers in data centers, infrastructure, energy, defense-tech, advanced manufacturing, and pharmaceutical manufacturing facilities. The firm places pre-qualified MEP coordinators, commissioning leads, schedulers, and field supervisors who already know what high-stakes turnover demands. Its recruitment, RPO, and consulting services are built around these roles, with a streamlined hiring process and pre-qualified candidates that cut risk when the schedule is already under strain.
The chart below shows the point: speed by itself isn't enough. Project fit and turnover readiness matter too.
Specialized recruiting fills niche MEP and commissioning roles faster and with better project fit. General hiring is often too slow when a turnover date is already at risk.
When staffing fixes show up late, triage is what keeps the turnover date from slipping. At that point, trying to speed up everything usually makes the problem worse. The better move is to focus on the few milestones that still control turnover: mechanical completion, startup, commissioning, and turnover.
Those are the dates that need labor first.
Start with the latest baseline schedule and current manpower loading reports. Then pull actual staffing rosters from HR, subcontractors, and staffing vendors. You’re looking for a simple comparison: what the plan said versus who is on site now, broken out by role and trade.
Labor-loading charts and 3- to 6-week look-ahead schedules usually make the gap obvious. Say the plan called for four electrical foremen and 40 electricians for main switchgear installation and bus duct rough-in, but the site only has two foremen and 22 electricians. That shortfall is probably sitting right on the critical path.
A good rule: filter schedule activities by float. Zero to 10 days is the danger zone. Then layer actual staffing onto those tasks so you can see which open roles put milestone dates at risk.
Don’t stop at the schedule file. Check the field. Daily reports, daily production tracking, and inspection logs show where output is falling behind. Short talks with trade foremen can tell you even more. One superintendent covering two buildings or one scheduler covering three schedules may sound workable on paper, but in practice those are single-point failures with real schedule risk.
Once you’ve mapped the gaps, the next move is simple: put labor where it still protects turnover.
After the gaps are clear, concentrate labor instead of spreading it around. Look for work packages with positive float, especially noncritical finishes and site work that don’t affect energization. Push those tasks later or batch them into another window. Then move that labor to startup-critical systems like main electrical rooms, chiller plants, UPS rooms, and critical process spaces.
It also helps to adjust schedule buffers around testing and inspections. Labor-short projects often miss the amount of time needed for rework and retesting. Adding 3 to 5 days around fire alarm, sprinkler, and life-safety inspections can absorb slippage tied to reduced MEP manpower without forcing the whole schedule off track. In most mission-critical projects, owners will accept delays in noncritical finishes if startup stays on course.
Write down every triage call. Formal schedule updates, change-control logs, and risk register entries make sure deferred scope is tracked and staffed later. They also create a clear record of mitigation if schedule relief ends up on the table.
A one-off triage effort won’t carry a project very far. The teams that protect turnover dates over and over again usually treat backfill planning as a standard process, not a scramble after someone leaves.
A practical backfill plan sets trigger points you can measure. For example:
Once a trigger is hit, the response should already be spelled out: redistribute workload, approve overtime, and start recruiting right away. The table below works as a live backfill tool tied to the milestones that matter most for turnover.
Review this table every week during peak construction and pre-commissioning. Repeating patterns matter. If commissioning keeps showing up as high risk because specialized staff are hard to find, that points to a staffing gap across the portfolio, not just on one project.
iRecruit.co supports trigger-based backfill with prequalified PM, scheduler, MEP, commissioning, and field-supervision candidates for mission-critical projects. Use that support before vacancies land on the critical path.
Keep that same trigger list active through the next staffing review so the backfill plan stays ahead of the schedule.
Labor gaps usually show up first in critical-path work. Across procurement, field execution, MEP coordination, and turnover, the pattern is the same: the opening itself matters less than how long it stays open. Once that delay drags on, work starts slipping off the critical path. And that damage tends to hit the work that controls the schedule first.
Role reshuffling and targeted overtime can buy a little breathing room. But that only works for so long. High-impact gaps like PMs, schedulers, MEP leads, and commissioning managers often need outside help because internal shuffling can’t fully cover them. Schedule triage helps keep the turnover date in place, even if some scope has to move around. For hard-to-fill mission-critical roles, specialized recruiting closes the gap faster. iRecruit.co supports targeted recruiting for PM, scheduling, MEP, commissioning, and field supervision roles on mission-critical projects.
Use these moves based on urgency.
Don’t rank vacancies by headcount alone. Rank them by milestone risk. Protect the milestone first, then fill the role.
Teams that keep turnover dates on track treat labor planning as a schedule discipline, not just an HR task. They move before vacancy age starts putting the milestone at risk.
MEP Managers and Commissioning Managers should be hired first. These are some of the toughest roles to fill, and open seats here create schedule risk fast on mission-critical projects.
Without an MEP Manager, submittals and equipment procurement start to slip. That pushes back energization.
Without a Commissioning Manager, pre-functional checks fall behind. Then the risk climbs during testing and integration, right when the schedule has no float left.
As soon as it puts the project’s critical path at risk.
If a key role - like a commissioning lead, MEP manager, project executive, or P6 scheduler - sits open for 60 to 90 days, or your team plainly doesn’t have enough capacity, that opening is no longer just a hiring issue. It’s a schedule risk.
Tie each open role to the milestone it protects - such as energization, IST, or turnover - and start triage right away if those roles are still unfilled.
Protect turnover dates by moving the plan away from broad area completion and toward system readiness and commissioning milestones. Put the schedule around the Ready-for-Service date, equipment procurement, utility interconnections, and the latest arrival date for each critical item.
If internal teams are stretched thin, use a blended staffing model during key handoffs. Bring in commissioning managers, MEP leads, and controls specialists early so they can spot issues and fix them before they turn into jobsite delays.
