Per-MW pricing, regional variance, and cost drivers for owners scoping hyperscale & AI builds.
Salary benchmarks across the 14 mission-critical disciplines.
Hire an owner’s rep like a delivery-risk lead, not a meeting manager. If I were hiring for a data center, hospital, fab, or power project, I’d screen for five things first: preconstruction, design coordination, GC oversight, stakeholder handling, and cost/schedule control.
Here’s the short version:
A lot of these programs run 18 to 30 months, and small hiring misses can turn into missed milestones, weak change-order control, and turnover delays. The article’s main point is simple: if the project carries high MEP, commissioning, budget, and schedule risk, the hiring process has to match that risk.
If you want fewer hiring misses on high-stakes capital work, this is the frame I’d use.

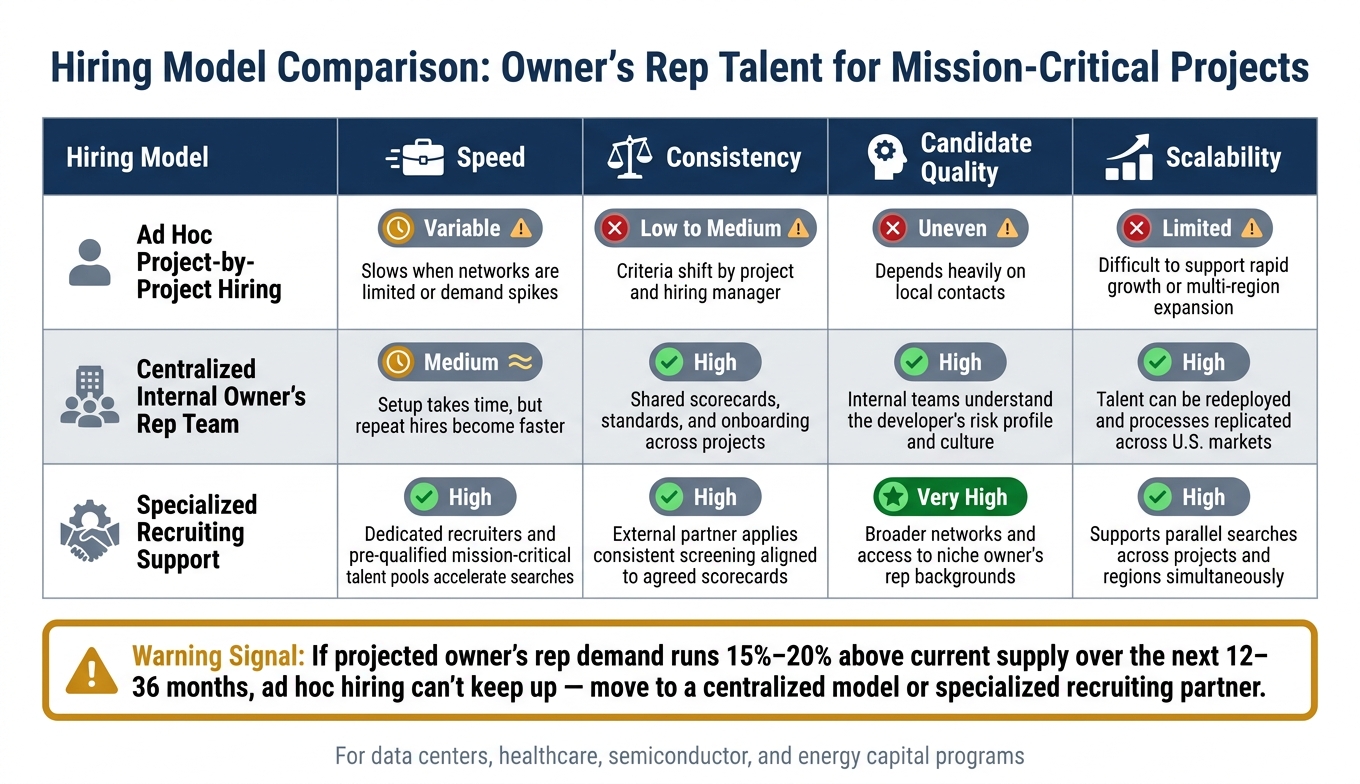

Hiring Model Comparison for Owner's Rep Talent in Mission-Critical Projects
Define the role based on delivery risk before you post the job. The owner's rep is the owner-side lead. They are not the GC and not a field PM. They coordinate the owner's architects, engineers, GC, trade partners, commissioning agent, AHJs, utilities, and operations team.
That difference matters when you hire. If the job description mixes up owner-side oversight with field execution, you'll attract the wrong people. The GC is accountable for delivering the contracted scope in the field. The owner's rep is accountable for keeping scope, cost, schedule, quality, and operational readiness lined up with business goals from preconstruction through turnover.
Once the owner-side role is clear, turn the project's biggest risks into screening criteria.
Start with project risk. Then turn each risk into a hiring requirement. On mission-critical programs, those risks usually cluster around aggressive milestones, high capital intensity, technical complexity, owner-furnished contractor-installed equipment coordination, and stakeholder pressure.
Each risk should map to a skill you can screen for:
Screen for:
With the risk profile set, write duties that fit the asset type.
Match the role to the asset class so the right candidates can spot the job fast. For data centers, focus on power density, electrical procurement, commissioning sequence, and turnover readiness. For healthcare, focus on user-group coordination, infection control risk assessments and interim life safety measures, and phased construction in occupied facilities. For advanced manufacturing and semiconductor programs, focus on process coordination, utility interfaces, shutdown planning, and production continuity.
Across asset types, write responsibilities as action-based deliverables with clear outputs, not fuzzy duties. For example:
"Lead weekly risk reviews and maintain a live risk register"
That says a lot more than "manage project risks."
And this is stronger too:
"Review and challenge monthly cost forecasts against the approved budget"
It's far more useful than "oversee financials."
Use those deliverables to shape interviews, scorecards, and reference checks.
Once the role profile and risk criteria are set, focus on sectors where people already deal with similar delivery risk. The risk profile from the last step should do most of the filtering for you.
Start with candidates who already operate in high-stakes environments. The best transfer signal is experience with formal project controls, complex MEP systems, and tight commissioning requirements.
For data centers and other critical infrastructure, put hyperscale or colocation CMs and developer-side project directors at the top of the list. These are the people who have already managed multi-project budgets, utility coordination, and commissioning sequences tied to uptime.[1]
Leaders from semiconductor, pharma, biotech, healthcare, utility, and transmission can also move into this work well, especially if they’ve handled change control, phasing, validation, and regulated schedules.[1]
Use this priority map by project type:
Titles can be misleading. A resume that says Project Manager or Construction Manager doesn’t tell you much on its own. The real signal is the project context behind the title: system complexity, governance, delivery pressure, and how the work was managed day to day.
That’s why it helps to look past the label and dig into the actual program. Many candidates share the same title, but their projects didn’t require the MEP depth, commissioning discipline, or regulatory oversight that mission-critical programs demand.
Specialized recruiting support can speed things up in a big way. It helps you reach vetted owner-side and technical candidates faster, which can cut down search time and improve the first slate.
Once the right backgrounds are in the funnel, screen for the five capabilities that protect delivery.
Use structured interviews to test five capabilities that have the biggest impact on delivery: preconstruction, design coordination, GC oversight, stakeholder management, and cost and schedule controls. The key is simple: test for the same risks you used when writing the job description.
Start with the areas most likely to affect project outcomes.
Preconstruction shapes budget certainty and long-lead risk. Ask candidates to walk through one specific project from start to finish: the initial budget in USD, the final GMP, and how they handled major cost changes along the way. Then dig deeper. Ask about benchmark costs per square foot, contingency calls, long-lead equipment planning, and how bid packages were set up.
Strong candidates usually speak in hard numbers, not vague generalities. They should be able to point to actual dollar amounts and clear results. If the answers stay fuzzy, that's a red flag. For value engineering, ask for a case where they reduced cost without hurting performance.
Design coordination protects scope stability and schedule. This is best tested with a scenario instead of a theory question. For example, present a mid-design power density change, such as a 20% increase in IT load on a data center, and ask how they would lead the architectural, structural, and MEP teams through it without blowing the schedule.
Look for a clear process: updated basis-of-design documents, revision control, and BIM coordination. If someone defaults to “get everyone in a room” but can't explain the process behind it, that's a risk on complex programs.
GC oversight affects baseline recovery and change control. Ask for an example where the GC was weeks behind baseline, then require the candidate to explain the float analysis and recovery plan. For pay applications, hand over a sample and ask them to walk through the review process, including progress verification, retention, change orders, and lien waivers.
People with hands-on GC oversight experience usually sound at home with contract language and know when, and how, to escalate.
Stakeholder management drives executive alignment. A short verbal update test works well here. Give the candidate a major project overrun and ask for a five-minute executive briefing. Then evaluate whether they can separate controllable cost drivers from uncontrollable ones, stay direct, and recommend corrective actions without burying the main issue.
A one-page memo on a risk decision for senior leadership is also useful. It shows how they write and think when the pressure is on.
Cost and schedule controls help teams spot risk early. Provide a simplified cost report for a hypothetical $200 million project and ask the candidate to identify the key risks and recommend actions. Then share a baseline schedule with a current update and ask for a basic float analysis.
Keep the exercise to 60 to 90 minutes and use one scoring rubric. You're testing judgment, not whether they know every tool in the stack.
One useful way to calibrate your evaluation is to look at where the candidate's prior experience sits, either GC-side or owner-side. That background often shapes their default instincts around neutrality, controls, and oversight.
Use the table to spot gaps. For GC-heavy candidates, probe harder on owner-side controls. For developer-side candidates, push more on field execution.
Then carry those same gaps into your scorecards, reference checks, and compensation decisions.
The next step is to turn your hiring review into a system you can use again and again. Ad hoc hiring may work when you're filling roles for a few standalone jobs. But once you're staffing multiple programs at the same time across several states, that approach starts to crack.
Use one scorecard for every search. Keep it simple and tied to the work that matters most. In most cases, that means four to six core competencies linked straight to schedule, budget, and quality. For example: schedule protection, budget control, quality assurance, commissioning support, and stakeholder management. Add behavioral rating scales for each one so interviewers aren't just going off gut feel.
Every interviewer should fill out the same scorecard right after each interview. That timing matters. It helps people record clear examples while the conversation is still fresh, instead of writing vague comments later.
Reference checks should follow the same logic. Focus them on the same risk areas and on results you can verify. Ask the same set of questions each time, mapped to those same categories. That can include how the candidate handled change orders above $100,000, whether milestones were met on a steady basis, and how they communicated under pressure with executive sponsors. Record those answers with the same rating scales used in the interview scorecard.
Do that long enough, and patterns start to show up. You begin to see who tends to protect schedules, who has cost-control weak spots, and which signals point to a stronger hire.
Compensation bands need the same level of structure. Set them by scope, geography, travel, and seniority. A project lead running a single-site project under $100 million should not sit in the same band as a director-level delivery risk manager overseeing several programs at once. Senior project managers and delivery executives often land in the $175,000–$250,000 base range, with bonuses tied to delivery results. Clear bands make offer approvals move faster and help candidates know where they stand from day one.
Pick the hiring model that matches your portfolio's pace and your tolerance for hiring risk. Look at speed, consistency, candidate quality, and how well the model holds up as you add more work.
There’s also a simple warning sign to watch. If projected owner's rep demand runs 15%–20% above current supply over the next 12–36 months, staffing risk is building. At that point, ad hoc hiring usually can’t keep up. That’s the cue to move toward a centralized model, a specialized recruiting partner, or a mix of both.
The takeaway is simple: hire owner's reps to manage delivery risk, not meetings. On mission-critical programs, the owner's rep is a delivery-risk manager, not a coordinator. Protecting schedule, budget, quality, and execution across data centers, power facilities, advanced manufacturing plants, and healthcare projects calls for a different kind of hire than generic project management can offer.
It starts with the role profile. Tie it to the delivery risks the person will own and to the backgrounds that transfer best - people from hyperscale data center programs, utility-scale power, semiconductor builds, and hospital capital programs who already work in high-stakes settings.
Then test those skills head-on. The five capabilities that matter most - preconstruction leadership, design-team coordination, GC oversight, stakeholder management, and project controls - should be checked with structured questions and practical exercises, not just resume reviews.
Use standardized scorecards, structured references, and pay bands tied to scope, geography, and delivery accountability. That makes each hire repeatable and easier to scale, and it helps turn steady hiring into steady delivery across the full portfolio.
The main difference comes down to who they report to, what risks they carry, and how much of the project they cover.
An owner’s representative (OR) works for the developer as an independent advocate across the full project lifecycle. Their job is to protect the developer’s interests, with close attention on budget, schedule, and quality.
A general contractor (GC) project manager (PM) works for the contractor. They’re focused on day-to-day site execution, trade coordination, and keeping construction moving. The OR, by contrast, sits at a higher level and provides broader oversight on behalf of the developer.
The strongest owner’s rep talent usually comes from high-stakes delivery roles where people have to manage tough technical coordination under pressure.
Good fits often include general contractor superintendents, cost engineers from EPCM or consulting firms, commissioning leads from provider firms, and project engineers with hands-on experience in live, fast-paced delivery environments.
Focus on delivery know-how, owner-side judgment, and the nerve to deal with high-stakes conflict. The best interview prompts make candidates show how they acted on behalf of an owner when stakeholders wanted different things and pressure was high.
For technical roles, test the skills that matter on the job. For example:
That way, you’re not just hearing polished answers. You’re finding out whether someone can step into the role and make sound calls when the project gets messy.
