September 7, 2026

Traveling Superintendent Jobs: Pay, Per Diem & Data Centers

By:
Dallas Bond

If you're looking at a traveling superintendent job in data center construction, the trade is simple: more pay for more time on the road. From what I see in this article, base pay often lands around $135,000 to $250,000+, with total compensation reaching $160,000 to $360,000, depending on experience, project size, and bonus structure. On top of that, per diem, housing, flights home, and vehicle support can swing your weekly take-home by hundreds of dollars.

Here’s the short version:

  • I’d expect 80% to 100% travel in many roles
  • Workweeks often run 5 to 6 days
  • Busy phases can hit 60 to 70+ hours
  • Assignments may last 6 months to 24 months
  • Per diem often falls between $140 and $200+ per day on flat-rate plans
  • Some senior roles in top markets have reported base pay of $185,000 to $275,000

What matters most is not just salary. I’d look at:

  • Base pay
  • Bonus and completion pay
  • Per diem rules
  • Housing setup
  • Flights home
  • Rotation schedule
  • Construction project delivery type
  • How much commissioning and MEP work I’ll touch

Quick Comparison

Area What the article shows
Pay Higher than many other construction sectors; data center work was cited at about 32% more
Travel Often 80% to 100%
Hours Usually long, with peak periods above 60 hours
Per diem Flat daily, days-worked-only, or employer-paid lodging plus meal cash
Housing Hotel, extended stay, corporate apartment, or stipend
Best fit Superintendents who can step into a site fast and run MEP-heavy work through commissioning
Main downside Time away from home and burnout risk

So if I were weighing one of these jobs, I’d keep it simple: Does the extra money beat the travel load, long hours, and time away from home? That’s the core decision this article helps answer.

Role Scope, Responsibilities, and Work Schedule

Field Leadership From Mobilization to Commissioning

A traveling superintendent usually shows up before the first crew and stays until turnover. In the mobilization phase, that means handling utilities, fencing, laydown, badging, and trailers. That early setup shapes the job from the start.

Once the project is moving, the day often begins with a 6:00–6:30 a.m. foremen meeting. The superintendent lines up work by zone and keeps MEP, containment, and finish trades moving together. Each foreman needs a clear plan for labor and materials before crews get to work.

From there, it’s a lot of field time. The superintendent walks the site, checks installed work, sorts out clashes between conduit runs, cable tray, and ductwork, and logs daily reports on manpower, weather, delays, and inspections.

On some jobs, they may be coordinating structural, envelope, electrical, low-voltage, HVAC, fire alarm, security, and specialty trades in tight spaces. In occupied facilities or live data center areas, the job gets even trickier. Trades may need escorts through active spaces, noisy work may be limited to set hours, and materials have to be staged in preapproved zones so egress stays open.

As turnover gets closer, the focus shifts to commissioning readiness. The superintendent works with the commissioning agent on equipment start-ups, integrated systems testing, and phased room turnover. They also make sure pre-functional checklists are done, punch items are closed out, and systems are safe before testing starts.

In data centers, the schedule often turns on tie-ins, inspections, and commissioning windows. That’s why field control matters from day one. Across the full project, the superintendent is also the main field contact for owners, owner's reps, inspectors, and code officials. They schedule inspections, answer correction items, and keep the schedule from slipping.

That kind of pace is a big reason these roles often come with premium pay and travel support.

Typical Rotations, Hours, and Travel Patterns

Most traveling superintendents in U.S. data center work are on 5- to 6-day workweeks, with days starting around 6:00 a.m. and ending around 5:00 or 6:00 p.m. When the project hits critical path work, like major electrical tie-ins, commissioning windows, or owner-driven milestones, the week can jump to 60–70+ hours. Evening coordination calls and weekend work can become part of the routine.

Night shifts are common during tie-ins and shutdowns, especially in live or near-live facilities where disruptive work has to happen after hours. Some superintendents switch between day and night coverage. Others keep a separate night superintendent in place but stay on call around the clock for big calls.

Assignment length depends on the project:

  • Smaller fit-outs or expansions may last 6–9 months
  • Large greenfield campuses can run 12–24 months
  • Some traveling superintendents move straight from one project to the next within the same portfolio

In fully traveling roles, the superintendent is often on the job from start to finish, with trips home every 3–4 weeks. Regional rotation models keep them within a set hub, which can mean more time at home, though peak phases still tend to require long stays.

Lifestyle Trade-Offs: Higher Pay Versus Time Away From Home

Those long hours and travel patterns are the price behind the pay premium.

Yes, the money can be strong. But the personal cost is real too. Extended-stay hotels, corporate apartments, and short-term rentals can become home for months at a time. That setup wears on people, especially when one assignment rolls straight into the next.

Long hours and back-to-back projects also push up burnout risk, especially once weeks go past 60 hours.

Traveling roles swap home time and stability for higher total pay and faster exposure to complex work. The superintendents who stay in these roles for the long haul usually put limits around rotations, lock in staffing help, and guard their recovery time between projects.

The next question is whether the offer pays enough to make that trade worth it.

Pay Ranges for Traveling Superintendents in U.S. Data Center Construction

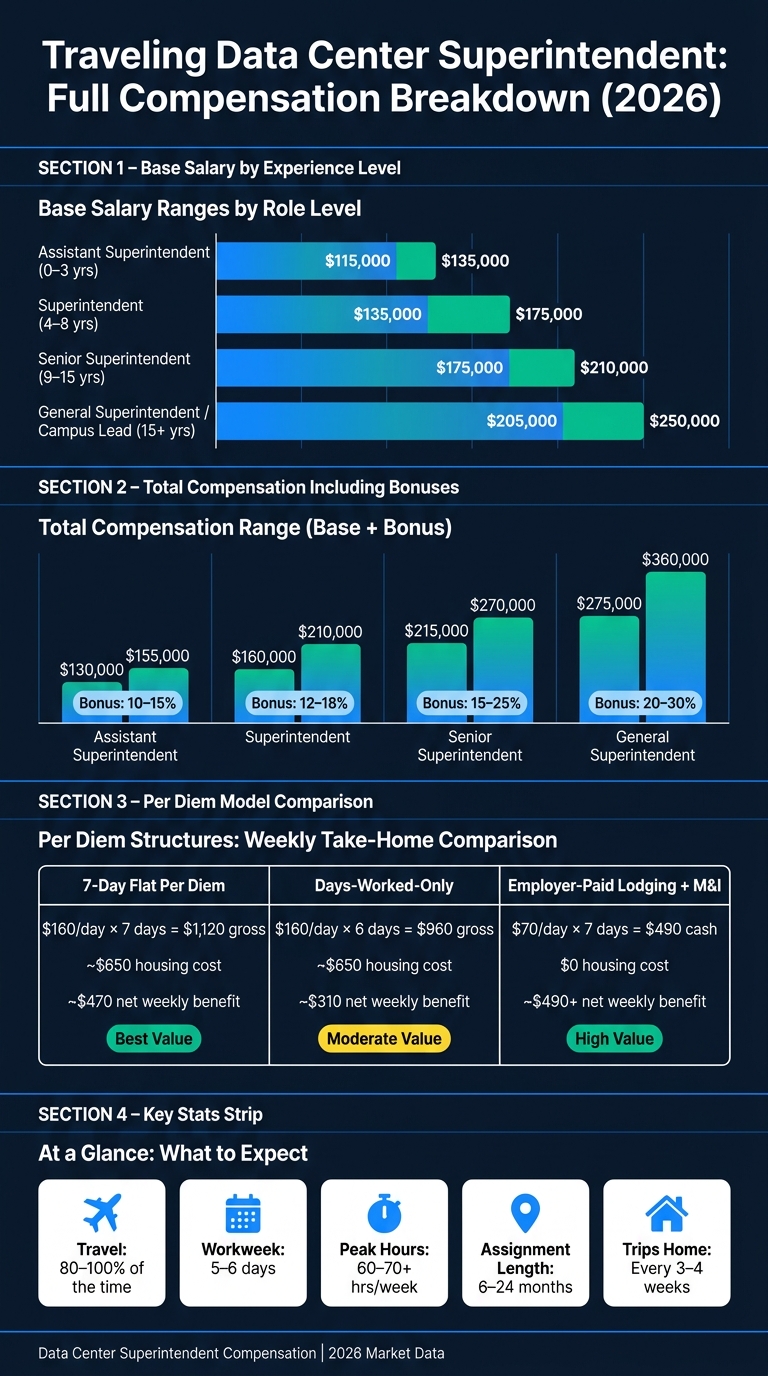

Traveling Superintendent Pay & Per Diem: Full Compensation Breakdown (2026)

Traveling Superintendent Pay & Per Diem: Full Compensation Breakdown (2026)

That premium shows up in base pay, bonuses, and market demand. Traveling data center superintendents get paid more because the work is mission-critical and the job often means living on the road. Average base pay lands around $155,000, but the range gets much broader depending on experience, project scope, and the type of build.

Base Salary by Experience Level and Role Type

Mission-critical and MEP-heavy experience usually pushes pay higher. Here’s how the market looks for traveling data center superintendents in 2026 [1]:

Role Level Base Salary Range Bonus Potential Total Compensation Range
Assistant Superintendent (0–3 years) $115,000 – $135,000 10% – 15% $130,000 – $155,000
Superintendent (4–8 yrs) $135,000 – $175,000 12% – 18% $160,000 – $210,000
Senior Superintendent (9–15 yrs) $175,000 – $210,000 15% – 25% $215,000 – $270,000
General Superintendent / Campus Lead (15+ years) $205,000 – $250,000 20% – 30% $275,000 – $360,000

Northern Virginia, Phoenix, Dallas, and Atlanta stand out as markets where superintendents often hit the top end of salary bands and see strong demand [3].

Bonus, Completion, and Project Incentive Structures

Base salary is only one part of the deal. Most employers also offer an annual bonus tied to profit, schedule, and safety. Completion bonuses are often paid at substantial completion or turnover for staying through commissioning. On multi-year campus builds, retention bonuses may show up too, especially when companies want field leaders to stay in place through key phases.

What Drives Pay Up or Down

Project type and scale matter a lot. Hyperscale campuses tend to pay more than smaller colocation or enterprise projects, especially when the role includes heavy MEP coordination, commissioning, and tight schedule pressure.

On the candidate side, direct data center and mission-critical experience carries the most weight. Superintendents who have led jobs from site mobilization through commissioning and turnover - and can point to on-time delivery, strong safety results, and solid commissioning performance - are the ones most likely to land at the top of the pay range.

Market location also shifts compensation. In hotter markets, pay tends to move up. In travel roles, employers often balance location costs with per diem and company-paid housing, which can change what the offer is worth week to week.

Base salary is only part of the offer; per diem, housing, and travel support can change the real weekly value.

Per Diem, Housing, and Travel Package Structures

Per diem, housing, and travel support shape what you actually keep each week. For a traveling data center superintendent role, the package can swing your weekly take-home by hundreds of dollars.

Common Per Diem Models and Typical Ranges

Per diem is a daily allowance for lodging, meals, and incidentals while you're on assignment. In U.S. data center construction, you’ll usually see three main setups.

A flat daily per diem pays every day you’re on assignment, including days off. For travelers, this is usually the best deal. On mission-critical projects, rates often land around $140–$200+ per day. If you spend less on housing, you keep the difference.

A days-worked-only model pays only for the days you’re on the job, often at $100–$160 per day. At first glance, that can look close to a flat-rate deal. But there’s a catch: on a 6-day schedule, you lose one day of per diem every week while still paying to live in the project city.

A split model works a little differently. The employer covers lodging directly, then pays a smaller meals and incidentals per diem of $50–$90 per day. In many cases, employers set these plans up to stay within non-taxable travel rules.

Travel Support Beyond Per Diem

Per diem is only one piece of the deal. Flights, vehicles, and housing often have just as much impact on weekly take-home.

Round-trip airfare is usually covered on a set rotation. One paid trip home every three to four weeks is common [2][7][8]. If you drive your own vehicle, mileage, tolls, and parking are often reimbursed. Many roles also come with a rental vehicle or company truck plus a fuel card.

Housing support can show up in a few forms. Some employers offer a monthly stipend, usually around $1,500–$2,500 per month in lower-cost markets, with higher amounts in expensive data center markets. Others provide company-paid housing on longer builds [4][5][6]. You may also see move-in and move-out stipends to help cover the hassle and cost of getting set up for the job.

How to Compare the Real Weekly Value of an Offer

Two offers can show the same daily rate and still leave you with very different money in your pocket. That’s why it helps to look at the full weekly picture.

Package Structure Per Diem Rate Days Paid Gross Weekly Per Diem Est. Weekly Housing Cost Net Weekly Benefit
7-day flat per diem $160/day 7 $1,120 $650 (self-arranged) ~$470
Days-worked-only per diem $160/day 6 $960 $650 (self-arranged) ~$310
Employer-booked lodging + M&I per diem $70/day 7 $490 cash $0 (employer-paid) ~$490+

Company-paid housing can come out ahead in high-cost markets like Northern Virginia or Phoenix, where extended-stay rates can run far above $650 per week. A flat per diem gives you more control and lets you keep the leftover amount if you find a cheaper place. But when hotel and short-term rental prices jump, that risk lands on you.

The smart move is to compare the total weekly take-home value, not just the per diem number.

How to Evaluate a Traveling Superintendent Opportunity

Offer Review Checklist for Data Center Roles

Once the weekly value looks right, judge the role on fit, not just pay. Money matters, but it doesn't carry the whole job.

Before you sign, put these decision points in writing:

  • Base salary and review cycle - Confirm the exact base salary and the review date.
  • Bonus structure - Get the bonus triggers, payout timing, and whether completion pay is tied to commissioning.
  • Per diem rules - Confirm which days per diem is paid, when it hits your check, and what it covers.
  • Housing quality - Verify the housing type, commute time, and whether you get a private room.
  • Rotation and travel - Confirm the exact rotation, home-trip policy, and who pays for travel.
  • Expected hours - Confirm the weekly hours and whether overtime is built in.
  • Project type and client standards - Match the project to your background: greenfield, retrofit, live facility, or campus expansion.
  • Company track record - Look for repeat data center clients, strong safety performance with a low TRIR, and a history of on-time delivery. Companies with established mission-critical programs often have steadier pipelines and clearer paths up.

It also helps to run a simple calendar test. Lay out a normal month against family commitments and the things you can't move. If the rotation leaves you home only four to six days a month, and some of those days get eaten up by travel fatigue, the job may not last over 12–24 months no matter what the paycheck says.

If the offer clears that checklist, the next step is to ask a different question: does this role build the kind of mission-critical experience that helps you move up?

Career Path and When Specialist Recruiting Support Helps

Traveling superintendent roles pay well, but the bigger draw is how fast they expose you to tough data center work. You get MEP coordination, commissioning exposure, and direct client interaction in one job. That can move you toward senior superintendent and general superintendent faster than many local roles.

A common path looks like this: traveling superintendent, then senior superintendent, then general superintendent. Moving up usually comes down to documented results - megawatts of capacity delivered, white rooms turned over on schedule, safety metrics, and client relationships built across multiple projects.

Specialist recruiting support tends to help at two points. The first is when you're trying to break into data centers for the first time. The second is when you've already built a record and want to turn that into a higher-level role. A recruiter focused on mission-critical construction can tell you whether an offer is below market, in line with market, or above market for your background. That's tough to judge on your own when jobs, pay, and travel packages shift from one market to the next.

Conclusion: The Main Trade-Offs to Weigh Before Saying Yes

After you review pay, per diem, rotation, and project demands, the last call is pretty simple: does this role fit your life and your long-term path?

Traveling superintendent roles in data center construction can bring strong total compensation, solid per diem and housing value, and fast exposure to high-complexity work. The full package comes down to base salary, bonus, per diem, housing, and travel support.

The trade-off is just as real. These jobs call for sustained mobility, long weeks, and comfort making high-stakes decisions in places where delays can cost a lot of money. The right offer is the one where compensation, project quality, travel, and personal priorities all line up in writing.

FAQs

Is the pay usually salaried or overtime-based?

It depends on how the role is set up. Many traveling superintendent jobs come with an annual base salary. Others pay by the hour.

Either way, overtime can have a big effect on total pay, because projects often run 60 to 72 hours per week. If the role is hourly, overtime is usually paid at time-and-a-half. If it’s salaried, check your contract closely to see whether overtime pay is included.

How is per diem taxed in traveling superintendent jobs?

Per diem is usually treated as a non-taxable allowance when it’s set up the right way for temporary, away-from-home assignments.

Since it’s meant to cover meals, incidentals, and lodging, not wages, it’s often left out of taxable income. That said, the tax treatment can change based on the company’s setup and its travel reimbursement rules, so check how your offer labels it.

What experience helps me break into data center projects?

Focus on mission-critical environments where MEP systems, commissioning, and strict uptime requirements are part of the job. In this space, trade experience is often expected. That said, work in healthcare, semiconductor labs, power utilities, or industrial manufacturing can also show the level of technical discipline employers want to see.

Put a spotlight on hands-on experience with high-voltage distribution, backup power, and cooling infrastructure. Those systems sit at the heart of data center work, so they matter on a resume.

When you describe your experience, lead with results. Call out outcomes such as:

  • Successful Integrated Systems Testing
  • Phased turnovers completed on time or with minimal disruption
  • Schedule recovery that kept the project moving

That kind of detail shows you didn’t just support the work - you helped get the facility online and keep it there.

Related Blog Posts

Keywords:
traveling superintendent, data center superintendent, per diem, construction superintendent jobs, superintendent pay, MEP commissioning, travel packages, rotation schedule
Free Download

Data Center Construction Labor Trends in 2026

Thank you! Your submission has been received!
Oops! Something went wrong while submitting the form.

More mission critical construction news

Construction Estimator Salary 2026: Mission-Critical Rates
September 7, 2026

Construction Estimator Salary 2026: Mission-Critical Rates

2026 pay benchmarks for construction estimators: mission-critical roles pay more—data centers top the list; mid $90–130k, senior $130–170k.
Data Center Construction Jobs: 2026 Hiring Outlook & Pay
September 7, 2026

Data Center Construction Jobs: 2026 Hiring Outlook & Pay

Tight 2026 market: high demand for data center construction leaders, strong pay for PMs, supers, MEP and commissioning roles.
Data Center Technician Certifications That Get You Hired
September 7, 2026

Data Center Technician Certifications That Get You Hired

Pick 2–4 role-matching certs to get hired: A+/Network+/Server+ for IT; OSHA/NFPA 70E, CDCP or vendor training for facilities.
Energy Vault secures land for 125 MW Stoney Creek BESS
September 6, 2026

Energy Vault secures land for 125 MW Stoney Creek BESS

Energy Vault secures land for 125 MW / 1 GWh Stoney Creek BESS in NSW, advancing toward construction.
