The Construction Project Manager's First 90 Days on a New Build

By:
Dallas Bond

The first 90 days decide whether a new build stays under control or drifts into delay, cost creep, and rework. If I were stepping into a new project, I’d focus on four things first: scope, schedule, cost, and field accountability.

Here’s the short version:

  • I lock the scope baseline before crews ramp up
  • I check contracts, drawings, procurement, and trade handoffs
  • I set a fixed meeting and reporting rhythm
  • I run the job with CPM, 2–4 week look-aheads, and live constraint tracking
  • I track cost against the estimate, not just invoices
  • I push RFIs, submittals, and change orders through one system
  • I start turnover and commissioning planning by Day 61, not at the end

The numbers make the point. 70% of projects falter because of weak project management. Formal precon cost baseline work makes projects 34% more likely to land within 10% of the original budget. And with average procurement cycles at 40.5 days, waiting even a few weeks can put the schedule at risk.

By Day 90, I should be able to show that the job is under control with:

  • A clear scope baseline
  • A live CPM schedule
  • A working look-ahead plan
  • Up-to-date RFI, submittal, and change logs
  • Cost tracking tied to actual spend
  • Early closeout and commissioning work already started

This article breaks that 90-day window into Days 1–30, 31–60, and 61–90 so you can see what a PM needs to set up, track, and fix before small gaps turn into jobsite problems.

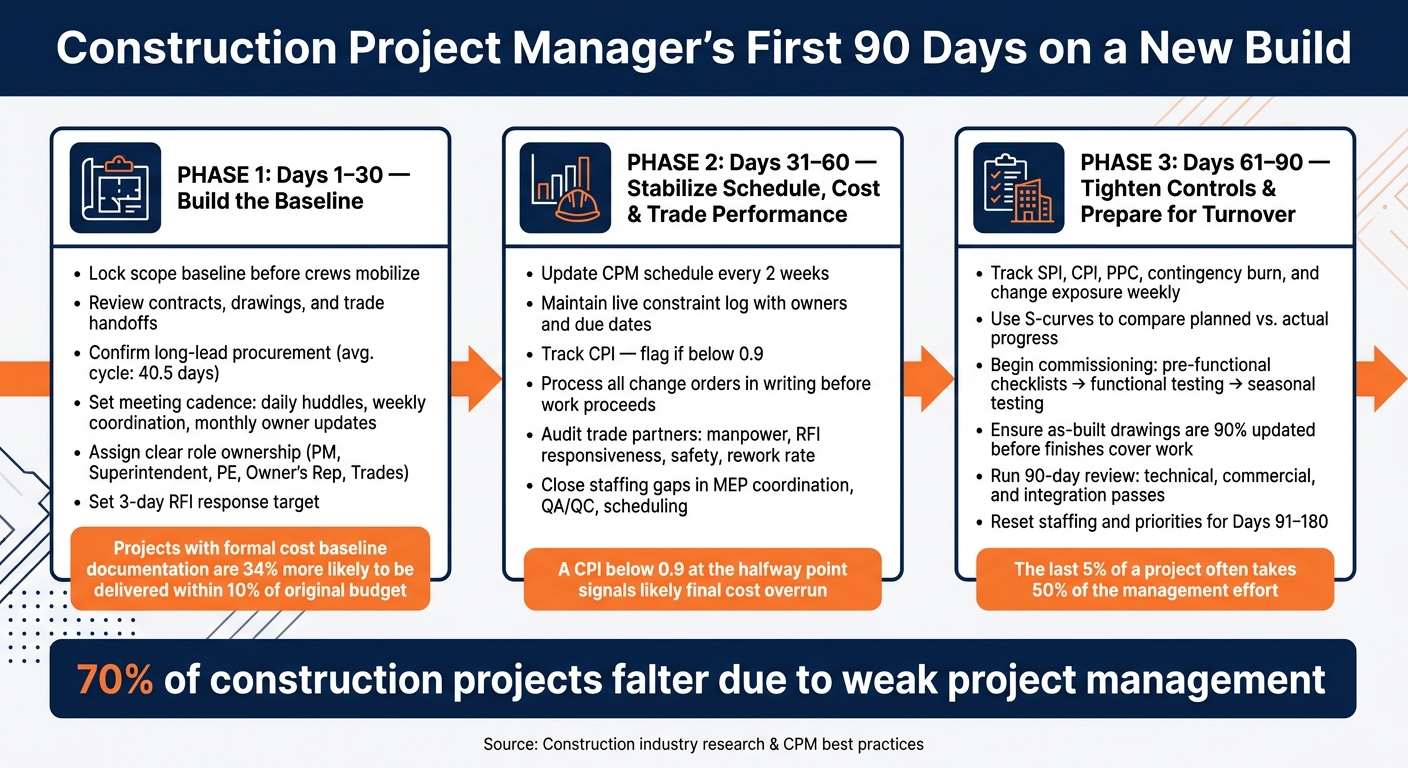

Construction PM's First 90 Days: The 30-60-90 Day Action Plan

Construction PM's First 90 Days: The 30-60-90 Day Action Plan

Before Day One and Days 1-30: Build the Baseline and Set the Rhythm

Before mobilization, lock the scope baseline, flag the riskiest interfaces, and assign clear ownership. This is the window to get control before field work starts moving fast.

Go back through the prime contract, specs, drawings, and owner expectations with fresh eyes. Then map the high-risk scope interfaces and hunt for scope gaps. These are the spots where teams trip over each other because no one knows who owns what, like who brings power to HVAC equipment or who handles fire caulking at penetrations.

Projects with formal cost baseline documentation at preconstruction are 34% more likely to be delivered within 10% of the original budget [6]. That’s why the baseline needs to be locked before crews mobilize. Once that’s done, shift right into procurement status, reporting rules, and role clarity.

By Day 30, the PM should have a locked baseline, clear ownership, and a live rhythm for procurement and reporting.

Review Contracts, Drawings, Schedule, and Procurement Status

Review each scope for quality, contract terms, and trade handoffs [1]. Don’t stop at what’s written on paper. Look at where one trade ends and the next one begins, because that’s often where trouble shows up.

Once the scope map is clear, move to the CPM schedule and procurement log. Long-lead items need confirmed lead times right away. The average procurement cycle in construction runs 40.5 days [4], so if an item isn’t already in motion, it needs attention now.

Trace field material requests all the way back to the supplier. That’s one of the easiest ways to catch duplicate orders, pricing that was never checked, and small schedule leaks before they turn into bigger problems [4].

Set Meeting, Reporting, and Field Communication Standards

Set the rhythm early: daily field huddles, weekly trade coordination, and monthly owner updates [2][6]. Once the baseline is in place, the cadence should stay simple and steady.

Keep a running action log so every meeting ends with a clear owner and due date. Set a 3-day RFI response target [2], and use one shared system for submittals, RFIs, and project updates [3]. If job information is split between email, text, and phone calls, details slip through the cracks. It happens all the time.

A simple setup works best:

  • Daily huddles to flag field issues fast
  • Weekly coordination meetings to track trade handoffs
  • Monthly owner updates tied to budget, schedule, and pending decisions

Meet the Team and Confirm Who Owns What

Confirm ownership of each control point before crews arrive [2][5].

  • The PM owns the budget baseline, prime contract, and buyout strategy
  • The superintendent owns site control and safety
  • The project engineer owns submittals, RFIs, and document control
  • The owner's rep owns scope approvals and site access
  • Trade partners own production rates and look-ahead inputs

That kind of clarity cuts down rework, missed handoffs, and approval delays once field work starts to speed up.

Walk the estimate with the superintendent before mobilization so the team starts from the same scope and budget baseline. The gap between the bid and the field is where reactive management begins. Set the standard early, then enforce it.

With roles and rhythms in place, move into schedule, cost, and trade performance control in Days 31–60.

Days 31-60: Stabilize Schedule, Cost, and Trade Performance

With the baseline in place, Days 31–60 are about proving the plan on the ground and tightening control wherever field conditions drift from it. This is the first hard test of the baseline: does it still match what’s happening in the field, or are small gaps starting to turn into bigger problems?

Use CPM and Look-Ahead Plans to Remove Constraints Early

Use the CPM schedule to confirm progress, then use the 2-to-4-week look-ahead to remove near-term constraints before they touch the critical path. Update the CPM at least every two weeks so float is recalculated and actual progress is built in [7].

In weekly coordination meetings, keep a live constraint log. Every blocker should have an owner and a due date. If a submittal is still out, a permit still hasn’t been pulled, or a material delivery still isn’t confirmed, it belongs on the log. The goal is simple: clear the issue before it lands on the critical path. Permits and inspection hold points should also be tied straight to the 2-to-4-week look-ahead window, so excavation or hot work never sits idle waiting on paperwork [2].

Have trade leads help build the look-ahead and commit to what they’ll deliver [3]. That’s when the look-ahead stops being shelf paper and starts working as an accountability tool people will actually use.

Once near-term work starts holding steady, apply that same discipline to budget exposure and trade performance.

Audit Budget, Change Orders, and Trade Partner Performance

By Day 31, the focus shifts to protecting the budget. On a steady cycle, compare committed costs, current forecast, and remaining contingency against the original budget. A Cost Performance Index (CPI) below 0.9 at the halfway point of a project is a strong sign of final cost overrun, but it can still be recovered if the issue is caught early [7].

Process every change in writing before the work moves ahead, and note the time and cost impact right away [3] [8].

Trade issues don’t stay hidden for long. Review each subcontractor on a few basics:

  • Manpower reliability: Consistent crew levels and supervision on site [1]
  • RFI and submittal responsiveness: Paperwork moving at or under the 3-day target [2] [3]
  • Safety compliance: Active near-miss reporting, not just reactive correction [7]
  • Rework rate: Adherence to Inspection Test Plans (ITPs) and low defect rates [3] [7]

If production rates are slipping or the numbers don’t hold up, fix the team right away. Waiting usually turns one trade problem into a jobwide delay.

Close Staffing Gaps Before They Become Project Risk

If the schedule stalls, cost starts sliding, or RFIs begin stacking up, staffing is often part of the issue. Days 31–60 tend to expose gaps that slipped through preconstruction [5]. If reviews show weak coverage in MEP coordination, QA/QC, scheduling, or commissioning, move now: backfill the role, shift ownership, or escalate to leadership before the gap turns into schedule risk [5].

Days 61-90: Tighten Controls and Prepare for Turnover

With the baseline stable and the weekly rhythm in place, the work changes. At this point, the PM's job is less about setup and more about control. By Day 61, move to weekly control based on actual job data, with a sharp eye on drift before it turns into a late-stage mess.

Track the Right KPIs for Schedule, Cost, Safety, and Quality

At this stage, the dashboard needs to do one thing well: show schedule, cost, risk, and changes in one place [9]. Use S-curves to compare planned vs. actual progress and spend. If SPI or CPI drops below 1.0, flag it at once [9][10].

For schedule, track:

  • Schedule Performance Index (SPI)
  • Critical path health
  • Look-ahead Percent Plan Complete (PPC) [10]

For cost, watch Cost Performance Index (CPI), forecast variance, contingency burn, and change exposure [10]. For safety, put more weight on leading indicators like near-miss reporting and safety observation frequency, not just incident counts [10][11]. For quality, review aging nonconformances, rework hours, and inspection pass rates every week [10]. Keep an eye on RFI turnaround time too, with a target of 5–7 days, along with submittal cycle times so bottlenecks don't slide onto the critical path [3].

Once measurement is in good shape, turnover work needs to start early. If not, closeout tends to become a mad dash.

Start Turnover, Commissioning, and Closeout Planning Now

The last 5% often takes 50% of the management effort [3]. That's why waiting until the end to sort out O&M manuals, as-builts, and owner training is a bad bet. Starting by Day 61 gives the team enough runway to stay ahead of closeout slip.

For complex systems - critical power, BAS/BMS, cleanrooms, and process utilities - commissioning should move through three phases: pre-functional checklists to confirm installation and labeling, functional testing in normal and emergency modes, and seasonal testing [10]. The commissioning agent should already be on board, and the functional test schedule should be set before Day 90 [10][7]. As-built drawings should be 90% updated before finishes hide the work underneath [10]. Record owner training sessions and give the owner quick-start guides for complex systems so handoff is usable on day one [10].

With turnover in motion, the 90-day review becomes the checkpoint for what still needs recovery before the next phase begins.

Run the 90-Day Review and Plan the Next 90-180 Days

The 90-day review is an accountability check. Compare actual job performance against the original 30-60-90 goals across schedule, cost, quality, and safety. Where the job has drifted from baseline, assign a recovery action and give it a due date [9][11].

Run a three-part review across the remaining work packages:

  • A technical pass to catch scope gaps
  • A commercial pass to reconcile the change log, pending change orders, and forecast-at-complete against the remaining contingency
  • An integration pass to confirm systems and trades are sequenced the right way for the next phase [1]

Then re-rate the probability and impact of the remaining risks, including weather, labor availability, utilities, and long-lead deliveries. Update the risk register and assign clear mitigation owners [10][7]. After that, reset staffing, procurement, and reporting priorities for Days 91–180, when the focus shifts to systems integration, commissioning, and enclosure testing [9][10]. This is the point where the PM confirms the job is controllable, not just active, and that the team has the data and ownership in place to carry execution certainty into the next phase.

Conclusion: The Early-Stage Roadmap That Creates Execution Certainty

The 30-60-90 cadence works because it turns early uncertainty into a controlled sequence. On complex new builds, that early control is what separates predictability from drift. At NTP, review the contract, confirm long-lead procurement, set the meeting cadence, keep RFIs, submittals, and change orders moving, and start turnover planning before practical completion.

Why does that matter so much? Because most field problems don’t appear out of nowhere. They usually start with missed interface decisions. Most late-project failures can be traced back to undefined handoffs in month one, like fire caulking, trench backfill, equipment power, and similar interfaces. That’s not a late-stage surprise. It’s a baseline problem.

The 30-60-90 structure keeps the team focused on the right control points at the right time. And the 90-day review should do more than look backward. It should reset owners and priorities for the next phase.

What This Means for Project Leaders and Hiring Teams

For hiring teams, the takeaway is simple: on mission-critical U.S. projects, early control protects schedule, operations, and margin. Teams should prioritize PMs who can lock scope, validate procurement, and enforce execution discipline from day one. The first 90 days show whether a PM can create execution certainty fast, and that’s the standard that matters most.

FAQs

What should a PM fix first if the project starts drifting early?

If a project starts to drift, pause and reset. Go back to the contract documents to clear up roles and find scope gaps. Then line up the estimate with what the jobsite needs, with input from the project team, key subcontractors, and foremen.

From there, build a clear plan the team can act on. Tackle the highest-risk areas first, keep submittals and RFIs moving in real time, and fix one measurable problem to get the job back under control.

How do you spot scope gaps before they cause rework?

Start with a rigorous pre-construction audit in your first 90 days. Put together a gap matrix that tracks unresolved scope questions by trade, document reference, and risk level. At the same time, map key trade handoffs so ownership is clear before work starts getting passed around.

Make sure subcontract scopes line up with the final bid documents, not the original proposal requests. During your 48-hour reset, review the contract documents, flag high-risk packages, and use alignment meetings to confirm gaps and upstream dependencies before they turn into bottlenecks.

When should turnover and commissioning planning begin?

Turnover and commissioning planning should start during the pre-construction phase. Getting started early gives the project team time to spot coordination conflicts and system requirements before work begins on-site.

That early start also makes it easier to build documentation, testing, and turnover checklists into the first project plan. The result is a smoother handoff from construction to occupancy.

Related Blog Posts

Keywords:
construction project management, 90-day plan, CPM schedule, procurement, commissioning, RFIs, cost control, look-ahead planning
Free Download

Data Center Construction Labor Trends in 2026

Thank you! Your submission has been received!
Oops! Something went wrong while submitting the form.

More mission critical construction news

Inside a Day in the Life of a Data Center Construction Project Manager
June 19, 2026

Inside a Day in the Life of a Data Center Construction Project Manager

How data center construction PMs protect schedule, safety, costs, and commissioning through site walks, RFIs, procurement, and coordination.
Project Closeout in Construction: The Checklist Owners Should Demand from Day One
June 19, 2026

Project Closeout in Construction: The Checklist Owners Should Demand from Day One

Set closeout rules at kickoff: require a written plan tied to contract, schedule, retainage, and a shared log for phased handover.
Construction Management for Owners: How to Protect Your Budget, Schedule, and Quality
June 19, 2026

Construction Management for Owners: How to Protect Your Budget, Schedule, and Quality

Protect budget, schedule, and quality by setting owner goals early, choosing the right contract, enforcing change control, and commissioning.
Weekly Construction Meetings: The Owner's Agenda for Catching Problems Early
June 19, 2026

Weekly Construction Meetings: The Owner's Agenda for Catching Problems Early

Owner-led weekly meetings on seven risk areas—fixed agenda, action logs, and 24‑hour minutes to catch issues early.
