Per-MW pricing, regional variance, and cost drivers for owners scoping hyperscale & AI builds.
Salary benchmarks across the 14 mission-critical disciplines.
Data center budgets usually go off track for three reasons: the estimate starts low, long-lead gear gets bought late, or changes hit the job with weak cost control. On mission-critical builds, those misses can get expensive fast. Power and cooling systems drive a big share of total cost, transformer lead times have stretched to 128 weeks, and average cost per megawatt has moved from $7.7 million in 2020 to $11.3 million in 2026.
If I had to sum up the fix in one line, it would be this: put clear budget owners in place for each phase and control cost before the field pays for it. That means:
You also need the right people tied to each control point:
A few numbers show why this matters:
The core idea is simple: budget control is not one meeting or one spreadsheet. It is a phase-by-phase system, with each person owning a clear part of the cost. The rest of the article breaks down where budget risk shows up, who should own it, and what actions help keep the job on plan.

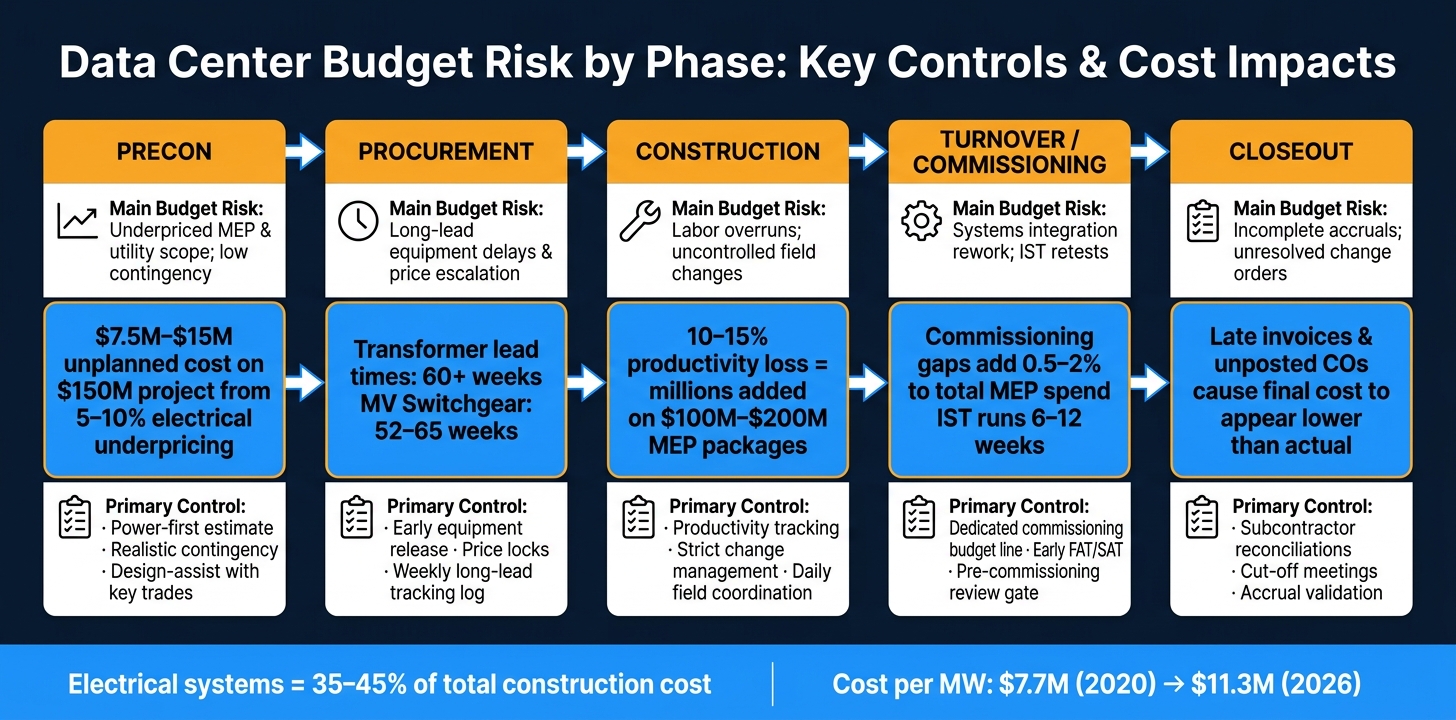

Data Center Budget Risk by Phase: Key Controls & Cost Impacts
Budget overruns rarely come from one giant mistake. More often, they come from a string of small misses across the job, from precon all the way through closeout. Weak early estimates, late buying, labor drift, scope changes, and sloppy final reconciliation can all push cost past plan. So the key move is simple: know which controls matter in each phase, and make sure someone owns them.
Precon sets the cost baseline. If the estimate is light at the start, that gap usually stays with the job.
Electrical distribution is a common problem area. It is often underpriced by 5–10%, which can create $7.5 million to $15 million in unplanned cost on a $150 million project. Utility allowances also tend to fall apart once trenching, duct banks, offsite upgrades, and permitting hit the budget. Commissioning gets missed too. Teams may fund basic testing, but integrated testing and retests often get left out.
That matters even more on MEP-heavy work. These projects need more contingency than general commercial jobs.
During procurement, the risk changes. It becomes less about estimate accuracy and more about timing and price. Long-lead gear can take more than a year to arrive, so teams often order transformers and switchgear well before groundbreaking.[5][6][9][10][11] The strongest controls here are pretty direct:
Once major equipment is locked in, the budget risk moves to the field. If crew output slips below plan, labor overruns can pile up fast. On MEP-heavy data center jobs, a 10–15% productivity loss across major electrical packages can add several million dollars in labor on a $100 million to $200 million project, especially when overtime is used to get the schedule back on track.[12] That's why strict change management, daily field coordination, and timely budget updates matter so much. Without them, field directives can turn into unbudgeted work before anyone catches it.
Even after the field work looks finished, cost can still move during turnover and reconciliation. Commissioning and turnover are often where systems integration issues show up for the first time. Misconfigured controls, failover logic problems, cooling imbalance, and alarm or trending gaps can lead to overtime labor, retesting, and hardware changes. If commissioning is not scoped and funded from day one, those issues can add 0.5–2% to total MEP spend.[4][7]
Closeout brings a different kind of risk: missed cost. Unposted change orders, late invoices, unresolved T&M tickets, and incomplete accruals can make the final cost look lower than it actually is.[2][3][8]
These controls only work if each phase has a clear owner.
Budget control works best when each phase has a clear owner: precon, procurement, construction, turnover, and closeout. Data center budgets usually drift for a simple reason: cost responsibility gets spread across too many people. Then no one spots the problem early enough to fix it. Those control points only work when each phase has a named owner.
The owner's capital and finance team sets the funding ceiling. They decide the total funding limit, the contingency plan, and the three-stage approvals that stop the project from moving ahead until scope and cost are ready for the next release of funds. On larger data center programs, a three-stage review at concept, schematic, and 100% design is a practical way to check scope maturity before more money is committed. If those reviews are weak or skipped, the project can lock in a budget that was off from the start, sometimes months before field work begins.
The project executive owns the commercial and contract plan. In plain terms, that means choosing the contract structure - GMP, design-build, or CM at-risk - based on the owner's appetite for risk. It also means making procurement calls, like whether to split the electrical package or buy key equipment early.
The construction project manager takes that plan into the field. This role manages the procurement log, tracks long-lead equipment against required on-site dates, runs change control, and coordinates trade sequencing so crews don't pile on top of each other. The split is pretty clear:
As mission-critical work grows, many firms find these roles harder to fill than they expected. Labor shortages in specialized positions - project executives, project managers, MEP supervisors, and commissioning managers - create real cost and schedule risk.[17][18]
The estimator builds the base budget. On a data center project, that starts with electrical load, redundancy architecture, backup generation, switchgear, UPS, and the cooling plant. That power-first approach helps avoid one of the most common early misses: underpricing MEP systems because the estimate was built from architectural drawings instead of the facility's actual power and cooling demand.[13][16]
The cost controls lead keeps the forecast current throughout the job. This person tracks committed costs, actual spend, pending changes, and contingency burn. Just as important, they turn those numbers into decisions instead of letting them sit in a report.
The MEP lead owns technical scope control. That includes checking that bids are complete, spotting coordination gaps before they hit the field, and reviewing substitutions for downstream cost that may not show up in the first price.
The commissioning manager makes sure testing and turnover allowances are built into the budget early. That's a big deal on data center work. If testing costs get treated like an afterthought, the bill usually shows up late, when there's less room to react.
Use the role split below to match each phase with its budget controls.
When these roles are spelled out and each person knows what they own, the team can move fast on late-stage changes. Take a transformer substitution. The estimator prices the delta, the MEP lead checks technical equivalency, and the commissioning manager flags testing impacts before approval. Without that split, the team may approve the change based only on purchase price - then get hit with the hidden costs later.
With ownership set, the next step is applying these roles to precon, procurement, construction, turnover, and closeout controls.
Use phase-based controls early, before small misses turn into overruns.
The estimate should start with power, not square footage. Set the target IT load in megawatts, the redundancy level - N+1 or 2N - and the phasing plan first. Then build the rest of the budget around those limits. Electrical systems - switchgear, UPS, generators, PDUs, and distribution - usually account for 35–45% of total construction cost[1], so getting that number right at the start sets the baseline for everything else.
Next, split the budget into clear control buckets: shell and core, fit-out, power, cooling, utility upgrades, off-site work, and commissioning. Each bucket should have its own line in the work breakdown structure and its own contingency logic. A single flat contingency across the whole job can blur where the actual risk sits. On U.S. mission-critical projects, total contingency often lands between 5–15% of construction cost, with more carried at concept stage and less once design reaches 100% construction documents[14].
Owner approval gates at concept, 30%, 60%, and issued-for-construction help stop the budget from hardening too early. At each gate, the cost team updates the estimate, checks contingency again, and reviews open risks such as unconfirmed IT load changes or utility upgrade scope that still lacks full pricing. Release the baseline only after key equipment is specified, major MEP layouts are frozen, and site conditions are verified[14][20].
Labor planning needs the same level of control. Build a labor histogram by trade - electrical, mechanical, controls, and commissioning - and model shift patterns directly. Two-shift work during critical path tasks like electrical rough-in is common on data center projects. That cost belongs in the baseline budget, not tucked into contingency.
Once the estimate is in place, procurement timing becomes the main budget lever.
The biggest schedule and budget risk in data center construction is long-lead electrical equipment. Medium-voltage switchgear can take 52–65 weeks from order to delivery, and transformers can run past 60 weeks[1][19]. In plain terms, procurement calls made in precon often decide whether the project hits its power-on date.
Release equipment-only bid packages at 60–75% design completion instead of waiting for 100% construction documents. That can cut 2–4 months from the procurement cycle and helps the team secure factory slots early. But there’s a catch: design changes after a factory slot is secured can add 4–8 weeks to delivery. That’s why specs need to be frozen before purchase orders go out.
During construction, track budget, commitments, and actuals in one cost report by WBS bucket. Each new subcontract or purchase order should update the commitments column right away. Pending change orders need to be logged before they hit the formal budget. Weekly cost reviews with the data center construction project manager, superintendent, procurement lead, and owner rep keep mitigation moving instead of letting issues sit.
Change order control is where construction budgets often start to slip. Every change order should come with detailed backup, a schedule impact analysis, and proof that the work sits outside the original bid scope. Approving a change based only on purchase price - without checking installation, coordination, or testing effects - is how a “small” change turns into a much bigger overrun.
After buyout and field execution, turnover is the last point to catch scope gaps before they hit cost.
Commissioning needs its own budget line. It shouldn’t be funded out of general construction contingency. The work in this phase - integrated systems testing (IST), staged energization, and redundancy validation - takes fixed amounts of time and can’t just be shortened by adding more labor. IST usually runs 6–12 weeks and requires commissioning, owner, and vendor teams onsite[15].
Staged energization and redundancy validation, including simulated failures of utility feeds, UPS modules, or cooling components, can reveal installation issues that need corrective work before turnover. If that rework wasn’t carried in the budget, it eats into whatever contingency remains at the end of the job. A dedicated commissioning allowance set early helps prevent that.
Owner-side reviews before commissioning starts are the last practical gate for controlling late design changes and operational readiness upgrades. By the time commissioning begins, the cost to fix a design gap is much higher than it would have been in precon or early construction. A pre-commissioning review that confirms MEP systems are installed per design and that test scripts are approved helps the team avoid finding scope gaps after energization starts.
That handoff carries the remaining cost risk into closeout, where final invoices and accruals are reconciled.
Once commissioning wraps up, closeout tells you if the budget actually held up. This is the point where the numbers stop being forecasts and start being final. Every commitment, invoice, change order, accrual, contingency draw, and allowance needs to be matched back to the control budget. That work sits with the project executive, construction project manager, and cost controls lead.
To catch every last dollar before final approval, move through closeout in a clear order. Start with the final commitment log and confirm that every purchase order, subcontract, and amendment ties to the right budget line and the right approved change order. Then complete an open-commitment and accrual review so any work that is finished but not yet billed still shows up in the owner's cost report. After that, reconcile invoices, retainage, and executed change orders, and treat disputed or pending changes as owner exposure. From there, track where contingency dollars went by trade and issue type - design gaps, MEP scope creep, labor productivity, or long-lead premiums - and return any unused contingency to the owner.
Once the final numbers are locked, use them to tighten controls on the next job. Compare planned versus actual labor hours by trade. Review vendor schedule performance and how often change orders showed up. Check actual commissioning spend against the original allowance. Then tie MEP change orders back to root causes, such as owner standard changes, design coordination gaps, or code or permitting requirements.
It helps to sort change orders into clean buckets:
That breakdown gives estimators the ratios they need to set better contingency levels and design allowances on the next build.
Lead-time data should also shape the next project's buyout plan. Compare actual lead times with the baseline schedule assumptions for switchgear, transformers, UPS units, and generators. Document any expedite costs, out-of-sequence installation premiums, or rework tied to late deliveries. Then use those actual lead times to reset future procurement milestones and contingency buffers.
Closeout data can also sharpen the staffing plan for the next project. Looking at labor histograms by role - superintendent, MEP coordinator, scheduler, commissioning manager - shows where thin staffing led to cost overruns or missed procurement windows. That can turn into standard staffing models tied to project MW size and redundancy level.
iRecruit.co can help source project managers, project executives, MEP leads, and commissioning managers with data center experience, so the next project starts with a team that fits the work.
A power-first estimate is a budgeting approach for mission-critical facilities that treats electrical infrastructure as the main cost driver.
That makes sense in data center work. Systems such as substations, medium-voltage switchgear, transformers, UPS systems, and backup generators often account for 40% to 45% of total data center construction costs.
By focusing on power costs first, owners can model and lock in those big-ticket items early. It also helps them deal with long-lead procurement and make better use of capital.
Long-lead equipment should be purchased during design development, ideally when the design is 60% to 75% complete, instead of waiting for final construction documents.
That timing matters more than it used to. Lead times for critical items like switchgear, transformers, and generators can range from 12 to more than 100 weeks. Buying early helps teams avoid schedule delays and keeps submittal, fabrication, and delivery milestones on track.
Budget control is a shared job across the full project lifecycle. The project manager handles the day-to-day watch on budget and schedule, while specialist roles take care of specific parts of the work.
The cost engineer tracks actual costs, change orders, and forecasts. The scheduler points out cost effects caused by schedule changes. The finance lead manages funding draws. The owner or steering committee approves major budget changes, contingency releases, and business-case sign-offs. The owner’s representative provides neutral oversight from start to finish.
