How Construction Project Managers Handle Subcontractor Default Without Losing the Schedule

By:
Dallas Bond

When a subcontractor starts to fail, I don’t wait for a full shutdown. I move in the first 48 hours, document the problem, send notice, protect the critical path, and line up backup labor. That’s the shortest version of the playbook.

A stalled trade can turn into schedule loss and cash loss fast. On a $20 million project with $10,000 per day in liquidated damages, a 3-week slip can cost $210,000 before replacement costs are added. And if the fix runs through a bond process, the delay can stretch 60 to 90 days.

Here’s the article in plain English:

  • I separate delay from default early. Not every weak sub needs termination.
  • I watch field signs first. Low crew count, unpaid suppliers, slow deliveries, and missing paperwork are early red flags.
  • I use set triggers. Missed milestones, float loss, or labor dropping below contract levels should start action.
  • I act inside 48 hours. I review contract notice rules, log site facts, take photos, and send a clear cure notice.
  • I pick the least disruptive fix. That can mean coaching, step-in labor, partial reassignment, or termination for cause.
  • I resequence work fast. I shift crews to open areas, stack work where possible, and avoid idle time.
  • I fill labor gaps at once. That may mean labor-only support, GC self-perform, or a replacement sub through a short bid process.
  • I keep owner and lender updates factual. I report milestone impact, crew status, and the revised recovery schedule.
  • I build the claim file early. The first 72 hours of logs, photos, notices, and schedule updates often shape bond or SDI recovery.
  • I treat default response as preplanning, not guesswork. Backup trade lists, step-in rights, and tighter prequalification make recovery easier.

A fast response does two things at once: it cuts schedule damage and puts the project team in a better position if cost recovery turns into a dispute.

The rest of the article walks through that response step by step.

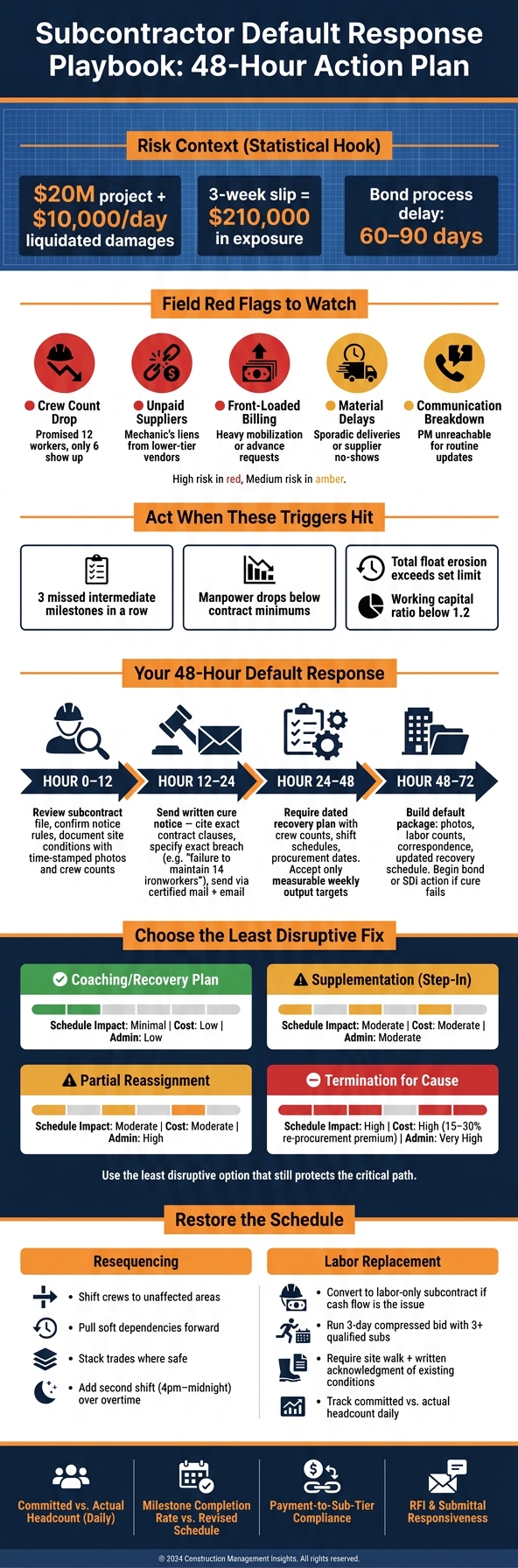

Subcontractor Default Response Playbook: 48-Hour Action Plan

Subcontractor Default Response Playbook: 48-Hour Action Plan

9 Steps to Managing Subcontractor Default Risk with Jim Budwell, Dir. of SDI Risk Mgmt. at CRP

Define Default and Spot Schedule Exposure Early

Not every performance problem is a default. Treating every delay the same way gets expensive fast.

A recoverable delay is a short-term problem, like a brief cash flow squeeze or a minor material delay, that a subcontractor can fix with a solid recovery plan inside a set cure window. In most cases, that window is 48 to 72 hours after written notice. A default is different. It starts when the subcontractor misses that cure deadline, which gives the general contractor the contract right to terminate for cause or use step-in rights [4][1]. This isn't only about legal language. It's about stopping one trade's problem from eating up float on the critical path.

Common default triggers include abandonment of work, repeated failure to keep the required crew size on site, insolvency, or failure to pay sub-tier suppliers [4][1]. In many cases, those problems show up before the work fully stops. As Michael R. Morano notes:

"A telltale sign that a subcontractor is experiencing financial distress is that suppliers and other downstream subcontractors will have made non-payment claims and filed mechanic's liens." [6]

Once you draw a clear line between delay and default, the next move is figuring out whether the subcontractor needs coaching, supplementation, or termination.

Watch for Field Warning Signs Before the Trade Collapses

The first sign in the field is often a drop in manpower. If a subcontractor promised 12 workers and only 6 show up, there's a good chance they're moving labor to cover cash problems on another job [4].

The warning signs don't stop there. Spotty material deliveries or supplier no-shows can point to credit trouble. Late submittals, missing insurance certificates, or lien waivers that never show up can point to admin failure. Front-loaded pay applications, such as heavy mobilization billing or vague "pre-purchase" line items, often suggest the subcontractor is under money pressure. A working capital ratio below 1.2 is one of the strongest metrics for spotting default risk [4].

Daily logs, manpower counts, and production reports matter here. They build the record needed to support cure notices, supplementation, or bond action. And the logs from the first 72 hours often become the strongest proof in later bond or SDI actions [4].

Set Escalation Triggers Tied to Milestones

Vague thresholds slow people down at the worst time. It's better to set specific triggers ahead of time, such as:

  • Three missed intermediate milestones in a row
  • Manpower dropping below contract minimums
  • Total float erosion passing a set limit [4]

These recorded triggers do two jobs. First, they push the team to act early, before the issue hits the critical path. Second, they create a clean legal record to support a prompt cure notice, supplementation step, or bond claim. A subcontract that relies on loose wording like "reasonable time" instead of a set 48- to 72-hour cure period leaves too much room for argument during a schedule crisis [4][1].

Warning Sign Practical Field Indicator Risk Level
Crew Count Drop Subcontractor committed 12 workers; 6 showed up High
Unpaid Suppliers Mechanic's liens filed by lower-tier vendors High
Front-Loaded Billing Heavy mobilization charges or advance requests High
Material Delays Sporadic deliveries or supplier no-shows Medium
Communication Breakdown PM or principal unreachable for routine updates Medium

When one of these triggers hits, that's the moment to shift from watching the problem to issuing a cure notice and starting recovery action.

Start Your Default Response Before Total Failure Occurs

Once a trigger is confirmed, move within 48 hours. Review the subcontract file, confirm the notice rules, and document site conditions. In that same 48-hour window, gather time-stamped photos, log crew and equipment counts, and save progress reports. That record gives you room to send notice and start recovery without burning more time.

Then send written notice. A cure notice needs to be exact. Don’t write “improve performance.” Write something like “failure to maintain 14 ironworkers required by the subcontract.” It should point to the exact contract clauses that were breached, use the delivery method the contract requires, and reserve your rights to supplement labor, back-charge costs, or terminate for cause [1][4]. In most cases, that means certified mail plus email so you also have an immediate timestamp. Miss those formal steps, and any later wrongful-termination defense gets harder to support.

During the 48- to 72-hour cure window, require a dated recovery plan. It should spell out crew counts, shift schedules, and procurement dates. And don’t accept fuzzy promises. Tie acceptance to measurable weekly output instead [1].

Compare Coaching, Supplementation, Partial Reassignment, and Termination

The right move depends on three things: how much float is left, how critical the scope is, and whether the subcontractor is actually getting back on track.

Response Option Schedule Impact Cost Impact Administrative Burden Owner Confidence Impact
Coaching/Recovery Plan Minimal if the issue is temporary Low; internal staff time only Low High; shows proactive management
Supplementation (Step-In) Moderate; prevents idle time Moderate; back-charges for added labor Moderate Stable; work continues on site
Partial Reassignment Moderate; protects critical path Moderate; GC absorbs procurement risk High; requires contract adjustments Moderate; addresses a specific bottleneck
Termination for Cause High; can stall the schedule until replacement work is in place High; re-procurement premium and possible liquidated damages Very High Low; signals major project distress

Use the least disruptive option that still protects the critical path. In plain terms, don’t swing a sledgehammer if a wrench will do.

The next move is to restore labor and scope without creating idle time.

Use Prebuilt Backup Trade and Staffing Plans

The fastest recoveries happen when the team isn’t starting from zero. The contract should already include step-in rights that allow the GC to bring in replacement labor and back-charge the defaulted subcontractor if needed [4]. Keep prequalified backup trades, superintendents, and schedulers ready to go.

With notice sent and backup labor lined up, the next schedule recovery move is resequencing the work.

Recover the Schedule Through Resequencing and Manpower Replacement

With notice out and backup help lined up, the next job is simple: keep crews moving. Every idle hour pushes the critical path farther out. That means resequencing and labor replacement need to begin right away.

Resequence Work to Protect the Critical Path

Rebuild the recovery schedule from today forward using actual site conditions and the crews you have on hand [7]. Then find the new critical path. That matters because fast-tracking or adding labor can move it, sometimes in ways people miss at first glance. After each big change, check the sequence again [5].

Look for soft dependencies. These are tasks lined up for convenience, not because one task physically has to wait for another. Those are often the best places to overlap work and fast-track the schedule [5]. Hard dependencies are different. You can’t cheat concrete cure time, for example, and trying to do so usually backfires.

Resequencing Strategy Schedule Gain Safety/Quality Risk Coordination Complexity
Shifting to Unaffected Areas Medium Low Medium
Pulling Work Forward Medium Medium (prerequisite risk) Low
Parallel Work / Trade Stacking High High (congestion) High
Off-Hours / Weekend Work High Medium (fatigue) Low
GC Self-Perform High Low Medium

Overtime looks good on paper, but the math gets ugly fast. A 50-hour overtime week may produce only about 48 productive hours in week one and close to 40 by week four [5]. That drop-off is why a second shift, like 4 p.m. to midnight, often works better than stretching the same crew deeper into each day [5].

Failed fast-tracking can cost more time than it saves.

If the new sequence still leaves a labor hole, fill it at once.

Replace or Supplement Labor Fast Enough to Avoid Idle Time

Once the sequence is reset, deal with the crew gap right away. Resequencing buys time. Replacement labor makes that time count.

If the defaulting subcontractor still has a working crew but is choking on cash flow and material buying, one option is to convert the subcontract into a labor-only deal so the GC buys materials directly [3]. It’s a practical move. The crew stays active while purchasing gets sorted out.

If a full replacement is needed, run a compressed three-day bid process with at least three qualified subs [4]. Require site walks. Also get written acknowledgment of existing conditions so the new sub can’t later argue over inherited work [4]. In a crisis, expect a 15% to 30% premium over the original contract value [4].

As the replacement crew mobilizes, switch to daily 15-minute standups centered on the next recovery milestone [7][5]. Back that up with daily site reports and a live constraint log that shows start dates, durations, and blockers [8][1]. Every trade should know the updated plan before crews show up in the morning. Also track committed headcount against actual headcount each day so you can spot production shortfalls before they land on the critical path [4].

Manage Replacement, Surety, and Owner Communication to Close the Recovery Gap

With the field sequence reset, the next job is to lock in the replacement scope, the surety route, and owner notices. As crews get resequenced and replacement labor comes in, the contract, surety, and notice work has to move at the same pace. This is not a separate admin step. It is the next part of the same recovery plan.

Source the Replacement Subcontractor and Coordinate Bond or SDI Actions

Before signing a replacement subcontract, do a quick scope audit. Split the remaining work into three buckets: unfinished work, defective work that needs correction, and warranty obligations [9]. That audit shapes the replacement scope and helps cut down later cost fights. Every bidder should also give written acknowledgment of existing site conditions so they can't later argue they inherited hidden defects [4].

For bonded work under AIA A312, the notice sequence matters. Send the 15-day notice asking for a conference, then wait at least 20 days before making a formal default declaration [9]. After that, the surety can pick its remedy: tender, takeover, or buyout [9]. With tender, the surety finds a replacement, pays the cost gap, and moves the contract straight to the owner [9].

SDI works differently. It lets the GC declare default and re-procure without waiting for a surety review [4][10]. The catch is cost sharing. The GC takes on a self-insured retention and copay, often 10% to 20% of remediation costs [10].

No matter which coverage path applies, build the default package within the first 72 hours. That package should include:

  • Time-stamped photos
  • Daily labor counts
  • Correspondence tied to specific contract clauses
  • An updated recovery schedule [1][4]

Use that updated recovery schedule to drive every notice, meeting, and manpower report.

Control the Message With Formal Reports and Recovery Updates

Once the replacement path is set, use the revised recovery schedule as the baseline for every notice and update. Owners and lenders want facts, not reassurance. Give them specific milestone impacts, the cause of the disruption, the trades affected, and a resourced recovery schedule tied to revised milestone dates [4]. In every upstream communication, include an express reservation of rights to seek schedule relief and related impacts [2].

Channel Audience Frequency Level of Detail Documentation Value
Formal Notice of Delay Owner, Lender, Legal Immediate (upon event) High - contractual/legal Critical for claims preservation
OAC Meetings Owner, Architect, GC Weekly Medium - milestone focus High for project history
Recovery Schedule Update Owner, Internal Leadership Weekly/bi-weekly High - critical path logic Essential for LD mitigation
Daily Manpower Reports Field Team, GC Daily High - granular crew counts Supports cost-to-complete claims

Move all project communication into formal written notices and use a direct subject line: "Notice of Subcontractor Default: [Trade Name]" [1]. Keep the language neutral and factual. Think incident report, not vent session.

Track four recovery metrics through closeout: committed crew versus actual headcount, milestone completion rate against the revised schedule, payment-to-sub-tier compliance, and RFI and submittal responsiveness from the replacement team [4].

"The contractor must preserve and assert rights in both contractual directions." - John A. Gambill and Eric L. Singer, Taft Stettinius & Hollister [2]

Conclusion: Build Future Resilience Into Your Subcontractor and Hiring Strategy

The big takeaway is simple: recovery works best when the project is set up to take a hit and keep moving.

Subcontractor default isn’t just bad luck. It’s usually a systems issue. And the fastest recoveries almost always come from systems put in place before anything goes wrong.

That work starts before award. Tiered prequalification, weekly crew verification, and milestone-based pay help spot risk early, before it turns into schedule damage.

It also helps to keep replacement capacity lined up ahead of time. A vetted backup list for high-risk scopes lets replacement mobilization begin fast and helps control cost.

On mission-critical projects, experienced project managers matter just as much as backup trades. Specialized recruiting for construction project managers can help source those leaders, so your team can spot default risk early and run the recovery playbook without losing time. On mission-critical jobs, the right managers can keep one subcontractor failure from turning into a schedule failure.

FAQs

How do I tell delay from default?

Delay is a performance issue. Default is a basic contract breach, and it often points to insolvency or an inability to do the work.

A delay can come from a short-term setback, like supply chain problems or poor scheduling. Default usually shows up in more serious ways: crews leaving the job, suppliers going unpaid, or demands for inflated early payments. It also helps to watch for chronic labor shortages on site and sudden signs of financial trouble.

What should happen in the first 48 hours?

In the first 48 hours after a potential subcontractor default, the goal is simple: stabilize the jobsite and get the facts straight before you do anything else.

Start by documenting what’s happening on site. Take photos and videos. Log manpower, equipment, and weather conditions. If this turns into a dispute later, those details can matter a lot.

Next, compare what was actually delivered against the subcontractor’s contract duties. That helps you see where the gaps are and whether the issue is hitting the critical path or creating knock-on delays.

At the same time, secure the site, stop any unsafe work, and shift all communication to formal written notices. Verbal updates are easy to dispute. Written records give you a clear paper trail.

When should I replace a failing subcontractor?

Replace a subcontractor only as a last resort.

Start by trying to fix the problem with them. Meet face to face, lay out the issue clearly, and look at practical options. That might mean adding people to their crew, taking some tasks back in-house, or moving the deal to a labor-only setup.

Go to replacement only if those steps don’t work, a formal default notice has been issued, and the required cure period has run out. Before termination, make sure the default is documented and that the contract clearly permits termination, re-procurement, or step-in remedies.

Related Blog Posts

Keywords:
subcontractor default, schedule recovery, construction project management, cure notice, step-in rights, resequencing, backup trades
Free Download

Data Center Construction Labor Trends in 2026

Thank you! Your submission has been received!
Oops! Something went wrong while submitting the form.

More mission critical construction news

Remote and Hybrid Data Center Project Manager Roles: What Works and What Doesn't
June 22, 2026

Remote and Hybrid Data Center Project Manager Roles: What Works and What Doesn't

When to use remote, hybrid, or site-based data center PMs—match presence to project phase, travel, and commissioning risk.
The Data Center Construction Project Manager's Punchlist Strategy Before RFS
June 22, 2026

The Data Center Construction Project Manager's Punchlist Strategy Before RFS

Plan punchlists backward from the RFS date, prioritize A/B/C blockers, tie defects to commissioning, docs, and named owners to protect turnover.
What Construction Project Managers Wish Owners Knew About Float and Buffer
June 22, 2026

What Construction Project Managers Wish Owners Knew About Float and Buffer

Owners must distinguish CPM-created float from intentional buffers to protect milestones, avoid overtime, and reduce disputes.
Data Center Project Manager Career Paths: From Coordinator to Program Lead
June 22, 2026

Data Center Project Manager Career Paths: From Coordinator to Program Lead

Career progression for data center project managers—from coordinator to program lead—skills, pay ranges, commissioning, and top US markets.
