If I’m choosing between hyperscale and colocation work, I’d look at the job setting first, not the title. In a U.S. market that reached $77.7 billion in new data center construction starts in 2025, the split is clear: hyperscale fits people who do best on large, repeatable campus builds, while colocation fits people who can manage live sites, tenant demands, and frequent schedule resets.
Here’s the short version:

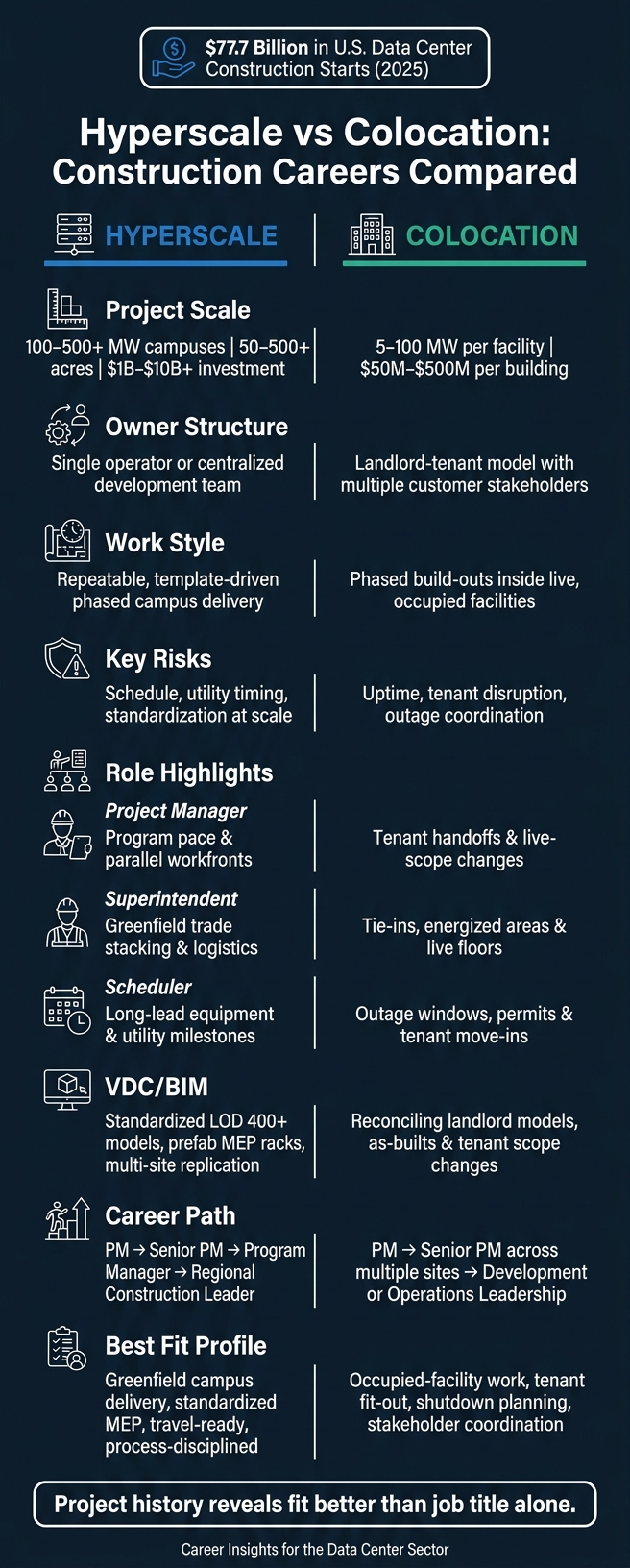

Hyperscale vs Colocation Data Center Careers: Side-by-Side Breakdown
My main takeaway: project history tells me more than a job title. If someone has greenfield campus delivery, that points to hyperscale. If they’ve handled occupied facilities, shutdown planning, and tenant fit-outs, that points to colocation.
That’s the lens I’d use before reading the rest of the article.
Before looking at individual roles, it helps to see what each setting is like day to day. The gap between hyperscale and colocation isn't just project size. It changes how teams plan work, set sequences, and run the job every single day.
This difference shows up fast in the field. A single campus can cover 50 to 500+ acres, with multiple buildings rising in overlapping phases over 24–36 months or longer before the cycle starts again in another market [2][10]. The work is built for repeat use. Teams rely on the same equipment layouts, procurement packages, and execution sequences across buildings and even across campuses.
That's what drives the speed. Once the template is locked, the field team leans hard on production control, logistics, and utility-linked milestones. Utility readiness is often on the critical path. Hyperscalers are now locking in transmission infrastructure and grid upgrades 3 to 5 years before public project announcements for gigawatt-scale AI campuses [8]. For construction teams, that means utility coordination starts long before the first shovel hits the ground. If that work slips, the delay can hit the whole program.
In major U.S. hyperscale markets like Northern Virginia, Phoenix, Dallas-Fort Worth, Columbus, and Atlanta, field teams often number in the thousands, with multiple superintendents, scheduling staff, and commissioning teams working at the same time [3][4]. For program-based builders, travel between campus phases - or even across state lines - is just part of the job.
In colocation, live-site and tenant constraints shape almost everything. These facilities are often already producing revenue when new phases start, so construction teams have to work around active tenants, live electrical systems, and strict uptime SLAs [5][7]. One floor might still be under construction while another is fully live and serving customers.
That changes the mindset. Outage planning, method-of-procedure (MOP) documentation, noise and dust controls, and access restrictions are standard practice. The goal isn't just speed. It's speed without disruption. Tenant move-in dates and customer go-live windows drive the schedule, but those dates can move based on customer readiness. When that happens, the construction team has to resequence work without affecting anyone already online [5][6][9].
These are the kinds of jobs that reward teams who can reshuffle work fast while keeping live operations steady. And that pressure shapes what project managers, superintendents, schedulers, commissioning managers, and VDC teams are expected to handle.
The same job title can mean two pretty different jobs depending on the project type.
In hyperscale, the work leans on repetition. Teams use a proven playbook, repeat the same packages across buildings, and push for steady output. In colocation, the work is more fluid. Teams juggle base-building work, tenant handoffs, live-site limits, and scope changes that can land in the middle of construction.
You can see that split most clearly in delivery leadership, commissioning, and VDC coordination.
Project managers in hyperscale usually run a repeatable delivery program. The design is mostly set, procurement packages repeat across buildings, and the main job is keeping parallel workfronts lined up and moving fast.
In colocation, that same PM title carries a different weight. The PM has to balance base-build milestones with tenant-specific handoffs, manage tenant-driven deadlines, and deal with scope changes while the job is already underway.
Superintendents follow the same pattern. Hyperscale supers oversee large greenfield trade stacks with a heavy focus on productivity, site logistics, and sequence control. Colocation supers spend more time coordinating tie-ins, planning work around occupied and energized areas, and protecting active floors from disruption.
Schedulers also work from different playbooks. In hyperscale, schedulers manage CPM logic tied to mitigating schedule risks from long-lead equipment and utility milestones. In colocation, they often resequence around tenant moves, outage windows, permit limits, and live-site conditions.
The contrast gets even sharper in commissioning, where turnover pressure and outage risk can change the whole job.
In hyperscale, commissioning managers lead large integrated systems tests across standardized modules. They prove redundancy, validate high-capacity electrical and mechanical performance, and run repeatable turnover procedures across many megawatts of load.[17][18]
In colocation, the commissioning manager acts as the owner-side lead for acceptance criteria in tenant-ready facilities.[19] That means coordinating with operations teams, tenants, and construction teams while protecting uptime. Outage risk is always in the background, so tenant communication is part of the role, not an extra task.
MEP specialists show the same divide. In hyperscale, they go deep on high-capacity power distribution, switchgear, UPS systems, and large cooling systems. They also often work with prefabricated MEP racks and skids that sit at the center of the campus delivery model.[11][12][13]
In colocation, those same specialists need to work inside existing-building limits and respond to tenant-specific fit-out needs. It’s less about repeating one setup and more about making the system work inside tighter physical and operating limits.
You see the same thing in VDC. The model strategy changes a lot depending on whether the project repeats the same module or keeps shifting in the field.
In hyperscale, VDC is a production job. Models are built to repeat: the same standards, the same clash priorities, and the same prefabrication coordination logic used across buildings and sites.[1][14][15] Teams produce fabrication-ready models, often at LOD 400+, to support prefab MEP racks, modular data halls, and steady field execution at scale.[11][12][13][16]
In colocation, VDC work is less about replication and more about reconciliation. Teams have to line up landlord models, tenant scope changes, and field-verified as-builts that may not match the original design. Clash priorities can shift fast as existing conditions show up in the field, so quick revision coordination becomes a core part of the job.
Those role gaps affect how employers screen people and how they decide who moves up. Delivery proof matters more than title alone. A Project Manager can face one kind of screen in hyperscale and a very different one in colocation, because the work itself, the risk, and the pace are not the same.
Hyperscale employers usually screen hard for scale experience. Some U.S. general contractors now expect candidates for MEP Project Manager roles to have delivered at least one hyperscale data center from start to finish. They treat that as a hiring requirement, not just a rough marker tied to years of experience.[20]
They also look for strong MEP and power knowledge, along with familiarity with commissioning and standardized owner controls. On top of that, employers tend to care about disciplined process, clean reporting, fast escalation, and willingness to travel. That last point matters more than many people expect. A lot of superintendent and manager roles are set up as traveling positions tied to national campus programs.
Colocation employers usually want people who have worked in occupied facilities, handled tenant fit-out or white space build-outs, and coordinated work carefully around live operations. Experience in hospitals, pharma, or retrofit jobs also carries weight because those settings demand tight uptime discipline and close stakeholder control.
For live data center work, MEP managers are also expected to understand and enforce LOTO (lockout/tagout) procedures and read one-line diagrams with ease. The stakeholder mix matters too. Candidates who can show they have coordinated with operators, tenants, and design teams on the same project often stand out.
These hiring patterns also shape long-term career growth. In hyperscale, careers usually move up a program ladder: PM to Senior PM to Program Manager to Regional Leader. As contractors and owners keep building long-term campus portfolios, those structured paths have become more common. They tend to reward people who can run the same playbook across multiple sites without losing control of schedule, quality, or reporting.
In colocation, careers usually spread across more facilities, owners, and operating teams. Advancement is often tied to range, relationships, and the ability to move between development and live-site demands without missing a beat.
That hiring logic is what separates a strong campus-program hire from a strong portfolio hire.
The market is tight, so fit matters more than ever. In that kind of market, a bad hire can cost a lot, and the right fit can change the whole project.
The split is pretty simple. Hyperscale tends to reward scale, standardization, and strong program discipline. Colocation tends to reward phased delivery, live-site discipline, and tight stakeholder control. You see that gap most clearly in a candidate’s project history.
Project history matters more than title. That’s the standard both candidates and hiring teams should use.
For candidates, the main filters are scale, live-site exposure, travel tolerance, and long-term path. Greenfield campus work and standardized MEP delivery usually point to hyperscale. Brownfield upgrades, tenant coordination, and shutdown planning usually point to colocation.
For hiring teams, start by screening for project environment. Then test for direct delivery history across PM, superintendent, scheduler, commissioning, MEP, and VDC roles. Get the project environment match right first. Titles come after that.
Hyperscale projects usually pay more than colocation work. The reason is pretty simple: they come with bigger budgets, tighter timelines, and more delivery risk.
At the senior level, base pay often tops out at about $155,000 in enterprise, $180,000 in colocation, and $215,000+ in hyperscale. On top of that, hyperscale roles may include incentives, per diem, and completion bonuses.
Yes, but you’ll need to adjust to some big differences in scale, team setup, and technical demands.
Hyperscale work is usually more standardized and driven by set programs, while colocation puts more weight on flexibility, phased fit-outs, and live-environment SLAs. To make that move, show your experience with large-scale coordination, high-density power and cooling, and rigorous commissioning. Hyperscale hiring often leans toward deep technical specialization.
Think about where you do your best work: structure, scale, and technical depth or flexibility and tenant-facing operations.
Hyperscale tends to fit people who like large, standardized programs and deep specialization. Colocation tends to fit people who do well in agile teams, tenant coordination, phased turnover, and live, multi-tenant settings.
Put simply, hyperscale rewards repeatable infrastructure expertise. Colocation rewards flexible, customer-facing delivery.
