October 1, 2026

Mountain States Data Center Jobs 2026: 8 Markets

By:
Dallas Bond

Phoenix tops my October 1, 2026, hiring assessment - but I’d confirm permits, power dates, and project phases before adding staff in any market. My final order is Phoenix, Reno, Salt Lake City, Denver, Las Vegas, Albuquerque, Boise, and Cheyenne.

Hiring for a data center program? Our data center construction recruiters place delivery, MEP, and commissioning talent on hyperscale schedules.

I compare project demand (35%), labor depth (30%), pay pressure (20%), and near-term hiring urgency (15%). This is a planning guide, not a verified statistical ranking. A large project pipeline doesn’t mean qualified workers are available.

Quick Comparison

Market Main hiring signal Main staffing hurdle
Phoenix Largest project pipeline Competition from chip plants and other data centers
Reno Campus construction around TRIC Small local specialist pool
Salt Lake City Active construction and campus expansion MEP, controls, and commissioning gaps
Denver Projects moving through separate phases Permitting limits and power delays
Las Vegas Approved projects and expansion plans Specialist shortages and uncertain start dates
Albuquerque A few anchor projects Limited local data-center leadership
Boise Micron-led demand plus smaller data-center work Competition for fab-trained specialists
Cheyenne Power-heavy campuses Thin labor supply, travel costs, and winter delays

My hiring approach is simple: secure project and MEP leaders first, then add crews as work is confirmed. I’d compare salary or hourly pay separately from lodging, travel, overtime, and retention payments - and check candidates’ completed commissioning work, not just their job titles.

The rule across all eight markets: <u>hire for confirmed work, not announced capacity</u>.

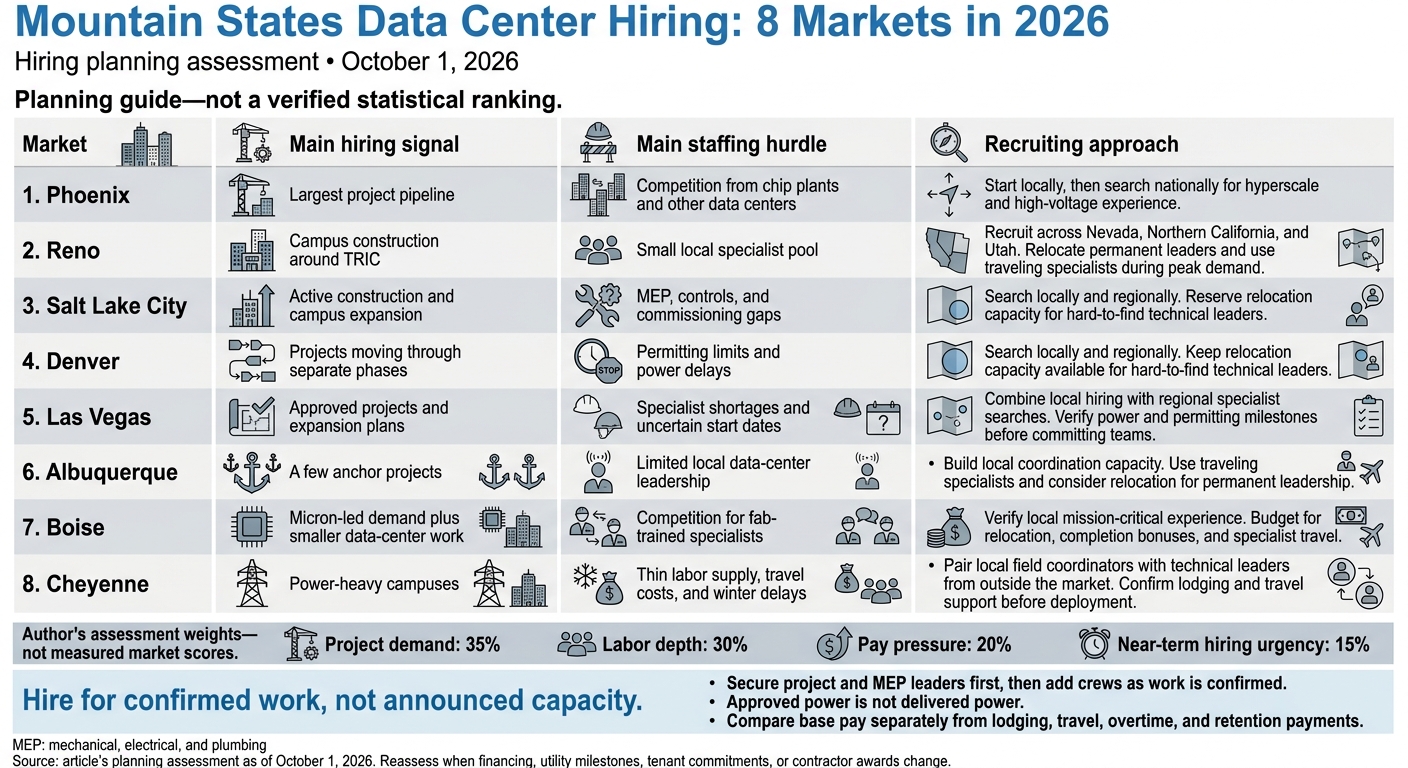

Mountain States Data Center Hiring: 8 Markets in 2026

Mountain States Data Center Hiring: 8 Markets in 2026

1. Phoenix

Project Volume

Phoenix leads the region in project volume, but staffing remains difficult. CBRE reported 256 MW of absorption across four projects in H2 2025. Major projects in Mesa, Phoenix, Avondale, Goodyear, and Glendale were expected to finish within the following 12 months.[7] A 2026 market profile estimated 2,381 MW operating and 2,978 MW planned or under construction in Maricopa County, though the total includes unconfirmed starts.[5]

Executable work versus proposed demand: Aligned’s Glendale campus broke ground in April 2025, with its initial 72-MW phase under construction.[4] By contrast, SRP received 7.2 GW of requests from 24 applicants, but only three remained after its February 2026 deposit deadline.[4]

Visible fieldwork supports hiring now. Proposed capacity still depends on deposits, interconnection, and notice-to-proceed. The project pipeline increases hiring demand, but it doesn't guarantee workers are available.

Labor Depth

Phoenix-Mesa-Chandler had about 21,280 electricians in May 2024.[8] That's a large labor pool - not a ready supply of data-center specialists. Screen separately for medium-voltage, UPS, controls, and phased turnover experience.

Local hiring makes sense for general trades and project staff. For MEP managers, commissioning specialists, and hyperscale project executives and project managers, expect to recruit beyond the metro.

Pay Pressure

Large industrial builds across the metro push wages beyond standard electrician benchmarks. May 2025 median electrician pay was $29.43 an hour, with the 90th percentile above $41.73.[6]

A 2026 staffing report projected 40,000 construction jobs over four years at TSMC’s north Phoenix campus and more than 11,000 workers on-site at Intel’s Ocotillo expansion.[9]

These projects compete for electrical, mechanical, controls, and senior management talent. Compare base pay separately from housing, travel, and milestone retention bonuses. Recruiting pressure tends to show up first in leadership, electrical, and commissioning roles.

Hiring Sequence

Hire senior project managers, estimators, schedulers, utility coordinators, and safety leaders six to 12 months before mobilization, once project milestones are firm enough to support hiring. Add superintendents and foremen three to six months before site work. Secure MEP and commissioning leaders before craft hiring ramps up.

For summer work, plan early shifts, shade, hydration, acclimatization, and schedule buffers. Bringing safety and field leaders on board early reduces heat-related scheduling risk. Stage hiring when power dates remain uncertain.

Hiring for a mission-critical build? Get a pre-qualified shortlist.

iRecruit.co specializes in construction recruiting for data center, energy, and advanced-manufacturing projects — project managers, MEP coordinators, commissioning leads, and more. We pre-screen every candidate so only qualified professionals reach your hiring team.

Get Started

Success-based pricing · 90-day replacement credit · No upfront fee on single roles

2. Reno

Project Volume

Reno’s main hiring demand centers on Storey County’s Tahoe-Reno Industrial Center (TRIC). Six area data centers were active in May 2026, including Webb and Oppidan projects under construction.[10][12][13]

That cluster adds demand, but the local labor pool still sets the pace of hiring.

Labor Depth

Compared with Phoenix, Reno relies more on regional recruiting and travel-ready hires than on local candidate volume. Search Reno-Sparks, Fernley, Carson City, and TRIC separately, then extend the search to Sacramento and the Bay Area.

Clustered projects put pressure on a smaller pool of experienced electrical superintendents, MEP project managers, controls specialists, and commissioning leaders. Confirm the site, shift, start date, and travel terms before counting a candidate as available. Check supply through contractor rosters, union halls, and interviews. Living nearby doesn’t mean someone is available to work.

Pay Pressure

Reno’s all-occupation wage is not a mission-critical benchmark.[11] Use dated, role-specific offers that separate base pay from overtime, per diem, mileage, lodging, travel time, bonuses, shift premiums, completion incentives, and relocation.

For Sacramento and Bay Area candidates, spell out weekly travel, rotations, or relocation. Don’t assume they’ll commute daily.

Overlapping campus schedules can tighten pay for scarce specialists.

Hiring Sequence

With a thinner labor pool and power timing that can change, hire leadership before field crews. Prequalify project executives, project managers, estimators, schedulers, and leaders in procurement, permitting, utilities, and civil/sitework six to nine months before mobilization. Tie start dates to permits, utility commitments, and notice-to-proceed.

Add superintendents and managers for safety, survey, logistics, and earthwork next. Bring in MEP superintendents, foremen, and controls specialists before installation, and secure commissioning teams before turnover.

3. Salt Lake City

Project Volume

A mid-2025 assessment counted 157 MW operating, 228 MW under construction, and 885 MW planned in the Salt Lake City market.[15] April 2026 reporting listed 2,600 MW under construction statewide, but that figure isn’t a metro-level comparison.[16]

Keep active phases separate from announced capacity, and verify utility commitments before forecasting headcount. For staffing, capacity counts only when projects are moving toward labor release and creating active work within the recruiting area.

Meta’s Eagle Mountain campus began construction in 2018 and opened its first data center in 2021. By September 2026, Utah investment tied to the expansion exceeded $3 billion, with more than 1,200 construction jobs at peak.[19][20]

Labor Depth

Recruit across West Jordan, Midvale, Bluffdale, and Eagle Mountain - not just Salt Lake City. Utah has a broad construction workforce, but reported gaps include medium-voltage electricians, chilled-water pipefitters, controls technicians, and commissioning specialists.[14]

Regional trades can support general construction, but senior MEP managers and specialists with completed mission-critical work will still require outside recruiting.

Plan to recruit beyond the core metro for specialist roles, particularly MEP and commissioning positions.

Pay Pressure

Salt Lake City-Murray’s May 2025 average wage was $34.45 an hour, compared with $33.54 nationally. That’s a general labor-market indicator, not a data center pay rate.[18]

A 2026 project manager listing advertised $113,500–$170,300 annually.[17]

The strongest premiums should sit with proven electrical, controls, and commissioning experience.

Budget for relocation and rotations separately from base salary.

Hiring Sequence

With shortages concentrated in specialist roles, secure project management, estimating, scheduling, procurement, and MEP leadership first. Add utility and medium-voltage supervision before field electrical work.[14]

Start commissioning planning before equipment installation. Before committing to start dates, check power readiness, equipment dates, and candidates’ turnover experience.

4. Denver

Project Volume

JLL’s midyear 2025 report counted 36 MW under construction and 304 MW planned. That’s a project pipeline - not a guaranteed workload for 2026.[30]

Denver has an active pipeline led by CoreSite’s DE3 campus, PCL’s 22.5-MW project, and QTS’s Aurora campus.[27][22][23]

Denver adopted a one-year moratorium on new data-center development within city limits in May 2026. Jefferson County imposed a separate temporary moratorium.[21][24] Power availability adds another hurdle: Xcel Energy reported 5.8 GW of pending data-center electricity applications, compared with about 6.2 GW of existing generating capacity in Colorado.[23]

Developers want facilities running within 18 to 24 months, but new generation and transmission can take three to five years.[26] Tie hiring plans to permits and utility milestones.

That makes Denver a timing market, not a headline market.

Labor Depth

Denver has projects in the pipeline, but specialist staffing is a tighter squeeze. The city averaged 19,900 building-construction workers per month in H1 2025 - a deep labor base with a smaller pool of mission-critical talent.[29] Recruit managers locally, and extend specialist searches across Colorado and neighboring states.

The tightest gaps will be in electricians, low-voltage and controls technicians, pipefitters, sheet-metal workers, HVAC specialists, and commissioning technicians.

Pay Pressure

Wage pressure tends to hit scarce specialists first. The sources do not provide a reliable 2026 Denver salary table. Private mission-critical projects may need to pay above prevailing wage to attract experienced workers. Denver’s 2025 heavy-construction wage decision sets a compliance floor for covered work.[28]

Pay pressure will be highest in senior project managers, MEP and electrical project managers, commissioning leads, controls specialists, superintendents, and high-voltage and critical-power staff.

For scarce field roles, budget travel, per diem, completion bonuses, and retention incentives separately.

Hiring Sequence

Build staffing around each project phase:

  • Preconstruction: Secure executive and project management, estimating, scheduling, procurement, design/BIM, and permitting or utility-coordination leads.
  • Early construction: Add MEP management, electrical and mechanical superintendents, quality, safety, logistics, and commissioning planning.
  • Peak installation: Scale up trade foremen and electrical, controls, mechanical, and equipment crews.
  • Turnover: Have commissioning, testing and balancing, controls engineering, electrical testing, documentation, and owner-training staff ready.[22][25][27]

5. Albuquerque

Project Volume

Albuquerque lands in the middle of the ranking because hiring depends on a few verifiable projects, rather than a broad wave of campus construction.

A July 2026 project report describes Connect Albuquerque at Westpointe 40 Business Park as a roughly 98,695-square-foot, 10-MW project with $30.7 million in permitted construction value. That figure includes fit-out or expansion work beyond core and shell.[34]

A separate tracker lists roughly $80 million and a winter 2025 completion. The mixed scope makes that estimate a weak signal for 2026 hiring.[36]

Treat this as an anchor-project market, not a high-volume hiring market.

Labor Depth

Sandia National Laboratories and Kirtland Air Force Base draw from overlapping technical talent pools.[31][32][37]

Sandia/Kirtland spillover offers transferable laboratory, defense, and utility experience - not ready-made data-center leadership. Recruit outside Albuquerque for senior data-center managers and commissioning specialists.

Look beyond job titles. Screen candidates for power-up sequencing, MEP coordination, and turnover documentation.

That makes local hiring workable for general construction, but scarce technical roles still need broader recruiting.

Pay Pressure

The BLS release cited in May 2025 reported Albuquerque’s all-occupation average wage at $31.00 per hour, compared with $33.54 nationally.[33] A construction-cost analysis using May 2025 occupational estimates put construction supervisors at approximately $36.09 per hour.[35]

These figures are labor-market benchmarks only. Budget for relocation, lodging, travel rotations, and retention payments separately from base pay.

Hiring Sequence

Time hiring to the project phase, not the announcement date.

During preconstruction, secure senior project management, estimating, scheduling, and utility coordination. Bring in MEP and commissioning leaders before major equipment installation so they can shape procurement and testing plans.

As installation moves ahead, add electrical and mechanical supervision, controls, and quality staff. Secure commissioning and turnover leads before energization.

For a 10-MW project, recruit scarce leaders months before installation starts.[34]

6. Boise

Project Volume

Boise ranks sixth, with Micron driving most of the workload and data centers adding less demand. Micron plans to invest up to $50 billion across two Boise fabs, targeting first-fab DRAM production in mid-2027 and second-fab production in late 2028.[38][39] ValorC3’s $21 million, 10-MW expansion is expected to finish in 2027.[42]

For 2026 hiring, treat Micron as the main source of work and ValorC3 as a smaller source of data-center demand. Rhea Data’s 600-MW proposal remains uncommitted, so don’t count it toward 2026 hiring needs.[41] This project mix shifts hiring away from general construction and toward specialist fab support.

Labor Depth

BLS reported 26,200 construction and extraction jobs in the Boise City metropolitan area in May 2025, including about 2,510 electricians.[40] Micron’s first fab reached blowdown in spring 2026, tightening demand for controls, instrumentation, process-utility, and cleanroom specialists.[38]

When screening candidates from adjacent industries, look for hands-on tool-installation and high-purity piping experience, not just commercial MEP work. Gaps in these specialties will push pay up faster than the metro average.

Pay Pressure

May 2025 BLS averages for construction and extraction occupations were $28.58 per hour in the Boise City metropolitan area, compared with $31.42 nationally. Local electricians averaged $31.67 per hour.[40] These figures are occupational baselines - not 2026 specialist offers.

Set a separate budget for scarce fab-experienced managers. Compare local, relocating, and traveling candidates by total cost, and tie retention incentives to cleanroom handover and equipment-installation milestones.

Hiring Sequence

Follow fab milestones, not announcement dates, when planning hires.[38][39]

  • First-fab installation and turnover: Hire project executives and senior project managers first, then process-utility managers and controls leads. Secure commissioning leaders before turnover.
  • Second-fab preparation: Secure estimating, procurement, scheduling, superintendents, and general foremen before expanding installation crews.

7. Las Vegas

Project Volume

Las Vegas ranks seventh, with a large but uneven pipeline. June 2026 reporting counted more than 60 operating data centers statewide, including at least 30 in the Las Vegas Valley. It also confirmed Switch’s approval for a 56,800-square-foot facility near Warm Springs Road.[44] Switch’s proposed 486,250-square-foot Core 2.0 Phase 1 had no scheduled Planning Commission or City Council review, so it was not committed 2026 work.[47]

Staff projects only after utility and planning milestones are confirmed. Treat everything else as future demand, not immediate headcount.

That makes timing, not headline square footage, the real hiring trigger.

Labor Depth

Las Vegas has moderate labor depth, but hiring remains tight. June 2025 Engineering News-Record coverage reported persistent labor shortages and staffing difficulties.[46] Hospitality projects compete hardest for electricians, HVAC workers, and project leaders. That demand includes the 384-room M Resort tower and the reported $600 million Las Vegas Convention Center Phase 3 renovation.[43][45]

Prequalify subcontractors before counting them as available. For senior MEP and commissioning hires, require references from completed data-center projects.

Scarcity shows up first in senior MEP and commissioning compensation.

Pay Pressure

Pay pressure is highest for electrical, controls, commissioning, and high-voltage roles.

Reporting points to rising labor costs and skilled-worker shortages, but it does not establish reliable 2026 Las Vegas salary ranges.[49] Include travel and lodging in the budget for MEP and commissioning talent brought in from outside the area.

Hospitality and convention work will push premiums higher for field leadership. High premiums should go to roles that control installation and turnover timing.

Hiring Sequence

Summer conditions and power timing both affect start dates, so hire by verified project phase. The proposed 432-MW Apex campus targets power delivery in 2029–2030. That makes it future staffing demand, not a reason to hire now.[48]

Hire project executives, preconstruction leaders, schedulers, and senior MEP/electrical managers first. Add field superintendents, BIM/VDC, procurement, controls, safety, quality, and commissioning leadership before mobilization; ramp foremen and craft crews by verified construction phase.

Summer highs above 110°F add heat risk to staffing and scheduling.[50]

Assign early-morning or night shifts, shaded recovery areas, acclimatization, and schedule float for summer fieldwork.

8. Cheyenne

Project Volume

Cheyenne ranks eighth because construction capacity and labor depth lag demand. In May 2026, Cheyenne had 10 operating data centers, five under construction, and nine in planning. A March 2026 report counted 12 operating facilities, five under construction, and 43 announced projects at the end of 2024.[52][55] The difference comes from how each report defines and counts projects.

Related Digital broke ground on a $1.2 billion campus in October 2025. Phase 1 covers 184,000 square feet and was due in late 2026.[51][54] Project Jade’s January 2026 approval included up to 2.7 GW of gas-fired generation.[52][55]

Construction is underway, but power readiness and phase timing determine when crews are needed. Track power infrastructure milestones alongside building progress. Approved capacity doesn’t mean power is available. Those milestones help determine when Cheyenne will need outside labor rather than local crews alone.

Labor Depth

Project Jade will likely need traveling specialists alongside a core local workforce, with peak construction staffing estimated at up to 5,000 workers.[55] Recruit regionally for high-voltage, turbine, substation, controls, and commissioning experience. Before mobilizing crews, confirm lodging and transportation to remote sites. With that mix of local and traveling workers, compensation and logistics become the next staffing constraint.

Pay Pressure

The cited material does not provide Cheyenne-specific salary or per diem ranges for 2026.

Traveling specialists will drive higher total costs through lodging, travel, overtime, and rotation premiums; compare full compensation packages, not base pay alone.

Put lodging standards, rotation schedules, and assumptions about wind, snow, and freeze delays in writing before workers accept.

Hiring Sequence

Start with power-infrastructure leads alongside project leadership, estimating, scheduling, procurement, safety, quality, and permitting staff. That timing reflects Related Digital’s late-2026 completion target and Project Jade’s initial buildings targeted for 2027.[51][54][53]

Add civil and structural superintendents as site work opens. Then bring in MEP leaders, electrical and mechanical foremen, controls specialists, and commissioning leads before installation and energization.

Build winter float into excavation, concrete, enclosure, and crane schedules. Choose superintendents who can move crews indoors when wind, snow, or freezing conditions interrupt exterior work.

Construction Demand and Workforce Supply

The market profiles above show that projects are at different stages and local labor pools vary in depth. The tables below separate active work from demand that exists only on paper.

Project Status, Timing, and Power Supply

Put active construction ahead of commitments, and commitments ahead of announcements.

Market Project scale Status and timing Power and staffing impact
Phoenix Project-specific scope unverified Confirm permits and active phases Verify utility service and energization dates before scheduling electrical crews
Reno EdgeCore Reno: 216 MW [61] Under construction; completion date pending Confirm campus power milestones before mobilizing electrical and commissioning teams
Salt Lake City No verified project scale supplied Verify active phases and schedules Obtain permit and utility records before assigning headcount
Denver CoreSite DE3: 60 MW [61] Under construction; completion date pending Confirm utility delivery before setting energization staffing
Albuquerque Project scale unverified Verify authorization Confirm utility commitments and notice to proceed before mobilization
Boise ValorC3: 10 MW; financing secured [57] Financing does not mean construction has started Focus on preconstruction staffing until construction and power milestones are confirmed
Las Vegas Approved expansion; capacity not disclosed [57][62] Mobilization pending verification Confirm utility service and start dates before forecasting trade demand
Cheyenne Project Jade: up to 2.7 GW of planned on-site generation [55] A later database entry reported a pause and withdrawal [57] Exclude it from active hiring demand unless renewed authorization is verified

Approved power is not delivered power. Track available service, contracted capacity, generation under construction, and planned capacity separately.

Project timing tells you when to hire. Labor depth helps you decide where to recruit.

Local Talent, Skills Gaps, and Recruiting Reach

Phoenix had approximately 179,600 construction jobs in 2025 [60]. Use the labor table as planning guidance - not a count of workers available to hire.

High project demand does not tell the whole staffing story. Specialty skills and recruiting reach can make the same project easier or harder to staff.

Market Labor depth Specialty gaps to validate Competing demand Recruiting reach
Phoenix Deepest general labor base, but not necessarily data-center-ready talent Medium-voltage and substation electricians; high and rising skilled-labor exposure [58][59] TSMC, Intel, hyperscale facilities Local trades; national electrical leadership searches
Reno Limited local specialist pool Generation, high-voltage, controls, commissioning Industrial and infrastructure work Regional travel and rotational specialists
Salt Lake City Broad construction pool; specialist depth needs validation Data-center MEP supervision, controls, commissioning Industrial and commercial work Regional MEP and commissioning searches
Denver Broad construction base; availability unverified Medium-voltage electricians and transmission-and-distribution linemen; high and rising skilled-labor exposure [58][56] Transmission, industrial, advanced manufacturing Colorado crews; grid-specialist searches beyond the state
Albuquerque General construction pool; limited mission-critical depth Construction management, MEP, controls, commissioning Energy and industrial work Regional leadership searches
Boise Small-market depth; not a measured availability count Hyperscale supervision and specialist MEP roles Manufacturing and other construction Travel or relocation for specialists
Las Vegas General trades pool; hyperscale experience needs validation Specialized electrical, controls, commissioning Hospitality and large commercial development Regional specialists with completed data-center experience
Cheyenne Thin local pool Electrical, mechanical, controls, commissioning, senior management Energy and manufacturing Regional crews and national leadership searches

With timing and labor depth confirmed, match staffing to verified start dates and phase-specific needs.

Ask contractors for start-date availability across civil/sitework, concrete/structural, electrical, mechanical/HVAC, field supervision, construction management, controls/BMS, and commissioning. Check energized-system and live-facility turnover experience separately.

Staffing Costs and Hiring Timing

When workers are scarce or travel is required, total compensation and start dates matter as much as base pay.

Base Pay, Travel Expenses, and Retention

Compare job scope, not just job titles. Benchmark leadership roles by annual pay and electricians by hourly pay, using May 2025 BLS OEWS as the baseline.[64][66] Where local leadership pay data are missing, apply the same assumptions across markets. Start with matched BLS occupations, then use dated employer postings and specialist surveys.[63][64]

Market Leadership base pay (annual) Electrician base pay (hourly) Available source and data date Package additions to price separately
Phoenix - - Matched local figures not supplied Per diem, vehicle, completion bonus, shift premiums
Reno - - BLS, May 2025: construction/extraction mean $32.48/hour; not role-comparable [11] Travel, lodging, relocation, retention
Salt Lake City - - Matched local figures not supplied Housing, per diem, completion bonus
Denver - - Matched local figures not supplied Relocation, travel premiums, retention
Albuquerque - - Matched local figures not supplied Travel, housing, per diem
Boise - - BLS, May 2025: first-line construction-trade supervisors mean $38.50/hour; not role-comparable [40] Relocation, rotation travel, retention
Las Vegas - - Matched local figures not supplied Per diem, shift premiums, completion bonus
Cheyenne - - Matched metropolitan figures not supplied Winter lodging, travel flexibility, retention

No matched city-level leadership pay data were supplied, so use the same comparison structure across markets. Treat package items as budget inputs, not local premiums.

Base pay covers salary or straight-time wages - not the full assignment cost. Price overtime, benefits, travel premiums, airfare, mileage, per diem, housing, relocation, and retention separately. Spell out travel days, lodging arrangements, and overtime assumptions. Keep discretionary bonuses outside guaranteed compensation.

A 2026 specialist guide estimates traveling-trade per diem at $15,000–$30,000 annually, but assignment length and employer policy determine the actual amount.[65]

Start dates also affect cost. Hire for the project phase, not the announcement.

Hiring Priorities by Construction Phase

Once compensation is set, match hiring to the work ahead.

The table below is a hiring forecast, not observed employment data. The early team includes the PM, project executive, estimator, scheduler, and procurement staff. Build-phase roles cover field supervision, trades, quality, and safety. Turnover roles cover controls, testing, commissioning, TAB, and owner training.

Recruit MEP and commissioning leaders during design and procurement. They need to weigh in on equipment choices, controls sequences, test requirements, and acceptance plans before installation. Release offers only after each project reaches a verified milestone.

Market Early leadership and planning Build-phase priorities Turnover and facilities readiness Hiring trigger and mobility
Phoenix Early team plus electrical/MEP leadership Electrical superintendents, trades, safety Controls, testing, commissioning, owner training Confirm package releases; check local availability before funding travel
Reno Early team plus MEP and commissioning leads Electrical/mechanical supervision, trades, safety Controls, testing, commissioning, owner training Match recruitment to the approved construction schedule; budget specialist rotations
Salt Lake City Early team plus MEP leadership Field supervision, trades, quality, safety Controls, testing, commissioning, owner training Verify procurement and installation dates; source specialists regionally
Denver Early team plus electrical/MEP leadership Electrical supervision, trades, quality, safety Testing, controls, commissioning, owner training Align staffing with equipment delivery and energization; assess out-of-state specialists
Albuquerque Early team after authorization Field supervision, trades, safety Controls, testing, commissioning, owner training Require verified project authorization before mobilization; price regional leadership travel
Boise Early team while start dates are confirmed Superintendents, MEP trades, safety Controls, testing, commissioning, owner training Avoid premature craft mobilization; assess relocation for specialists
Las Vegas Early team plus MEP leadership Field supervision, electrical trades, safety Controls, testing, commissioning, owner training Confirm the schedule before assigning regional specialist travel
Cheyenne Early team only for authorized work Field/MEP supervision, trades, safety Controls, testing, commissioning, owner training Require authorized work before mobilization; budget rotations and lodging

Keep MEP and commissioning leaders through integrated testing and acceptance; losing them late can disrupt turnover. For Phoenix and Las Vegas, budget for heat-related shifts and recovery time. For Cheyenne, include winter protection, travel interruptions, and lodging extensions in the budget.

Carry these cost and timing signals into the final ranking.

Final Rankings and Hiring Recommendations

This ranking weighs project commitments, power-delivery visibility, labor depth, and staffing cost. Phoenix leads in planned and under-construction capacity.[67] Las Vegas places above Albuquerque and Boise because of near-term project momentum and specialty-labor demand.

The table translates those factors into hiring priorities.

Final rank Market Best fit Priority hires Hiring cautions
1 Phoenix Hyperscale developers and large contractors managing complex MEP work and phased delivery Project executives, senior project managers, MEP leaders, commissioning leads Start locally, then search nationally for hyperscale and high-voltage experience. Budget for pay premiums and power-related delays.
2 Reno Campus developers and contractors with regional recruiting reach Senior project managers, MEP leaders, commissioning leads Recruit across Nevada, Northern California, and Utah. Relocate permanent leaders and use traveling specialists during peak demand.
3 Salt Lake City Regional general contractors, MEP subcontractors, and secondary-market owners Project managers, MEP leaders, commissioning leads Search locally and regionally. Reserve relocation capacity for hard-to-find technical leaders.
4 Denver Firms needing depth in engineering, project controls, and commissioning Project executives, construction managers, project-controls leads, commissioning leads Search locally and regionally. Keep relocation capacity available for hard-to-find technical leaders.
5 Las Vegas Contractors pursuing projects sensitive to power availability and specialty-labor supply Project managers, MEP leaders, commissioning leads Combine local hiring with regional specialist searches. Verify power and permitting milestones before committing teams.
6 Albuquerque Smaller phased projects led by regional teams Project managers, MEP leaders, commissioning leads Build local coordination capacity. Use traveling specialists and consider relocation for permanent leadership.
7 Boise Advanced-manufacturing and data-center-adjacent employers offering relocation and travel Senior project managers, MEP leaders, commissioning leads Verify local mission-critical experience. Budget for relocation, completion bonuses, and specialist travel.
8 Cheyenne Remote, power-heavy projects requiring technical leaders from outside the market and local field coordination Traveling project leaders, MEP leaders, commissioning leads Pair local field coordinators with technical leaders from outside the market. Confirm lodging and travel support before deployment.

Use these rankings to set recruiting priorities. Expand beyond local sourcing only when it fails to produce candidates: broaden the search after two to three weeks without a qualified shortlist. Screen for experience delivering energized, commissioned facilities - not just conventional commercial buildings. Consider relocation for permanent staffing gaps and traveling teams for short, specialized assignments.

For support within this framework, iRecruit.co provides construction recruiting, RPO, and consulting for mission-critical builders and developers.

This order is a planning framework as of October 1, 2026. Revisit it when financing, tenant commitments, utility milestones, or contractor awards change.

FAQs

How can I verify a project's hiring readiness?

Treat staffing as a core preconstruction input. Track permits and capital announcements 6–18 months before construction starts. Review regional vacancy rates, wage trends, and average days-to-fill every quarter to keep compensation competitive.

Fill project executive and commissioning manager roles 6–12 months before field activity begins. Define each role’s project phase, reporting structure, and required mission-critical experience. If local talent pools shrink, be ready to recruit across more regions.

Which skills transfer to data center construction?

Skills gained in hospitals, semiconductor fabrication, pharmaceutical manufacturing, and advanced industrial or energy facilities translate well. These settings demand high availability, strict quality control, phased sequencing, redundant power, cooling, and zero-failure commissioning [1].

Relevant skills include MEP coordination, high-density power distribution, managing shutdowns across multiple trades, writing method-of-procedure documentation, integrated systems testing, and critical-path scheduling in facilities that remain in operation [1][2].

Should I relocate leaders or use traveling teams?

Use traveling teams for mission-critical leadership when local talent is limited. Hiring gaps often affect project executives, project managers, MEP/commissioning leaders, and planning roles first. Secure these leaders 6 to 12 months before peak field activity.

A hybrid model works best: hire local superintendents and field engineers, and bring in project managers, MEP leaders, and commissioning specialists. Budget for travel, lodging, and rotations up front, often including per diem. [1][2][3]

Related Blog Posts

Keywords:
data center jobs, data center hiring, Mountain States, MEP staffing, commissioning, construction labor, power readiness, project mobilization
Free Download

Data Center Construction Labor Trends in 2026

Thank you! Your submission has been received!
Oops! Something went wrong while submitting the form.

More mission critical construction news

Construction Safety Engineer on Mission-Critical Builds: Scope, Certs, and Pay
October 1, 2026

Construction Safety Engineer on Mission-Critical Builds: Scope, Certs, and Pay

Evaluate scope, certs, field controls, and pay for construction safety engineers on data-center and power projects.
EHS Engineer vs EHS Specialist vs Safety Manager: Titles, Pay, and Who Hires Which
October 1, 2026

EHS Engineer vs EHS Specialist vs Safety Manager: Titles, Pay, and Who Hires Which

Match title, authority and pay to EHS work: engineers design controls, specialists enforce field safety, managers lead programs.
EHS Manager Job Description: What Owners Should Put in the Req
October 1, 2026

EHS Manager Job Description: What Owners Should Put in the Req

Owner-side blueprint for EHS manager requisitions: define scope, authority, 30/90‑day deliverables, contractor oversight, and hiring criteria.
Construction accounts for half of Wisconsin job growth
September 30, 2026

Construction accounts for half of Wisconsin job growth

Data center projects have driven strong construction job growth in Wisconsin and spurred energy and manufacturing investments.
