Loose RFI and change order workflows cost owners time and money fast. On large projects, change-related costs often reach 10%–15% of the original contract, poorly handled RFIs drive 30% of delays, and avoidable rework can add 5%–8% to total cost.
If I were running the owner-side process, I’d keep the rules simple:
The main idea is simple: owners lose control when answers, approvals, and cost impact live in different places. A reply is not the same as closeout, and a field request is not the same as approved contract change.
Here’s the short version of what matters most:
This article lays out the owner-side controls I’d use to keep decisions documented, pricing checked, and schedule risk visible before small issues turn into claims.
Email breaks the record apart and makes traceability harder. When RFIs and change requests come in through email, texts, and side conversations, the team loses a single source of truth. Attachments sink into long threads. Partial replies disappear. The official record ends up scattered across inboxes instead of sitting in one place.
The mess adds up fast. In one forensic review, only 1,000 of 4,000 logged items were real RFIs; the rest were duplicates or routine mail [2]. That kind of clutter makes it far harder to see what needs a decision and what doesn't. And the admin burden isn't small. At 400 RFIs, overhead alone can hit $240,000 to $600,000 before delay costs even enter the picture [4].
There's also a quieter problem that causes a lot of damage: the "Answered" status trap. Many teams mark an RFI as "Answered" as soon as the design team sends a reply. On paper, that looks done. In practice, it often isn't. "Answered" only means a response exists. "Closed" means the field can act on that response. That's a big difference. If the owner-side team gives up control too early, unresolved issues sit behind a status that looks complete while the job site is still stuck.
Once intake breaks down, routing and closeout usually slow down right behind it.
When no one is clear on who can approve what, decisions drag. RFIs can sit for days before anyone even routes them. That delay may not show up cleanly in the log, but the schedule still feels it.
Change orders run into the same wall. If a submission comes in without a cost breakdown, schedule impact, or backup, the team has to kick it back for clarification. Then it comes around again. And again. Each loop burns more time. The median manual approval cycle is 14.3 days [7], and about 35% of change orders land on the critical path [7]. So this isn't just office friction. It turns into schedule overrun fast.
Dollar thresholds matter here too. Without them, requests go to the wrong person, wait in limbo, or get pushed higher than they need to go. A small gap in workflow can end up causing a big field problem.
That’s where workflow trouble starts turning into direct schedule risk.
The danger often stays hidden because RFIs are not tied to possible change orders at intake. When that link is missing, owners lose a live view of cost exposure as it builds. Then, when a claim shows up later, the team is forced to rebuild a paper trail after the fact.
Failing to connect RFIs to Potential Change Orders (PCOs) at intake creates risk downstream. If a clarification leads to extra work and no PCO was opened, the owner has no clear record to judge the claim - or push back on it. That's the kind of gap that comes back to bite.
The cost of poor RFI handling also tends to show up sideways. It rarely appears as one neat line item. Instead, it surfaces through:
At first, those issues can look separate. Then someone traces them back and sees the same root cause.
"RFIs don't just slow projects down. They bleed them dry." - Softabase Editorial Team [4]
Without one live view of open RFIs, pending change orders, and exposure, owner-side teams end up reacting instead of staying in control. That leads straight to the controls covered next: one intake path, one log, and one closeout rule.
Use one standard RFI template and one log for every RFI. When intake follows the same format every time, routing and closeout are much easier to manage.
Each submission should include the drawing reference, conflict description, proposed fix, and an annotated sketch or site photo [4][9]. If an RFI is vague, send it back to the contractor right away. That step may feel strict, but it saves time later. In fact, requiring contractors to suggest a resolution before the question goes to the design team can cut resolution time by 40% compared with open-ended questions [4].
Your owner-side log should track:
Use a naming format like Trade-###-Short Description so records stay easy to find through closeout and claims review. Treat the log as the source of truth. Don’t manage status in email [4][9].
Once intake is under control, the next step is deciding who reviews each RFI and how fast they need to act.
Assign one person - usually the owner’s CM or project engineer - as the RFI manager. This person screens every new submission for completeness and priority before it reaches the design team. Incomplete RFIs go back at once. Valid RFIs get sorted and routed.
A practical tiered structure looks like this [4][9]:
| RFI Category | Response Target | Escalation Path |
|---|---|---|
| Safety / Field Stoppage | 24–48 hours | Immediate to Owner's Representative |
| Critical Path Impact | 2–3 business days | Day 4 to Owner's CM |
| Standard Coordination | 5 business days | Day 6 to Owner's Representative |
| Design Clarification | 10 business days | Day 11 to Owner's Project Manager |
Response targets matter, but escalation triggers matter just as much. If no one steps in when a deadline starts slipping, the target is just a date on paper. Set an automated reminder at 80% of the response window so reviewers get a nudge before the deadline passes [9].
Routing drives speed. Closeout is what locks in accountability.
Only close an RFI after the response has been reviewed for commercial impact, sent to all affected parties, and marked with a final status.
Use revision control for every updated sketch or spec. Sequential labels like R1 and R2 make it clear which version controls the work in the field. Every action in the record - who reviewed it, when, and what changed - should be timestamped. Dispute rates fall by 40–55% when records include timestamped audit trails [6].
If an RFI leads to a scope change, link it directly to a Potential Change Order before closing the record. That keeps the budget trail connected and clear [10][12].
"A well-documented RFI log shows that the contractor received timely, complete answers and that any delay was not caused by lack of information." - BridgeDoc [11]
Any RFI that changes scope should move straight into the change order log.

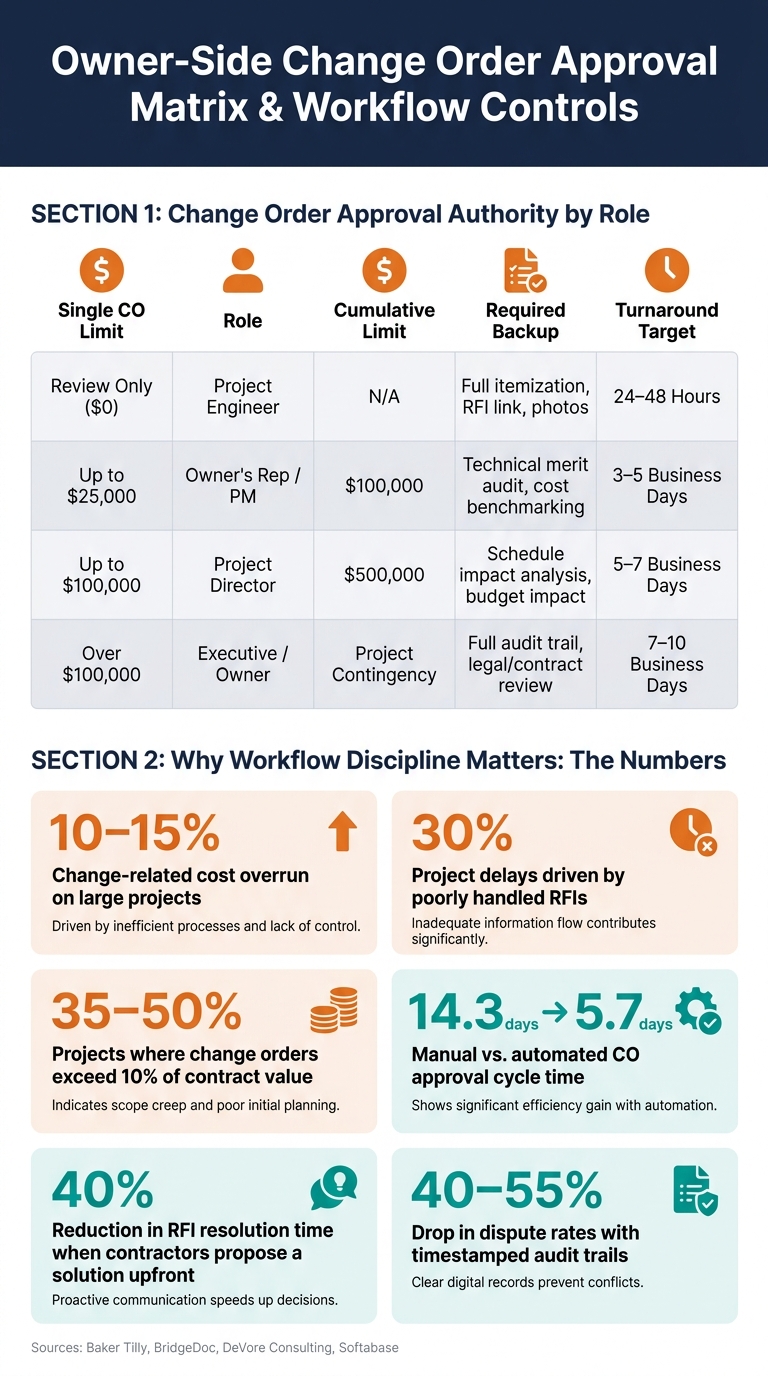

RFI & Change Order Approval Matrix: Owner-Side Workflow Controls
Once an RFI points to scope impact, move it into the PCO log right away.
Open a PCO as soon as a design clarification, unforeseen condition, owner revision, code change, or trade conflict shows up [13][1]. For owner-side teams, the PCO log is the place where scope drift stops being vague and starts becoming something you can track.
The timing matters. A PCO logged on day one with a rough order-of-magnitude (ROM) cost range and an early read on schedule effect gives the team visibility before the price gets locked in. Each entry should include the origin, linked RFI number, ROM cost range, and estimated schedule impact [13][2][15].
That matters because change-order exposure shows up often. 35–50% of construction projects see change orders go past 10% of the original contract value [14]. The best way to stay ahead of that exposure is simple: log possible changes before they turn into formal claims.
Don't accept a lump-sum change order proposal. For every change, require a three-part package: a narrative explaining the cause, a detailed cost breakdown, and a schedule impact analysis [1].
The cost breakdown needs to spell out:
One red flag shows up again and again: labor burden above 70% of the base wage can point to profit being tucked into the labor line [1]. Ask for the detail, then check it against contract rates and supplier invoices.
For larger changes, require a Time-Impact Analysis (TIA) or a schedule fragment that shows how the change touches the critical path [13][1].
"A disciplined change order procedure enables project owners to control budget overruns and schedule impacts by requiring detailed cost estimates and time extensions tied to each change." - Baker Tilly [13]
At intake, reject submissions that use lump-sum pricing, break out small tools as a separate charge, or apply markup to sales tax [1]. A short checklist keeps that review steady from one file to the next.
Once pricing is in, send the change through a defined approval path before any field work begins.
Approval authority should be tied to role, dollar threshold, and cumulative exposure, not whoever happens to be free that day [13][1]. Here's a practical setup for owner-side teams.
| Role | Single Change Order Limit | Cumulative Change Limit | Required Backup | Typical Turnaround Target |
|---|---|---|---|---|
| Project Engineer | $0 (Review only) | N/A | Full itemization, RFI link, photos | 24–48 Hours |
| Owner's Rep / PM | Up to $25,000 | $100,000 | Technical merit audit, cost benchmarking | 3–5 Business Days |
| Project Director | Up to $100,000 | $500,000 | Schedule impact analysis, budget impact | 5–7 Business Days |
| Executive/Owner | Over $100,000 | Project Contingency | Full audit trail, legal/contract review | 7–10 Business Days |
A PCO log entry should not turn into field work until the right owner authority signs off [13][1].
"No work proceeds without written owner approval, except in true emergency. Reserve emergencies for immediate danger to health or property, not schedule pressure." - DeVore Consulting [1]
When the schedule is tight but pricing still isn't settled, use a CCD to keep control. If price talks stall but the work can't wait, issue a CCD and track labor and material costs as they happen [16].
Also set a written notice rule. Require notice within 7–14 days of discovery, or 21 days under AIA terms, to cut off late claims [17][16][1]. That notice rule, paired with the approval matrix, connects early PCO logging to formal authorization.
Once intake, routing, and approvals are set, tie them straight to budget, schedule, and staffing.
This is where the process stops being a paper trail and starts working like a control system. Every RFI record should include linked cost, schedule, and delay fields so budget and schedule exposure show up the moment the RFI comes in [2]. If an RFI is approved or closed with a cost or schedule flag, open the follow-on record right away [12]. That keeps the team from losing time between decision and action.
It also helps to store both numbers in the same place: the contractor's proposed impact and the owner's independent estimate [12]. When those figures sit side by side, pricing gaps are easier to spot before they turn into claims or disputes. Keep all of this in project software or a shared database so each change stays tied to status, submission and approval dates, costs incurred, and the broader job costing system [3].
The big shift here is simple: every RFI needs to stay connected to budget, schedule, and the follow-on record.
Bring that same visibility into weekly OAC meetings. The live dashboard should be part of the meeting itself, not something passed around at the last minute. Put the RFI aging report and the PCO log on the standing agenda every week [2] [11]. That regular review turns separate workflow steps into a working control system, and integrated cross-project metrics have been shown to cut average RFI aging by 40% on complex projects [2].
Once the workflow is connected, the numbers start showing where things get stuck.
Don't track dozens of metrics. Track the few that tell you where the process is dragging.
Focus on:
These numbers give you an early warning. Industry averages for RFI response sit around 9.7 days, while contract expectations are usually 5–10 business days [5] [11]. Manual change order approval averages 14.3 days, while automated workflows can bring that down to 5.7 days [6].
Repeat RFIs tied to the same trade or spec section usually point to drawing gaps. Fixing those early can stop the next round of change orders before it starts [12] [9].
Use these controls as one operating system, not a stack of separate checklists. One intake path, one log, clear routing rules, written authority limits, detailed pricing requirements, escalation for schedule threats, and disciplined closeout only work when they stay linked together.
Owner-side control also depends on matching the right people to the right work. That usually means:
An RFI should turn into a Potential Change Order (PCO) when the question points to a change in the project’s scope, budget, or schedule that falls outside the original contract.
The best move is to open the PCO at the same time as the RFI as soon as there’s any sign the clarification could lead to extra work, even if the full cost or schedule impact isn’t clear yet. Tying the PCO to the RFI creates a clean audit trail and helps with proper cost recovery.
For owner-side project teams, the construction manager or owner’s representative usually runs both workflows. That person is the main gatekeeper between the contractor and the design team.
They log and review requests, send them to the right design professional, track progress, and share decisions back with the contractor. The project manager keeps overall accountability and works with the architect of record and other stakeholders when cost or schedule issues come up.
Establish a strict contract policy that requires a fully executed change order before any added work begins. When teams move ahead without written approval, costs can drift fast and disputes tend to follow. The rule should be simple: no written authorization, no extra work.
If work has already started, document the situation at once and pause long enough to get formal pricing and approval in place before it continues. Don’t rely on verbal directives. Track every change in writing, including cost impacts, schedule impacts, and signed approvals.
