A project is not ready to start just because the design looks done. If zoning, utilities, site conditions, permit order, or team staffing are still unclear, the start date is at risk.
I’d boil the article down to this: before work starts, I need to confirm five things:
The cost of getting this wrong can be steep. A 12-month approval delay on a $100 million project can add $6 million to $8 million in carrying cost. On the other end, spending about $5,000 on early soil testing can help avoid a $200,000 redesign.
Here’s the plain takeaway: I should treat preconstruction checks as a go/no-go test, not paperwork. That means checking zoning and land-use risk, lining up agency reviews, confirming utility capacity in writing, testing soil and access conditions, building a permit matrix, and making sure no one issues Notice to Proceed until permits, documents, utility agreements, and field staffing are all done.
If I can’t mark those items as complete, I’m not ready to build.

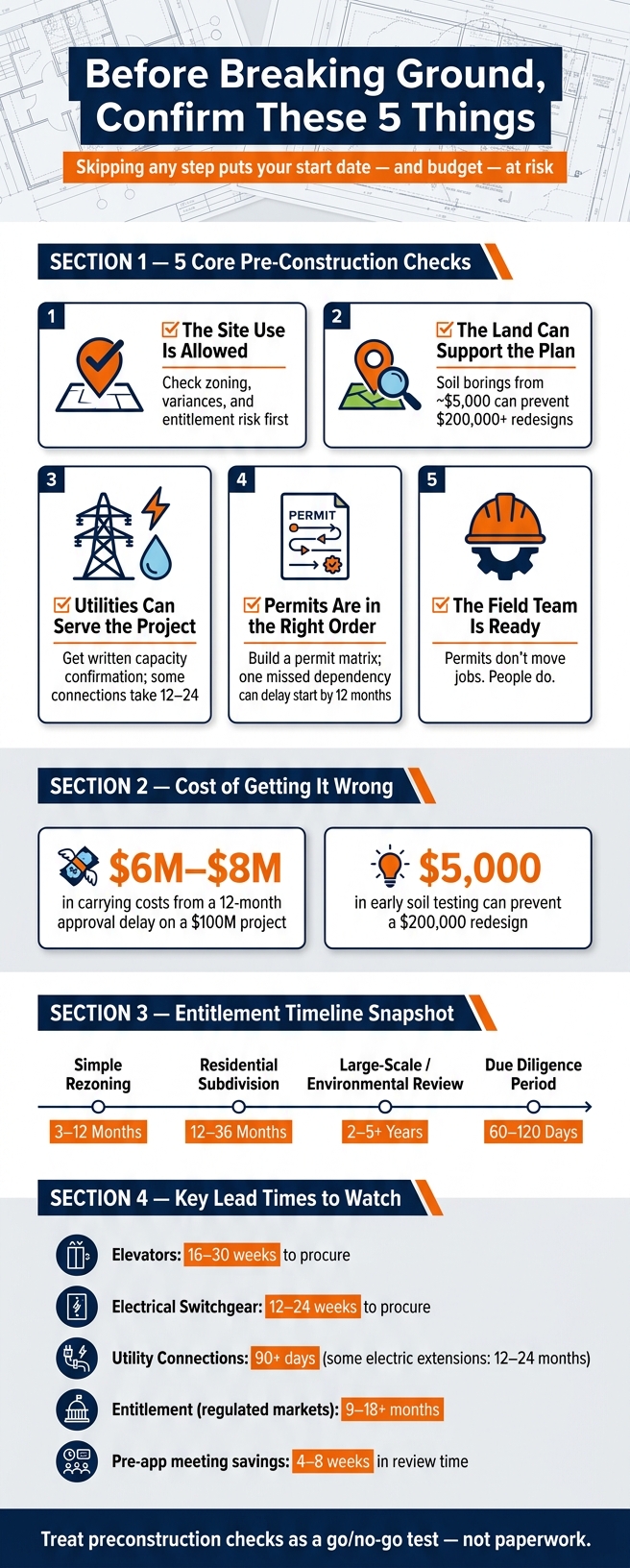

Site Planning & Permitting: 5-Step Pre-Construction Checklist for Owners
Before design moves too far, owners need to find out whether the site, approvals, and budget can support the planned use and timeline. That means pressure-testing the site against the intended use, target completion date, phasing plan, and a rough budget before paying for full civil engineering or architectural drawings.
Start with the basics, in writing: facility type, operating needs, target delivery date, phasing, and any hard limits. Those limits can include building height, density, Floor Area Ratio (FAR), setbacks, parking rules, or the need to build in phases.
These aren't just design details. They're early pass-or-fail checks.
Timing deserves extra attention. Long-lead materials and permit timelines often control the critical path. Even common building parts, like elevators, can take 16–30 weeks to procure [2]. If those timing assumptions don't show up in feasibility, the project can look fine on paper and then slip the moment it starts.
Once the scope is set, confirm whether the intended use is allowed as of right on the site or whether it needs a special use permit, a variance, or rezoning [4]. That one distinction can change the whole risk profile.
If the project doesn't match the local comprehensive plan, a general plan amendment may be needed. In many cases, that's the longest part of the process [6][5]. It also helps to look at local politics early. Organized growth opposition or pending ballot measures can shape zoning outcomes in a big way [6].
Beyond use, owners should verify:
Historic, coastal, and seismic zones can add more limits on top of base zoning [5][7].
| Entitlement Step | Typical Duration | Key Focus |
|---|---|---|
| Simple Rezoning | 3–12 Months | Changing land use designation [6] |
| Residential Subdivision | 12–36 Months | Dividing land into multiple parcels [6] |
| Large-scale / Environmental Review | 2–5+ Years | Complex projects with full environmental review [6] |
| Due Diligence Period | 60–120 Days | Technical and legal validation before closing [5] |
One smart move is to ask for a pre-application meeting with the local planning department before filing anything formal. These informal meetings often bring blocking issues to the surface early and give you a clearer read on whether the project has a shot [6].
If entitlement risk is high, an option agreement can make more sense than buying the land outright. It gives you the right to buy at a set price while approvals are still in process [6][8].
Most owners miss how many agencies can affect a start date. Reviews can happen at the local, state, and federal levels, and each one has its own timeline and filing rules [9][3]. One delayed review can hold up everything that comes after it [3].
| Agency Level | Typical Authorities / Reviews | Potential Impact |
|---|---|---|
| Local | Planning/Zoning, Building Dept., Fire Marshal, Health Dept. | Sets use, density, and safety standards; often the main bottleneck for start dates [9][5] |
| State | Dept. of Transportation (DOT), Environmental Quality | Controls road access and air/water quality permits [3][5] |
| Federal | Army Corps of Engineers, USFWS, EPA | Manages wetlands, endangered species, and NEPA reviews; can add years to timelines [1][5] |
| Utilities | Power, Water, Sewer, Gas, Fiber | Capacity limits can delay operations; providers may issue conditional capacity estimates instead of firm commitments [10] |
Utilities are a common blind spot. Get written confirmation that existing infrastructure can handle the project's exact load needs [6][2]. Then use that agency list to assign owners, gather submittals, and map the permit sequence.
A permit matrix helps here. For each agency, document the trigger, review window, and any prerequisite tied to the next approval step.
Once the permit path is clear, put the right people in place to keep it moving.
Build the core preconstruction team before design gets locked. If key people come in late, you usually get incomplete submissions, bad sequencing, and rework that didn't need to happen. Early alignment helps the team avoid approval delays and keeps the job moving toward groundbreaking.
Every decision area needs one clear owner. If no one owns it, issues tend to get lost during handoffs between teams. A RACI matrix helps make that plain. Here’s how ownership often breaks down across the core preconstruction team:
| Role | Primary Ownership Area | Key Output |
|---|---|---|
| Owner's Rep | Dry utilities & project strategy | Service agreements; strategy alignment |
| Civil Engineer | Site & wet utilities | Grading, drainage, and tie-ins |
| GC / Construction Manager | Schedule & logistics | Schedule, logistics, constructability |
| Geotechnical Engineer | Subsurface conditions | Soil bearing capacity; foundation recommendations |
| Environmental Consultant | Compliance & due diligence | ESA and environmental permitting |
| Architect | Design & building code | Permit drawings and code compliance |
| Land-Use Attorney | Zoning & entitlements | Zoning strategy and entitlement risk |
Set an explicit owner for each area at the very start of preconstruction. It sounds simple, but this is where a lot of projects either stay organized or start drifting.
Clear roles help, but they won't save a weak schedule.
Bring construction leadership into site planning early, not when permits are almost out the door. Pull in the GC, scheduler, and MEP team while the site plan is still being tested. That gives the team a chance to pressure-test procurement timing and field limits before they become schedule problems.
For example, electrical switchgear can take 12–24 weeks to procure [2]. If that timing isn't built into the schedule from the start, the project can slip before anyone even breaks ground.
"The early involvement of preconstruction teams can reduce risk and enhance flexibility for developers." - Phillip Marino, Vice President of Preconstruction, Frampton Construction
Once roles are set, put change control in place before design moves much further.
Changes to the building footprint, utility load, or traffic counts can trigger a new round of permit review and force new submissions. When a change affects agency review, the clock can start over. In some cases, one delayed stormwater permit can push a project back by as much as 12 months [3].
Set a formal rule for change review before design moves past schematic phase. Any change that affects entitlements, civil plans, or agency filings should be reviewed by the owner's rep, civil engineer, and land-use attorney. Review drawings at schematic design, design development, and construction documents so the team can catch scope drift before it resets permits.
If a change touches entitlements, civil plans, or agency filings, stop and review it first.
Before design freeze, check the site, utility capacity, and access plan for anything that could still force a redesign or push back mobilization. This is the window to catch issues before drawings go to permit.
Boundary and subsurface problems are a common reason projects get redrawn late or sent back through permitting. Start with a current ALTA/NSPS survey and a title commitment. Those documents show easements, encroachments, and restrictive covenants that can affect the building footprint or driveway location. Your civil engineer or surveyor should place each easement directly on the site plan so the buildable area is clear before design moves too far. Topography matters too. A grade change that looks minor on a flat drawing can make an entrance alignment or building placement fail in practice, so the site model should reflect actual slopes before the layout is locked [13][12].
Geotechnical conditions should also be checked with actual soil borings before drawings are finalized. For smaller projects, a standard soil investigation can start around $5,000. A baseline industrial geotechnical evaluation usually runs $15,000–$30,000 [2][12]. Early borings can show rock, fill, or groundwater issues while there is still time to make a lower-cost layout change before foundation plans are done.
Complete a Phase I ESA to ASTM E1527 standards before design freeze. Move to Phase II only if the Phase I identifies concerns [5].
Get written capacity confirmation from each utility provider before locking major design decisions. That includes electric, water, sewer, stormwater, gas, and telecom. The schedule depends on actual service commitments, not rough verbal estimates.
| Utility | Key Items to Confirm | Written Deliverable |
|---|---|---|
| Power (Electric) | Peak demand capacity, transformer needs, extension timeline | Capacity/Will-Serve Letter |
| Water/Sewer | Fire flow, line pressure, downstream capacity, lift station needs | Will-Serve Letter / Capacity Study |
| Stormwater | Detention requirements, discharge limits, runoff patterns | Civil Engineering Report |
| Gas & Telecom | Service point location, fiber availability, upgrade costs | Service Confirmation Letter |
| General Infrastructure | Off-site improvements, easements, impact/connection fees | Utility Matrix / Fee Schedule |
Watch lead times closely. Some utility connections take 90+ days. On larger projects, electric infrastructure extensions can take 12–24 months or more [2][10]. If power sits on the critical path, that timing has to be in the schedule from day one.
"Infrastructure requirements often dictate when construction can begin, making early coordination essential." - Compass DevCo [11]
After capacity is confirmed, tie each utility task to the permit schedule.
Driveway approvals, truck turning radius, and haul route limits can affect the start date just as much as the design itself. A Traffic Impact Study is often required when a project adds a large number of vehicle trips, so confirm the trigger with the local agency before permit submission.
Have the GC check crane access, laydown space, parking, and temporary entrances while the site plan can still change. Problems that look small on paper can turn into expensive field fixes. Those site limits should feed straight into the permit sequence and mobilization plan.
A short feasibility check helps sort the main site risks before you commit too far into design:
| Risk Factor | Low Risk | Moderate Risk | High Risk |
|---|---|---|---|
| Utility Capacity | Service path is plausible; coordination is manageable | Capacity depends on upgrades or uncertain off-site extensions | Constraints materially threaten viability or project timing |
| Geotechnical | Early indicators suggest no major subsurface concerns | Site signs justify caution; targeted testing required before commitment | Evidence suggests soil/water conditions may defeat project economics |
| Access Complexity | Strategy is straightforward and supports intended use | Works only with modifications, shared solutions, or further approvals | Limitations compromise use or create major entitlement risk |
| Off-Site Needs | No major off-site improvements required | Requires standard roadway or utility extensions | Requires massive infrastructure upgrades or district participation fees |
If you see two or more moderate or high ratings, treat that as a warning sign. At that point, the project may need a reset on scope, budget, or schedule.
Use the site, utility, and logistics work above to map the approval path. Once due diligence is done, lay out every approval in order before mobilization. If you skip the permit matrix, it's easy to think permits are moving when they're actually stuck behind an earlier requirement.
Entitlements give you the legal right to build. Construction permits give you permission to do the work. They happen in sequence, not side by side.
Entitlements cover the legal right to develop land for a certain use. That can include rezoning, conditional use permits (CUPs), variances, plats, and site plan approvals. These often involve public hearings. On many projects, they add 60 to 180 days [15]. In regulated markets, entitlement alone can take 9 to 18+ months [14].
Construction permits come after that. Grading, building, mechanical, electrical, plumbing (MEP), and right-of-way (ROW) encroachment permits allow the physical work to begin. Many jurisdictions won’t even accept a building permit application until site development or entitlement approvals are done [15]. In some areas, stormwater approvals must also clear first [14][3].
When you sort each approval into the right bucket - entitlement, specialty agency sign-off, or technical construction permit - you can build a timeline based on facts, not hope. Utility approvals should be tracked on their own line in the matrix.
A permit matrix keeps approvals from slipping out of view. More than that, it puts every moving part on one page so the team can see what’s holding the job back.
After you set the approval list, assign each item a date, an owner, and a dependency.
| Field | What to Capture |
|---|---|
| Approval Name | Specific permit, such as grading, foundation-only, encroachment, or building |
| Issuing Agency | The exact department, such as the Water District or Fire Marshal |
| Prerequisites | Documents required before filing, such as a geotech report or site plan |
| Review Duration | Estimated agency turnaround, including a 2- to 4-week resubmittal buffer [2] |
| Hearing Dates | Required Planning Commission or City Council dates |
| Dependencies | Other permits that must be issued first |
| Status | Current stage: not started, submitted, under review, approved |
| Expiration Date | Date the permit becomes void if work hasn't started |
Review the matrix each month alongside the master schedule. It should make the controlling item for groundbreaking obvious. If a stormwater permit is sitting in a review queue and no one owns it, that one item can delay mobilization by as much as 12 months [3]. A pre-application meeting with the permitting agency before formal submittal can bring issues to the surface early and may save 4 to 8 weeks in review time [14].
Once the matrix is built, look at which permits can support an earlier start without boxing the team into avoidable redesign. In some cases, phased permits let you start grading or foundations before the full building permit is approved [14][3].
This is the owner’s main call: is an earlier start worth giving up some design flexibility? That tradeoff matters. If the building design shifts after the foundation is already in the ground, rework can get expensive fast [14].
| No Sequencing Strategy | Planned Phased Permitting | |
|---|---|---|
| Time to Mobilization | After full building permit - 9 to 18+ months in slow markets [14] | Earlier start via grading/foundation permits [14][3] |
| Rework Risk | Low; all systems are approved simultaneously | Higher; foundation changes may affect later MEP coordination [14] |
| Idle Time | High; crews wait for total project approval | Minimized; site work and vertical construction overlap [3] |
Keep the focus on permit order, dependencies, and early work packages. A well-built permit matrix turns due diligence into a mobilization plan the team can actually use, while showing owners exactly what has to clear before breaking ground.
Once the permit matrix is done, check that the site is actually ready before you issue Notice to Proceed.
A permit matrix tells you what got approved. A ready-to-build checklist tells you whether work can start. One shows what cleared on paper; the other confirms the team can mobilize in the field.
Before equipment shows up, every permit, drawing set, and agreement should be issued or fully signed. Nothing should be sitting in a "waiting for final signature" pile.
That includes building, grading, and stormwater permits; signed and sealed civil, structural, architectural, and MEP drawings; recorded easements; and written utility tie-in rules for wet utilities like water, sewer, and storm, plus dry utilities like power, gas, and telecom.
Utility providers may need 90+ days for new connections or pole relocations [2]. That kind of lead time can wreck a start date if you're relying on a phone call or a casual "you should be fine."
Before issuing any Notice to Proceed, walk the site against the ALTA/NSPS survey. Make sure property corners are staked and that no new encroachments have shown up. Finish the 811 utility locate and get clearances before excavation starts. Also check that the SWPPP and erosion-control measures are posted and ready before any earthwork begins.
Paper approvals can still fall apart on day one if the field team isn't there.
Before mobilization, confirm that the named project manager, scheduler, cost controller, superintendent, MEP lead, and commissioning lead are hired and onboarded. Permits don't move the job. People do.
You should also verify that insurance certificates are active, including General Liability, Workers' Compensation, and Builder's Risk. At the same time, make sure contractor licenses and W-9s are on file.
Use this checklist as the last gate before Notice to Proceed. Every line below should read "Complete" before mobilization. If something still says "In Progress" or "Not Started," treat it as a direct risk to the start date.
| Category | Item to Verify | Status |
|---|---|---|
| Regulatory | Building, Grading, and Zoning Permits Issued | Complete / In Progress / Not Started |
| Regulatory | Fire, Environmental, and ROW Encroachment Approvals | Complete / In Progress / Not Started |
| Technical | Signed/Sealed Coordinated Construction Documents | Complete / In Progress / Not Started |
| Technical | Geotechnical Report and Phase I/II ESA Completed | Complete / In Progress / Not Started |
| Utilities | 811 Utility Clearance and Written Service Agreements | Complete / In Progress / Not Started |
| Utilities | Recorded Easements and Capacity Confirmations | Complete / In Progress / Not Started |
| Team/Talent | PM, Superintendent, and MEP Lead Onboarded | Complete / In Progress / Not Started |
| Team/Talent | Insurance Certificates Active | Complete / In Progress / Not Started |
| Logistics | SWPPP/Erosion Control Posted; Long-Lead Items Ordered | Complete / In Progress / Not Started |
"The best contractors win or lose a project before they ever break ground." - Projul [2]
Strong site planning, a sequenced permit matrix, confirmed utility agreements, and a fully staffed execution team turn approvals into construction activity. Owners who close every gap on this list before issuing Notice to Proceed are the ones who mobilize on time - and finish that way too.
Start with zoning approvals and entitlements before you apply for a building permit. Those come first, and they often involve a public hearing process that can take 3 to 6 months. It also helps to move early on utility clearance, including 811 marking and excavation certificates.
Once entitlements are confirmed, turn to parallel reviews from specialty agencies like fire marshals, health departments, and environmental agencies. Many teams handle these reviews at the same time to avoid slowdowns.
Some owners also use phased permitting to keep work moving. That can mean getting early grading and utility permits while the main building permit is still under review.
Order soil testing during your initial due diligence and site assessment, well before construction starts.
Early geotechnical testing can flag problems like unstable soil, high water tables, or buried rock. That gives you a clearer read on whether the site can be built on, helps shape the design and foundation plan, tightens your budget, and can help you avoid costly redesigns or schedule delays later.
Owners should bring in the preconstruction team and specialized consultants as early as possible, ideally during the first planning stage or even during site selection. That early start can help spot zoning problems, utility constraints, and geotechnical risks before they turn into expensive delays.
Key participants often include general contractors, civil engineers, and land-use attorneys. They help with cost planning, schedule planning, site feasibility, and permitting.
