Most construction claims start small, not all at once. If I run a weekly owner meeting the right way, I can spot trouble early, assign fixes on the spot, and keep delays, cost drift, and field blockers from turning into claims.
Here’s the short version:
I’d treat the meeting as a working session, not a status update. I’d review last week’s actions, clear this week’s blockers, and use a few simple logs to track RFIs, submittals, changes, staffing, and decisions. If float is shrinking, long-lead items are slipping, or crews are thin, I want to know that this week - not after the job falls behind.
What matters most: keep the agenda fixed, send pre-reads 24 to 48 hours before the meeting, and start the next meeting by checking what was promised last week.
That’s the whole playbook in plain English: same agenda, current data, fast follow-up, written decisions.

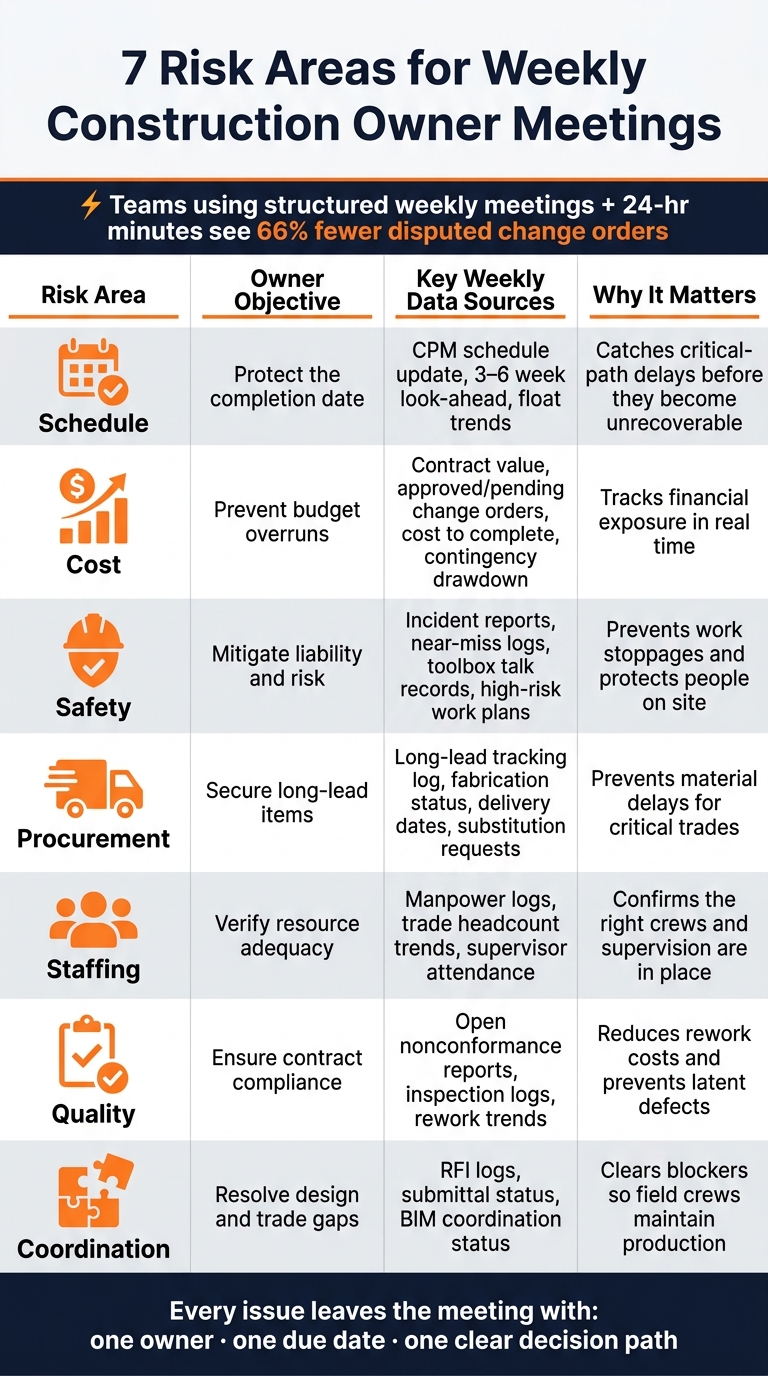

7 Risk Areas for Weekly Construction Meetings: Owner's Agenda at a Glance
Set the weekly owner agenda around the seven risk areas most likely to slow the job or lead to change orders. Keep the format fixed: short updates first, then blocker removal. Every item should end with one of three things: a decision, an owner, or a deadline.
The owner's role is simple: spot drift early and push the team to respond before a small issue turns into a job-wide problem.
Use the agenda to drive decisions, not to collect status reports. Keep each category time-boxed. If a topic needs more time, move it to the blocker log and keep the meeting moving.
For schedule, compare actual progress to the baseline, name the current completion target, identify the activities on the critical path, and report float trends. If float on near-critical activities is shrinking week over week, act now. Don’t wait for the delay to hit the critical path. Put that review next to the 3- to 6-week look-ahead so the team can see what’s coming before it lands in the field.
For cost, confirm that invoices match actual field progress. Also check whether contingency drawdown is running ahead of the schedule. That’s often where budget trouble starts to show up first.
For safety, confirm incident reports, near misses, toolbox talk records, and any high-risk work planned for the next seven days. This part of the meeting should stay concrete. What happened, what’s planned, and what needs attention now?
Procurement should stay focused on long-lead items, fabrication status, delivery dates, and substitution requests. If a submittal is overdue, flag it immediately [5][4]. A late submittal can look minor on paper, then hit the field like a brick a few weeks later.
Staffing review means each trade confirms crew counts for the next two weeks and states whether supervision is in place. Missing mechanical, electrical, and plumbing supervision is a major red flag. In many jobs, that problem shows up later as quality issues or coordination failures.
Quality review should cover failed inspections, open nonconformance reports, and rework trends that point to a pattern instead of a one-off mistake. If the same issue keeps popping up, the team needs a fix, not another promise.
Coordination should close the agenda with the active blocker list: the five to ten RFIs and submittals now blocking field work, plus any unresolved design clashes between trades that need a decision before installation can move ahead [1][4].
Every open issue should leave the meeting with an owner and a due date.
After the meeting, a few living logs turn decisions into deadlines, named owners, and proof that the work is done.
Once the meeting ends, these tools keep each call in plain sight until it closes.
Every action item needs a unique ID, one owner, a firm due date, and a current status [3]. "ASAP" is not a due date. If an item slips, it should be called out first in the next meeting. In a well-run meeting, 90% of action items should be completed and closed each week [2].
The look-ahead schedule works best when it is tied to constraints, not just a list of upcoming work. Owners should check that permits, shutdown approvals, design clarifications, inspections, and required user sign-offs are cleared before work starts [5]. That link makes the next 3 to 4 weeks much easier to read. You can see what has to get resolved now so the field doesn't stall later.
Owners should expect the RFI dashboard to show aging by days open, not just a raw count. An RFI sitting open for 3 days and one sitting open for 30 days are not the same problem. Use the issue log to name the blocker, the owner, and the escalation date. Use the submittal dashboard to flag approvals that are holding up fabrication. Any RFI not answered within the contract deadline should be flagged [5]. If RFIs keep piling up in one area, that can point to a design gap, not just a paperwork jam.
Record each approval with an ID, approver, date, rationale, and cost or schedule impact. That kind of traceability gives the team a defensible written record when questions come up later [6].
When the same execution problems show up week after week, the problem is often the team setup, not the meeting process. Owners should assess whether the project still has the right leads in key roles for scheduling, cost control, MEP coordination, and commissioning process optimization [6][2].
Those gaps should shape the next week's owner questions.
Once your logs and dashboards are up and running, the next move is simple: ask questions that expose what those tools don't show at first glance. A tracking system is only as good as the questions behind it. If those questions are weak, site risk stays buried.
A lot of weekly meetings drift because the questions are too vague. "How are things going?" sounds fine, but it rarely tells you much. You want questions that can be checked against the schedule, the logs, and the work in place.
Ask which activity lost float this week and why instead of asking if the schedule is still on track. Ask which unresolved RFI or submittal is blocking system testing instead of focusing on how many are still open. Ask what change exposure is known but not yet priced or submitted so you can track it before it turns into a nasty surprise.
Two more questions belong in every weekly meeting. Ask which long-lead item has less than four weeks of schedule buffer. Then ask which crews or key roles are understaffed in the next 30 days. Those two questions tie the look-ahead schedule directly to procurement and manpower gaps before they hit the critical path.
Red flags matter most when they show up more than once or start piling up together. Repeated slips, growing pending change orders, recurring safety events, repeated inspection failures, overdue commissioning submittals, and understaffed crews all need follow-up right away.
When a red flag comes up in the meeting, don't let it hang in the air. It needs a named owner, a firm due date, and a clear decision path before the meeting wraps. Log each flag in the action log and decision register before everyone leaves.
Weekly construction meetings work best when the owner runs them like a control system, not a simple status call. The key is using the same agenda every week and showing up with current data. Convenience is nice, but consistency is what keeps a project on track. That same cadence should continue through closeout.
Look-ahead schedules, action logs, dashboards, and decision registers don't help much if they're out of date. They need to be updated before the meeting and reviewed during it. When those logs stay current, teams can spot warning signs sooner and respond before issues hit the critical path.
The way a meeting ends matters just as much as the way it runs. Use the last five minutes to recap every open action item and each decision that needs to be recorded. Then send the minutes within 24 hours while the details are still fresh [1][3]. Projects that pair structured weekly meetings with minutes sent inside that 24-hour window see 66% fewer disputed change orders than projects without formal documentation [3].
"A decision made in a meeting without written documentation is a promise with no enforceability." - Olivia Reyes, TaskTag [3]
Use this closeout sequence every week:
That rhythm helps catch problems early, before they turn into change orders.
Weekly meetings should include the core stakeholders who can make decisions: the owner or the owner’s representative, the architect, and the general contractor’s project manager.
The site superintendent should be there too, because they bring on-site context that can change the conversation fast. Lead subcontractors and other specialists, such as engineers or financial representatives, can join when their input is needed based on the current scope, project phase, or items on the agenda.
Weekly construction meetings should usually last no more than 60 minutes.
Some teams work within a 60- to 90-minute window, but 60 minutes is the better target if you want the meeting to stay tight and useful. Once a meeting drifts past the hour mark, people start to lose focus, and the room can turn into a catch-all for issues that should’ve been handled somewhere else.
To keep things on track, stick to a fixed agenda, give each topic a set time limit, and push side issues into smaller follow-up meetings. That simple shift can save a lot of wasted time.
If your weekly meetings keep running longer than an hour, that’s usually a sign of one of two things:
Owners should run a consistent process with clear accountability: give each action item one owner and one due date.
Don’t use meeting time to debate why something slipped. Keep every item on the tracking log until it’s closed. Review overdue items first in each meeting, and if the same item keeps slipping, treat it as a blocker that needs to be escalated or handled between meetings.
