If you think the design budget only pays for drawings, you're missing the part that protects your job from delays, rework, and cost drift.
I’d sum it up like this: construction design management is the work that keeps design, pricing, permits, procurement, and field execution lined up before problems hit the site. On complex jobs, that control can mean the difference between a clean release package and a pile of RFIs, change orders, and schedule hits.
Here’s what owners are paying for:
A few points stand out from the article:
Put simply: I’m not paying only for design output. I’m paying for a system that helps make the design buildable, priced, permitted, and ready for release.
| What I pay for | What I get | What it helps prevent |
|---|---|---|
| Team coordination | Logs, clash reports, model review follow-up | Field conflicts and rework |
| Package oversight | Version control, release checks, complete drawing sets | Outdated or incomplete documents |
| Cost and scope control | Cost comments, VE logs, change tracking | Budget drift and late cuts |
| Milestone control | Design freezes, release dates, procurement timing | Long-lead delays and schedule slip |
| Permit alignment | Submission planning, permit trackers | Start delays and work stoppages |
That’s the core point of the article: design management is a control function, not just a design task.
While design managers focus on pre-construction coordination, they work closely with the construction project manager to ensure the design intent is executed during the build phase.

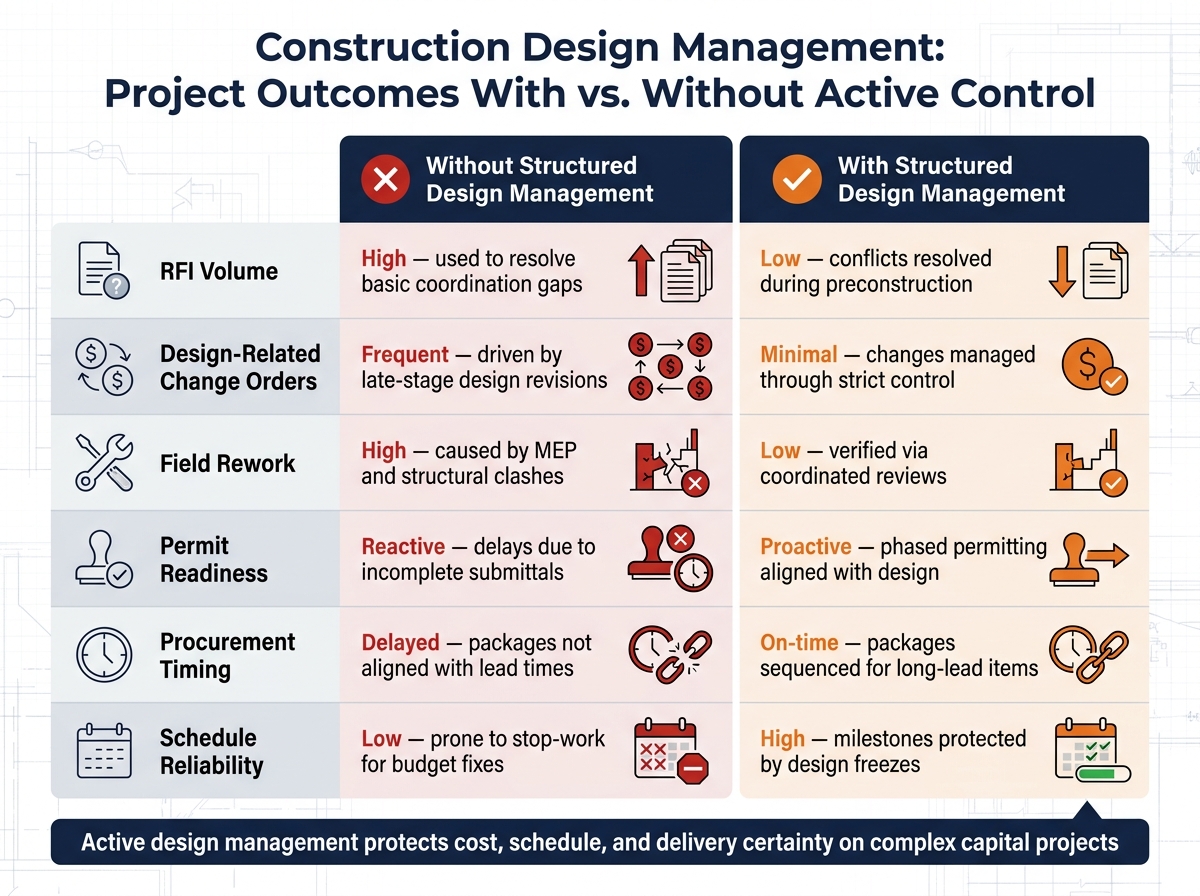

Construction Design Management: Project Outcomes With vs. Without Active Control
Without active management, design gaps stay hidden until the field exposes them. Then the damage shows up fast: missed coordination, slow approvals, and packages released before they're ready. Those issues don't stay on paper. They turn into fixes in the field, and those fixes cost money. That's the failure pattern owners are paying to avoid.
When architectural, structural, and MEP teams work in silos, their drawings often don't line up. A duct run hits a structural beam. An electrical route crosses plumbing. What looked fine in separate sets of drawings turns into a problem the moment trades start building.
In the field, those clashes become RFIs, rework, and expensive rework. And field fixes cost far more than catching the same issue during a coordinated model review in preconstruction. It's the difference between adjusting a model on a screen and pulling crews off installed work to make room for a system that doesn't fit.
That kind of rework does more than burn labor hours. It disrupts sequencing, throws off trade partners that are already scheduled and mobilized, and creates knock-on delays across the jobsite. On mission-critical projects, that chain reaction can put delivery commitments at risk.
Late design decisions throw procurement, permitting, and the guaranteed maximum price (GMP) off balance. If a design package isn't frozen soon enough to release a long-lead equipment order, the schedule slips. If structural or site work isn't finished early enough, phased permitting can stall construction before it starts. Each late decision adds more exposure to cost growth and schedule delay.
"One of the biggest roles a design manager plays is mediating major timing and risk decisions between the need to go build and the desire to keep designing." - Kabri Lehrman-Schmid, Superintendent & Project Leader, Hensel Phelps [1]
Untracked scope changes make things worse. Instead of making trade-offs early, the team gets pushed into reactive value engineering. That's when scope gets cut under pressure, not by plan. Budget control weakens, and the design itself starts to give way.
For owners, these breakdowns show up in ways that are hard to miss: budget drift, schedule slippage, and less certainty around delivery. On mission-critical projects, the risk isn't limited to design quality. It can threaten the go-live date.
| Project Outcome | Without Structured Design Management | With Structured Design Management |
|---|---|---|
| RFI Volume | High; often used to resolve basic coordination gaps | Low; conflicts resolved during preconstruction |
| Design-Related Change Orders | Frequent; driven by late-stage design revisions | Minimal; changes managed through strict control |
| Field Rework | High; caused by MEP and structural clashes | Low; verified via coordinated reviews |
| Permit Readiness | Reactive; delays due to incomplete submittals | Proactive; phased permitting aligned with design |
| Procurement Timing | Delayed; packages not aligned with lead times | On-time; packages sequenced for long-lead items |
| Schedule Reliability | Low; prone to stop-work for budget fixes | High; milestones protected by design freezes |
These are the exact breakdowns active design management is there to stop. The next section shows the controls owners buy to prevent those outcomes.
Owners pay for coordination, control, and risk reduction - not just drawing production.
That distinction matters more than it sounds. A lot of project trouble starts in the gap between the drawings people expect to receive and the control work needed to make those drawings usable in the field. The items below show what that scope looks like day to day.
At its core, design management is about running the system that keeps consultants aligned. That includes coordination meetings, action logs, and open-issue tracking across the full design team. If a conflict shows up in the BIM model, the design manager pushes it to resolution before anything gets released.
"Design managers are constantly tracking the exchange of information in all different mediums while maintaining a clear trail of decision-making that ties back to the contract and owner requirements." - Kabri Lehrman-Schmid, Superintendent & Project Leader, Hensel Phelps [1]
They also oversee drawing package completeness and version control through each phase: Schematic Design (SD), Design Development (DD), and Issued for Construction (IFC). In plain English, that means checking whether a package is ready to go, keeping revision logs current, and making sure everyone is working from the right drawing version.
Consultant performance is tracked against schedule commitments and package completeness. If design slips, procurement slips with it. And once procurement moves, construction feels it too.
The owner is paying for the process that turns design decisions into coordinated packages that are ready for release.
Design managers also keep a live eye on budget and schedule. They review cost as issues appear, not weeks later at the next estimate. If a high-cost item starts creeping in, it gets flagged early, while there’s still time to respond.
On schedule, they set design freeze milestones. These are fixed dates when parts of the design must be locked so the team can move on long-lead procurement and phased permit submissions. Without those dates, things can drift fast.
Permitting is part of that same control work. Design managers coordinate with local permitting authorities so submissions happen in the right sequence. That can mean getting site or structural approvals first, even if the full architectural package is still being finished. Done right, that sequencing keeps permit timing under control and helps the project avoid stalling while design is still moving.
Those controls show up in the deliverables below.
Owners are buying a control system with outputs they can track.
| Service | Owner Deliverable | Outcome |
|---|---|---|
| Design Coordination | Coordination logs, clash detection reports, coordinated BIM models | Fewer field clashes and reduced rework |
| Consultant Management | Consultant performance reports, meeting minutes | Accountability for schedule and package completeness |
| Budget & Cost Alignment | Cost review comments, value engineering logs | Protection against overruns and late-stage redesigns |
| Milestone & Schedule Tracking | Design freeze schedules, milestone tracking logs | Schedule certainty and on-time procurement |
| Constructability Review | Constructability reports, redlined drawing packages, revision logs | Lower execution risk and improved field efficiency |
| Permitting & AHJ Coordination | Permit trackers, submission readiness checklists | Reduced risk of permit delays or work stoppages |
| Drawing Package Oversight | Version-controlled SD, DD, and IFC packages | Consistency across teams and less rework from outdated drawings |
These aren’t just admin files sitting in a folder. They’re control records tied to cost, schedule, and execution certainty. Each deliverable shows that the work of coordination and control actually happened.
Once owners understand what design management covers, the next thing they want to know is simple: what is that control worth?
It pays off by stopping rework, scope drift, and schedule squeeze before they snowball. On data centers, life sciences facilities, advanced manufacturing plants, and hospitals, small misses can get expensive in a hurry. One missed handoff or one late design call doesn't just add admin work. It can trigger field rework and compress the schedule hard enough to burn through contingency.
ROI starts with problems caught before they hit the field. If a design manager spots a conflict early, the fix is far cheaper than dealing with it after concrete is poured or systems are already in place.
A lab project shows how this works in practice. Design management identified stainless steel exhaust ductwork as a major cost driver and changed the layout to stack lab spaces vertically, which cut ductwork length by nearly 30%.[1] For owners, that means less redesign and tighter control over costs.
"One of the biggest roles a design manager plays is mediating major timing and risk decisions between the need to go build and the desire to keep designing." - Kabri Lehrman-Schmid, Superintendent & Project Leader, Hensel Phelps [1]
Scope creep is the other big threat to cost. On complex capital programs, owner needs shift, stakeholders add requests, and small choices pile up over time. Without active change control, that added scope often shows up later as change orders. Design management helps keep contingency intact.
The same controls that protect cost also protect the delivery date.
On a fast-track infrastructure project, the team avoided a two-year delay by suspending an existing duct bank in place and building below it.[1] For owners, that means the project stays on track instead of absorbing a massive setback.
This kind of discipline also matters when owners are scaling programs across multiple sites. Commissioning tends to go more smoothly because MEP coordination is handled during design, not pushed to startup. Stable design also helps keep long-lead equipment on schedule. And for owners running repeat projects, that consistency is what makes delivery repeatable from site to site.
Controls only matter if someone owns them every day. And that value lasts only when the right people are in place to run the work. That's where many owners and developers hit a wall.
On the owner side, design management usually sits with a small group of key roles. Who owns it depends on the delivery method. On Design-Build and Progressive Design-Build projects, the contractor's design manager connects design intent to field execution and is accountable for constructability, cost alignment, and schedule sequencing. [1]
That lead role is backed by a broader team. Estimators and schedulers track how design changes affect budget and procurement timing as the work moves. MEP leaders coordinate mechanical, electrical, and plumbing systems so clashes are caught before construction starts. Commissioning managers check that the design meets end-user performance needs and regulatory requirements. [1][2] Each of these roles helps keep cost, schedule, and coordination under control.
The catch is simple: strong design managers need both design literacy and field experience. That's a hard mix to find, and it's not something most teams can hire for on short notice. [1]
When those roles are missing or only partly filled, the issue turns into delivery risk fast. Design freeze milestones slip. Consultant coordination starts to fray. Procurement falls behind because packages aren't sequenced the right way. [1][2]
This is where specialized recruiting comes in. It helps owners fill roles that need hybrid experience, including mission-critical construction roles like:
The goal isn't just staffing. It's closing capability gaps that can affect cost, schedule, and delivery certainty.
Design management is not a design service. It's a control function.
Owners who put money into it are paying for coordinated, buildable drawing packages, design-phase budget and schedule discipline, aligned consultants, permit-ready deliverables, and change control that helps protect cost and schedule. On complex capital programs, that mix makes delivery more predictable and easier to scale.
"For owners who aren't familiar with alternative delivery, the idea of a design manager may not immediately click. But when they see how this role supports their stakeholders, balances priorities and manages risk, it becomes a major factor in winning their trust." - Kabri Lehrman-Schmid, Superintendent & Project Leader, Hensel Phelps [1]
Design is the process of creating plans, drawings, and specifications. Design management is the work of guiding and coordinating that process so it stays aligned with project goals, including budget, schedule, constructability, and stakeholder needs.
It also covers consultant coordination, change control, risk management, and decision support. In plain English, it helps make sure the design supports successful project delivery, not just the production of drawings.
Owners should bring in design management early - ideally during planning and design - especially for complex or large-scale projects.
Getting design management involved at the start helps line up the project scope, budget, and schedule with the owner’s goals. It also improves coordination across architects, engineers, and regulatory agencies, which can save a lot of headaches later.
This matters even more for projects over $10 million, projects with multiple funding sources, or projects where operational continuity is critical. In those cases, early design management can help cut delays, cost overruns, conflicts, and interface risks.
Owners can see design management working when communication is clear, design milestones are tracked in real time, and everyone has a clear view of how design decisions affect cost, schedule, and constructability.
It also shows up in steady updates and clear alignment with the project’s goals.
