Per-MW pricing, regional variance, and cost drivers for owners scoping hyperscale & AI builds.
Salary benchmarks across the 14 mission-critical disciplines.
If you hire too late, RFS slips. On a U.S. data center build, the staffing plan should follow the project path from sitework to turnover, with key roles starting months before the work they support.
Here’s the short version:
A few numbers stand out:
The main point: I’d tie hiring to milestones like NTP, mobilization, dry-in, equipment set, energization, and RFS instead of waiting for the phase to start.
If I had to sum up the article in one line, it would be this: build the staffing plan like a construction schedule - phase by phase, with lead time built in.

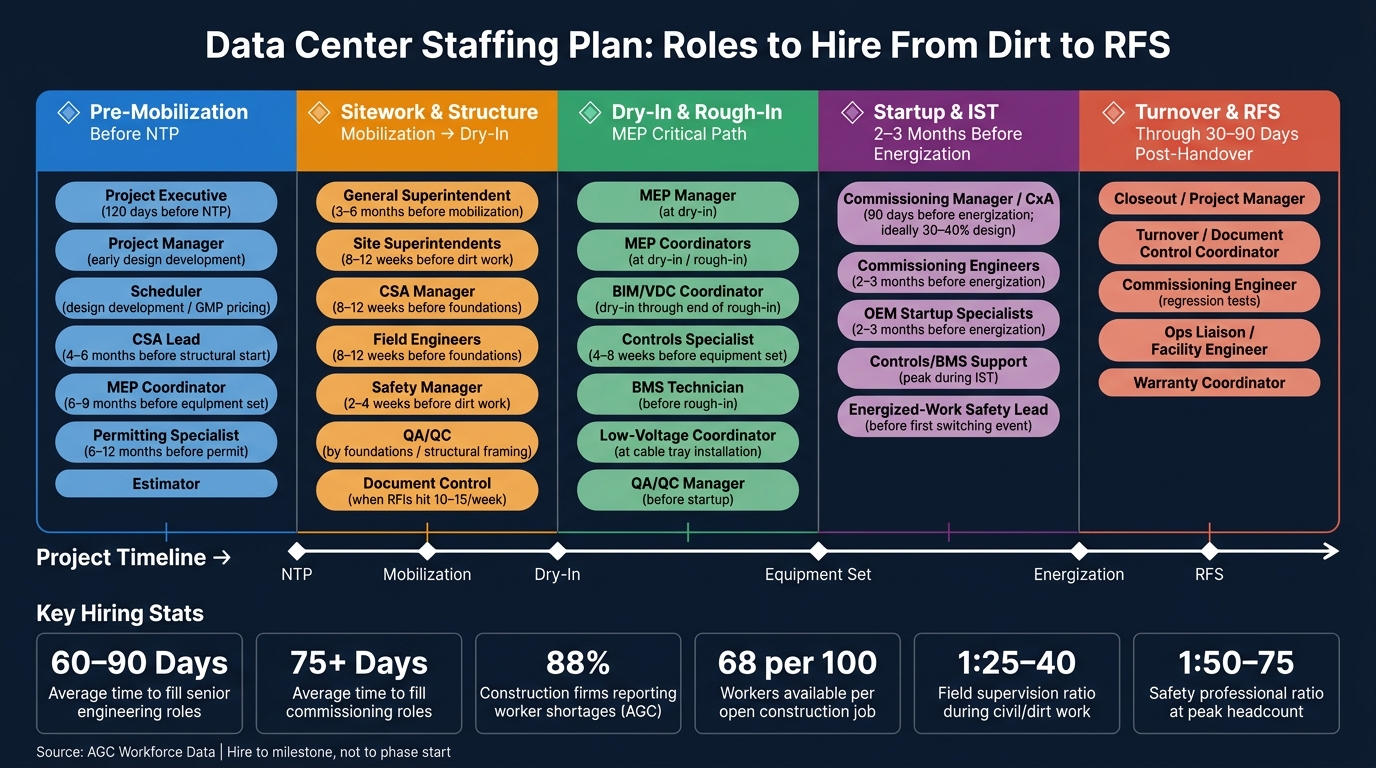

Data Center Staffing Timeline: Key Roles by Project Phase
Preconstruction choices - sequencing, trade buyout, and long-lead releases - set the cost and schedule baseline. That’s where a lot of the job is won or lost.
Put leadership in place before mobilization so the team can manage risk before it snowballs. The field team should be building from a plan that’s already settled, not trying to sort out big decisions after boots hit the ground.
These three roles are the governance backbone of a major U.S. data center build. They need to be on board well before the project reaches full speed.
On large hyperscale or colocation builds, all three are usually full-time hires from notice to proceed (NTP). The dollars at stake are high, and the number of parallel workstreams is simply too much for part-time oversight. In many active U.S. markets, developers and GCs now pre-assign these roles using 12–24 month project forecasts instead of waiting for each project’s NTP [1].
Once the PX, PM, and Scheduler are locked in, the next step is the technical preconstruction team.
A CSA lead handles civil, structural, and architectural constructability reviews. That includes earthwork volumes, foundation systems, steel frame sequencing, and early bid package setup.
An MEP design coordinator focuses on mechanical, electrical, and plumbing system integration. This role reviews designs for code compliance, maintainability, and routing conflicts before those issues turn into field headaches.
An estimator supports both roles by building cost models and checking that design choices stay on budget.
A permitting specialist tracks building permits, electrical and mechanical approvals, environmental permits, and utility connections with the local Authority Having Jurisdiction (AHJ).
Use full-time support for roles that touch design, procurement, and execution. Bring in contract help for narrow, time-bound work.
Tie hiring to fixed milestones: mobilization, structural start, major equipment set, commissioning start, and RFS.
Staffing usually peaks before the field ramps. Preconstruction comes first, then field execution takes the lead as mobilization starts. Once dirt moves, the staffing mix should shift from planning-heavy leadership to site leadership and field controls.
Once the baseline schedule is locked and the first civil subcontractor mobilizes, control moves from the office to the field. The staffing plan needs to move with it. This is where leadership stops being mostly planning and starts becoming daily field output.
The General Superintendent leads field strategy: site logistics, laydown areas, crane positioning, and day-to-day output across civil and structural trades. This person should be in place 3–6 months before mobilization so they can shape phasing plans, bid packaging, and early RFIs.
Site Superintendents handle oversight by zone or scope. On a large campus, one superintendent may run sitework and underground utilities, another may manage foundations and the structural frame, and a third may step in as the building envelope begins. Each one runs daily huddles, coordinates crews, and tracks inspections. Bring the first site superintendent on 8–12 weeks before major dirt work starts.
The CSA Manager works between the office and the field, sorting out design issues as they come up, including earthwork, rebar, formwork, steel connections, embeds, and envelope details. Field Engineers handle layout, tolerances, and as-built verification. That means setting control points, checking elevations, and confirming anchor bolt locations before pours. Both roles should mobilize 8–12 weeks before foundations start.
As more structural bays or buildings go active at the same time, add more site superintendents and field engineers so supervision doesn’t get stretched too thin. A good rule of thumb is 1 field supervision FTE per 25–40 workers during dirt work and foundations. Tighten that to 1:20–25 during structural steel and enclosure, when crane coordination and multi-level work drive up risk and coordination demands.
Bring in a dedicated Safety Manager 2–4 weeks before major dirt work to finish the safety plan, complete JSAs, and train subcontractors. On mission-critical sites, common benchmarks call for one full-time safety professional per 50–75 workers at peak, with more coverage during high-risk work such as deep excavations, large foundation pours, structural steel erection, and elevated work. [3][4] The Safety Manager should be part of weekly coordination meetings and pre-task planning so controls are built into the sequence early, not patched in later.
Assign QA/QC by the time foundations and structural framing begin, when hidden work starts to pile up. Add document control once RFIs and submittal returns reach 10–15 per week. [2][5] These roles help protect the work before later trades cover it up.
The General Superintendent, lead Site Superintendents, and CSA Manager are almost always full-time in-house roles. They hold company knowledge, owner relationships, and standards that need to stay steady across a program. In many cases, they move from one data center project to the next within the same campus or portfolio, so continuity matters.
Other roles tend to flex with the pace of the project, especially additional zone superintendents, extra field engineers, and document control staff. Those can often be filled with contract staff during peak periods and released when that phase wraps up. Safety usually lands somewhere in the middle. The lead Safety Manager stays in-house to keep reporting and site expectations steady, while extra safety reps may come in on contract when headcount jumps or when special skill sets - like crane safety or confined space coverage - are needed.
Use full-time staff for core field leadership. Use contract staff for peak-load supervision, field engineering, and document control when the project is temporary or the workload spikes.
As the shell goes up, the next staffing shift moves toward MEP, controls, and quality coverage.
Once the shell is dried in, MEP work starts driving the schedule. At that point, missed coordination can hit RFS fast. That’s why the team has to shift from shell-first leadership to systems-first coordination.
This is the stage where schedule control moves from structure to systems.
Bring in the MEP Manager at dry-in, before several trades working at the same time turn coordination gaps into RFIs and change orders. The MEP Manager owns the MEP critical path: scope interfaces, RFIs, change management, and subcontractor manpower alignment.
MEP Coordinators work closer to the field. They walk the job with foremen, check that field layout matches the coordinated model, and confirm prefabrication dimensions before fabrication is locked in.
A dedicated BIM/VDC Coordinator should be staffed full-time from dry-in through at least the end of rough-in. That role handles clash detection reports ranked by schedule impact, installation drawings that turn model coordinates into field-usable sheets, and coordination-grade models for major systems such as chilled water, power distribution, and containment. Many GCs put one MEP Manager and one BIM/VDC Coordinator on each major block at dry-in.
The cost of getting this wrong can be steep. Electrical coordination failures on data center projects have been estimated at $50–$150 per kW in avoidable rework. On a 10 MW facility, that equals $500,000–$1.5 million that a properly staffed MEP coordination team could have avoided. [12]
The Construction Industry Institute has linked up to 52% of all construction rework to design coordination errors and omissions. [13]
Controls specialists and BMS technicians need to start before controls rough-in and major equipment set, usually 4–8 weeks before major equipment like chillers, UPS systems, and switchgear is being set. [6][7] At this stage, their job is to finish I/O lists, point maps, and sequences of operations before devices are wired - not after.
If they show up only during testing, they inherit wiring mistakes already built into the job, undocumented field changes, and missing points that slow functional testing.
Low-voltage coordinators should ramp up alongside cable tray installation for controls, monitoring, and IT/telecom systems. They set segregation rules between power and data cabling, reserve tray space and elevation bands, and line up penetrations through fire and smoke assemblies. When these roles coordinate with MEP teams during weekly sessions - before rough-in fixes routing in place - the project avoids costly re-routing and extra penetration work that often happens when low-voltage gets treated like a late add-on. [8]
Add QA/QC before startup, with discipline inspectors and hold points for critical systems.
A QA/QC Manager should be in place before startup, backed by discipline-specific inspectors for electrical, mechanical, and controls. Their main deliverables are inspection and test plans (ITPs), pre-functional checklists, and hold-point sign-offs for critical systems such as busway joints and high-pressure piping.
Those checklists feed straight into commissioning readiness. Power distribution should have no open QA/QC items before energization. Flow and pressure readings should be verified before chiller functional testing begins. This staged gate approach means systems entering functional testing have already been checked for basic installation quality, which cuts down punch items that can throw off integrated systems testing and delay RFS. [9][10][11]
Once these roles are in place, the staffing plan can move from rough-in control to commissioning readiness. The next hiring wave should support commissioning, energization, and turnover.
As QA/QC winds down and systems get close to energization, the staffing plan changes fast. The job is no longer just about helping installation teams finish work. It becomes about commissioning, startup, safety, and turnover. This is the riskiest stretch of the project. Schedule pressure is high, systems are live or about to be live, and the team has to prove the site is ready for handoff.
The Commissioning Manager (CxA) is one of the most important early hires, and teams often bring this person in too late. A better move is to bring the CxA onboard by 30–40% design, or 6–9 months before first startup. That gives them time to help shape the Owner's Project Requirements (OPR), Basis of Design (BOD), and witness plans before any system is energized [15][16][17][19][20][24].
The CxA should own the commissioning plan, prefunctional checklists, functional test scripts, and the IST sequence. On larger projects, commissioning usually runs across several levels, from factory and site acceptance all the way through functional testing and IST. The CxA's role becomes most important during L4–L5 IST, when system interaction and failure response have to be tested under real conditions [14][17][18].
You also need to ramp up commissioning engineers, OEM startup specialists, and controls/BMS support 2–3 months before energization, then hit peak staffing during IST [14][16][17]. At the same time, put the energized-work safety lead onsite before the first switching event. That person should manage NFPA 70E, arc flash boundaries, LOTO, and pre-job briefs [14][16][17].
On large projects, owners often bring in an independent third-party CxA too. That helps keep commissioning objective and tied to owner needs, not just construction closeout pressure [20][21][22][23][24][25].
Once IST starts, the center of gravity shifts. The question is no longer, “Who do we need for startup?” It becomes, “Who stays in place to get the site fully handed over and running well?”
Most construction staff can demobilize at substantial completion. But the closeout team should stay through RFS and for 30–90 days after [14][16][17]. This is the handoff point between construction ownership and operations ownership, and it's where loose ends can cause the most pain.
That team usually includes:
Operations staff should be onsite full-time before RFS. They need to take part in alarm testing and tuning for BMS, EPMS, and DCIM so they can see how alarms behave in practice before customers feel the impact. A structured hot handover checklist should confirm a few simple but critical items: on-call rotations are active, OEM support contacts are confirmed, critical spares are onsite, and warranty triggers are understood.
Those roles and dates should feed the repeatable phase matrix in the next step.
The right staffing model depends on how often your organization builds. Some teams build enough to justify a steady internal group. Others need outside help to scale during startup and IST. In practice, this usually comes down to control versus flexibility.
Most developers land on a hybrid model: internal commissioning leadership with contract support during IST peaks. That setup keeps hard-won knowledge inside the company while giving the team room to scale when the schedule gets tight and the workload spikes.
Turn dirt, dry-in, energization, and RFS into a hiring calendar you can use again and again. The goal is simple: take the project lifecycle and turn it into a matrix that sets clear hiring triggers across sites.
A staffing matrix is one of the easiest ways to stop making hiring calls at the last minute. It links each role to a project phase, a milestone trigger, an expected duration, and the staffing model that makes the most sense. Think of it as a hiring calendar, not just another spreadsheet.
Hard-to-fill roles should be treated like long-lead equipment. Senior engineering roles often take 60–90 days to fill, and commissioning hires often take 75+ days.[28][29] If you wait until the phase begins to open those reqs, you’re late already.
The table below gives sample entries for five core roles. Use it as a starting point, then shift the start windows to fit your local permitting timeline, utility schedule, and delivery model.
Once the matrix is in place, use the same triggers across every site. Then adjust only headcount and sourcing by market.
For a multi-site U.S. portfolio, keep role definitions and milestone triggers the same from site to site. Regional teams can change headcount and sourcing tactics based on local labor conditions, and they should. But each project shouldn’t rebuild the role structure from scratch. That consistency is what makes the model repeatable.
This matrix is where phase planning turns into repeatable portfolio execution.
The data center labor market is tight. According to AGC workforce data, 88% of construction firms report difficulty finding workers, with about 68 workers available for every 100 open jobs.[27] More than 60% of data center providers report the same issue for specialized roles.[26] In plain English: teams that hire early and hire with structure have an edge.
That means hiring leadership before mobilization, adding field and QA/QC support before site headcount jumps, bringing MEP and controls in before critical-path work gets squeezed, and staffing commissioning early enough to shape testability.
The staffing matrix is the tool that makes those rules stick across a portfolio. Build it once, then refine it after each project using actual data - headcount curves, delay drivers, and change order patterns. Over time, it becomes a playbook your team can trust, not just a planning exercise.
For a smaller data center project, breadth matters more than deep specialization. The smartest setup is usually a lean internal team with people who can wear more than one hat. Then, when the work gets more intense, bring in an Owner's Engineer or specialty contractors for periods like startup or commissioning instead of adding full-time staff for every single discipline.
That approach keeps the core team light while still giving the project the support it needs at the right moments. It also works well when the same leaders need to handle site-wide operations, tenant fit-outs, and phased turnover without dropping the ball.
Focus on leaders who can move across functions and keep the whole site aligned. In a smaller project, that kind of range often matters more than narrow expertise in one lane. A hybrid staffing model like this helps protect quality and schedule discipline without the cost burden of a large permanent workforce.
For owners running multi-site programs, the main leadership and control roles should remain full-time and centralized. That setup helps keep standards, budget, and schedule aligned across every project instead of letting each site drift in its own direction.
These roles usually include the program project executive, development director, portfolio scheduler, central cost controls lead, and commissioning program lead. Site-level teams can then plug into that shared system to handle day-to-day execution and local permitting.
The clearest warning signs are reactive crisis management, schedule slippage, and leaning on executive guesswork instead of a structured, phase-based plan.
You probably hired too late if the team is always putting out fires, can’t see how design changes affect total cost, or has fuzzy role boundaries that make accountability hard to pin down. Those gaps often turn into technical bottlenecks or missed site details.
