Per-MW pricing, regional variance, and cost drivers for owners scoping hyperscale & AI builds.
Salary benchmarks across the 14 mission-critical disciplines.
If you get the foundation plan wrong, you can lose time, money, and key staff before steel even starts.
I see three big takeaways in this article:
Here’s the article in plain terms:
A few stats make the gap clear. Data hall slabs are often specified at FF 50 / FL 30 or better, while many standard commercial floors sit closer to FF 25 / FL 20. And some deep systems move at very different field rates, from about 4 to 10 drilled shafts per day to 40 to 80 driven piles per day in open conditions.
If you hire, design, or build under a data hall, I’d treat the foundation package as an early project decision - not a routine civil scope.
What happens below the slab shapes almost everything above it. Geotechnical findings affect foundation choice, schedule, and staffing, so the geotechnical report needs to spell out the soil profile, bearing capacity, and settlement behavior.
On large U.S. data hall projects, the investigation usually combines mechanical borings with cone penetration tests (CPTs). Borings give the team soil and rock logs, SPT blow counts, groundwater observations, and lab samples. CPTs add a continuous read on tip resistance, sleeve friction, and pore pressure. That matters because CPTs can flag soft layers and variable lenses that borings by themselves may miss. Put together, these tools give designers what they need to set bearing criteria and run settlement models for high rack loads and equipment foundations.
Some site conditions can rule out shallow foundations fast. High groundwater, expansive clays, collapsible soils, karst, and liquefiable sands often push the design toward ground improvement or deep foundations.
Cut-fill transitions inside the slab footprint need close attention too. When the building pad moves from a cut area into a fill area, the stiffness can change sharply. That kind of shift can lead to differential movement beyond mission-critical tolerances if the design team doesn't account for it. Common fixes include grade beams, stiffer slabs, or separate zones with different subgrade stiffness values in the settlement model.
Those findings usually point the job in one of three directions: stay shallow, improve the ground, or go deep.
Shallow foundations, such as spread footings and mats, make sense when the soils are competent, subsurface variability is low, and groundwater stays below footing level. In U.S. practice, mats on engineered fill often work in the 3,000–6,000 psf bearing range. A single-story data hall on uniform stiff clay can often use spread footings at 3,000–4,000 psf with a reinforced slab-on-grade.
When the soils are too soft or too loose for shallow foundations, but can still be improved, ground improvement becomes the middle path. Vibro-replacement stone columns are often used in granular problem soils. Deep soil mixing is common in cohesive soils. The aim is simple: stiffen the subgrade enough so a mat or spread footing can meet settlement limits. Teams usually verify the results with pre- and post-improvement CPTs or SPTs to confirm the target density and stiffness were reached.
If improved soils still can't meet the performance target, or if the site has thick soft organic clays, karst, or liquefaction-susceptible layers, the project shifts to deep foundations. That can mean driven piles, drilled shafts, augercast piles, micropiles, or helical piles, all used to transfer load down to competent strata.
Once that call is made, the civil scope turns into a sequencing job.
Bulk earthwork, dewatering, pile or shaft installation, pile caps and grade beams, and embed/MEP coordination need to happen in that order. Each step has to be checked before the next one starts. That's what protects both the schedule and the structural handoff.
A few misses at this stage can get expensive fast. Misplaced embeds are hard and costly to fix. Rushed or skipped density verification is one of the most common causes of rework on data hall jobs. The handoff at pile caps and grade beams also controls when steel erection can move ahead.
Before the slab is placed, the team needs to sort out rack embeds, equipment pads, power duct banks, fiber conduits, chilled water lines, and drain routing. If that coordination slips, crews end up cutting, patching, or reworking work that should have been right the first time. On a mission-critical build, a dedicated layout and QC role at this stage isn't optional.
That sequence shapes the field engineer, superintendent, and QA-QC staffing needs covered later.

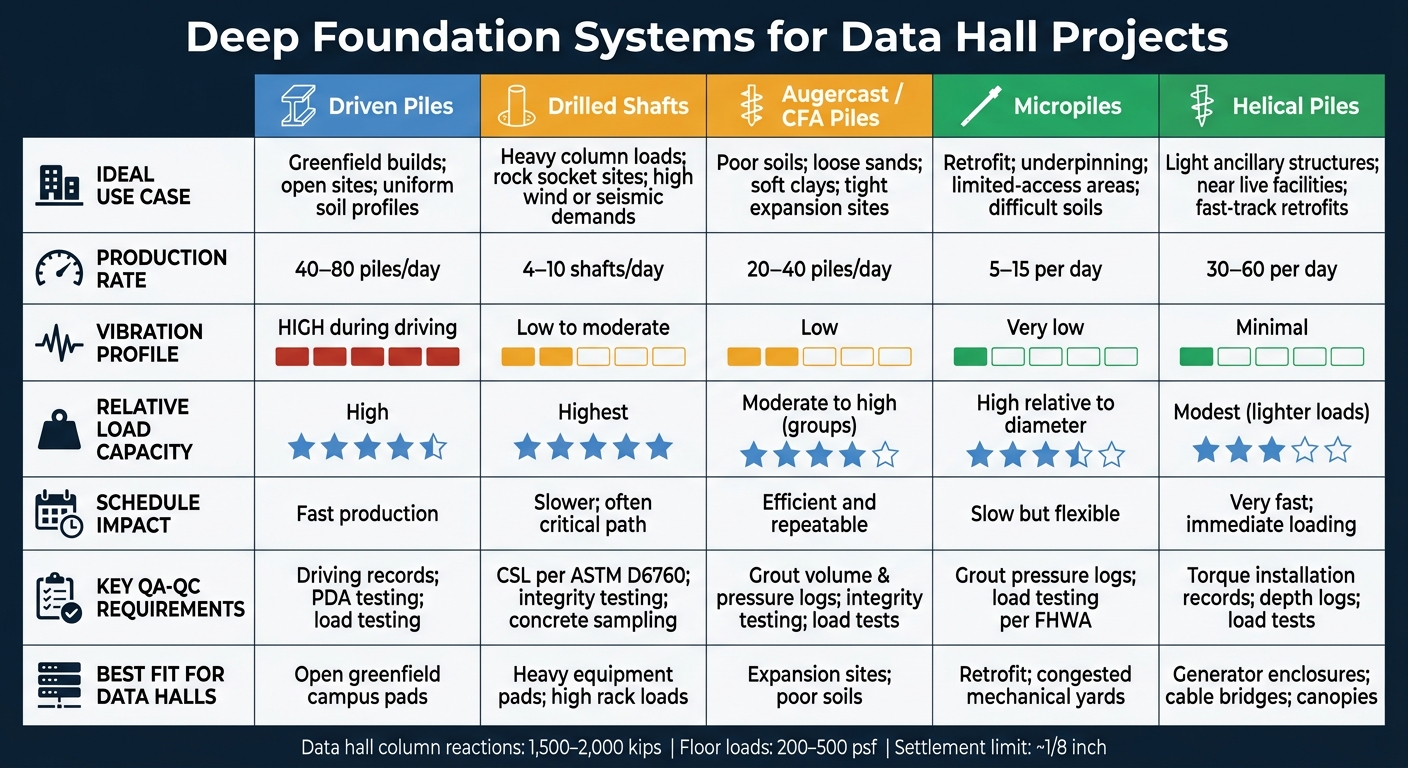

Deep Foundation Systems for Data Hall Projects: Side-by-Side Comparison
Once a geotechnical report points to deep foundations, the next call is picking the right system for the site. That choice matters more than it may seem on paper. Each option comes with its own build sequence, crew needs, and schedule rhythm. Pick the wrong one, and the job can burn time and money fast.
Driven piles - steel H-piles, pipe piles, or precast concrete sections - go into the ground with impact or vibratory hammers. They tend to fit greenfield campus projects with fairly even soil conditions, such as loose fill over deeper dense sand or stiff clay. The big upside is speed. On an open site, crews can move quickly. The downside is hard to ignore: noise and vibration. If the work is close to live white space or another operating facility, impact hammers can turn into a serious issue.
Drilled shafts, also called caissons, are large-diameter cast-in-place concrete elements drilled into the ground. In many cases, they extend into rock through a rock socket. These are often used for heavy column loads and large equipment pads, especially when axial loads and overturning forces are high or when vibration needs to stay low. One example stands out: Microsoft’s Fairwater AI campus in Wisconsin, a 3.3 GW two-story facility, required 46.6 miles of deep-foundation piles to support its massive electrical load and Blackwell GPU clusters.[1]
Augercast piles, also called CFA or ACIP piles, are built with a continuous flight auger. The auger drills down, then grout or concrete is pumped as the auger is pulled out. That process creates a low-vibration element with limited spoil. For poor soils, loose sands, soft clays, and tight expansion sites, that can be a strong fit. It’s often a practical answer when access is tight and disturbance has to stay low. A field example comes from the Terremark Data Center in Santa Clara, where 122 production Omega drilled displacement piles were installed at 18 inches in diameter and up to 86 feet deep, with compression test loads reaching 750 kips and about 15% pile length savings versus the initial design.[6][7]
Micropiles are small-diameter drilled elements reinforced with high-strength steel and grouted in place. They’re often used where larger rigs simply can’t get in. That makes them common in retrofit and underpinning work, congested mechanical yards, and other tight-access areas. They also help when subsurface conditions are difficult or uneven from one spot to the next.
Helical piles are steel shafts installed by torque, with helical plates that develop capacity through bearing and friction. They create very little vibration, almost no spoil, and they can be loaded right away. For lighter support work - generator enclosures, cable bridges, canopies, and other tasks near operating facilities - they’re often the cleanest option.
Buildability matters just as much as the design itself. Driven piles can move fast, often in the range of 40 to 80 piles per day on open greenfield grids. They also avoid slurry and casing work. But there’s a catch: refusal can show up at depths no one expected, and pile damage may not show itself until testing.
Drilled shafts move more slowly, usually around 4 to 10 shafts per day. They also come with heavier field demands: casing and slurry in unstable ground, spoil handling, rebar cage work, and concrete placement with inspection at every step. On many jobs, that makes them critical-path work for the structural package. If the schedule has no cushion here, the whole sequence can tighten up fast.
Augercast piles sit in the middle, at about 20 to 40 piles per day in good conditions. Their cycle is repeatable, which works well for large, even grids under data halls. Micropiles are slower, often about 5 to 15 per day, but they make possible the kind of work other systems just can’t handle in retrofit or tight-access settings. Helical piles can hit 30 to 60 per day for shallow depths and lighter loads, usually with a small crew and very little concrete work.
In the field, the best choice usually comes down to a few plain questions:
The handoff from the foundation installer to the pile cap and grade beam crews is one of the main schedule gates. Concrete cure time, load test results, and inspection sign-offs all need to clear before the structural package can move ahead. On drilled shaft work, crosshole sonic logging (CSL) is usually performed 3 to 7 days after casting, which puts a built-in lag into the schedule.[4][5] If that window is missing from the CPM, teams often end up squeezing the structural steel start with no practical way to make the lost time back.
Once the substructure package starts, production rates, testing, and acceptance start to drive the job. This is the point where a project moves from excavation toward structure, and deep foundation risk control often decides whether the data hall stays on schedule after award.
When site conditions don't line up with the geotechnical report, schedule float disappears fast. On deep foundation work, the worst surprises usually come from a short list of issues.
Unknown or shifting rock depth can wreck pile termination assumptions and force a redesign in the middle of production. That change can ripple into rebar fabrication, concrete quantities, and inspection planning. Unexpected groundwater slows drilling, brings in casing or slurry needs, and can even force a corrosion protection redesign. Bad fill and shifting refusal layers often lead to rejected pile attempts, unplanned predrilling, or even a switch to another foundation system mid-job.
Shaft instability in loose or soft soils creates another headache. It can cause necking or inclusions that may not show up until integrity testing, after the concrete has already cured. Then there are owner-driven layout changes. Those don't just move a few lines on a drawing. They can trigger revised foundation layouts, new rebar details, and resequenced field work.
The table below ties each risk to the schedule or quality issue it tends to cause, along with the mitigation steps often used on U.S. data hall projects.
A risk register should be in place before award, with probability and impact ratings for each condition and a response plan tied to each one. Treat the first production day like a live baseline check. Compare actual field conditions against the report, and agree ahead of time on stop-work criteria if rock elevation or groundwater depth drifts past a set threshold.
The same geotechnical unknowns that threaten production also shape the QC checks that protect acceptance.
Contractor QC and owner QA are not the same thing. Mixing them up is a common mistake on fast-tracked jobs. Contractor QC is process control in real time: drilling records, spoil logs, slurry properties, concrete placement details, rebar checks, and elevation verification. Owner QA is an independent check that QC is doing its job and that the finished foundation elements meet performance requirements. FHWA guidance says this plainly: inspection records, paired with integrity testing, form the main basis of quality assurance for drilled shafts.[3]
Concrete performance needs close attention. Mission-critical data center foundations usually require minimum 28-day compressive strengths, with cylinders tested at 7 and 28 days. During placement and cure, track concrete temperature, slump, and strength against the project spec. If cylinder breaks come in low, that does not mean automatic removal. The next step is a structured review by the structural and geotechnical engineers to check capacity margin. From there, the team may move to supplemental load testing or, in severe cases, grouting or replacement.
The table below shows the main integrity testing methods used on U.S. data hall projects, what each method produces, and how the results feed into acceptance or remediation.
The base cleanliness check is a hold point that should never be skipped on end-bearing shafts. Document base-cleanliness checks before rebar and concrete placement.
CSL testing windows also need to be built into the CPM. If test timing slips, downstream work can slip with it. These controls break down when the site team can't record field conditions fast enough to act on them.
That is why mission-critical foundation work depends on field engineers, superintendents, and QA-QC specialists who possess the key skills for data center construction who can document conditions without slowing production.
A risk register only helps the schedule when the right people own layout, production, and acceptance. And those controls only hold up when the field team can execute day after day. On deep foundation packages beneath data halls, three roles matter most: the field engineer, the superintendent, and the QA-QC professional. Each one owns a different part of the work. If even one is weak, schedule slips and quality issues can show up fast.
A superintendent on deep foundations may own driven piles, drilled shafts, micropiles, auger cast piles, soil mixing, and support-of-excavation work. [10]
Once those roles are clear, hiring should focus on proven field ownership, not just broad civil experience.
Hire for direct deep-foundation ownership, schedule recovery, documentation discipline, and safety leadership. The best candidates can name the exact foundation system they ran, spell out the production rates they tracked, and walk through what they did when site conditions drifted from the geotechnical report.
Paperwork matters just as much as production. A strong hire should be able to talk through inspection logs, pile records, and concrete tickets that passed owner audits without gaps. And on sites with multiple drilling rigs and heavy equipment moving at once, safety leadership isn't optional.
One hiring detail is easy to miss, but it matters a lot: incorrectly placed embeds and anchor bolts are among the most expensive small mistakes on a data hall job. [9] That means a field engineer who understands how layout precision affects downstream structural cost is often a much better hire than someone who just follows the plan without thinking ahead.
Employers staffing deep foundation packages for U.S. data halls can start a targeted search at iRecruit.co/contact. iRecruit.co screens for the experience signals that matter most on mission-critical builds - direct pile and shaft experience, geotechnical literacy, and documentation discipline - so hiring teams spend less time sorting through resumes and more time talking with high-fit candidates.
The same proof that helps employers hire also helps candidates stand out. If you've worked on deep foundations, get specific. Don't just say you have drilled shaft experience. Show the system used, the daily production rate achieved, how many shafts were installed, and which testing methods were used for acceptance. Numbers tell a much stronger story than a job title ever will.
The same goes for QA-QC work. Be specific about the test methods you've worked with, how you handled a nonconformance, and any owner or hyperscale-specific QA-QC programs you've supported. If you've presented foundation status, risk updates, or test results directly to hyperscale owners or their representatives, put that front and center. That kind of owner-facing communication shows a level of maturity employers want on mission-critical work.
Senior candidates for data hall foundation roles can register at iRecruit.co/candidate-sign-up to connect with employers staffing deep foundation and mission-critical construction scopes.
A data hall project should move to deep foundations when geotechnical assessments and site feasibility studies show that the native soil can’t safely carry the building’s structural loads.
That call should be locked in during the design and engineering phase, usually 6 to 12 months before construction. Making the choice early helps address bearing-capacity issues before they turn into schedule delays, redesigns, or costly rework.
The available materials do not point to one deep foundation system as the clear winner for the lowest schedule risk.
Instead, they make a different point: schedule risk usually comes down to how the project is planned and executed, not to a head-to-head ranking of deep foundation methods.
More specifically, the materials say schedule risk can be cut by:
So if you're looking for a direct claim that one deep foundation option has less schedule risk than the rest, it isn't there.
Prioritize candidates with direct campus-scale construction experience over people whose background is mainly in general commercial or mixed-use work.
You want superintendents and field engineers who know how to sequence dense, multi-trade logistics and earthwork. That kind of hands-on planning can help prevent costly schedule drift.
Experience from industrial jobs like semiconductor, pharmaceutical, or large energy projects also tends to transfer well to mission-critical builds.
It also helps to find people with a proven record of managing foundation work alongside early mechanical and electrical rough-ins, backed by strong safety habits and tight documentation.
