To move up in facilities, I’d build proof that I can handle the next role - not just count years on the job. Start with three to five skill gaps, choose assignments with your supervisor, and review results at 30, 60, and 90 days.
Here’s how I’d map the path:
The shift is simple: do the work, lead the team, then own facility results. In data centers and advanced manufacturing, I’d track safe execution, repeat failures, spending, and verified recovery - not just completed tasks.
My rule: <u>match your promotion evidence to the scope of the next job</u>. Keep approved plans, work records, team results, and cost reports that show what changed because of your decisions.

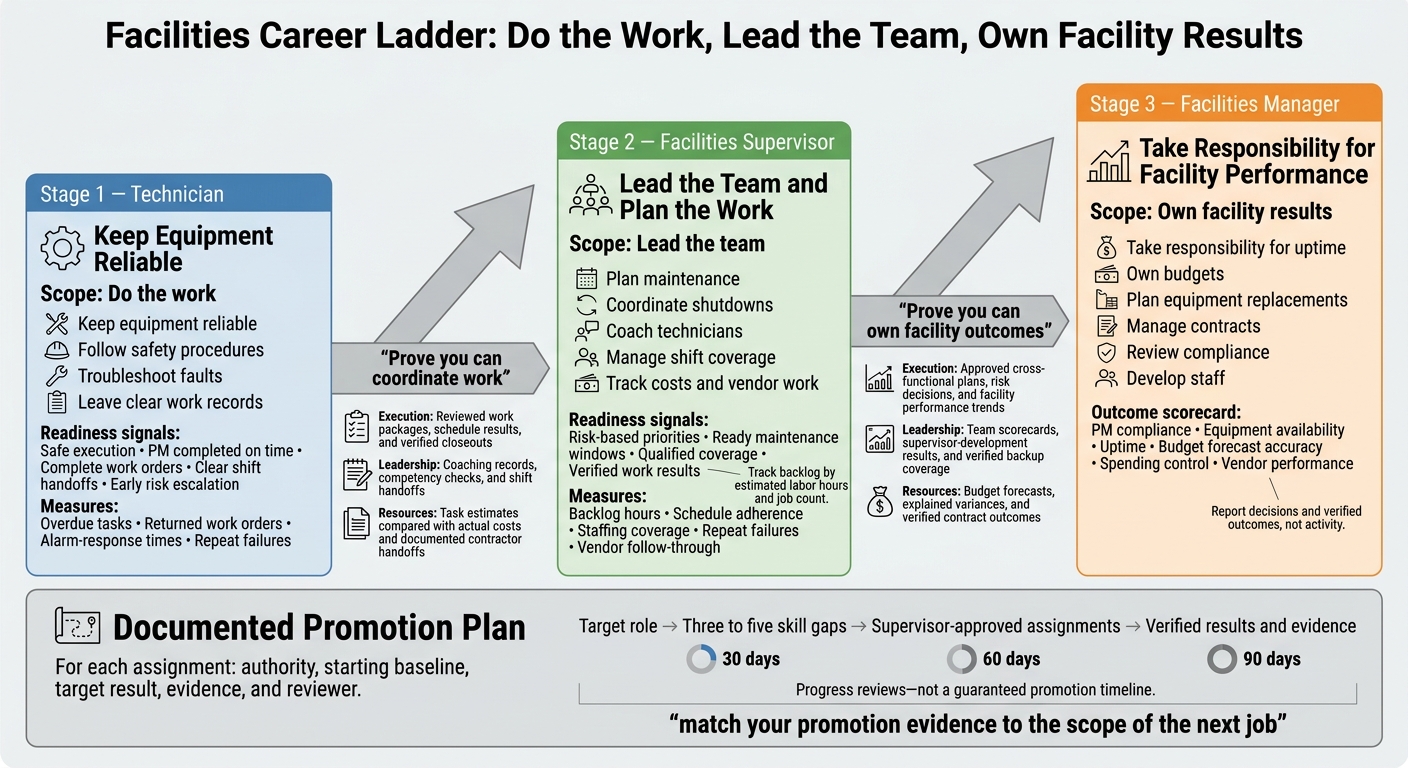

Facilities Career Ladder: Technician to Facilities Manager
A technician’s day includes inspections, PM, troubleshooting, alarm response, and CMMS records. Those records show that work was completed reliably. In data centers, UPS batteries, generators, and cooling systems support availability. In manufacturing, compressed air and process cooling help keep production running. Inspect for changing conditions - not just completed tasks. Record temperature, pressure, vibration, leaks, and alarms against limits or baselines.
Build your knowledge of electrical distribution, pumps and motors, HVAC, controls, and fire and life safety systems. Stay within your documented qualifications. Permission to inspect a UPS does not authorize you to open energized equipment or change protection settings. Use SOPs for normal operation, MOPs for reviewed maintenance or changes, and EOPs for abnormal conditions. If actual conditions differ from the procedure, stop and escalate.
When servicing requires energy isolation, follow the equipment-specific lockout/tagout (LOTO) procedure. Identify energy sources, shut down, isolate, apply the required locks or tags, release or restrain stored energy, and verify isolation before starting work.[4][5] A stopped motor can still pose electrical, mechanical, or pressure hazards.
Before closing a CMMS work order, record the asset, timestamps, symptoms, measurements, safety controls, repair, test results, return-to-service status, and unresolved defects. Give the next technician enough information to continue safely.
Show that you can work safely, complete PM on time, submit complete work orders, provide clear shift handoffs, and flag risks to redundancy or production early. Your promotion case should show that you can handle your own work consistently enough to support others.
Track overdue tasks, returned work orders, alarm-response times, and repeat failures. Set targets with your supervisor rather than using a universal threshold. During emergencies, follow the EOP and keep communications clear. For recurring faults, collect alarm text, trends, operating conditions, and repair history so the team can separate the immediate fix from the underlying cause. These habits help you move from completing your own work to coordinating a team.
Hypothetical cooling-system fault: AHU-3 supply air reaches 78°F at 2:10 p.m., with increased fan vibration and visible belt wear. The technician checks the high-temperature EOP, confirms available cooling redundancy, and notifies the shift lead instead of simply resetting the alarm. Under approved procedures and required LOTO, the belt is replaced; supply air is then verified at 62°F for 20 minutes. The CMMS record captures readings, notifications, and test results, with follow-up work for alignment inspection. This approach checks recovery without treating belt replacement as proof that the underlying fault is solved.
Choose assignments with clear limits, a supervisor-approved scope, and a reviewer. Audit 10 recurring work orders to improve documentation and handoffs. Shadow an authorized electrician to strengthen your electrical knowledge, compare controls trends with field readings, or take responsibility for follow-up on a repeat fault for 30, 60, or 90 days.
You can also take responsibility for a defined equipment group, improve one PM task, coach a newer technician on an approved procedure, or prepare a weekly maintenance schedule. These assignments provide evidence of supervisor readiness while building the documentation, judgment, and communication skills needed to lead work - not just perform it.
Choose training or credentials that match the next role’s requirements, but keep them separate from equipment-specific authorization.
Once you can handle your own work reliably, the next step is managing the team’s priorities, coverage, and schedule. As a supervisor, you manage execution - not every repair. Rank work by safety, environmental, mission, uptime, and production risk. The career path moves from completing work to coordinating it, then owning facility performance.
Track backlog by estimated labor hours and job count. At every shift handoff, review overdue critical work, blocked jobs, qualified shift coverage, and emergency response capacity. Work through competing needs with operations, engineering, safety, security, IT, and production.[6][9][11]
Protect time for preventive maintenance in the weekly schedule while accounting for repairs, training, leave, and emergency coverage. Before releasing a maintenance window, confirm the scope, procedure, staffing, parts, tools, permits, approvals, and acceptance tests.
Check equipment dependencies and remaining redundancy. Document contingency actions and restoration steps. Having enough labor doesn’t mean a job is ready. Use change control for deviations, identify escalation contacts, and record follow-up actions.[7][8][11][15]
Hypothetical example - data-center generator maintenance: For Generator 2’s annual load-bank test, verify Generator 1, the alternate power path, UPS battery capacity, fuel, and monitoring before operations approves reduced redundancy. Assign one technician to field checks, one to control-room monitoring, and an approved vendor to perform the load-bank test. Set hold points before transfer testing and before returning the generator to automatic mode. If an unexpected alarm appears, stop the sequence and escalate. Closeout requires test readings, transfer results, deficiencies, and confirmation that redundancy is restored.[8][10][13]
Hypothetical example - advanced manufacturing shutdown: Before compressed-air, chilled-water, and electrical maintenance, map dependencies on production tools, environmental controls, and safety systems. Confirm isolation boundaries, permits, spare parts, contractor scope, and restart authority. Sequence isolation, repair, inspection, testing, and controlled restart; communicate delays to production and engineering. Completion requires utilities within operating specifications, tested alarms and interlocks, production acceptance, and records of actual labor, parts, and follow-up work.[12][14][15]
Apply that same planning discipline to budgets, vendor control, and team leadership.
Use these benchmarks to show you can manage execution at the next level.
Show consistent results over several months through work packages, shift records, incident communications, and manager-validated outcomes - not your personal work-order volume.[6][9][14]
Estimate labor, parts, rentals, and contractor costs, then compare those estimates with actual spending. Before approval, review vendor scope and acceptance criteria.
Maintain staffing and compliance controls through delegation and feedback tied to specific behaviors. In incident reviews, present the facts, timeline, controls, root cause, and corrective actions.
Keep a monthly log of backlog hours, schedule adherence, staffing coverage, repeat failures, and vendor follow-through to show you’re ready for a manager role.[6][11][14]
At this level, you move from coordinating work to owning facility outcomes. You own the operating plan and its results: reliability, uptime, safety, compliance, staff capability, and financial performance. Assign owners and set approval limits, escalation thresholds, and a reporting schedule. In data centers, manage power, cooling, controls, fuel, and monitoring as one reliability system - not separate maintenance programs. Uptime Institute reported that 53% of data-center operators in its 2024 survey had experienced an outage in the preceding three years. That’s industry context, not a forecast for your site.[16] Connect readiness to commissioning and turnover requirements.
Ownership starts with a clear handoff from engineering and construction. Before accepting a system, require asset records, as-built drawings, operating sequences, test results, warranties, training, and named owners for remaining deficiencies. For manufacturing shutdowns, agree with operations on scope, isolation plans, contingency equipment, restart criteria, and communication plans. Construction completion does not mean the system is ready for use. After turnover, staff must be able to operate, maintain, and safely restore the equipment.
Use finance policy to separate operating expenses from capital replacement costs. Own the monthly forecast by comparing the approved budget with actual spending, committed costs, and forecast-to-complete costs.
Rank replacements by condition, failure consequences, redundancy, parts availability, and lead time - not age alone. Schedule replacements to protect uptime. Spell out lifecycle costs and the risk of delaying work, and use the risk register to justify contingency reserves.
With spending and replacement plans in place, control how outside work is scoped and verified.
Set contract terms that protect reliability, safety, and continuity. Cover response and restoration commitments, qualifications, access controls, safety requirements, and acceptance records. Enforce service levels, and factor unresolved service failures into escalation and renewal decisions.
Maintain a compliance calendar and controlled records for inspections, permits, training, and corrective actions. Develop supervisors through commissioning assignments and emergency exercises. Use a skills matrix to verify primary and backup coverage for critical systems. Turn skill gaps into hiring needs linked to business risk, shift coverage, and first-year targets.
Put these responsibilities into a monthly scorecard. Report decisions and verified outcomes, not activity. Show facility-wide results through PM compliance, equipment availability, uptime, budget forecast accuracy, spending control, and vendor performance. Keep each measure’s scope and calculation consistent.
Include supervisors qualified for independent coverage and projects completed without disruption. Back up this proof of management readiness with financial, work-management, testing, and incident records. State the remaining risk, tradeoffs, and approvals needed - not just whether the metric is green.
Use the benchmarks above to put your career goals into a documented promotion plan. Map your path from safe technical work to team coordination, then to facility-wide accountability for uptime, compliance, cost, risk, and asset performance.
Build a one-page plan that names your target role, three to five skill gaps, and a reviewer. For each assignment, spell out your authority, starting baseline, target result, and evidence you’ll keep. Check progress at 30, 60, and 90 days. Put assignments that combine safe work, measurable reliability gains, and coordination across teams first.
Your evidence should match the scope of the next role, not just show that you completed more work. Use this table to check that match.
Check that you have proof of performance, not just time on the job.
Keep your portfolio organized: work records, approved plans, incident lessons, staff-development results, and financial or vendor outcomes. Remove confidential site, customer, security, and pricing details while keeping your decisions and verified results.
Becoming a facilities manager typically takes 6 to 15 years in mission-critical environments [1][2]. A military technical background can sometimes shorten that path to 5 to 7 years [1].
But there’s no fixed timeline. Readiness depends on owning day-to-day operations, responding to incidents, and managing complex mechanical and electrical systems. You also need to show leadership in budgeting, staff management, and vendor coordination - and take responsibility for uptime across the entire site. It’s about what you can manage, not just how long you’ve worked [1][3][2].
Focus on credentials that cover safety and technical infrastructure. Start with OSHA 30-Hour Construction for site access and supervisory safety. If you work with electrical systems, NFPA 70E covers arc-flash risks and safety protocols.
For facility operations, consider the vendor-neutral Certified Data Centre Professional (CDCP). As you move into management or commissioning, look at Certified Data Centre Project Manager (CDCPM) or project-focused certifications like PMP.
Move beyond completing tasks and take ownership of how the site runs. Step into shift lead duties: mentor junior staff, coordinate outage responses, and approve Methods of Procedure (MOPs). Volunteer for capacity upgrades or DCIM rollouts, and write or update runbooks, SOPs, and EOPs.
Take charge of small projects, preventive maintenance planning, and vendor coordination. These responsibilities show that you can manage outcomes and improve site performance.
