The short version: I see this as a U.S. mine-to-magnet buildout backed by money, demand support, and price protection. MP Materials is linking Mountain Pass, CA, Fort Worth, TX, and Northlake, TX into one supply chain, with a plan to reach about 10,000 metric tons per year of NdFeB magnet output by 2028.
If you want the core takeaway fast, here it is:
This matters because the plan is not just about digging ore out of the ground. It is about getting from mine -> oxide -> metal -> alloy -> magnet inside the United States, while lining up the plants, equipment, and people needed to make that chain work.
Quick comparison
What stands out to me is how the funding changes delivery. With upfront capital, a buyer locked in, and downside price support, MP Materials can move on plant buildout, equipment orders, startup planning, and hiring and training the workforce with more certainty than a normal commodity-linked project would have.

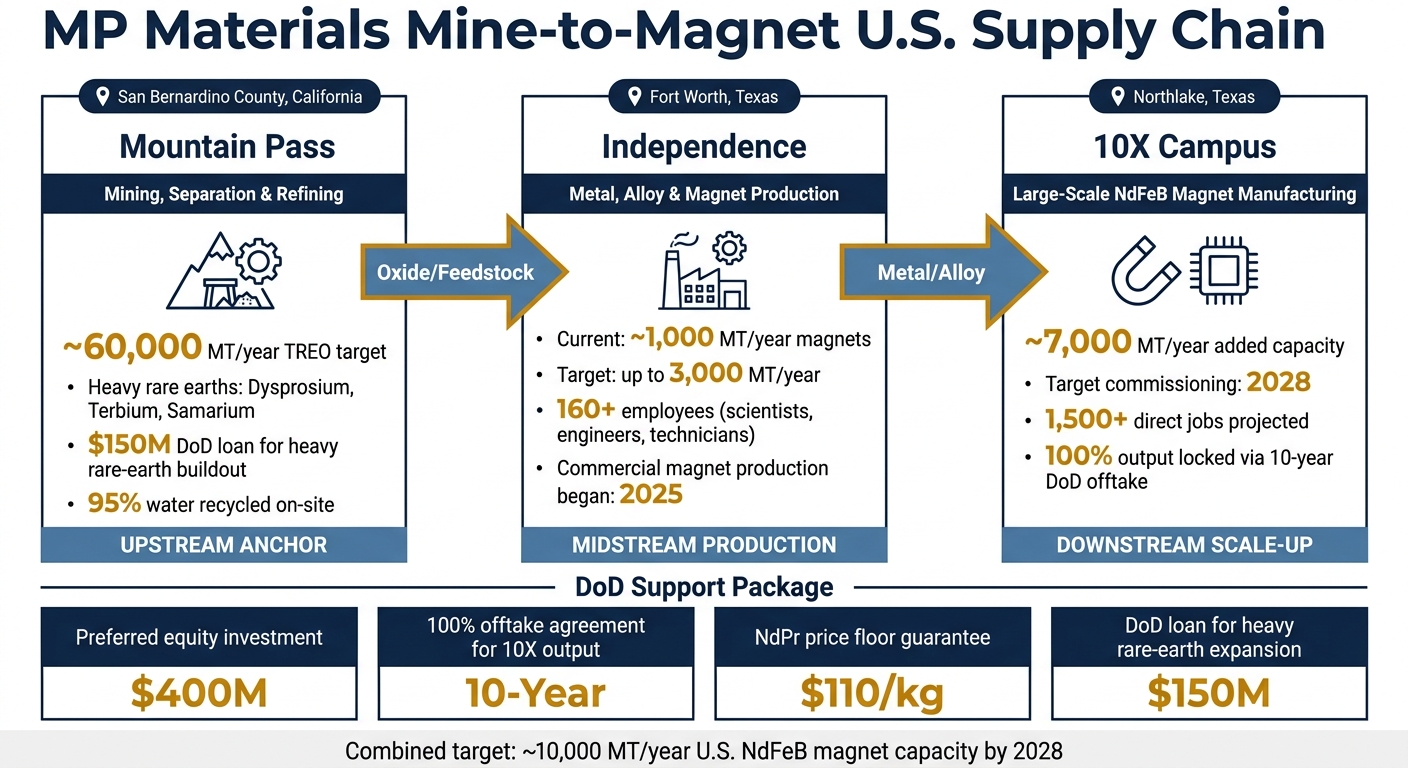

MP Materials Mine-to-Magnet Supply Chain: 3 Sites, 1 U.S. Rare-Earth Strategy
Mountain Pass in California is MP Materials' integrated upstream rare-earth mine and processing site. At one location, the company mines ore, upgrades it, runs flotation to make high-purity concentrate, and then separates, refines, and finishes material before shipping it to downstream facilities[12][13].
The site is growing, too. MP Materials is aiming for TREO output of about 60,000 metric tons per year and adding new separation circuits for heavy rare earths such as dysprosium, terbium, and samarium[8][14]. A $150 million DoD loan is helping fund that heavy rare-earth buildout[11][14]. Those materials matter because they go into high-temperature, high-performance magnets used in military and aerospace systems.
That makes Mountain Pass the pace setter for what happens in Texas. If upstream output slips, downstream startup gets harder. Put simply, production at the mine only helps if material arrives in Texas on a steady schedule.
Once feedstock is ready upstream, the Texas sites turn it into metal, alloys, and magnets. Independence, on Independence Parkway in Fort Worth, Texas, is MP Materials' downstream metal and magnet facility[2][7]. It converts refined Mountain Pass feedstock into metals, alloys, and finished NdFeB magnets. The site includes metalization, alloying, powder production, pressing, sintering, machining, finishing, and recycling[10][7].
That isn't the kind of plant you flip on all at once. The process has to come online in stages, with each step lined up carefully. Independence began commercial metal production in 2024. In 2025, it first produced alloy flake and finished magnets on commercial production lines, bringing back end-to-end U.S. magnet production[19].
Independence now runs at about 1,000 metric tons per year, with a route to 3,000 metric tons per year[3][5][21]. How far and how fast it scales depends in part on the capital structure.
The planned 10X campus in Northlake, Texas, adds about 7,000 metric tons per year of magnet capacity and is set for commissioning in 2028[10][16][1][4]. The campus is expected to employ more than 1,500 people[3][17]. Being close to Independence gives MP Materials a practical edge: it can share labor, logistics, and startup support across both Texas locations. That matters a lot when you're trying to ramp one magnet site while building another.
The DoD package lowers risk in three main ways. The $400 million preferred equity investment gives MP Materials upfront capital. The 10-year offtake agreement for 100% of 10X output removes demand uncertainty. And the $110-per-kilogram NdPr price floor helps shield the project from commodity price swings[6][11][14][4].
Together, those terms change what MP Materials can get done. The package gives the company room to order long-lead equipment earlier and move through commissioning with less exposure to market risk. It also lets MP Materials set up EPC contracts around known revenue baselines, with initial lines qualifying defense-grade product before later capacity additions come online[6][5].
Then there's the rest of the funding stack. Add $1 billion in debt financing from JPMorgan and Goldman Sachs, plus $200 million in public support from Texas, Denton County, and Northlake, and the 10X campus ends up with a financing package that would be tough to assemble through private markets alone for a plant of this type and scale[7][17][18].
Those differences between Mountain Pass, Independence, and 10X lead to very different needs on construction, startup sequencing, and hiring.
Because the MP Materials buildout covers mining, separation, and magnet manufacturing, delivery risk shifts from site to site. Each facility moves through the same basic path - FEED, detailed engineering, procurement, construction, commissioning, and ramp-up - but the trouble spots are different depending on the plant.
FEED sets the process configuration, equipment specifications, utilities, and layout. If mistakes slip in here, they tend to show up later as change orders, rework, and startup delays. The handoff from FEED to detailed engineering is one of the riskiest moments on any industrial project. That’s the point where scope gets locked, and procurement has to move fast on long-lead equipment. For 10X, that procurement window is especially tight.
That’s when staffing and sequencing stop being side issues and become central to delivery.
Commissioning is the other big strain point. These facilities don’t switch on all at once. They’re integrated chemical and materials-processing systems, so startup has to happen in a specific sequence. To make that work, process engineers, controls specialists, E&I technicians, and operations leaders need to be in place before mechanical completion - not brought in at the last minute.
The scopes that put the most pressure on cost and schedule include hydrometallurgical processing systems, metallization and alloying lines, sintering and machining areas, power distribution, hazardous materials handling, water systems, environmental controls, and QA/QC infrastructure. At Mountain Pass, the upstream scope is built around mining, wet processing, separation, and product finishing. Each one brings its own utility, reagent, and permitting demands.
On the upstream side, wet-chemical processing circuits are some of the heaviest capital items. They need corrosion-resistant materials throughout the system, complex reagent handling, multi-stage solvent extraction, and wastewater treatment. Tailings management alone can turn into a major capex line. Lined storage facilities and water recycling systems add a lot of engineering weight to the project. MP Materials reports that around 95% of the water used at Mountain Pass comes from on-site recycled sources,[23] which shows how early these systems need to be thought through.
At Independence and 10X, magnet lines depend on inert-atmosphere processing, tight temperature control, powder handling, and strict quality control. Once you add machining, surface coating, and QA/QC infrastructure, the scope starts to look much closer to advanced manufacturing than standard industrial construction.[24][25][26]
Upstream and downstream facilities both carry risk. They just break in different places. For construction leaders and hiring managers, that difference matters.
Each site needs its own execution plan and its own hiring mix. Those differences shape which construction, engineering, commissioning, and operations roles need to be in place first.
These facility differences lead to very different hiring plans. Labor demand changes by site and by project phase, so recruiting has to be staged years before startup.
The role mix changes a lot depending on where a plant sits in the supply chain. Upstream plants need more mining, processing, and maintenance talent. Downstream plants lean harder on automation, QA/QC, and commissioning.
At Mountain Pass, the upstream scope depends on project managers, civil/structural/mechanical engineers, process engineers, metallurgists, controls engineers, commissioning managers, QA/QC leaders, EHS managers, and operators. Once the site moves into steady-state operations, the team grows to include mine and crusher operators, mill technicians, maintenance technicians, instrumentation techs, heavy mobile equipment mechanics, operations trainers, and operations managers.[29]
At Independence and 10X in Fort Worth and Northlake, Texas, the workforce shifts toward automation-heavy, precision manufacturing jobs. Process and materials engineers sit at the center of hiring. Controls and automation engineers move from nice-to-have to core roles. QA/QC also carries more weight, since magnets must meet strict performance requirements for defense and automotive customers. MP's Fort Worth magnet facility employed 160+ people - scientists, engineers, production technicians, and operators - and the 10X campus is projected to create about 1,500 direct engineering and manufacturing jobs at scale.[10][17][22]
Commissioning needs its own hiring plan. It can't just be folded into construction or operations. Controls, QA/QC, and operations-readiness roles need to be in place before turnover begins. Job descriptions for process plant commissioning superintendents show that commissioning is treated as a separate phase, with its own procedures, risk assessments, and system turnover matrices.[27][9][28]
The table below maps each supply-chain node to its facility type, major scope, and the roles that matter most at each phase of delivery.
Hiring should match the project sequence: design, construction, commissioning, startup, and operations.
The MP Materials–DoD partnership is about delivering facilities and building a workforce, not just fixing a supply chain. U.S. magnet supply rests on three funded, sequenced, and staffed sites: Mountain Pass, Independence, and 10X. If those three nodes aren't running in sync, the chain breaks.[1][30][20]
That setup matters because the U.S. capacity gap is still huge. 10X is built to push U.S. magnet capacity to about 10,000 metric tons per year by around 2028, up from roughly 1,000 metric tons per year at Independence today.[10][14][31][33] That's not small-step growth. It's a major jump, and it only happens if construction, commissioning, and operations teams are ready on time.
The hiring piece starts well before startup. Workforce availability can shape the whole project schedule. MP has said North Texas stood out because of its manufacturing base and labor depth, which is a big reason both Independence and 10X are there.[10][32][33] If hiring plans aren't lined up with FEED, construction, commissioning, and ramp-up, delays can hit at the worst possible points.
That's why recruiting isn't just an HR job here. It's part of project control. Teams and platforms like iRecruit.co can help by building targeted pipelines for mining engineers, process and chemical engineers, magnet manufacturing specialists, and commissioning professionals.
In this buildout, specialized project leadership is the edge that matters most. So far, the MP–DoD effort is the clearest U.S. example of upstream extraction, midstream metals, and downstream magnet manufacturing being funded and staffed as one industrial program.[1][30][20]
The Department of Defense is backing this supply chain to strengthen U.S. industrial resilience and help ensure a steady supply of mission-critical rare-earth magnets for defense use.
Through its 10-year partnership with MP Materials, the Department is supporting a secure, U.S.-based mine-to-magnet pipeline. That means less dependence on foreign sources and more long-term stability for defense readiness.
The main risks come down to supply-chain issues and labor shortages.
Lead times for critical power equipment, including high-voltage circuit breakers, transformers, and switchgear, can stretch from 120 to 200 weeks. That can push project readiness back by years, not just months.
Utility interconnections can slow things down too. Grid hookups and substation upgrades often take longer than teams expect, which can stall mobilization even when the site itself is ready.
On top of that, many projects are short on skilled labor. The biggest gaps tend to show up in MEP specialists, commissioning engineers, and project managers.
This buildout creates two hiring tracks: the construction team that gets the facility built and the production workforce that keeps it running day to day.
On the construction side, key roles include project executives, senior project managers, superintendents, MEP managers, schedulers, project controls leads, and commissioning managers.
On the production side, companies usually need manufacturing engineers, production supervisors, quality and test talent, automation specialists, maintenance and reliability technicians, industrial electricians, millwrights, and robotics technicians.
