Per-MW pricing, regional variance, and cost drivers for owners scoping hyperscale & AI builds.
Salary benchmarks across the 14 mission-critical disciplines.
A commissioning agent (commissioning authority, or CxA) independently verifies that a building’s critical systems were built, started, tested and documented to the Owner’s Project Requirements (OPR), and that they keep working during failure events such as generator transfers, UPS failovers and utility outages, not only in normal operation. The CxA is not the engineer of record and carries no design liability; the role is independent verification, and owners use the CxA’s test documentation as the acceptance standard before taking over a facility. In mission-critical work that means running the L1–L5 test sequence across power distribution, cooling, controls and life safety, with titles that run from Cx Technician (0–3 years) through Cx Engineer (3–7), Senior Cx Engineer (7–10), Lead CxA (10+) and Cx Manager (12+).
If you want to become a commissioning agent in mission-critical work, the shortest path is this: build field experience with power, cooling, controls, and life-safety systems, then prove you can test failure scenarios and document results.
I’d boil the article down to four things:
Here’s why this path is getting more attention: U.S. data center construction starts went from $26.9 billion in 2024 to $77.7 billion in 2025 - a 190% jump. Semiconductor construction also surged, with spending moving from about $6 billion per year in 2011–2020 to more than $11 billion per month by June 2024. Those projects need people who can run L1–L5 commissioning, from factory checks to full-site outage testing.
If I were entering this field, I’d focus on these steps first:
A commissioning career in this space is a good fit if you like field problem-solving, cross-trade coordination, and clear pass/fail testing. The article’s main point is simple: employers want people who can help take a high-risk facility from install to turnover without losing the critical load.

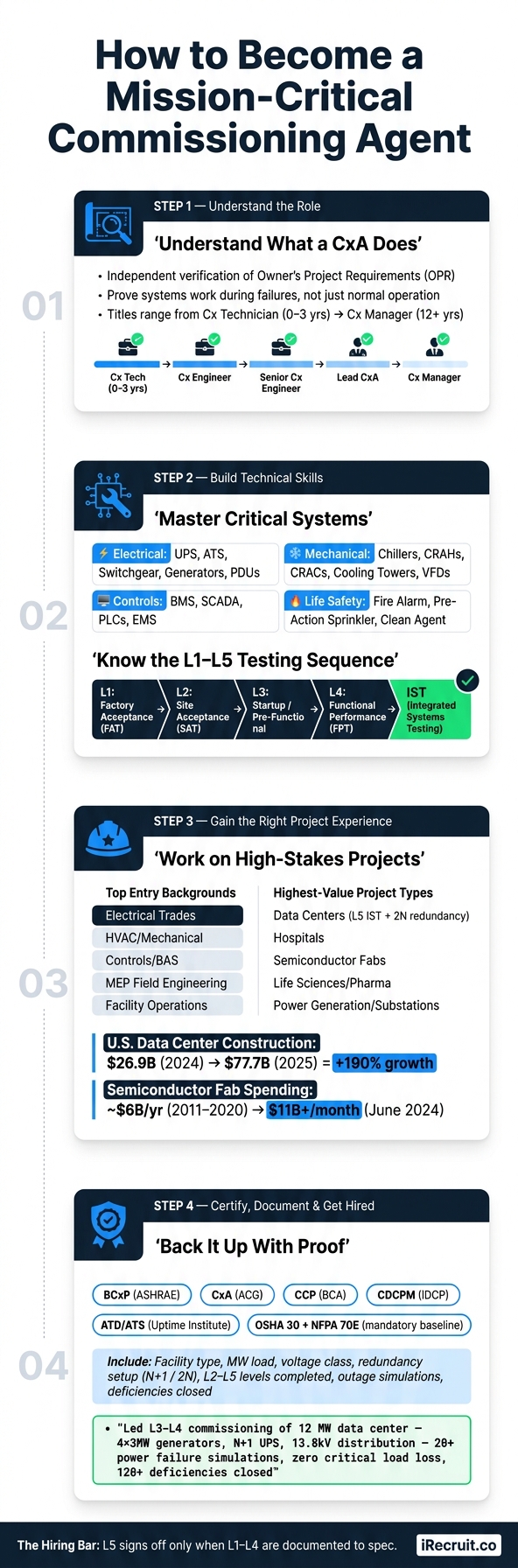

How to Become a Commissioning Agent: L1–L5 Mission-Critical Path
Hiring for a mission-critical build? Get a pre-qualified shortlist.
iRecruit.co specializes in construction recruiting for data center, energy, and advanced-manufacturing projects — project managers, MEP coordinators, commissioning leads, and more. We pre-screen every candidate so only qualified professionals reach your hiring team.
Get Started
Success-based pricing · 90-day replacement credit · No upfront fee on single roles
A commissioning authority (CxA) checks that critical systems were built, started, tested, and documented in line with the Owner's Project Requirements (OPR). The CxA is not the engineer of record and does not carry design liability. Their role is independent verification. In plain English, they confirm that the installed systems match the OPR and still perform when things go wrong. Depending on the title, that role can range from field support to full owner-facing leadership.
In mission-critical facilities, that means proving that power distribution, cooling, controls, and life safety systems work during normal operation and during failure events like generator transfers, UPS failovers, and utility outages. Owners use this documentation as the acceptance standard before taking over the facility and starting operations.
These titles line up with different levels of field exposure and responsibility.
Early-career technicians usually spend most of their time in the field. They verify installation details, check labels, complete pre-functional checklists, and support senior staff during functional testing. Client interaction is limited at this stage.
As you move into engineer and senior engineer roles, the work shifts. You're writing test scripts, leading system-level testing, and walking general contractors and owner reps through findings. At the Lead CxA level, you own the full commissioning process, sign off on major milestones, and serve as the main owner contact from design review through turnover.
Title matters, sure. But in practice, what counts most is the systems you can test. That's where the bar gets high, fast.
Standard commercial building commissioning checks that HVAC, lighting, and controls work as designed under normal conditions. For an office building, that's often enough. For a data center or advanced manufacturing site, it isn't even close.
In mission-critical facilities, failure can hit operations and revenue hard. A data center outage can cost hundreds of thousands of dollars per hour. Because of that, commissioning is built around one core idea: prove that redundancy works under load and during failure, not just that it appears on a drawing.
That's why redundancy targets like N+1 and 2N sit at the center of the CxA's work. An N+1 chilled water system means there is one spare chiller beyond what is needed for full load. The commissioning team doesn't stop at checking that the spare chiller is installed. They trip a running chiller and verify that the system picks up the load on its own without dropping critical equipment. With 2N redundancy, common in fault-tolerant designs, the test bar is even higher because each system must carry the full load on its own.
That mindset shapes the work from design review all the way to final turnover.
The process starts before construction begins and doesn't end until the operations team is ready to take over.
On mission-critical projects, commissioning moves through phases that cover planning, design, construction, testing, closeout, and handover.
During design and planning, the CxA reviews the Basis of Design (BOD) and OPR. They look for gaps, such as missing bypasses that would make failure simulation hard or impossible, and flag reliability concerns before construction makes changes costly. This is also when the commissioning plan is put together.
During construction and installation, the team handles pre-functional checklists. That includes checking that equipment matches the drawings, reviewing sensor placement, confirming valve orientation, and reviewing submittals. Once systems are energized, startup and functional testing begins. These are scripted tests of individual systems like UPS units, generators, chillers, and BMS sequences under normal and failure modes, often with load banks used to simulate critical loads.
Integrated systems testing (IST) is where mission-critical commissioning earns its reputation. This is the full-facility stress test. The team may simulate a total utility power loss and verify that every system responds the right way, together, to protect the critical load. IST scripts, test logs, and pass/fail records become part of the permanent project file.
The process finishes with turnover documentation: the final report, deficiency log, training records, and O&M handoff. Owners usually won't accept the facility - and often won't start revenue-generating operations - until this package is complete and the CxA has signed off.[2][3]
Across all of this, the commissioning agent works with a big mix of people: owners, general contractors, subcontractors, equipment vendors, design engineers, and the future operations team. Keeping that group aligned on coordination, schedule, and documentation is a huge part of the job.
Getting hired comes down to one thing: showing that you can test, document, and troubleshoot critical systems in the field. That means knowing the main systems, reading the right project documents, and working with the tools people use on commissioning jobs every day.
Mission-critical commissioning covers four main areas: electrical, mechanical, controls, and life safety.
On the electrical side, you need to know medium-voltage switchgear, UPS systems, automatic transfer switches (ATS), power distribution units (PDUs), grounding systems, and generators.
Mechanical work includes chillers, cooling towers, computer room air handlers (CRAHs), computer room air conditioners (CRACs), pumps, piping, and variable frequency drives (VFDs).
For controls, you should understand building management systems (BMS), energy management systems (EMS), SCADA, and PLC-based controls.
Life safety finishes the picture. That usually means fire alarm, pre-action sprinkler systems, and clean agent suppression systems. These are standard parts of scope on many builds. Every one of these systems plays a part in uptime, redundancy, or recovery.
But knowing the names of the equipment isn't enough. You need to be able to verify that the system works in the field.
You should be able to read one-line diagrams, sequences of operation, submittals, and test scripts. That matters more than it might seem. If you can't trace the sequence in the BMS, you can't write a credible functional test.
That's why employers hire for verification and troubleshooting, not just equipment familiarity.
In the field, the work usually includes:
You'll also use tools like Excel, Bluebeam, and BIM for tracking and markups. Owner reports need to show pass/fail results and open issues in a clear way.
All of this ties into a set testing path, from factory acceptance through integrated systems testing.
Mission-critical projects follow a structured testing sequence, usually called Level 1 through Level 5 (L1–L5). Each level builds on the one before it, so you always need to know where you are in the process.
L5 is the final proof that the full system can handle a power-loss event and recover the way it should.
Once you know the systems, the next move is putting that knowledge to work on live projects. The best way in is usually through a role that already sits close to critical systems, then making a deliberate shift into commissioning work.
Most people who move into mission-critical commissioning come from one of five backgrounds: electrical trades, HVAC/mechanical trades, controls/BAS, MEP field engineering, or facility operations. There’s a reason for that. Each path lines up well with day-to-day commissioning tasks.
Electricians and foremen already know critical power systems, transfer equipment, and grounding. HVAC technicians bring hands-on time with chilled-water equipment and startup support. Controls and BAS/BMS technicians often handle sequence checks, trend setup, and integration debugging. That’s a big part of commissioning testing.
Field engineers and MEP coordinators tend to bring strong documentation habits. If you’ve managed a commissioning log or tracked deficiencies through closeout, you already know a big piece of the workflow. Facilities engineers and operators - especially from hospitals, data centers, or industrial plants - bring an operations-first mindset that’s tough to teach.
If you want to move in this direction, start taking on commissioning-related tasks now:
Not every project carries the same weight. Mission-critical environments matter more because the systems are less forgiving and the handover standards are tougher.
Commercial office and retail work usually carries less weight. If possible, aim for projects that involve outage testing, redundancy, or regulated handover requirements. Those are the jobs that tend to stand out on a résumé.
The move from technician to senior agent is pretty direct on paper. In practice, the jumps depend a lot on the complexity of the projects you’ve worked on, not just how long you’ve been in the field.
Each step up brings more judgment, more ownership, and less day-to-day supervision.
After you have the right project experience, certifications and résumé framing make that experience easier to hire for.
Certifications don't replace project work. But they do show hiring managers that you know the commissioning process in a formal, structured way.
For mission-critical roles in the U.S., a few credentials show up again and again in job posts:
If you're aiming at data center work, a couple of names matter even more. CDCPM from IDCP is especially relevant for senior hyperscale leadership roles. And the Uptime Institute's ATD/ATS programs carry a lot of weight in colocation and hyperscale settings.
Safety credentials are non-negotiable. On many mission-critical sites, OSHA 30-Hour Construction and NFPA 70E electrical safety training are baseline requirements, along with documented lockout/tagout competency before you work near energized equipment. NFPA 70E covers arc flash, shock protection, and lockout/tagout (LOTO) procedures. Training usually takes 2–8 hours per course, with retraining required at least every three years.[4][5][6]
It also helps to know NFPA 70 (National Electrical Code) and NFPA 110 (emergency and standby power systems). These standards shape how generator and ATS testing gets documented and how redundancy setups are checked. If you've worked on commissioning plans or method-of-procedure (MOP) documents, you've probably seen this up close.
A lot of candidates make the same mistake: they list responsibilities instead of showing what they did and what happened because of it. In mission-critical hiring, that misses the mark. Employers scan résumés for system types, test levels, and results, not generic job duties.
Under each project, spell out the details that matter. Include the facility type - for example, a 12 MW data center, hospital, or GMP pharmaceutical cleanroom. Add the voltage class, such as 480V distribution or a 13.8 kV primary feed. Name the cooling systems involved, whether that's a chilled water plant, CRAC/CRAH units, or liquid cooling CDUs. Then show the commissioning levels completed, including Level 2 through Level 5 testing.
If you worked on redundancy validation like N+1 or 2N, blackout simulations, or black-start drills, say that plainly. Don't make the reader hunt for it.
A strong résumé bullet looks like this: "Led Level 3–4 commissioning of a 12 MW data center including 4 × 3 MW generators, N+1 UPS topology, 13.8 kV primary distribution, and chilled water plant; executed 20+ integrated power failure simulations with zero critical load loss and closed 120+ deficiencies prior to owner turnover."
That single line does a lot of work. It shows project scale, system scope, test depth, redundancy setup, and the end result.
In your skills section, list the commissioning software you've used - CxAlloy, BlueRithm, Facility Grid, Procore - alongside field instruments like power quality analyzers, data loggers, and infrared cameras. A short label such as "Mission-Critical Commissioning Experience" can also help technical reviewers and general recruiters find the right information fast.
In the U.S., the employers hiring most often for these roles include specialized commissioning firms, large general contractors with mission-critical divisions, MEP and EPC firms, and owner-side technical teams at data center developers, health systems, and advanced manufacturers.
If you're moving into commissioning from the trades or an MEP background, data center construction can be a smart place to start. It gives you project experience that can transfer well into healthcare, pharmaceutical manufacturing, and advanced manufacturing.
Specialized recruiters like iRecruit.co focus on mission-critical construction hiring and work directly with builders, developers, and technical employers looking for pre-qualified commissioning talent. That kind of direct link can help when a role calls for a very specific mix of system knowledge and test-level experience.
"The energization date moves only when L5 signs off, and L5 only signs off when L1 through L4 have been documented to spec." - Dallas Bond, iRecruit [1]
That's the bar employers are hiring to. The people who get those calls are usually the ones who can show, clearly and quickly, that they've worked through that sequence from start to finish.
After looking at the role, the skills, the ways in, and the certifications, the path comes down to one thing: showing that you can deliver reliable systems. Mission-critical commissioning tends to reward people who bring together field experience, system knowledge, and disciplined testing to prove a facility is ready for service.
Use credentials to support your résumé, not to stand in for project proof. Certifications like BCxP, CCP, and ATD can help show a solid baseline, but hiring decisions still come back to project work and proven execution.
This career has a pretty clear direction. Experience on high-reliability projects can open the door to lead commissioning roles, owner-side technical positions, startup and operations leadership, and consulting or project management. Growth usually comes from better judgment, larger scopes, and taking on more ownership.
The clearest fit is simple: this work makes sense for people who like solving technical problems across disciplines and proving that complex systems perform before a facility goes live. The strongest candidates can read drawings, follow sequences, spot field issues, and turn technical findings into clear owner-ready reports. That mix is what helps people get hired and move into larger mission-critical scopes.
No. In mission-critical commissioning, an engineering degree can help, but it usually isn’t required.
Most employers care more about hands-on experience with MEP systems, controls, testing, and startup/verification. In plain English, they want people who’ve been in the field, seen how systems behave, and know how to spot problems before they turn into expensive downtime.
Credentials can matter too. Common ones include BCxP, CBCP, and CxA. And while PE licensure can be useful, it’s not always required, especially for CxA roles.
Use your hands-on background in MEP, controls, or facility systems to step into field-heavy roles like Commissioning Engineer or Coordinator. One of the fastest ways in is to join an active mission-critical project and start owning commissioning work: startup, functional performance testing, and deficiency log management.
On your resume, frame your trade experience in commissioning language. Call out Level 1-5 work, test script execution, schematic reading, and performance documentation. BCxP or CxA certifications can also help show that you’re ready for the role.
For entry-level candidates, start with baseline safety and technical training, especially OSHA 30 and, if you work around electrical systems, NFPA 70E. These are common field requirements, and they show employers that you take safety seriously.
As you build commissioning experience, move into a core process-based certification like ASHRAE BCxP or AEE CBCP. These credentials are widely recognized and signal that you understand commissioning across the full project lifecycle.
