September 4, 2026

Thacker Pass: America's Biggest Lithium Mine Construction Project

By:
Dallas Bond

Thacker Pass is the largest lithium mine build now under construction in the U.S., with Phase 1 alone priced at $2.93 billion and more than 1,600 workers already on site as of Q3 2026. If you want the short answer, here it is: this project matters because it combines a mine, a lithium-carbonate plant, a sulfuric acid plant, and site utilities into one large build with a late-2027 mechanical completion target.

Here’s what I’d want to know right away:

  • Location: Humboldt County, Nevada
  • Owner setup: Lithium Americas and GM joint venture
  • Phase 1 cost: $2.93 billion
  • Federal loan support: $2.26 billion from the U.S. Department of Energy
  • Target output: 40,000 tonnes/year of battery-grade lithium carbonate in Phase 1
  • Peak labor target: 2,000+ workers by the end of 2026
  • Delivery model: Bechtel-led EPCM
  • Main build scope: open-pit mine, processing plant, acid plant, water, power, roads, and workforce support
  • Schedule: early commissioning in Q4 2026, mechanical completion in late 2027, ramp-up into 2028

What makes this project different is simple: it is not just a mine. It is a large industrial campus spread across mining, chemical processing, utilities, and remote-site logistics. That puts pressure on scheduling, procurement, field supervision, QA/QC, commissioning, and camp-based workforce planning.

For hiring, the signal is clear. The hottest demand is around:

  • Project controls and schedulers
  • Superintendents and field engineers
  • QA/QC and safety leads
  • Commissioning managers and controls techs
  • Supply chain and materials teams

If I had to sum it up in one line: Thacker Pass is a high-spend, multi-scope Nevada construction program where schedule control and skilled labor will decide how smoothly Phase 1 reaches startup.

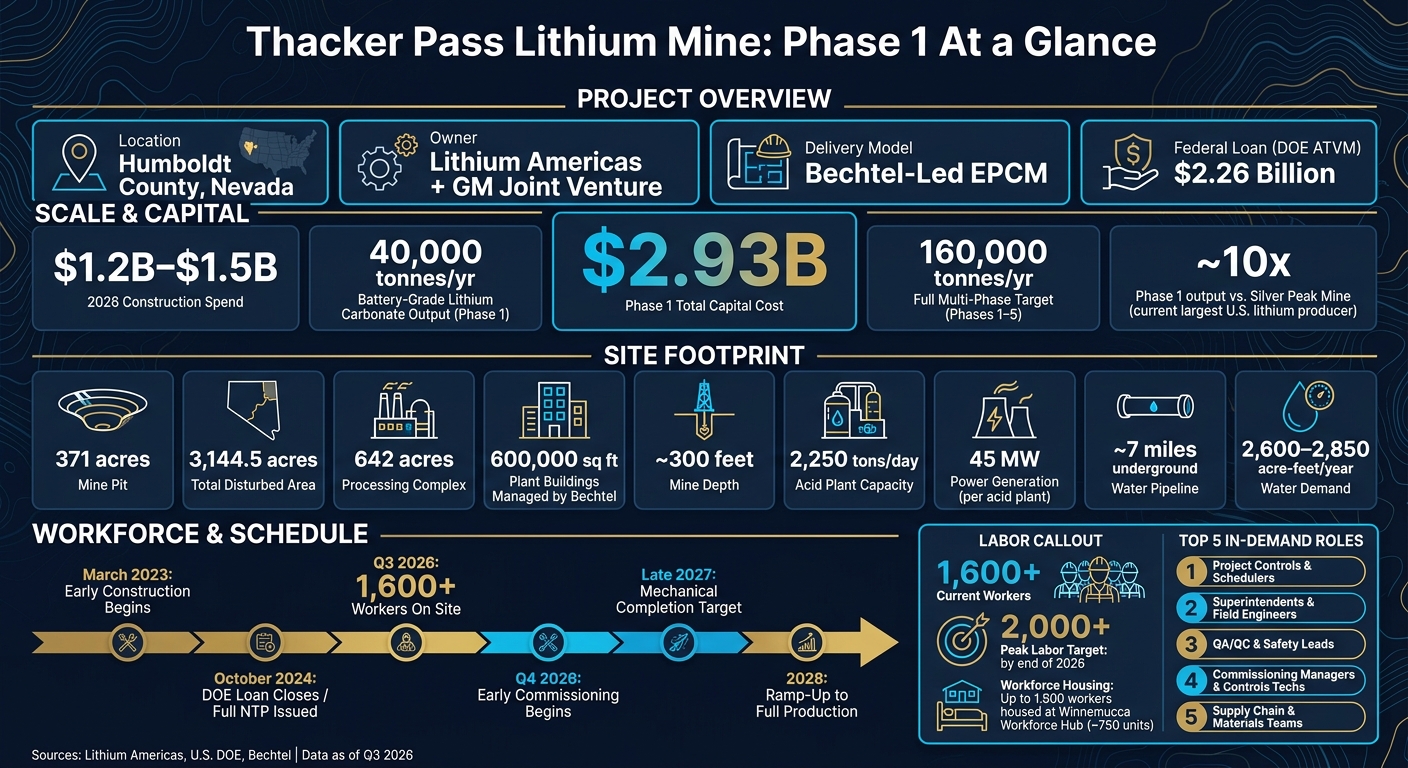

Thacker Pass Lithium Mine: Phase 1 Key Facts & Figures

Thacker Pass Lithium Mine: Phase 1 Key Facts & Figures

Building Thacker Pass: July 2026 Construction Update

Why Thacker Pass is the largest lithium mine construction project in the U.S.

Thacker Pass stands at the top of U.S. lithium construction for three simple reasons: resource size, planned output, and how much money it takes to build.

Resource size, footprint, and production capacity

Thacker Pass sits on the largest known measured and indicated lithium resource in North America. Lithium Americas reports combined measured and indicated in-situ resources of about 3,786 million metric tons of claystone, containing about 44.5 million tonnes of lithium carbonate equivalent (LCE).[2][3]

That resource base shapes the whole project. It affects the size of the mine, the processing setup, and the amount of equipment and labor needed to get Phase 1 online.

Phase 1 is designed to produce 40,000 tonnes per year of battery-grade lithium carbonate.[6][7][10] That kind of output doesn't come from a small operation. It calls for a large plant, many installed systems, and a deep bench of craft labor across the site.

For perspective, Silver Peak in Nevada has historically produced about 3,500 to 4,000 tonnes per year.[11][12][13] Thacker Pass Phase 1 alone is planned at about ten times that range. And the full multi-phase plan goes much further, with a target of 160,000 tonnes per year of lithium carbonate across Phases 1–5.[7][4] Put plainly, this is not a typical mine build. It's a huge industrial job.

Capital intensity and federal financing support

The money behind Thacker Pass also helps explain the project's scale. Phase 1 carries a revised total capex estimate of about $2.93 billion, with 2026 Phase 1 construction spend projected at $1.2 billion to $1.5 billion.[8][9][4]

On top of that, the $2.26 billion DOE ATVM loan, which closed in October 2024, is set aside for construction of the processing facilities at Thacker Pass.[14][15]

When a project carries that level of spend and federal backing, execution gets tighter. Teams need close milestone tracking, strict scheduling, and firm cost control. In practice, that means a larger build program with more oversight and more moving parts.

Taken together, those factors make Thacker Pass the largest U.S. lithium mine build and help explain why it creates such broad demand for construction labor. The next section breaks down the mine, processing plant, acid plant, and site infrastructure behind that demand.

What is being built: mine, processing plant, acid plant, and site infrastructure

Phase 1 brings mining, processing, acid production, and site utilities into one connected build.

Open-pit mine and processing complex

The open pit averages about 300 feet deep and will be mined in blocks, which allows active reclamation as work moves forward.[23] Ore travels from the pit on haul roads to a run-of-mine (ROM) stockpile, then into an attrition scrubbing and slurry pipeline system that gets the clay ready for lithium processing.[20]

Phase 1 mine development will disturb about 3,144.5 acres in total. That includes the pit at about 371 acres, waste rock storage facilities at about 250 acres, and a clay tailings filter stack (CTFS) covering about 364.6 acres.[19]

The processing complex covers about 642 acres.[5] It converts ore slurry into battery-grade lithium carbonate through leaching, neutralization, impurity removal, and crystallization. Major plant areas include filter, magnesium sulfate, reagent, control, lab, and product storage facilities, all linked in a tightly sequenced process flow.[10][17]

Bechtel is managing about 600,000 square feet of processing plant buildings, administrative buildings, roads, utilities, and related site infrastructure within that footprint.[5][16] In plain terms, this is not a single-facility job. It is a large industrial build where each stage pulls in its own mix of civil, mechanical, and process crews.

On-site sulfuric acid plant, power, water, and logistics

The processing circuit depends on the acid plant and site utilities to keep material moving. The on-site DCDA sulfur-burning acid plant is sized at 2,250 tons per day.[18][22] It supplies leaching acid and also generates steam for power.[18][22] Each Phase 1 and 2 acid plant is expected to generate about 45 MW of power to support the processing plant.[21]

That setup adds another layer to the work. It calls for high-voltage electricians, mechanical installers, and startup teams, not just mine and plant crews.

Water adds its own build package. Phase 1 needs about 2,600 to 2,850 acre-feet of water per year, delivered through an approximately seven-mile underground pipeline from the Quinn River Valley. The system also includes booster pump stations and storage tanks along the power line corridor.[18][24] Electrical infrastructure includes a 25-kilovolt transmission line, substations, and plant-wide distribution connected to on-site generation.[17]

Put it all together, and Thacker Pass looks more like a self-contained industrial campus than a standard mine. That means work is spread across civil, mechanical, electrical, and commissioning teams at the same time, with several critical paths moving in parallel.

Construction phases, delivery model, and schedule pressure points

Thacker Pass is a multi-year program with clear delivery stages, and each stage brings its own schedule and staffing risk. At this point, those systems are setting the pace for the project.

From permitting to major construction and Phase 1 completion

The BLM issued its Record of Decision on January 15, 2021, authorizing the mine plan and related facilities. Legal challenges continued through 2023, but a federal judge allowed early construction in March 2023. A December 2023 ruling then cleared the way for broader mobilization.[1]

March 2023 was the turning point from permitting into field execution. Early works covered earthworks, access roads, temporary facilities, initial utilities, and work on the Workforce Hub housing camp. Major construction picked up in 2024 after the $2.26 billion DOE ATVM loan closed and full notice to proceed was issued. Phase 1 is aimed at mechanical completion in late 2027, with commissioning and ramp-up continuing into 2028.[1]

Early commissioning of water management, reagent handling, and initial beneficiation circuits is expected in Q4 2026. From there, schedule control comes down to a few unglamorous but critical items: integrated master scheduling, look-ahead planning, and tight turnover control across civil, mechanical, electrical, and instrumentation crews.

That timing shapes where hiring pressure shows up first.

EPCM structure, trade partners, and critical-path work

Delivery is being run through a Bechtel-led EPCM structure. Bechtel received the Phase 1 contract in Q4 2022 and is overseeing detailed engineering, procurement, and construction management across the processing plant, sulfuric acid plant, and site infrastructure. Under that setup, Aquatech International is responsible for the magnesium sulfate and lithium carbonate chemical plants, EXP Global with MECS, Inc. technology is handling the sulfuric acid plant, CB&I is delivering 36 flat-bottom atmospheric tanks, and Sawtooth is managing contract mining operations.[1]

On a job like this, coordination can become the choke point. Project controls, procurement, and field supervision sit right in the middle of it. Several contractors are running parallel scopes on a congested site, so the critical path runs through the lithium carbonate processing train, the sulfuric acid plant, and the supporting utilities and water systems. Long-lead equipment sequencing is still an active schedule risk, and financing discipline stays tight because the DOE loan can be drawn only through November 30, 2028.[1] With detailed engineering more than 95% complete, near-term hiring is shifting toward commissioning, quality control, and operations-readiness roles.

Where talent demand and contractor opportunity are emerging

As Phase 1 moves deeper into peak construction, hiring demand is shifting toward field leadership, commissioning, and supply chain roles. This is the point where pressure shows up in plain sight. For contractors, the best openings are clustered in civil works, structural steel, process mechanical, the sulfuric acid plant, power and water utilities, and remote site logistics and workforce camp management. Those are the areas where labor gaps and procurement slowdowns are most likely to hit first.[1]

The most important hires right now fall into three buckets: controls, field execution, and commissioning.

Roles most critical to Phase 1 execution

Project governance and controls sit at the top of the stack. With Bechtel serving as the EPCM contractor for Phase 1, project managers, project controls leaders, schedulers, and cost managers are tying owner goals to EPCM and trade partner execution across the processing plant, acid plant, and utilities.[26][4][27] Schedulers, in particular, need to be fluent in detailed Primavera P6 schedules that factor in remote logistics, weather, and multiple work fronts moving at the same time.

Field execution leadership drives output across a crowded jobsite. Area superintendents and field engineers are coordinating structural steel, mechanical erection, and electrical and instrumentation work across civil, structural, mechanical, and E&I scopes. QA/QC managers matter in a big way here. Getting process piping, pressure vessels, and high-voltage systems right the first time cuts rework and helps protect the turnover schedule. Safety leaders also carry a heavy load as they manage a large rotating, camp-based workforce.[4]

Startup and commissioning are often the most thinly staffed parts of a build like this. Commissioning managers, instrument and controls technicians, MEP and electrical leads, process specialists, and supply chain managers become central in the last stretch of Phase 1. That’s when pre-commissioning, hot commissioning, and performance testing all need to stay lined up with the late-2027 mechanical completion target and the 2028 ramp-up.[4][25] If commissioning teams aren’t brought in early enough, handover dates can slide even when construction itself is moving well.

What this means for hiring strategy and workforce planning

The Bechtel-NABTU Project Labor Agreement (PLA) governs craft hiring and sets up a clear pipeline for union trades and apprenticeships.[30][31]

The DOE noted that the PLA was put in place to "minimize construction risk" and "ensure the availability of skilled labor" for this remote project.[31]

That helps on the craft side. But it doesn’t fix the tougher issue: hiring seasoned project controls people, commissioning engineers, senior superintendents, and supply chain managers who are willing to move to rural Humboldt County, Nevada.

The Winnemucca Workforce Hub can house up to 1,900 workers in about 750 units. Site bussing lowers some of the relocation friction and makes the project more appealing, but it still doesn’t solve the shortage of senior specialists.[28][29] Hiring for remote industrial roles in northern Nevada takes time. It also takes people who are open to rotational work. On a project like this, workforce planning needs to begin long before peak manning shows up.

Those hiring patterns point straight to the roles and scopes where recruiters and contractors are likely to place their next bets.

FAQs

Why is Thacker Pass more than a typical mine project?

Thacker Pass is more than a standard mine project. It brings together an open-pit mine, a lithium-carbonate processing plant, and a sulfuric-acid facility in one build.

That mix makes the job much harder to deliver than a mine on its own. The project’s size and technical demands call for specialized construction delivery, tightly integrated commissioning, and careful workforce planning. Without that, execution risks can pile up fast and put mechanical completion targets under pressure.

What could delay Phase 1 startup at Thacker Pass?

Phase 1 startup at Thacker Pass could slip if mission-critical roles and handoffs aren't filled on time. The pressure is highest for schedulers tracking critical-path risk and commissioning professionals running startup, testing, and owner handoff.

Delays can also snowball when candidates don't meet the bar or lack required licenses or certifications. The same goes for long-lead equipment: if procurement starts to slip and no one flags it early in the schedule, energization and integrated testing dates can move out fast.

Which roles are hardest to hire for this project?

The toughest hires are the roles closest to technical delivery and day-to-day project execution.

That’s especially true for commissioning managers and engineers, MEP leads, and controls specialists. These jobs sit right in the middle of mission-critical work, so when one stays open, the whole project can feel it.

Other hard-to-fill roles include project managers, superintendents, P6 schedulers, licensed electricians, and QA/QC leads. In many cases, these positions can take 60 to 90 days or longer to fill.
