September 4, 2026

Resolution Copper: The Decade-Long Fight to Build America's Largest Copper Mine

By:
Dallas Bond

This project is huge, deep, expensive, and delayed for years by federal review and court fights. If you want the short version: Resolution Copper could become the largest copper mine in the U.S., but getting to construction took more than a decade because the mine sits 5,000 to 7,000 feet underground, needs major surface and underground systems, and could not move into full buildout until the land exchange and federal approval were finished in March 2026.

Here’s what matters most:

  • Scale: The deposit is about 1.787 billion metric tons at 1.5% copper
  • Output goal: Up to 120,000 tons per day
  • U.S. supply impact: Projected to cover up to 25% of U.S. copper demand
  • Depth: About 1 to 1.3 miles underground
  • Heat: Rock temperatures can exceed 176°F
  • Owners: Rio Tinto (55%) and BHP (45%)
  • Workforce: Peak build workforce near 3,800
  • Early spending after approval: $500 million for shaft rehab and early works through 2028

What stands out to me is simple: this is not just a mine. It is a long-cycle industrial build with deep shafts, panel caving, a concentrator, slurry transport, power, water, ventilation, refrigeration, and rail-linked loadout work. That mix is why hiring, sequencing, and schedule control mattered as much as engineering.

A few points sum up the case:

  • The mine method shaped the talent plan. Deep-shaft and panel-cave work needs a small group of hard-to-find leaders, such as shaft managers, hoisting engineers, geotechnical teams, ventilation engineers, and underground HSE leads.
  • Permitting shaped the timeline. The Mine Plan was filed in 2013. Congress set up the land exchange in 2014, but full progress still depended on federal review and legal outcomes.
  • Court cases slowed hiring. Until the legal path became clearer in 2024–2026, many major surface packages stayed on hold.
  • March 2026 changed the project. The federal Record of Decision and recorded land transfer let the project move from planning-heavy work into approved early construction.
  • Hiring had to follow project gates. Bringing in large teams too early would have added cost and turnover risk.

If I had to reduce the article to one idea, it would be this: Resolution Copper shows that for a megaproject, workforce planning is part of project delivery. You do not just hire when you feel ready. You hire when approvals, funding, access, and scope line up.

Item What it tells you
Deep shafts Access, crew flow, materials, and hoisting all become schedule limits
Panel caving Ground control and subsidence planning become major parts of delivery
176°F+ rock Ventilation and cooling are core systems, not side systems
10+ years of review Hiring plans must stay flexible without overbuilding staff
March 2026 approval This was the main trigger for broader recruiting and early works

So when I look at Resolution Copper, I don’t see a simple “mine delayed by permitting” story. I see a project where depth, heat, method, legal timing, and labor scarcity all pushed the build timeline out - and where the hiring model had to be tied to each project milestone.

Inside the Resolution Copper Mine, 1.3 Miles Underground

Project scale: Deep underground construction, processing infrastructure, and long-horizon delivery

Resolution Copper is not a mine you build from the surface and just keep going deeper. The orebody sits between 5,000 and 7,000 feet underground - about 1 to 1.3 miles below the surface [11][13][17]. At that depth, rock temperatures climb past 176°F, and high silica levels add major ventilation and dust-control demands [15][18].

That changes everything. It affects engineering, build order, and staffing. For hiring teams, it also means a much smaller talent pool and longer searches for hard-to-fill roles. Put simply, this is deep underground work that calls for people who’ve done it before.

Why shaft depth and panel caving require specialized construction leadership

The shafts make the scale easy to see. Shaft 10 extends 6,943 to 7,000 feet, making it the deepest mine shaft in the U.S. Shaft 9 was rehabilitated and deepened from 4,800 feet to about 6,898 feet through a $200 million program [19][21]. It is now the second-deepest single-lift shaft in the country [8][19][21].

These are also large-diameter shafts, about 22 feet across, built to handle hoisting systems, utilities, personnel, and ventilation at the same time [19][21]. Work at that depth is not standard industrial construction. It calls for leaders with rare underground construction and hoisting backgrounds.

And shaft depth is only one part of the story. Resolution Copper plans to use panel caving, a bulk mining method that undercuts the orebody so it breaks and drops by gravity into drawpoints [10][13][17]. From there, loaders move the broken ore to crushers, and conveyors and hoists carry it to the surface concentrator [9][14].

That method sets large-scale rock movement in motion and leads to surface subsidence over time. So the leadership mix has to go far beyond general construction management. The project needs ground-control specialists, caving engineers, and geotechnical teams who know how this kind of mine behaves under stress.

The planned production rate of 120,000 tons per day adds another layer [14][18]. At that level, hoisting schedules and cage capacity do more than affect output. They control when crews, materials, and equipment can even reach the active mining zone. That’s why deep-shaft project executives and underground construction managers with direct shaft-sinking experience matter so much here.

The major systems that expand this mine into a full industrial megaproject

The underground scope is only half the job. On the surface, Resolution Copper also needs a concentrator with SAG and ball mills, large bulk flotation circuits, and separate handling for copper and molybdenum concentrates [16].

After processing, copper concentrate would move as slurry about 22 miles to a filter and loadout site near Magma, Arizona, using the MARRCO corridor [9]. That corridor also needs upgrades for a rail line, water pipelines, utility lines, intermediate pump stations, and as many as 30 new groundwater wells [9].

Underground operations bring another heavy layer of infrastructure. To keep the mine safe and running, the site needs ventilation of about 3,000 cubic meters per second and refrigeration capacity above 140 MW to control heat and dust at depth [18][22]. Add power transmission, roads, maintenance shops, and surface admin buildings, and this starts to look less like a single mine build and more like a full industrial program with many interlocking parts.

Each major system needs its own leadership. That includes process plant PMs, EPC leaders, water and power engineers, and interface managers. It also stretches the preconstruction period, since access, permitting, and sequencing all have to line up before full buildout can move ahead.

Comparison table: Deep underground mine construction vs. other large U.S. industrial builds

The table below shows why Resolution Copper has a very different delivery and staffing profile than other large U.S. industrial projects.

Factor Resolution Copper (Deep Underground) Advanced Manufacturing / Data Center Campus
Work depth 5,000–7,000 ft underground [11][13][17] Surface-level or shallow foundations
Logistics Vertical - shaft-dependent; cage capacity limits crew and material flow [14][18] Horizontal - road and crane access across campus
Key risks Rock bursts, subsidence, heat stress (176°F+), silica dust, high-energy hoisting [15][18] Electrical energization, working at heights, process safety
Ventilation demand ~3,000 m³/s airflow + 140 MW refrigeration [18][22] HVAC for climate control
Sequencing constraints Shaft completion gates all underground development; panel cave infrastructure must precede production [12][14] Parallel construction across buildings; fewer hard dependencies
Specialized leadership roles Shaft-sinking executives, cave engineers, geotechnical specialists, underground safety leaders [10][18] MEP coordinators, VDC managers, commissioning leads

That gap changes the hiring pool and stretches search timelines. In practice, staffing risk was part of the reason the schedule grew longer well before full-scale construction could begin.

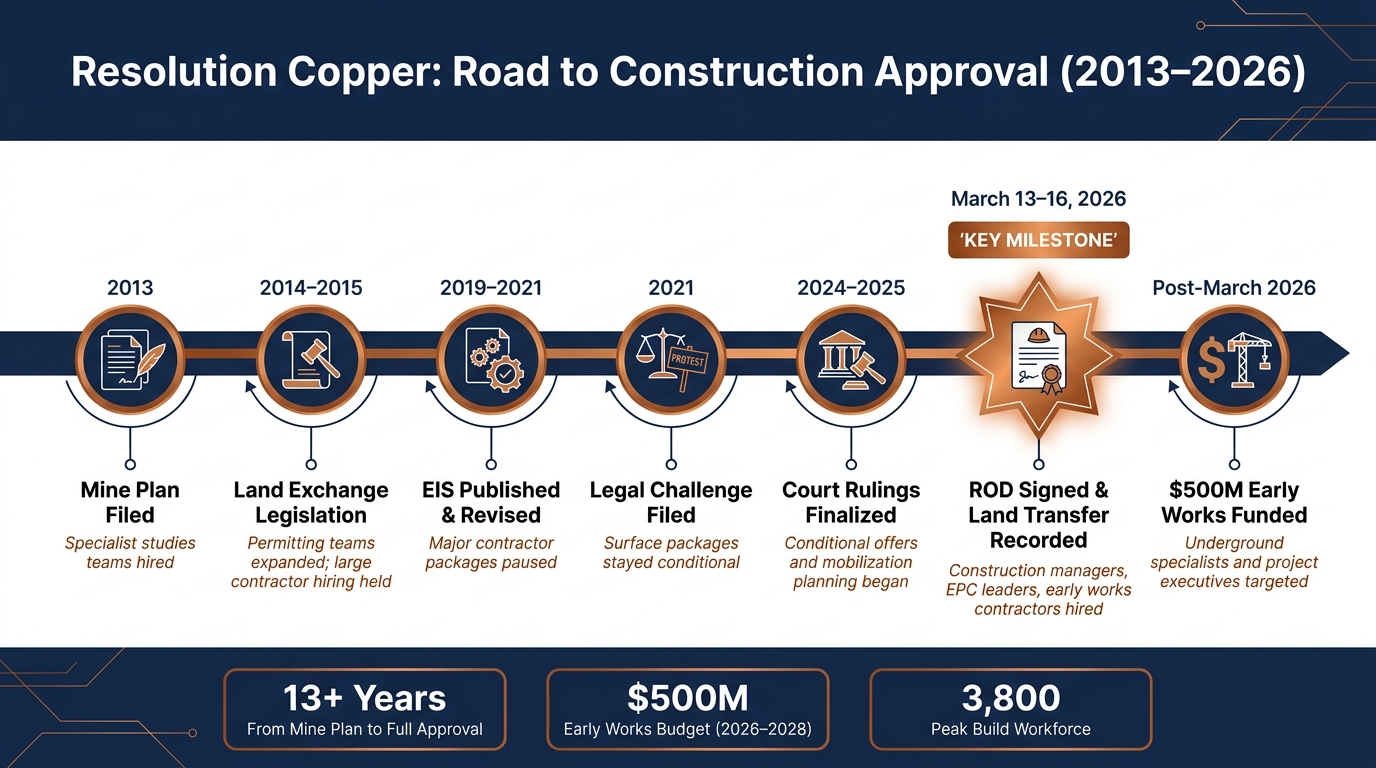

Resolution Copper: Key Milestones from Mine Plan to Construction Approval (2013–2026)

Resolution Copper: Key Milestones from Mine Plan to Construction Approval (2013–2026)

Resolution Copper submitted its Mine Plan of Operations to the U.S. Forest Service in 2013, which formally kicked off the federal permitting process and triggered a full Environmental Impact Statement (EIS) under NEPA [3][29]. From there, the project moved through more than a decade of permitting, court fights, and staged enabling works. That long runway limited hiring and contracting at each step. It shaped staffing from the earliest study teams all the way to later construction planning.

From land exchange legislation to the federal Record of Decision

The legal basis for the land exchange came from Section 3003 of the FY2015 National Defense Authorization Act, signed in December 2014. That law directed the U.S. Forest Service to exchange Oak Flat and nearby federal land for private lands held by Resolution Copper, but only after NEPA review was completed [25][28]. In plain terms, the project could keep moving on deep shafts and technical work, but major surface construction still had to wait.

That kept the mine in a permitting-limited phase for years. Then Acting Forest Supervisor Ericka Luna signed the final Record of Decision on March 16, 2026, approving special use permits for pipelines, powerlines, and road access [2][6][23][26]. The March 2026 Record of Decision, along with the land transfer, cleared the last federal obstacle.

How opposition and litigation extended planning horizons

Apache Stronghold and allied tribal groups sued in 2021, challenging the land transfer on religious and treaty grounds [30][31][32]. That legal cloud made it hard to lock in contractor awards or make firm hiring promises. Big surface packages stayed conditional, so contractor mobilization and full workforce planning moved slowly.

Over time, that picture changed. Courts ruled against the claims across 2024–2026, and the Supreme Court declined to hear an appeal in May 2025 [5][24][27]. Each decision gave workforce planners more confidence to shift from wait-and-see mode toward longer-term hiring plans.

The timeline below shows how those milestones moved hiring from a holding pattern into ramp-up.

Milestone table: Preconstruction events and their effect on staffing plans

Milestone Approximate Period Description Recruiting Impact
Early project investment and shaft sinking Pre-2014 onward Initial capital funded exploration, deep shafts, and technical studies [2][24] Ramp specialists; hold surface roles
Land exchange legislation (FY2015 NDAA) 2014–2015 Congress authorized the exchange, subject to NEPA review [25][28] Permitting and environmental teams expanded; large contractor hiring held
Draft and Final EIS stages 2019–2021 and revisions Forest Service released and revised EIS documents with additional tribal consultation [6][4][28] Major contractor packages paused; focus shifted to environmental specialists
Key court decisions (Ninth Circuit, Supreme Court) 2024–2025 Courts ruled against religious freedom claims; Supreme Court declined appeal [5] Scenario planning narrowed; conditional offer and mobilization planning began
Record of Decision and land exchange recorded March 13–16, 2026 Final ROD signed; land transfer completed after last judicial barriers cleared [2][6][23][24][27] Construction managers, EPC leaders, and early works contractors hired against approved scope
Enabling works funding ($500 million) Post-March 2026 Capital allocated for shaft rehabilitation and early works [1] Underground specialists, construction managers, and project executives targeted as schedules firmed

Those changes drove the hiring plan. Early on, the focus stayed on specialist roles tied to studies, permitting, and underground work. After the March 2026 approvals, the path opened for broader construction recruiting tied to an approved scope.

Talent strategy: The roles and recruiting model needed to build Resolution Copper

Resolution Copper is too big for reactive hiring. With a buildout that stretches more than a decade, an operating life of about 40 years, and a peak workforce near 3,800, timing matters just as much as headcount.[9][10] That changes the whole talent plan. Hiring has to follow the project phase, because the delivery model decides when each role needs to show up.

Critical hires by phase: project executives, underground specialists, EPC leaders, and project controls

The most important roles change as the project moves forward.

In the feasibility and permitting phase, the focus is on leaders who shape long-range outcomes. That includes a Project Director, Chief Mining Engineer, Environmental Permitting Lead, plus stakeholder and tribal engagement leads. These aren't back-office hires. The Project Director helps set the delivery and contracting model, along with mine design choices that affect cost, schedule, and risk for years to come.[10][20]

Once shaft sinking and underground enabling work begins, the pressure shifts. At that point, Shaft Construction Managers, Hoisting Systems Engineers, Underground HSE Managers, and Ventilation Engineers move to the front of the line. These jobs deal with extreme-depth mining conditions, where failures in ground control, ventilation, or hoisting can have serious consequences.[20][33] Resolution Copper's No. 9 shaft deepening is a good example of why seasoned shaft-sinking leadership matters.[7]

As EPC/EPCM activity expands across the concentrator, tailings, water, and power systems, another group becomes central: Cost Engineers, Schedulers, Contract Managers, and Discipline Superintendents. Later, about 12–24 months before first ore, operations leadership needs to be in place. That means hiring the Mine Operations Manager, Processing Plant Manager, Maintenance Manager, and Reliability Engineers early enough to shape final design, build procedures, and prepare for commissioning. If those leaders come in only at mechanical completion, start-up risk goes up and ramp-up takes longer.

How long timelines change recruiting strategy

A timeline this long creates staffing challenges on large-scale construction projects: attrition risk, market-rate drift, and relocation friction.

People hired early for permitting or enabling-works roles may sit too close to uncertainty for too long. Some will leave. Others will get pulled away by other offers. At the same time, pay rates for underground engineers and senior project directors can move a lot over five to ten years, so compensation benchmarks can't stay static.

Relocation makes things harder. Deep underground mining talent is spread across the globe, and moving those specialists to rural Arizona for a long assignment takes more than a standard relocation deal. People want to see project stability, a plan for settling into the community, and a clear view of the next big milestones.

The U.S. mining labor pool is already thin, which makes long-lead hiring and steady candidate contact much more important.[35][36][37][38][39][40]

The practical answer is a warm pipeline model. Talent teams line up priority candidates years before mobilization, stay in touch each quarter, share project updates, and group candidates by readiness tier. That way, if mobilization dates move, the pipeline doesn't just dry up.

Role needs, hiring timing, and search approach by project phase

The table below links each role to the phase where it matters most.

Role Project Phase Why It Matters Recommended Hiring Approach
Project Director / VP Major Projects Feasibility & Permitting Sets delivery and contracting strategy, mine method, and risk posture Executive search; global scope
Chief Mining Engineer Feasibility & Permitting Drives resource modeling and mine design decisions that lock in capital cost and operating performance Executive search; targeted specialist search
Environmental Permitting Lead Feasibility & Permitting Manages EIS compliance and conditions that shape future construction requirements Targeted specialist search
Shaft Construction Manager Shaft Sinking & Underground Enabling Works Oversees deep shaft execution under extreme geotechnical conditions Embedded recruiting + specialist search; global search likely required
Underground HSE Manager Shaft Sinking & Underground Enabling Works Manages rock burst, ground control, and ventilation hazards at depth Targeted specialist search; relocation package critical
Ventilation / Refrigeration Engineer Shaft Sinking & Underground Enabling Works Designs air quality and cooling systems for 176°F+ rock temperatures[18][15] Specialist search; limited U.S. candidate pool
EPCM Project Director Full EPC/EPCM Buildout Leads integrated delivery across underground and surface packages Executive search
Cost Engineer / Scheduler Full EPC/EPCM Buildout Maintains cost and schedule baseline for a workforce peaking at ~3,800[10] Embedded recruiting; recruitment process outsourcing (RPO) for volume
Discipline Superintendent (Civil, Structural, Mechanical, Electrical & Instrumentation) Full EPC/EPCM Buildout Executes specific systems; coordination failures cause rework and safety incidents Embedded recruiting
Mine Operations Manager Ramp-Up & Operations Must influence final design and lead commissioning readiness; hire 12–24 months pre-first ore[20][33][34] Executive search
Processing Plant Manager / Maintenance Manager Ramp-Up & Operations Builds operating culture, procedures, and maintenance systems before startup Executive search + embedded recruiting
Reliability Engineer Ramp-Up & Operations Reduces start-up risk and supports long-term asset performance Targeted specialist search

Those phase-based needs call for different recruiting methods. Executive search fits senior leadership. Embedded recruiting works best during buildout. Specialist search is the better route for hard-to-find underground roles. And RPO can help handle volume during ramp-up. The hiring model should match the phase, not the other way around.

Conclusion: What Resolution Copper shows about megaproject execution and hiring risk

Taken together, Resolution Copper's scale and permitting history make it clear why construction readiness took so long. This is the kind of megaproject that can sit in permitting and preconstruction for well over a decade before the work is actually ready to execute. And that long gap creates a hiring problem owners have to handle with care.

The project also calls for rare underground specialists. Time doesn't create more of that talent. It just gives other projects more time to hire those people first. That's why hiring needed to move side by side with approvals, not far ahead of them.

The main lesson comes down to timing. Hiring should be tied to key project gates, so staffing grows only when approvals and funding are in place. Each gate should set off a clear hiring plan instead of a broad hiring push. That gives the owner a way to control cost during uncertainty and then move fast when the work is finally ready to begin. For megaproject owners, workforce planning is a delivery decision, not a back-office function.

FAQs

Why did approval take so long?

Resolution Copper went through a long permitting process. That’s common for large greenfield mines, where regulation is often the biggest hurdle before any construction starts.

A few things drove the delay:

  • complex environmental review under NEPA
  • seasonal baseline data needs, which can stretch work across multiple months or years
  • multiple approvals from federal, state, and tribal authorities

On top of that, contested alternatives and litigation risk slowed things down even more. In some cases, those issues can add months or even years to the timeline.

What happens after the March 2026 approval?

After the federal land exchange is recorded in March 2026, Resolution Copper plans to put $500 million into shaft rehab and early work at the historic Magma mine over the next two years.

That move signals a clear change: the project is leaving behind a two-decade permitting phase and moving into site development. From here, the work centers on block-cave development, major infrastructure, and hiring the teams needed to run complex underground operations.

Why is hiring so difficult for this project?

Hiring for mega-projects like Resolution Copper isn't easy. The pressure is high, the work is specialized, and companies are all chasing the same limited group of skilled workers.

One big problem is the labor shortage. A lot of experienced workers are getting close to retirement, while fewer younger people are coming into the trades and other technical roles. That leaves a smaller hiring pool at the exact moment these large industrial builds need deep, job-ready talent.

Reactive hiring makes things even tougher. When companies wait until they urgently need people, problems pile up fast: burnout, turnover, project delays, and a scramble to find candidates with the right level of technical depth.
