Nuclear power deals are changing data center hiring now, not later. If I strip this article down to its core, the message is simple: the type of nuclear deal tells employers who to hire first, where to hire, and how early recruiting starts.
Here’s the short version:
If you’re a candidate, I’d focus on power systems, commissioning, and utility-facing project work. If you’re an employer, I’d move early, because these projects can start staffing 6 to 24 months before major field work ramps up.

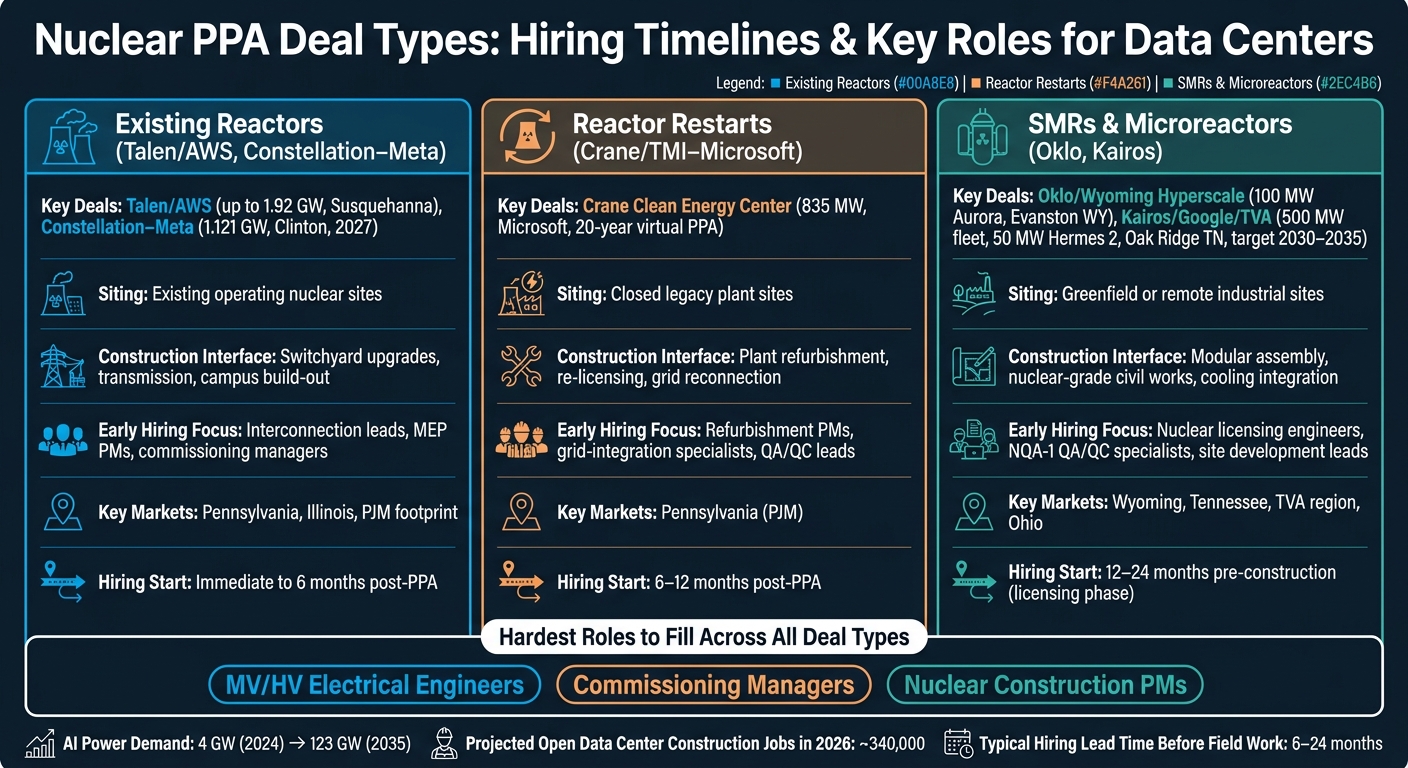

Nuclear PPA Deal Types: Hiring Timelines & Key Roles for Data Centers
What stands out to me is that this is no longer just a power story. It’s a staffing and project-timing story too. Once a nuclear PPA is signed, hiring often starts well before concrete is poured, and the labor mix changes with the deal model.
Four nuclear PPA models are now pushing data center hiring, and each one has its own timeline and labor mix. A lot comes down to the project type: an operating reactor, a restart, or a new SMR.
Constellation’s Microsoft deal ties 835 MW from the restarted Crane Clean Energy Center to a 20-year virtual PPA. Its Meta deal secures the full 1.121 GW output from Clinton starting in 2027.[2][3] Talen’s AWS deal connects up to 1.92 GW at Susquehanna to the Cumulus campus, with phased 120 MW ramps beginning in 2025.[15][16][1][17]
That setup pulls hiring forward into the parts of the project that have to move first: transmission planning, grid interconnection, and site delivery. In practice, that means more demand for transmission planners, grid-interconnection specialists, high-voltage substation engineers, site development managers, and campus MEP teams across Pennsylvania, Illinois, and the broader PJM corridor.
This is a very different labor pattern from SMRs and microreactors. With operating plants or near-term supply deals, companies can move earlier on power delivery and campus build-out instead of spending years stuck in nuclear licensing.
Oklo and Kairos shift hiring much earlier into licensing, siting, and nuclear civil work. Field labor comes later.
Oklo signed a non-binding letter of intent with Wyoming Hyperscale for a 20-year PPA to supply 100 MW from its Aurora Powerhouse microreactors to the Aspen Mountain data center campus, located on roughly 58 acres southeast of Evanston, Wyoming.[4][5][6][7] Aurora units are designed as modular, behind-the-meter microreactors. So the first hiring wave centers on site licensing, seismic review, environmental review, and nuclear civil work. That pushes demand toward nuclear civil engineers, NQA-1 QA/QC specialists, and licensing engineers well before large construction crews show up.
Kairos Power’s agreement with Google and TVA aims at a roughly 500 MW fleet of molten-salt SMRs by 2035, starting with the Hermes 2 demonstration plant in Oak Ridge, Tennessee. Hermes 2 will supply up to 50 MW into the TVA grid to power Google data centers in Tennessee and Alabama.[8][9][10][11][12][13] The first commercial deployment is targeted around 2030.[12][14]
These reactors add more handoff points between the plant and the campus electrical system. Think reactor systems, cooling systems, duct banks, electrical rooms, and control layers all having to work together. Because of that, commissioning is broader than on a standard data center campus. Mechanical integration teams and nuclear commissioning managers who can verify heat rejection and control systems at the nuclear interface are likely to be in demand across Tennessee and nearby TVA-region markets.
The hiring path changes with the model. Some projects need transmission and substation work right away. Others start with years of licensing and plant prep.
Once the deal structure is in place, delivery becomes the hard part. A nuclear PPA doesn't kick off one simple project. It starts a parallel program where siting, interconnection, licensing, design, and campus construction all have to move at the same time.
The route from PPA execution to commercial operation runs through site selection, interconnection, permitting, detailed design, procurement, construction, medium- and high-voltage (MV/HV) installation, and commissioning. Each step answers to a different gatekeeper - the utility, the local permitting authority, vendors, and the nuclear operator. So if one party slips, the next phase can stall too.
Existing-reactor deals can shorten the path because more of the work sits in interconnection and campus build-out. SMR projects are different. They shift more time into licensing and site prep. For SMR-linked projects, phase durations run about 6–18 months for site selection, 18–24 months for NRC licensing after a technology is approved, 3–4 years for first-of-a-kind construction, and 6–12 months for commissioning.[21][22] That timeline changes hiring plans in a big way. Teams have to start recruiting years before first commercial power shows up.
Phased supply deals like AWS–Talen add another wrinkle: they create repeat staffing waves instead of one big hiring surge.
Nuclear-linked campuses bring added risk at the interconnection, cooling, water, seismic, security, and commissioning interfaces. Whether the campus connects behind the meter through a direct switchyard tie-in or in front of the meter through the regional grid, such as PJM, both setups come with major MV/HV scope, complicated protection and controls work, and long lead times for transformers, breakers, and switchgear.[19][20][23] In plain English, key buying decisions have to happen early - well before the field team would like them to.
Seismic, geotechnical, physical-security, and cybersecurity requirements add even more handoffs between design, procurement, and field teams. That's why these jobs pull electrical engineers, QA/QC leads, and commissioning managers into the process earlier than a standard data center build.
More risk also means more people in the field. Owners and contractors need extra field engineers, QA/QC staff, and commissioning support to protect the energization date.
Those delivery pressures shape which roles employers need first.
Those delivery pressures are pushing hiring into three clear areas: power, commissioning, and nuclear project leadership. In plain English, companies are hiring fewer general construction people and more electrical, commissioning, and nuclear delivery specialists. The reason is simple. Interconnection work is tough, commissioning is full of hold points, and nuclear-linked projects come with extra regulatory steps. That’s where hiring tightens up fast.
Electrical engineers with MV/HV experience will be at the top of the list. Employers need people who understand 15 kV–500 kV systems, substation and switchyard design, protection and controls, and data center power distribution. On campuses tied to nuclear power, these engineers handle load flow studies, fault analyses, and redundant feed design. That work has to meet the needs of both the utility and the data center owner at the same time, which is no small task.
Commissioning managers are close behind. This role is already hard to staff, and campus-level IST leaders can command premium pay.[27]
Nuclear construction project managers are the third critical hire. These PMs need to manage the interface with reactor operators like Constellation or Talen, line up regulatory hold points and QA/QC documentation, and keep a multi-front schedule moving even when utility outage windows and equipment lead times change. That mix of experience is rare.
The common thread across all three roles is cross-functional range. Employers want people who can move between regulated power systems and mission-critical delivery without missing a beat.
The next wave of hiring will include MEP managers, substation PMs, P6 schedulers, QA/QC leads, controls leads, and field engineers. These are the people who keep large campuses moving day to day, including a 960 MW buildout like the planned Susquehanna/Cumulus program.[18][24]
The biggest edge is dual-sector experience: hyperscale plus utility or generation. Not many candidates have both, and that gap matters because it cuts interface risk on nuclear-linked programs.
Utility-side coordination is non-negotiable. The same goes for commissioning leadership through Level 1–6 and IST, backed by results such as zero critical defects at turnover. Schedule recovery experience also carries extra weight here. First-of-a-kind projects can slip when utility delays, equipment lead times, and regulatory approvals start piling up.
Credentials can help push candidates to the front of the pack, especially when they’re paired with the right project history. The ones that stand out most are:
Hiring will start in places where nuclear supply deals already have a defined campus, utility tie-in, or SMR program. That means the first wave won’t be spread evenly across the country. It’ll cluster where projects are already taking shape.
Pennsylvania and the Susquehanna Valley look like the most immediate market. The Talen/AWS deal and the planned Cumulus campus put the region near the top for construction, commissioning, and substation talent. Illinois and the broader Midwest come next, thanks to the large existing nuclear fleet and active data center growth around Chicago and major transmission hubs. Ohio and other PJM-adjacent states should also see strong demand for substation PMs, commissioning leads, and QA/QC roles as hyperscale growth overlaps with PJM’s footprint and existing nuclear plants. Tennessee and the TVA region are more of a long-game market, driven by the Kairos/TVA SMR program.[25][26]
Local labor pools won’t be enough to cover all of this demand. The industry is already projected to face about 340,000 open data center construction jobs in 2026, on top of a broader construction shortfall of 439,000 workers.[28] In markets near nuclear sites - especially Pennsylvania, Illinois, and TVA territory - employers will be chasing the same MV/HV and commissioning talent as utilities and EPCs. That likely means more rotating commissioning teams and more relocation packages for senior hires in thinner local markets.
Taken together, these deals show a clear shift: nuclear PPAs are changing hiring plans before construction even starts. Microsoft, AWS, and Google have all moved ahead with nuclear-linked power deals, and each one has active programs with set delivery windows. That means hiring doesn’t wait for ribbon cuttings or poured concrete. It starts earlier, and it tends to move alongside delivery timelines.
That project mix shapes the next wave of hiring. A small group of roles will get most of the attention, and a small group of markets will feel it first. Expect demand to center on electrical engineers with MV/HV and substation experience, commissioning managers who can run integrated system testing, and nuclear construction PMs who can handle utility, nuclear, and hyperscale coordination. Put simply, power deals change who gets hired first.
And this doesn’t stop with the deals already on the table. Future load growth is large enough that this hiring pattern is likely to stick around for years, not months.
For candidates: Focus on markets with announced nuclear PPAs, especially the Mid-Atlantic, Midwest, and TVA region. Make your crossover background easy to spot, especially in power systems, commissioning, and regulated settings. Watch announcements first, then move fast.
For employers: Get in early, before the market tightens. The 6–24 month gap between PPA signing and the hiring ramp is your window. Lock in priority roles early, write job descriptions for power-plus-data-center crossover talent, and build your pipeline before EPC awards.
Browse current mission-critical openings at /jobs. Employers building nuclear-linked teams can contact us at /contact.
Nuclear power purchase agreements tend to pull hiring forward. In practice, that means recruitment lines up with the early phases of complex power infrastructure work, not just the day construction starts.
These projects come with regulatory, safety, and licensing checkpoints that show up well before crews mobilize on-site. So employers often need to bring in key compliance, licensing, and quality hires 24 to 36 months before site mobilization.
If they wait until construction begins, they can run into schedule delays. The reason is simple: clearance and training lead times take time, and nuclear projects don't leave much room for late staffing.
The hardest roles to fill are the ones that sit at the intersection of nuclear-level compliance and data center delivery.
The toughest searches usually center on nuclear construction project managers, QA/QC leads with NQA-1 fluency, and commissioning leaders for safety-critical systems. Companies also tend to hit delays when hiring Primavera P6 schedulers and MEP estimators.
These roles often take 60 to 90 days or longer to fill. That’s why hiring early matters. A late start can easily turn into schedule slip.
The first wave of hiring will likely show up in the markets where power and nuclear-adjacent project work is moving the fastest: Northern Virginia, Texas - including DFW and West Texas - Tennessee, Idaho, Wyoming, and parts of the Southeast, Mid-Atlantic, and Midwest.
For broader AI data center hiring linked to power solutions, demand is also concentrated in Phoenix, Atlanta, Columbus, and Reno.
