Per-MW pricing, regional variance, and cost drivers for owners scoping hyperscale & AI builds.
Salary benchmarks across the 14 mission-critical disciplines.
If leadership hiring lags, the ramp usually slips. I’d use leadership-per-GWh as a simple way to plan when to hire salaried staff, not just how many to hire by the end.
Here’s the core takeaway in plain English:
What stands out to me is this: the ratio only works if I tie it to the ramp phase. Project leadership, construction, commissioning, EHS, quality, maintenance, controls, HR, procurement, and training do not peak at the same time. Some teams need to be in place before design freeze. Others need to land 6 to 9 months before SOP. And roles tied to training or incident response should be on site at least 12 weeks before SOP.
A few numbers shape the whole plan:
I’d treat these figures as planning ranges, not fixed rules. Automation, vertical integration, chemistry, and delivery model can shift the count. For example, owner-managed builds often need more owner-side staff than EPC-led turnkey projects, and line-heavy sites tend to lean harder on quality, controls, and reliability.
The article’s main point is simple: don’t build staffing from the final org chart backward. Start with the ramp calendar, apply function-level ratios, and hire in waves tied to design freeze, equipment install, commissioning, trial production, SOP, and volume ramp.
Use these function-level bands to turn total ramp headcount into a hiring plan. In practice, staffing intensity comes down to three things: automation level, delivery model, and scope. A plant run by an EPC on a turnkey basis will need a different owner-side team than a build the owner manages directly. And a cell-only plant won’t staff the same way as a site that also includes cathode, anode, or pack. The table bands below help size the core team before you map hires into a calendar.
Leadership demand tends to spike in two waves: first at peak construction, then again during commissioning. Construction staffing usually tops out earlier, commissioning follows, and both ease off as the plant settles into operations.
For a mid-complexity 35 GWh U.S. plant, project managers usually sit at 0.05–0.07 FTEs per GWh during concept and design. That climbs to 0.10–0.14 per GWh at peak construction, then settles at 0.06–0.08 per GWh in the first-year ramp. Commissioning managers and discipline leads are barely present in early design, then jump to 0.08–0.12 per GWh during startup before dropping back after operations steady out.
An EPC-led turnkey project usually shows lower owner-side ratios because the contractor carries many of these roles. Owner-managed builds that rely on several specialist firms tend to push owner-side staffing toward the top end of each band.
These functions have one thing in common: most need a minimum team no matter how small the plant is. That’s why the per-GWh ratios shrink as plant capacity gets bigger.
EHS is a good example. At 10 GWh, you’re often looking at 0.06–0.10 EHS FTEs per GWh - usually a manager plus a small team. At 60–100 GWh, that drops to 0.03–0.06 because the same group can cover more production lines without headcount rising at the same pace.
Quality scales a bit more with product mix and critical process steps. It runs 0.08–0.12 per GWh at 10 GWh, then compresses to 0.04–0.08 at 60–100 GWh as automation and standard work cut the extra staffing needed for each added line. Controls and MES/SCADA support behave a little differently. They carry a heavy integration load early in the ramp, so ratios are higher up front, then flatten once standard control templates can be reused across lines.
A vertically integrated plant with cathode and anode lines may keep process engineering near 0.05–0.09 FTEs per GWh across all capacity bands. In that case, chemistry and process complexity matter more than plant size.
Once the core plant teams are in place, the ramp starts to shift. The focus moves away from pure execution and toward hiring, training, and supplier readiness.
Support staffing tends to move early because hiring, training, and sourcing have to lead production, not trail behind it. In plain terms, these teams usually peak before SOP.
Large U.S. battery projects often need dedicated recruiting teams equal to 0.05–0.10 FTEs per GWh across the 12–18 months before start of production. After the bulk of hiring is done, that number drops fast to under 0.02 per GWh. Procurement and supply chain follow a similar pattern. During equipment buyout and supplier qualification, they often run at 0.05–0.09 per GWh in capex-heavy phases, then compress to 0.03–0.05 once the big contracts are in place.
All ratios are FTEs per annual GWh. Highly automated plants may need relatively more training and controls specialists per GWh even at steady state.
These are planning ratios, not final org-chart counts. The next step is to line them up against the ramp schedule and sequence hires accordingly.
Hiring for a mission-critical build? Get a pre-qualified shortlist.
iRecruit.co specializes in construction recruiting for data center, energy, and advanced-manufacturing projects — project managers, MEP coordinators, commissioning leads, and more. We pre-screen every candidate so only qualified professionals reach your hiring team.
Get Started
Success-based pricing · 90-day replacement credit · No upfront fee on single roles
As capacity grows from 10 to 100 GWh, salaried headcount does not climb in a straight line. The total headcount goes up, of course, but the per-GWh ratio drops as the plant gets larger. That happens because back-office and general management roles don't need to grow at the same pace as the factory itself. Technical and line-facing roles, on the other hand, stay much more tied to capacity.
The table below translates the function bands into peak-ramp salaried headcount across four common plant sizes. Peak-ramp is the right planning point because it reflects late commissioning and the first few months of production, when staffing needs are at their highest.
The pattern stays the same across sizes. What changes is the count. At 100 GWh, that translates to 200–280 people in project, construction, commissioning, and operations-readiness roles. At 10 GWh, you see the same setup, just with a much smaller team.
Function mix matters just as much as total headcount. At a 35 GWh plant, the largest permanent groups are operations leadership, quality, and maintenance, with about 90–130, 50–80, and 60–90 salaried roles. At 100 GWh, the same shape holds, but quality, controls, and reliability grow the fastest because they follow line count and process complexity more closely.
Plant size affects the ratio, but it doesn't affect every function the same way. Three factors tend to move staffing ratios more than capacity alone.
Automation level has the biggest impact. A heavily automated electrode and cell line needs more controls engineers and MES specialists per GWh. Bigger plant, same basic issue: system complexity doesn't just fade away.
Vertical integration adds more scope. If a site also handles cathode active material processing or pack assembly, it needs extra process engineering, quality, and EHS support that a cell-only plant wouldn't need.
Ramp timing matters too. Early ramp phases usually need more front-loaded project controls staffing for hiring, onboarding, and capital oversight.
So the overall ratio is useful, but only as a gut check on the full salaried count. The better approach is to build the model function by function using the bands above. When automation, vertical integration, or novel chemistry add complexity, push technical roles toward the high end. At large, more complex plants, quality, controls, and reliability carry the heaviest staffing load, which shapes hiring priority in the next section.
Those differences drive the hiring sequence in the next section.

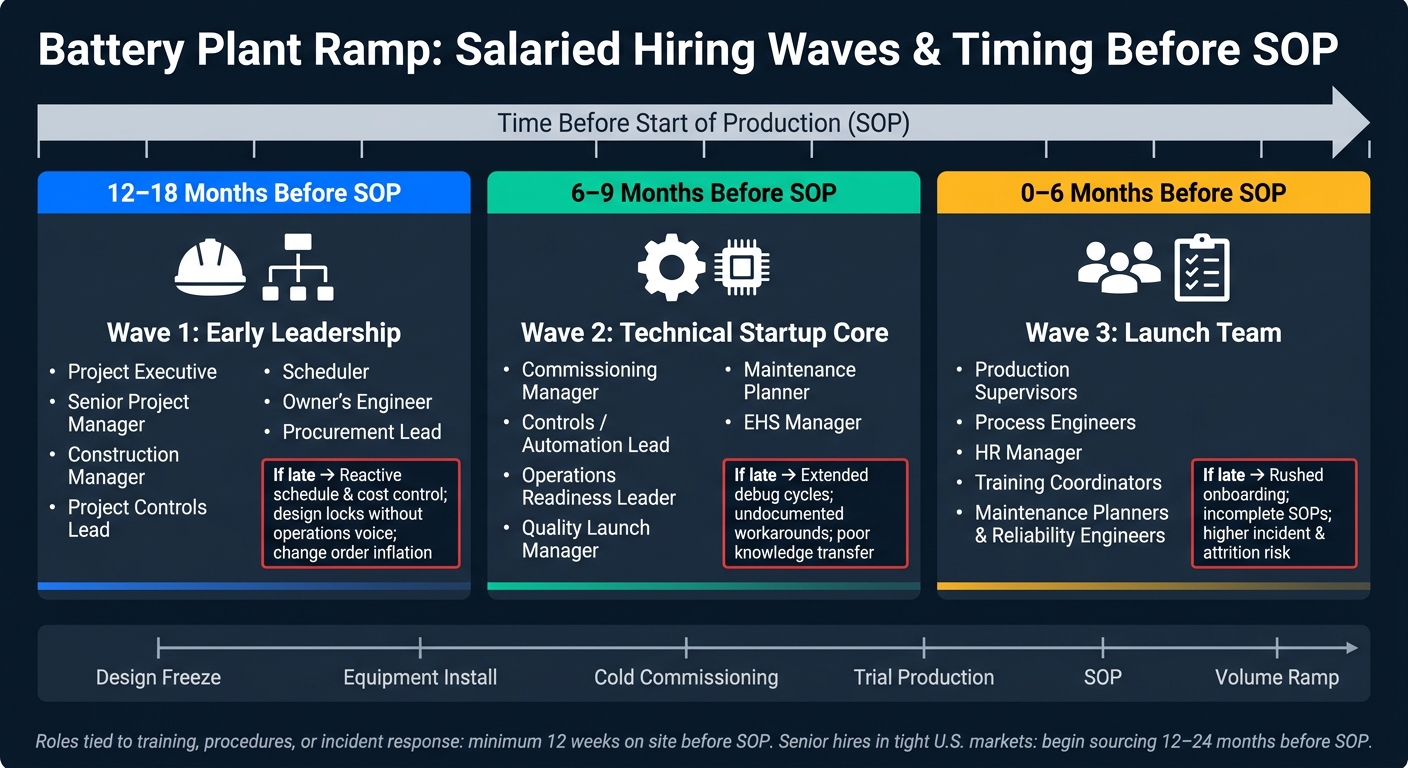

Battery Plant Ramp: Salaried Hiring Waves & Timing Before SOP
Headcount ratios only help if people show up when the ramp needs them. If commissioning, controls, and operations leaders come in after the work is already moving, the ramp starts to slip. That’s when teams end up reacting instead of leading.
So don’t plan hiring from the final org chart. Back-plan it from the ramp calendar and key milestones.
The hiring sequence should follow the path from design freeze to volume ramp: design freeze → major equipment installation → cold commissioning → trial production → SOP → volume ramp. Each step needs a different group of leaders already on site, working with the team, and close to the work.
This sequence turns staffing ratios into a hiring calendar:
Each hiring wave ties to a different kind of ramp risk:
Project leadership needs to be in place before design freeze. That’s when layout, utilities, and maintenance access get locked in. If operations leadership isn’t part of those calls early, the plant can inherit problems that are hard and expensive to fix later.
The 6–9 month wave carries some of the highest late-hire risk. Commissioning, controls, quality, and operations readiness leaders need to work alongside OEMs during factory acceptance testing and stay close to on-site installation. That gives them room to shape routing, standards, and startup methods before the plant goes live. If those hires come in late, teams often face long debug cycles and undocumented workarounds that stick around well into steady-state operations.
Any role tied to training, procedures, or incident response should have at least 12 weeks on site before SOP.
Even a solid hiring sequence can break down if the labor market can’t supply the people you need on time. In many U.S. battery build regions - the Southeast, Midwest, and Southwest - that risk is hard to ignore.
Research across the EV and battery industry found that 82% of respondents reported shortages of skilled local applicants.[1][2] A survey of 158 professionals in EV and battery manufacturing found the biggest gaps in cell manufacturing and pack assembly, which is exactly where commissioning, controls, and quality leadership matter most.[1]
The hardest roles to fill tend to be commissioning managers, controls and automation engineers, QA/QC leaders, and EHS managers who have both construction-phase and operating-plant experience. A 4–6 month search is common for these jobs. In plain terms, that means sourcing has to start early, lead times need to be built into the plan, and the candidate pipeline has to be active before the ramp window opens.
Use leadership- and support-function-per-GWh ratios as a starting point, not the final staffing plan. They give owners, EPCs, and recruiters a fast way to size a salaried headcount range and spot where leadership density matters most - without building a full bottom-up model from scratch. That matters because staffing demand doesn't peak all at once. It shifts as the plant moves through the ramp.
Don't lump construction, commissioning, and stable operations into one headcount figure. Each phase comes with a different staffing load and a different kind of risk. Commissioning and ramp usually need more leadership density than steady-state operations because process risk and schedule pressure hit at the same time. That's why a range works better than a single headcount target.
Model headcount as a range, not a fixed number. A 35 GWh plant can land in different parts of that range based on scope, automation, and risk. Lean staffing may lower cost, but it can also increase ramp risk. Plant scope plays a big part too. A cell-only plant, a cell + pack site, and a vertically integrated site won't have the same staffing density or mix of functions.
Once you set the range, turn it into a hiring calendar. Build a phased matrix with project phases as rows and GWh and function ranges as columns. Fill it in with the ratio bands from this article, adjust for your plant's scope and risk tolerance, and map hiring windows on top of it so your recruiting calendar reflects actual lead times. In U.S. projects, some senior hires should be planned 12–24 months before SOP in tight labor markets, especially when commissioning and controls talent is hard to find.
Then revisit the plan at each major ramp milestone. Schedule changes, scope shifts, and tech changes can all alter the risk profile underneath the model. Set formal review points at design freeze, major contract awards, first tool install, and first material in. At each step, check your ratios against the latest assumptions.
Choose the right per-GWh ratio with phase-based, milestone-driven planning, not one fixed multiplier.
Look at four variables: facility scale and complexity, project phase, delivery model, and operating and risk needs. Use separate ratios for design, construction, commissioning, and owner oversight. Then add staff where needed for peak commissioning and startup periods.
Hire the core leadership and project controls team at project kickoff, ideally 4 to 6 months before site mobilization.
Start with these roles:
As the project moves through design and preconstruction, bring in the MEP lead and commissioning lead. At that stage, put extra focus on the Construction Manager, Project Manager, Electrical Lead, and interconnection specialists. Those roles help manage the biggest schedule pressures and grid-related risks.
Beyond plant capacity, staffing ratios mostly come down to automation and operational complexity.
Sites with more advanced automation and AI tools can run with leaner teams than sites that still rely on manual work. Put simply, better systems can take routine tasks off people’s plates and cut the number of staff needed on the floor.
Complexity changes the picture too. Facilities with high-density GPU clusters, liquid cooling, high-uptime tiers like Tier IV, or multi-tenant compliance and client support often need more specialized engineers, plus round-the-clock monitoring staff. The more moving parts you add, the more expert oversight the site tends to need.
