Per-MW pricing, regional variance, and cost drivers for owners scoping hyperscale & AI builds.
Salary benchmarks across the 14 mission-critical disciplines.
Most subfab budget misses come from three areas: structure below grade, dense utility routing, and service access. If I had to boil this topic down fast, I’d say this: subfab costs are not driven by floor area alone. They move with system density, vibration limits, redundancy, and how hard it is to build and service the space.
If you’re planning a fab, here’s the short version:
A few numbers make the point fast:
What matters most is simple: I would treat subfab construction and service as one cost story, not two separate line items. Early choices on routing, access, spare capacity, and staffing can cut later outages, rework, and labor spend. That’s the main takeaway from the article.
This section below gives you the plain-English version so you can see where the money goes, what gets missed, and what to lock down early.

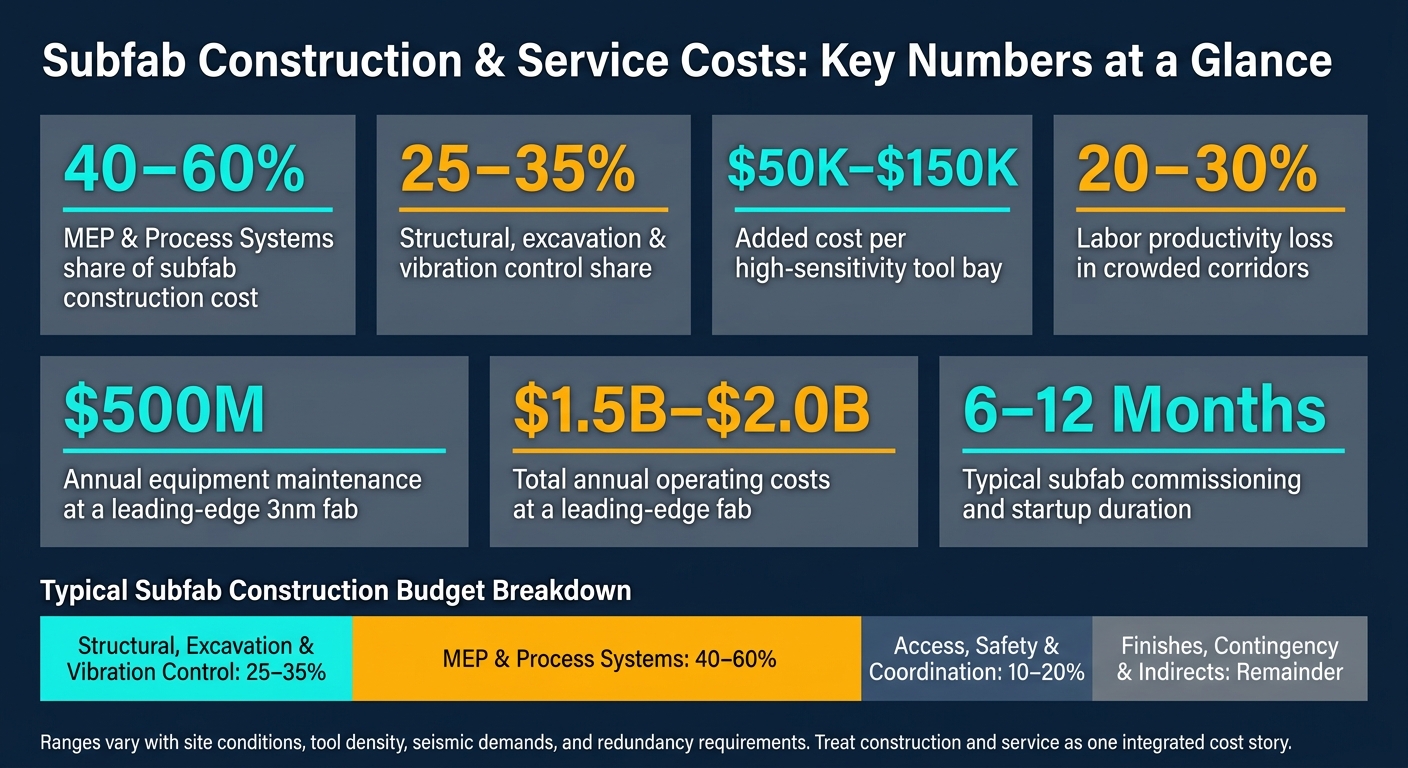

Subfab Construction & Service Costs: Key Numbers at a Glance
Three items drive most subfab budgets: below-grade structure and vibration control, utility and process routing, and access and safety infrastructure. Once the scope is set, the next step is figuring out which systems push costs up the most.
Deeper excavation means higher shoring and dewatering costs. Poor soil conditions add structural expense. High-seismic sites need more reinforcement and more spending on vibration control. And when tool bays are highly sensitive, teams may need thick slabs and isolation systems tied straight to tool sensitivity and uptime targets.
This is also the area where subfab structural costs split most from standard industrial construction. Modern fabs are so sensitive that even minor vibration from a nearby road or subfab pumps can lead to costly production rejects. Designers deal with this by anchoring the lowest fab level with deep piles and decoupling the cleanroom with springs and isolation joints.[2] Some semiconductor facilities require slabs up to 4 feet thick, along with very tight deflection limits.[3]
For individual tool bays that house lithography scanners or precision metrology equipment, budget $50,000–$150,000 per high-sensitivity bay for structural and isolation upgrades above the subfab baseline. In favorable conditions, plan for $80–$150 per square foot. If deep excavation, poor soils, and seismic demands all show up at once, that range can climb to $150–$250 per square foot.
At the most advanced nodes, the share of total capex going to vibration isolation and structural control has grown from about 12–15% to 18–22% as EUV and high-NA tools become more sensitive to outside disturbance.[4] Once the structure is locked in, utility routing becomes the next big cost swing.
MEP and process systems usually dominate the subfab footprint. They form the utility backbone that keeps process tools running. In dense semiconductor subfabs, MEP and process system budgets often represent 40–60% of total subfab construction cost, with specialty piping for ultrapure water (UPW) and process gases alone making up 20% of the total mechanical budget.
Crowded corridors hurt installer productivity by 20–30% compared with open mechanical rooms. N+1 or N+2 redundancy adds 20–40% to MEP cost. Prefabricated racks and early BIM coordination can win back 10–20% of that loss by cutting field cutting, fit-up conflicts, and change orders before mobilization.
Put simply, a packed subfab is a bit like trying to rewire a car engine while the hood opening keeps getting smaller. The systems still have to fit. They just cost more to place, connect, test, and maintain.
After routing and redundancy are addressed, access and life-safety rules add another cost layer.
Access and safety work often gets underbudgeted, even though it is a major construction package. Catwalks, stairs, egress routes, fire protection, gas detection, and service clearances all carry direct structural, MEP, and controls cost. NFPA 318 and insurer guidance often require 1–2 hour fire-rated barriers between the cleanroom and adjacent subfab or hazardous support areas.[1][5]
Better access cuts outage time and service labor. Poor access can double the time required for routine maintenance tasks like filter changes or valve replacements. That makes access design both a construction issue and an operations issue. Clearance dimensions, catwalk placement, and egress routing set the starting point for service labor efficiency across the facility's lifecycle.
These shares tend to move in pretty predictable ways. Tough geotechnical conditions can push structural costs toward 35–40%, while extremely dense or highly redundant process facilities can move MEP toward 60–70%. High-seismic sites and facilities with strict vibration limits also increase the structural share. Those same systems also shape commissioning, maintenance, and lifecycle service spend.
Construction builds the subfab. Service keeps it running.
These are the repeat costs that keep subfab systems up and usable day after day. And they often get underbudgeted early. In practice, ongoing subfab service costs usually cover commissioning support, preventive maintenance, repairs, inspections, parts replacement, calibration, outage support, and upgrades. They also include the specialty labor, permit steps, and cleanroom-adjacent coordination needed to work safely around live systems.
In advanced semiconductor fabs, annual equipment maintenance can reach $500 million at a leading-edge 3 nm fab, with total operating costs around $1.5 billion to $2 billion per year.[8] Even in smaller facilities, these repeat costs stack up fast. The same below-floor systems that make construction expensive also drive service spend. The difference is that the budget risk shifts. During construction, the pressure comes from build complexity. During operations, it comes from uptime and labor.
Subfab commissioning is not a one-and-done punch-list item. It can take 6 to 12 months and usually includes systems testing, controls verification, alarm and interlock checks, vibration and alignment validation, utility startup, and coordination across trades and vendors.
That work is labor-heavy, and on mission-critical projects it can become one of the biggest early service expenses. This is especially true when chemical exhaust, abatement systems, and ultrapure water delivery all have to meet tight process specs.
When certification goes wrong, the cost is not small. Design or testing mistakes can lead to $50,000 to $200,000 in added expense and delays of 3 to 6 months. That’s why experienced teams put together a commissioning and startup matrix early. They map each subfab system to its test protocol, acceptance criteria, and responsible party before mobilization starts. Once the systems are validated, the cost focus moves from startup to uptime.
The main repeat cost drivers are familiar, but in a subfab they’re harder to deal with:
These parts run nonstop, often moving corrosive or contaminated media. Because of that, they wear out faster than similar equipment in a standard industrial plant. Then access makes the job even harder. A repair that might take a few hours in a normal facility can turn into a staged outage with confined-space rules, lockout/tagout steps, and post-repair verification.
For owners, that changes the math. Maintenance staffing and specialty contractors are not side costs. They belong in the base cost model.
Owners also need room in the budget for planned outages, component replacement, inspections, recertification, and upgrade windows. Predictive maintenance can cut those costs in a meaningful way. In one semiconductor case, moving from reactive to predictive maintenance on vacuum pump fleets extended mean time between preventive maintenance from roughly 10,000 to 20,000 hours, which cut preventive pump replacements by about 50%.[6] That kind of result does not happen by accident. It takes planning, data, and follow-through.
Retrofits are where service estimates often fall apart.
A process change that needs new utilities and exhaust routing is almost never just an equipment swap. It usually means rebalancing current systems, retesting controls, lining up several downtime windows, and recommissioning nearby utilities, all while live operations keep moving close by. That’s where budgets get squeezed.
A production expansion that adds pump capacity and higher electrical loads can also trigger temporary equipment rentals, overtime labor, and recommissioning for systems nobody expected to touch again. Retrofits also push up demand for planners, controls techs, and outage crews who know how to work around live production without causing bigger problems.
One smart move is to oversize utility infrastructure by 20% to 30% during initial construction to reduce later rerouting and demolition.[7] If a facility skips that step, it usually pays for it later. Adding a redundant utility path in a crowded, live subfab costs far more than putting it in the first time.
Over 10 to 20 years, operational expenditure often exceeds original capital investment several times over.[9] That’s why service assumptions need real budget weight from the start, not just a placeholder line item before the next budget cycle.
Use a line-item budget, a risk check, and a clear owner for each package. That makes subfab estimates easier to compare, cuts scope gaps, and links cost control to day-to-day execution. The categories below turn the main cost drivers into a planning checklist teams can actually use.
Breaking a subfab budget into six defined categories gives owners a repeatable way to build estimates, compare bids, and catch gaps before procurement starts. It also helps teams ask the right questions early, when fixes are still cheaper.
The table below shows what each category usually includes and where early estimates often come up short.
A table like this does more than organize numbers. It gives teams a shared view of scope. If one bid includes burn-in support and another does not, or one contractor prices future sleeves and another leaves them out, you can spot the mismatch before it turns into a change order.
Most overruns don’t start with one big mistake. They start with small misses in design, coordination, site conditions, or late changes. The controls below are the fastest ways to keep those problems from snowballing.
A simple way to think about this: if the design is loose, the price will be loose too. And if access, routing, or below-grade conditions are not nailed down early, the field team usually pays for it later in time, labor, and rework.
Budget categories only work if the right people are in place to manage them. The MEP sector is short about 650,000 skilled workers nationally [10], and that labor pressure hits both pricing and schedule. So budget control is not just a spreadsheet task. It depends on assigning each package to the right person before procurement begins.
Assign these roles before procurement to cut scope gaps and change orders.
Subfab costs usually come down to a few big factors: below-grade complexity, utility density, vibration control, maintainability, and lifecycle service.
It helps to treat construction and service as one budget, not two separate buckets. A choice made early in design - like adding accessible catwalks - can cut future outage time, repair costs, and safety issues. It also makes day-to-day upkeep much easier over the life of the facility.
That same mindset should guide hiring. These cost pressures get harder to manage when commissioning and field leadership show up late.
The takeaway is simple: late staffing increases project risk. Operations and maintenance staff should be identified and trained before startup. If your team is missing project management, MEP coordination, commissioning leadership, or field supervision, fill that gap before procurement. Plan the team before the schedule hardens.
If your team needs outside hiring support, iRecruit.co can help source construction project managers, MEP leads, commissioning managers, and field leadership for mission-critical environments.
Subfab planning needs to start from day one. Early choices can shape up to 80% of total project cost and schedule, so power, water, gas, purchasing, and labor plans should line up long before construction starts.
Owners should lock in utility needs early and size power, water, and gas systems at the start. They should also secure long-lead equipment 18 to 36 months in advance. Bringing in general contractors and specialty engineers during schematic design helps avoid expensive redesigns later.
Before bidding starts, owners need to pin down a clear project scope, line up long-lead tools and utilities, and build a high-precision bottom-up cost estimate. That upfront work helps cut rework, schedule slips, and budget overruns.
Owners should also put an integrated delivery model in place, with contractor input during design instead of waiting until later. On top of that, clear governance matters early, along with hiring key technical leaders such as project executives, MEP leads, and commissioning specialists.
Plan for about 20% to 30% spare capacity in below-floor utility and HVAC systems during the initial design phase. That extra room gives you space for future growth and shifting cleanroom or mission needs.
It also helps lower the risk of expensive upgrades down the line. Think of it as an early investment in scaling the space and staying compliant as requirements change.
