Most construction cost savings come from a few early decisions. If I had to boil this article down to one point, it’s this: pick the right structural system, set the MEP approach early, use prefabrication where it fits, and make substitutions before the design is locked. That’s where teams often save 5% to 15% overall, and sometimes 10% to 30% when VE starts early.
Here’s the plain-English version:
A few numbers stand out:

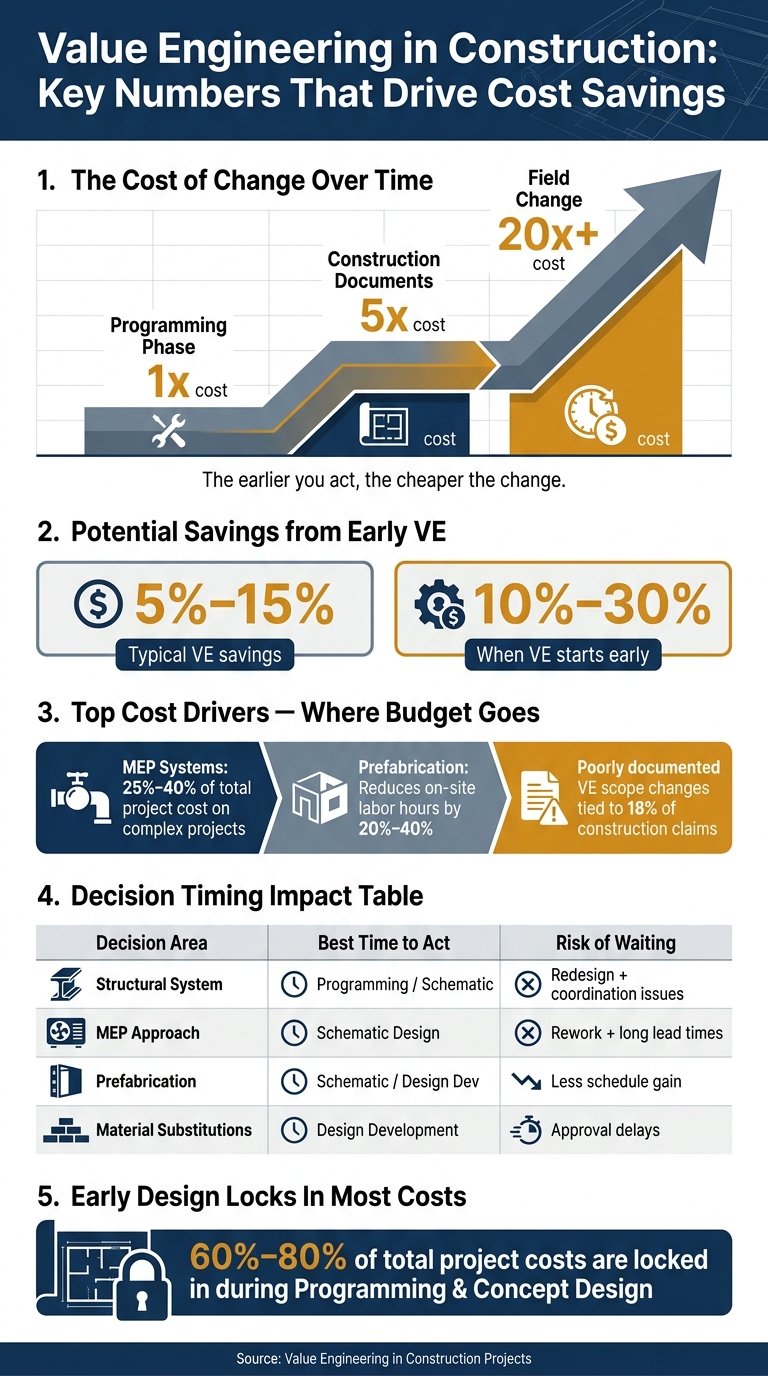

Value Engineering in Construction: Key Numbers That Drive Cost Savings
| Decision area | What moves cost most | Best time to act | What happens if you wait |
|---|---|---|---|
| Structural system | Grid, bay spacing, floor-to-floor height | Programming / schematic | More redesign, tougher coordination |
| MEP approach | System type, equipment sizing, standardization | Schematic | Rework, longer lead times, RFIs |
| Prefabrication | MEP racks, pods, repeatable assemblies | Schematic / design development | Less schedule gain, harder trade coordination |
| Material substitutions | Finishes, facade, non-public areas | Design development | Approval delays, spec conflicts |
| Team input | Builder, trades, BIM, estimator, superintendent | Early precon | Missed constructability and pricing issues |
If you want VE to do more than trim a few line items, you need to make a short list of high-impact decisions early and put the right people on them. That’s the core message of the article.
Most VE results come from three early choices: structure, MEP, and off-site fabrication. These decisions shape cost, schedule, and coordination long before the job hits full speed.
The structural system sets the ground rules for almost everything that follows. Bay spacing, floor-to-floor height, and grid alignment with MEP systems affect procurement, erection speed, and how much flexibility the building has later on. In plain terms: if the structure is off, the rest of the project starts fighting it.
This is a first-order decision for erection speed and long-term use. When the structural grid lines up with architectural and MEP planning, teams can avoid costly transfer beams and messy utility routing [1]. Even a shift in bay spacing can change the math in a big way. Moving from 30 to 40 feet changes steel tonnage and foundation loads [4]. Keeping those dimensions standardized can also shorten lead times and make prefabricated components easier to buy and install.
Floor-to-floor height is another lever that often gets missed. Post-tensioned slabs can reduce those heights, which cuts envelope, cladding, and vertical construction costs. On top of that, post-tensioned systems can save 15–25% on structural costs compared to conventional reinforced concrete [3].
Once the frame is fixed, the next big pressure point is MEP coordination.
MEP systems account for 25–40% of total construction costs on complex projects such as healthcare facilities and Class A office buildings [4]. That makes MEP strategy one of the biggest cost drivers on the job. It also means late mistakes can get expensive fast.
Right-sizing equipment matters more than many teams expect. Detailed load calculations based on actual occupancy, instead of rough rule-of-thumb estimates, help avoid overbuilt systems that cost more upfront and then run poorly because they operate outside their best performance range [1][7]. It’s a common trap: cheap equipment may lower first cost, but it can drive operating cost up over time.
Standardizing equipment builds on that. Off-the-shelf components can shorten lead times and make long-term maintenance and spare parts planning simpler [7][2]. Right-sized, standardized systems can cut energy use, reduce maintenance strain, and lower commissioning risk.
BIM clash detection adds another layer of cost control. Finding conflicts between ductwork and structural beams before field crews start work can prevent rework and keep RFIs from stacking up [3].
| Strategy | First Cost | Energy Use | Redundancy | Maintenance Burden | Schedule Risk |
|---|---|---|---|---|---|
| Rooftop Units (RTU) | Low | Moderate–High | Low (zoned) | Moderate (roof access) | Low (fast install) |
| VRF Systems | Moderate | Low | Moderate | Low–Moderate | Moderate |
| Chilled-Water Plant | High | Very Low | High | High (specialized) | High (long lead/commissioning) |
| Standardized Equipment | Low | Variable | Moderate | Low (easy parts) | Low (short lead times) |
When structure and MEP are lined up, prefabrication and smart substitutions become the next place to look.
The best ROI substitutions keep performance in place while cutting field labor and lowering installation risk.
Prefabrication shifts labor off-site, which helps reduce weather delays, trade stacking, and sequencing problems. MEP racks and bathroom pods are common examples. The big win is fewer field variables on a schedule-sensitive project. And the savings are not small: prefabricated components can reduce on-site labor hours by 20–40% [3]. Standard structural dimensions help here too, since they make prefabricated parts easier to use and improve delivery predictability.
Material substitutions work best when they go after items that are plainly over-specified. Swapping a specified $42/SF porcelain tile for a $28/SF option with matching durability ratings is a clean VE move [4]. Replacing conventional curtain walls with insulated metal panels at non-public elevations can save $30–$50 per square foot [3]. But a lower price alone isn’t enough. Any substitute still has to meet performance, code, and warranty requirements [1].
| Material Option | Labor Impact | Install Duration | Maintenance | Service Life |
|---|---|---|---|---|
| Brick Facade | High | Long | Low | 50+ years |
| Precast Panels | Low | Short | Low | 50+ years |
| Porcelain Tile | Moderate | Moderate | Low | 25+ years |
| Luxury Vinyl Tile (LVT) | Low | Very short | Very low | 10–15 years |
| Insulated Metal Panels | Low | Short | Low | 30–40 years |
A $0.50/SF savings may look good on bid day, but if it cuts service life from 25 years to 15 years, it’s a bad deal [4]. Each substitution has to be judged against total cost of ownership, not just the line item in the budget.
VE only matters when an idea turns into an approved scope change soon enough to shape design, buyout, and fabrication. Once the team spots the best VE options, the next move is simple in theory but tough in practice: decide when each idea should happen and who needs to approve it.
If that sounds basic, it is. But this is where projects often bog down. A good idea that shows up too late can miss its window.
The earlier a team makes a VE decision, the more control it has.
| Phase | What to Decide |
|---|---|
| Programming & Concept | Footprint, structural grid, massing, orientation |
| Schematic Design | Structural system type, MEP system type, envelope strategy |
| Design Development | Material substitutions, equipment standardization, prefabrication scope |
| Preconstruction | Trade partner selection, sequencing, formwork strategy, prefabrication details, submittals, mockup reviews |
The strongest teams don’t treat VE like a one-time workshop. They build it into the way the design moves forward and review it at each design milestone [6]. That matters because timing alone isn’t enough. The people responsible for cost, design, and field execution all need to be in the room when choices are made.
A footprint change during programming can shape the whole job. The same change during preconstruction? That can turn into redraws, delays, and a stack of hard conversations. That’s why early-phase VE tends to have the most pull.
Clear roles keep VE from sliding into a pure cost-cutting exercise. Each person sees a different kind of risk, and that mix leads to better decisions.
| Role | What They Bring to VE |
|---|---|
| Project Owner | Defines the project's value, establishes priorities, and decides which trade-offs are acceptable |
| Design Lead | Protects functional intent and safety while exploring alternatives |
| Estimator / Cost Engineer | Provides cost modeling and quantifies the financial impact of decisions |
| Contractor / Builder | Offers practical field knowledge on constructability, labor requirements, and installation efficiency |
| BIM / VDC Manager | Coordinates models across disciplines and uses clash detection to test how design adjustments affect the overall project |
| Structural Engineer | Aligns grid spacing with standard member lengths to reduce steel tonnage and speed up erection |
| MEP Manager / Engineer | Focuses on right-sizing equipment through load modeling and coordinating plenum depths to avoid costly rework |
| Superintendent | Flags sequencing problems and labor constraints |
| Commissioning Manager | Ensures VE decisions don't compromise long-term system performance |
| Trade Partners / Subcontractors | Identify opportunities for prefabrication, standardized components, and efficient routing of systems that designers might overlook |
The owner has to make the trade-offs. If no one in the room has the authority to decide, VE can drift into a slow memo exchange [4]. And once a decision is made, the team needs to update drawings and specifications right away. If not, scope gets fuzzy fast, and that opens the door to change-order disputes [3].
When the right people are involved at the right time, VE stops being just a workshop conversation and becomes a scope the team can actually build without blowing the budget.
Specialized talent decides whether a VE idea turns into an approved, buildable change or just stays on paper. A team can come up with a smart cost-saving move, but if no one is there to test it, price it, coordinate it, and carry it through, that idea usually stalls.
The issue isn't only finding savings. It's having the right people involved early enough to check whether those savings will hold up.
When teams are short-staffed, or when generalists are filling roles that call for sharper judgment, VE quality drops fast. If preconstruction managers, estimators, MEP managers, structural engineers, BIM managers and digital leads, or superintendents and field leadership aren't in the room early, VE often gets pushed into later phases. And that's where trouble starts, because the same change can cost 20x more at that point [4].
MEP-heavy work carries the most risk. In healthcare, hospitality, and Class-A office projects, MEP systems usually make up 25%–40% of total costs [4]. That's a big slice of the budget. BIM managers and digital leads matter a lot here because they handle clash detection and make sure VE changes move through the model the right way. Without them, a cost-cutting choice can trigger coordination mistakes later [6].
Cost control is another spot where teams often slip. Estimators and cost engineers need to look at all-in costs, not just catalog prices. That means freight and tariffs have to be part of the math. In 2025 and 2026, tariffs added 10%–25% to delivered costs for materials such as porcelain tile and lighting [5].
Commissioning leaders help stop a common VE mistake: cutting first cost in a way that hurts system performance and lifecycle cost later. Project controls matter too. If those controls are weak, even approved VE changes may never show up in updated drawings. That helps explain why 18% of construction claims are tied to poorly documented scope changes [3].
Superintendents and field leaders bring something design-only teams often miss: the jobsite view. They can spot labor savings, prefabrication openings, and installation risks before decisions lock in [6]. Without that input early, teams lose one of the best reality checks they have.
That's why mission-critical projects need targeted recruitment instead of broad, generic hiring.

iRecruit.co helps owners and builders fill the exact roles that keep VE moving from idea to execution. On high-stakes projects, where VE mistakes cost a lot and early staffing shapes certainty, iRecruit.co focuses on the roles that have the biggest effect on VE results:
Each role ties straight to the decision points covered in Sections 2 and 3. Preconstruction and estimating teams handle cost modeling and trade-off analysis. BIM and VDC leads test options in the model and help prevent coordination mistakes. Field leadership brings constructability and sequencing judgment. Commissioning leaders help protect lifecycle performance.
The practical upside is simple: speed and fit. Faster access to specialized candidates helps owners and builders cut rework, reduce approval friction, and carry out VE decisions with less delay when timing matters most.
Value engineering works best when teams make the right calls early, before changes spread through design, procurement, and field work. Decisions made during programming and concept design lock in 60% to 80% of total project costs [4]. That window closes fast, which is why early decisions matter so much.
The biggest wins usually come from choices around structural systems, MEP, prefabrication, substitutions, and standardization before the design is locked. These decisions affect more than upfront cost. They also shape schedule, constructability, and lifecycle performance.
At that stage, staffing has a direct effect on VE results. On complex projects, good VE depends on people who can price, coordinate, and carry out changes fast. Without those roles, even strong ideas can get stuck between concept and field execution.
That’s where preconstruction managers, estimators, BIM managers, cost engineers, and specialty trade leads come in. They turn VE ideas into approved, buildable, cost-effective results.
The best outcomes come from making the right decisions early and backing them with the right team. Good timing and the right people help keep projects on track.
Value engineering works best when it starts during programming, concept, and schematic design. At that point, big choices like structural grids, massing, and system selection are still open to change.
That timing matters for cost, too. Early in design, changes are usually simpler and cheaper to make. But once construction documents are finished, or field work is already under way, the menu of options gets a lot smaller. At that stage, even a smart change can trigger costly redesign work and schedule delays.
Owners don’t look at price alone. They balance short-term savings with long-term performance by focusing on lifecycle cost analysis.
That means value engineering looks at the total cost of ownership, not just the first invoice. It includes:
This gives owners a clearer way to justify a higher initial investment when it can cut future repair costs and energy use.
At the end of the day, project value comes down to how owners balance budget, performance, and long-term operational goals.
The biggest impact usually comes from the project owner, design lead, and general contractor, with support from specialized subcontractors.
The owner sets priorities, budget limits, and trade-offs. The design lead guards functional, performance, and aesthetic requirements. The general contractor brings pricing insight, constructability know-how, and ways to cut costs. Early input from subcontractors adds practical installation knowledge and helps teams lean on standard methods.
