Value engineering helps you cut cost without giving up the job the building must do. In plain terms, it means looking for another way to get the same result - or a better one - for less money over the full life of the project.
If I were explaining it fast, I’d put it like this:
A few numbers show why this matters:
What should you look for? I’d focus on three things: does it keep performance in place, does it avoid schedule problems, and does it lower total cost - not just the bid number? That’s the whole point of VE, and that’s what this guide breaks down in simple terms.

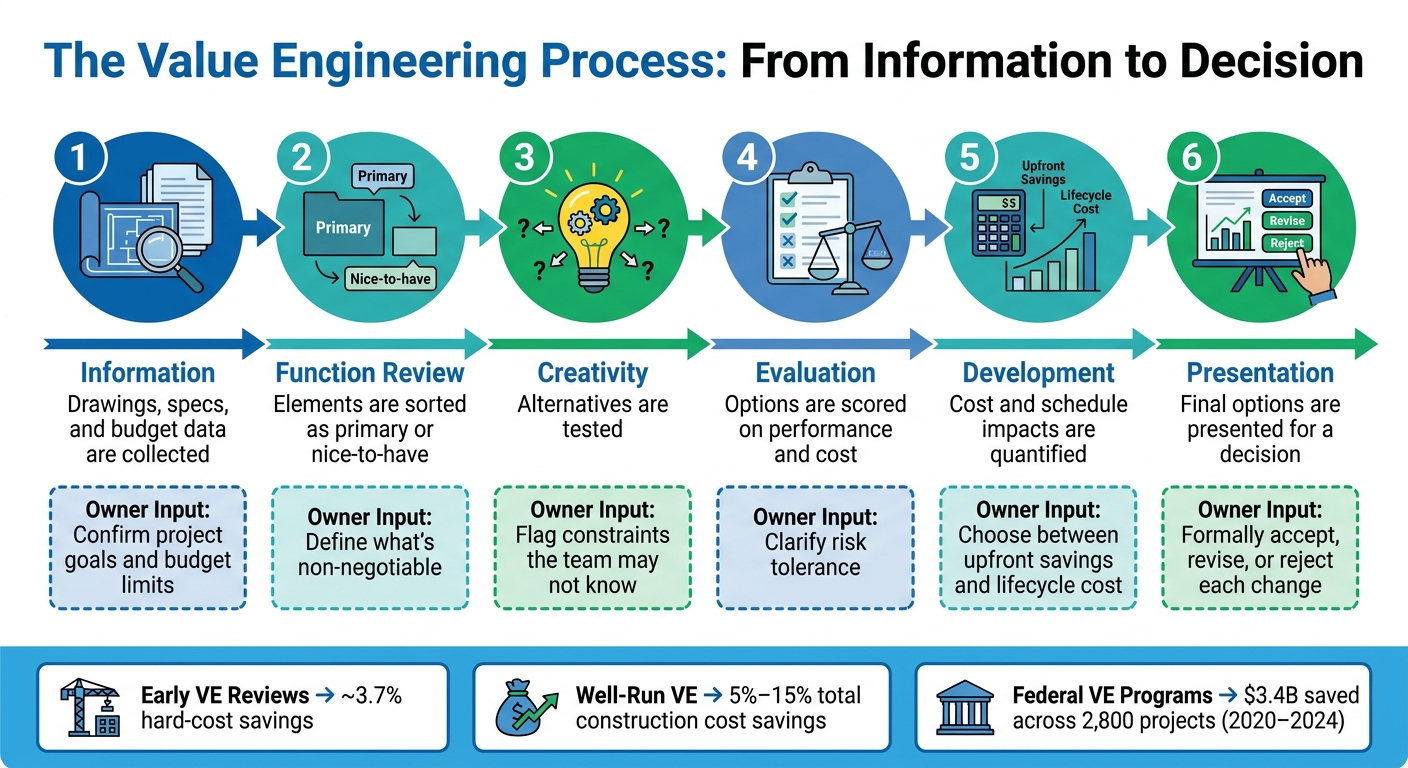

Value Engineering Process: 6 Steps to Smarter Construction Savings
Once owners get involved early, the next move is to use VE through a disciplined review process. During design and preconstruction, VE follows a simple path: gather project facts, test functions, compare options, and approve only the changes that keep performance intact.
The process begins with information gathering. The team pulls together drawings, specifications, cost estimates, schedule milestones, lead times, and the owner's stated priorities [1][2]. That keeps the review anchored to budget, scope, and what the owner cares about most.
Next comes the function review. Here, the team separates primary functions from nice-to-have features so it can see where changes are worth testing [2]. Put plainly: what does the project have to do, and what would simply be nice if the budget allows?
After that, the team tests practical alternatives for high-cost items that might deliver the same function at a lower cost or with fewer schedule issues [2]. The best ideas move into evaluation and development, where the team compares costs, checks lead times, and looks at lifecycle effects before turning the top options into formal recommendations with clear tradeoffs [1][2].
Once a change is approved, it needs to show up in the updated drawings and specifications. If that step gets skipped, coordination issues can turn into claims later [1][5].
For owners, each phase matters because it narrows the list from rough ideas to approved changes. This is what that looks like in practice:
| VE Phase | What Happens | Owner's Key Input |
|---|---|---|
| Information | Drawings, specs, and budget data are collected | Confirm project goals and budget limits |
| Function Review | Elements are sorted as primary or nice-to-have | Define what's non-negotiable |
| Creativity | Alternatives are tested | Flag constraints the team may not know |
| Evaluation | Options are scored on performance and cost | Clarify risk tolerance |
| Development | Cost and schedule impacts are quantified | Choose between upfront savings and lifecycle cost |
| Presentation | Final options are presented for a decision | Formally accept, revise, or reject each change |
The mix of people in the room can make the review useful or make it drift into theory. The owner, or the owner's representative, sets the agenda. The architect and engineers check whether each option still meets code, safety, and performance needs. The general contractor or construction manager brings pricing from the market and buildability know-how. Estimators and schedulers put numbers behind the cost and timeline effect of each option [1][2].
Trade partners and MEP specialists matter a lot when they're brought in early. Subcontractors who deal with specific systems every day usually know what can actually be built, what materials are available, and what tends to cause field problems. A design team working only from specs may miss that kind of day-to-day jobsite knowledge [1]. On more complex facilities, operations staff should also weigh in, since maintenance issues don't show up neatly on a bid tab.
Owners may not run the VE study, but they steer it. Before the process starts, you need to define your non-negotiables, your hard budget ceiling, your schedule deadlines, and any operating constraints that can't move [1][4].
The owner's role is simple but decisive: set the limits up front so the team brings back only options that can work.
With the process and decision-makers clear, the team can start testing specific design and construction alternatives.
VE options usually land in three groups: material or system swaps, prefab and constructability changes, and scope refinements. In practice, these are the kinds of changes owners tend to see during a VE review.
On complex projects, the biggest cost cuts usually come from the structure, MEP systems, and the building envelope, not from finish selections.
Post-tensioned slabs can lower structural costs by 15%–25% compared to conventional reinforced concrete. They can also reduce floor height [5]. On the envelope side, moving from curtain wall to insulated metal panels on non-public-facing elevations can save $30–$50 per square foot without changing building performance [5]. For HVAC, variable refrigerant flow (VRF) systems can cut costs by 20%–30% versus chilled water plants for the right building types, and they take up less mechanical room space [5].
Some VE decisions cost more upfront but save money over time. That’s why owners should look at total cost of ownership, not just the bid number.
| Original Design Intent | VE Alternative | Cost Impact | Schedule / Performance Notes |
|---|---|---|---|
| Reinforced concrete structure | Post-tensioned slabs | 15%–25% lower structural cost | Reduced floor height; faster cycle times [5] |
| Curtain wall (all elevations) | Insulated metal panels (non-public sides) | $30–$50/sq ft savings | Comparable thermal performance [5] |
| Chilled water HVAC plant | VRF systems | 20%–30% lower HVAC cost | Less mechanical space required [5] |
| Quartzite countertops | Engineered quartz | 10% lower | Matches durability and appearance specs [1] |
| Standard windows | High-efficiency coated windows | 3% higher | 6% reduction in operational energy costs [1] |
For owners, the job is pretty direct: weigh first cost, schedule effect, and operating cost before signing off on a swap.
Moving work off-site is one of the most dependable ways to cut field labor and protect the schedule. Prefabricated MEP racks, bathroom pods, and equipment skids can reduce on-site labor hours by 20%–40% compared to field-built methods [5]. Factory assembly can also tighten quality control.
The tradeoff is straightforward. Owners usually take on more coordination early in exchange for less field labor and better schedule certainty. Prefab asks the team to make decisions sooner, but parallel fabrication can shorten the full project timeline.
| Factor | Field-Built Baseline | Prefabricated / Modular Alternative |
|---|---|---|
| Site labor | High; weather- and condition-dependent | 20%–40% lower [5] |
| Quality control | Variable; field conditions apply | High; factory-controlled environment |
| Schedule impact | Linear; dependent on preceding trades | Parallel; assemblies built during site prep |
| Coordination demand | Lower upfront | Higher upfront; pays off during installation |
This tradeoff matters most on tight schedules, where labor availability and weather risk can hit both cost and timing.
Scope refinements are the most subtle VE tool, and they’re also the easiest to misuse. When done well, they cut nonessential scope without weakening mission-critical performance. When done poorly, they chip away at the parts of the project that matter most.
Owners should approve only the changes that keep core function, safety, code compliance, and maintenance performance intact. Teams that stick to these non-negotiables during VE are usually in a much better spot to approve good refinements fast and push back on the ones that only look cheaper on paper.
The next step is to test each idea for code impact, performance risk, and lifecycle value before approval.
Once the team brings forward a VE change, owners need a fast way to tell whether the savings are actual savings or just a lower number on paper. A proposal can look cheaper at first and still end up costing more later through delays, higher operating costs, or extra maintenance.
Every VE proposal needs a short, disciplined review. Before saying yes, owners should get clear answers to a few core questions:
If the team can't answer those questions clearly, the proposal shouldn't move forward until the documentation is complete.
Any VE change that breaks code or weakens health, safety, or required performance should be rejected right away. Code compliance comes first. After that, the design team should verify each proposal through structural analysis or performance modeling, not guesswork.
Owners should also ask for a Lifecycle Cost Analysis (LCCA) for any major system change. That's where many bad VE calls show up. A lower upfront cost can easily turn into a higher long-term bill. On mission-critical facilities, even small VE changes can affect redundancy, uptime, and recovery.
The table below shows the difference between a well-built VE proposal and one that only looks good on the budget line:
| Evaluation Factor | Strong VE Proposal | Risky Cost-Cutting Proposal |
|---|---|---|
| Code Compliance | Fully verified and documented against local building codes [2] | Assumed or requires variances that delay permits [2] |
| Reliability | Maintains or improves the intended function and longevity [1] | Reduces lifespan or durability to hit a lower price point [1] |
| Total Cost | Lowers total cost of ownership through efficiency or reduced maintenance [4] | Lower upfront cost; higher long-term operating and repair expenses [4] |
| Schedule Risk | Uses materials with verified lead times and simpler installation [1][4] | Introduces procurement risks or complex field changes that cause delays [1][4] |
| Support | Backed by detailed cost data, assembly unit costs, and lifecycle analysis [2] | Based on vague estimates or knee-jerk reactions to budget overruns [2][4] |
Even a solid proposal can fall apart if the review team is missing the right people. VE works best when estimators, engineers, contractors, and trade partners review options together.
That kind of group gives owners a better read on buildability, operations, and system interactions all at once. People with hands-on project experience tend to spot dependencies that a smaller group may miss. They also document proposals clearly, which makes it much easier for the owner to make a confident call.
After looking at the process, the options, and the guardrails, the main point is pretty clear: value engineering is not about stripping a project down to the cheapest version possible. It's a structured way to make every dollar pull its weight. The idea is straightforward: improve function while lowering total cost, not cut pieces just to hit a target number [2][3].
That’s also why early design is the best time to do VE. When teams act during schematic design, owners have more room to make smart calls and avoid expensive redesign work later [5].
From there, the owner’s role is to keep the review tied to mission-critical outcomes. Set priorities early. Keep the owner, designers, engineers, and builders aligned on construction and project delivery goals [2]. Stay open to better options everywhere else, but protect the must-have functions the building can’t operate without [2].
Done well, value engineering can save an average of 5%–15% of total construction costs. Federal VE programs saved $3.4 billion across 2,800 projects between 2020 and 2024 [5]. Those gains come from smarter calls made earlier, with better information and the right people at the table.
Treat VE as a value decision, not a budget reaction. Long-term ROI comes from early VE, clear priorities, and the right decision-makers.
Value engineering works best during the schematic or preliminary design phase, before the details are set and costs get locked in.
Start early, and you have more room to make smart changes. Wait too long, and even small shifts can lead to expensive rework.
Value engineering is a disciplined process for improving a project’s function, performance, and cost efficiency without giving up quality or its core goals.
Plain cost cutting usually means trimming scope or lowering quality to reduce upfront spending. Value engineering takes a different path. It looks for other materials, systems, or construction methods that can deliver the same result - or an even better one - at a lower total lifecycle cost.
Owners should review the evaluation of alternative solutions before approving a VE change.
That review should cover each option’s:
