If I wait for a corporate risk file to tell me what is going wrong on a live job, I am already late. On construction projects, risk data can change week to week, and a PM-run register helps me track the items most likely to hit schedule, cost, and turnover before they become field problems.
Here’s the short version:
A static register helps with reporting. A PM-owned register helps me run the job.
| Area | PM-Owned Register | Corporate or Owner Register |
|---|---|---|
| Update pace | Weekly or biweekly | Monthly or quarterly |
| Detail level | Field and trade specific | High-level reporting |
| Link to schedule | Tied to critical path and look-aheads | Often tied to milestone view only |
| Accountability | One named person | Team, role, or department |
| Main use | Day-to-day job decisions | Oversight and reporting |
| Contingency use | Based on risk-by-risk cost exposure | Often a flat reserve |
Put simply, if I own the register, I can act on permit delays, vendor slips, labor gaps on large projects, and testing issues while there is still time to do something about them.
The issue isn’t whether a register exists. The issue is whether it stays alive. Once the register stops moving with the job, it stops being useful to the PM.
Corporate and owner-side registers are built for oversight. PM-led registers are built for execution. That sounds like a small difference, but on a live project, it changes everything.
Owner-side and corporate registers usually track broad risk buckets. They’re fine for reporting up the chain. But they often miss the field-level triggers that actually knock work off plan. They also tend to sit apart from the live schedule, so they don’t move at the same pace as site conditions.
Then there’s the ownership problem. If a risk has no named owner, the register turns into a document everybody reviews and nobody uses. And when ownership is fuzzy, scoring often turns into guesswork. Teams downplay probability and impact when they rate risks by gut feel instead of data [3]. The result is pretty simple: contingency comes in too low, and the team finds out too late.
When the PM doesn’t own the register, the warning signs show up fast.
Risk data gets old fast on a live jobsite [2][3]. If the PM isn’t driving the register, permit delays, utility tie-ins, and slipping supplier lead times can hit the critical path before they ever show up as active risks. That’s why a PM-owned register starts with the risks that can move the critical path.
That means the PM reviews the register every week or every other week, updates scores when site conditions shift, and links it to the critical path, procurement milestones, commissioning dates, and contingency. If a register gets touched only at project kickoff, it's paperwork - not risk management.
When the PM owns the register, updates happen as issues surface, not weeks later at the end of a monthly reporting cycle. A missed submittal date, a delayed permit, or a slip in long-lead equipment delivery shows up right away as an active risk, with a named owner and clear mitigation steps. That timing matters. Once work is installed, a lot of calls can't be undone.
The day-to-day method is simple: score each risk by Likelihood (1–5) and Impact (1–5), then multiply the two. Any score of 15 or more is a red-flag risk that needs a detailed mitigation plan. Any score of 20 or more needs immediate management attention [2]. That keeps the team locked in on the risks most likely to hit the turnover date or create a material cost exposure, instead of giving every line item the same level of effort.
Contingency should work the same way. Rather than using a flat percentage across the total project cost, the PM calculates expected value for each high-priority risk (Probability × Financial Impact) and builds contingency from the bottom up [1][5]. That gives leadership a reserve tied to actual project exposure.

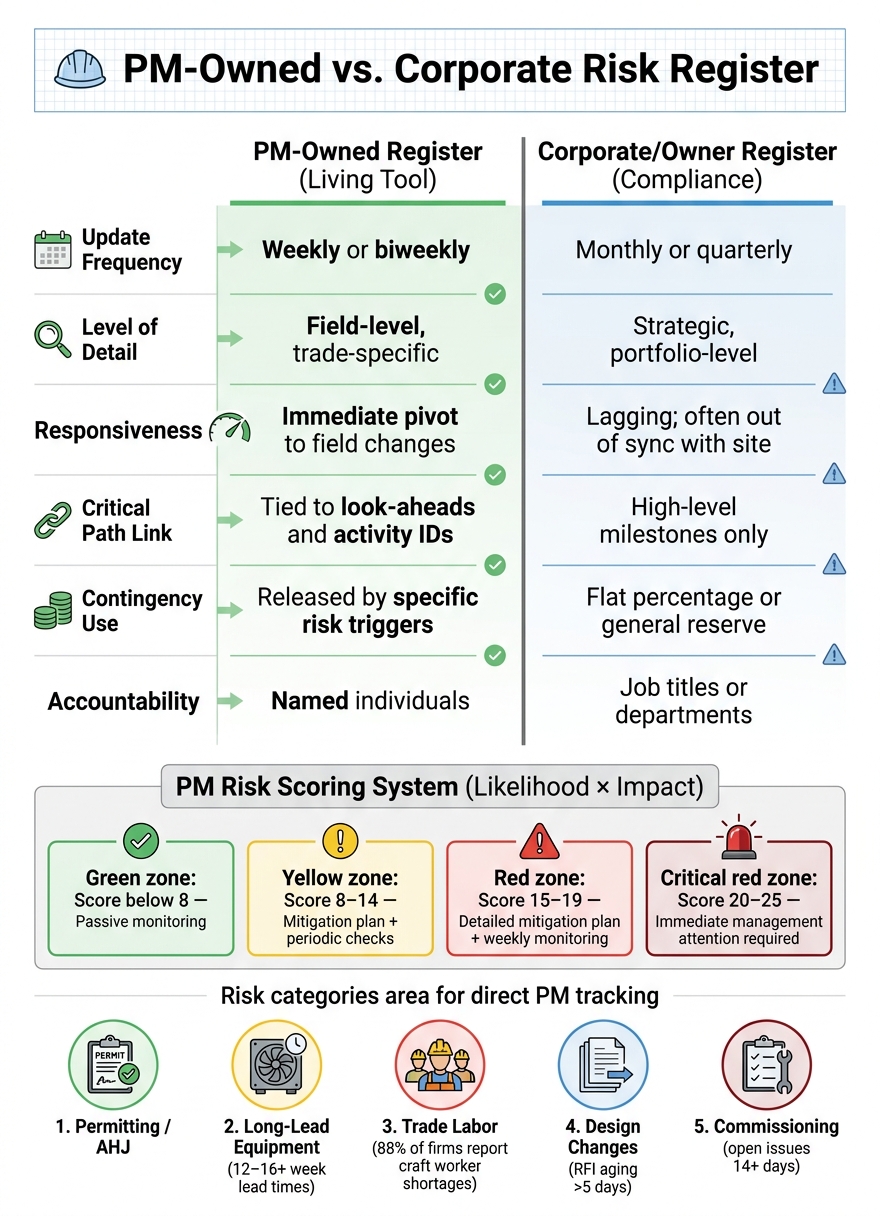

| Feature | PM-Owned (Living Tool) | Corporate-Owned (Compliance) |
|---|---|---|
| Update Frequency | Weekly or biweekly [1][5] | Monthly or quarterly [5] |
| Level of Detail | Field-level, trade-specific | Strategic, portfolio-level |
| Responsiveness | Immediate pivot to field changes [4] | Lagging; often out of sync with site [3] |
| Critical Path Link | Tied to look-aheads and activity IDs [3][5] | High-level milestones only [5] |
| Contingency Use | Released by specific risk triggers [5] | Flat percentage or general reserve [1] |
| Accountability | Named individuals [3] | Job titles or departments [5] |
That only works if the register covers the risks that can actually move the job.
Employers now screen for PMs who keep risk live, owned, and tied to delivery decisions [4]. They want PMs who can make fast, data-based calls under pressure, especially around critical-path decisions, procurement timing, and turnover readiness. A PM who can show a register that is actively maintained and linked to the critical path, procurement decisions, and commissioning milestones shows something simple but hard to fake: the ability to manage risk during day-to-day delivery, not just report on it [4].
That value starts with knowing which risks belong on the PM's list.
PM-Owned vs. Corporate Risk Register: Key Differences for Construction Projects
PMs need to keep a close eye on the risks that can shift the critical path. On mission-critical jobs, those risks belong on the PM’s live register. They’re usually the first to hit schedule, cost, and turnover.
Start with the risks that can stall work before crews even get going. Permitting risk shows up early in the schedule, which is exactly why it can do so much damage. Building permits, environmental approvals, utility interconnects, and fire marshal sign-offs all hit at a point when fix options are narrow and the cost of delay is at its peak [2].
AHJ review cycles are often outside the contractor’s direct control. Still, a PM who checks them every week can spot slow responses early and push for action before the delay lands on the critical path.
Long-lead equipment is where procurement risk becomes impossible to ignore. Switchgear, generators, UPS systems, chillers, CRAH and CRAC units, and filtration systems often face market backlogs that can stretch 12–16 weeks or longer [9]. That means the PM has to track more than just the purchase order. Lead times, factory acceptance testing (FAT) slots, freight, customs, on-site storage space, and delivery sequence all matter.
Labor gaps and design changes can snowball fast on mission-critical jobs, so they need a weekly check. In these projects, labor shortages tend to show up first with electricians, controls technicians, and other specialized crews. According to the AGC 2025 Workforce Survey, 88% of construction firms reported openings for craft workers [4]. That’s a big warning sign. PMs should collect weekly written manpower forecasts and confirm crew-size commitments before mobilization.
Subcontractor performance risk goes past simple headcount. Financial health, quality performance, and safety performance should all sit on the register with named owners and clear triggers. If a trade partner starts slipping, the job can feel it fast.
Design change risk belongs in that same group. Owner-requested equipment substitutions, unresolved BIM clashes, and RFI responses aging past five days are early signs that rework is on the way [9]. Freezing scope after sign-off milestones and keeping a formal change trail helps the PM keep that risk in plain view before it spills into the field [4][7].
Closeout risks need attention long before turnover is on the calendar. Commissioning risk is the one that often shows up too late. In data centers, integrated systems testing (IST) failures can delay turnover. In life sciences, missing IQ/OQ/PQ documents can trigger regulatory holds.
The PM should handle commissioning as part of the project’s quality assurance process, not as a last-minute checklist. Open issues that stay unresolved for 14 or more days, failed component testing, and missing IQ/OQ/PQ documents are all triggers that belong on the register [6]. Those risks need active management months before practical completion, with system testing lined up against project milestones [5][8].
| Risk Category | Typical Triggers / Early Warnings | Main Impacted Objective | PM Ownership Required? |
|---|---|---|---|
| Permitting / AHJ | City review cycle slippage; delayed utility interconnect sign-offs | Schedule (Critical Path) | Yes - requires local escalation |
| Long-Lead Equipment | Vendor misses FAT slot; quoted lead times > 12–16 weeks [9] | Schedule & Cost | Yes - affects sequencing |
| Trade Labor | Crew size below commitment; local market competition spikes | Schedule & Quality | Yes - requires daily monitoring |
| Design Change | RFI aging > 5 days; owner-requested equipment substitutions; BIM clashes [9] | Cost & BIM Coordination | Yes - prevents rework |
| Commissioning | Open issues 14+ days; failed component testing; missing IQ/OQ/PQ docs [6] | Turnover / Acceptance | Yes - critical for closeout |
Once the PM has the right risks on the list, the register needs to be easy to update and specific enough to push action. A good PM-owned risk register turns risk into action. Each entry should include a Risk ID, a Cause → Event → Impact description, category, owner, probability, impact, score, trigger, mitigation, due date, status, and latest update [5][3][2].
Two fields do a lot of the heavy lifting: the named owner and the trigger. If a risk is assigned to a department or job title, ownership gets fuzzy fast. A named person makes it clear who is on the hook. The trigger spells out the exact point when mitigation starts, like a permit not received by 07/15/2026 or a supplier date slipping by 7 days. Without that trigger, teams tend to wait too long, and by then the risk is no longer a risk. It’s an issue sitting right on the job [5][3][6].
For the risk description, use a Cause → Event → Impact format. Don’t write “switchgear delay.” That’s too thin. Write this instead: “Late switchgear delivery leads to delayed power-on, pushing commissioning by 3 weeks and creating a $250,000 cost impact.” In one sentence, the team and leadership can see what happened, what it affects, and what it may cost [3][6].
Use a 1-to-5 scale for probability and impact, then multiply them to get a 1–25 risk score. A score of 15 or more is red and needs a detailed mitigation plan plus active weekly monitoring. Scores from 8 to 14 are yellow and need a plan with periodic checks. Anything below 8 is green and can be watched passively [1][2].
Mitigation due dates should tie to schedule milestones, not random calendar dates. For example: “Secure permit by 10/15/2026 to avoid 11/01/2026 mobilization delay.” That’s much clearer because it connects the action to the job. Build the register in a filterable spreadsheet or a project controls tool, then review red risks and near-term triggers during the weekly PM meeting [1][6].
Use one row per risk so the owner, trigger, and due date all stay in the same view. The table below shows each field, why it matters, and a practical example using U.S. format - MM/DD/YYYY dates and USD cost impacts.
| Field | Purpose | Example Entry |
|---|---|---|
| Risk ID | Permanent reference for tracking | R-101 |
| Risk Description | Cause → Event → Impact | Late switchgear delivery (Cause) leads to delayed power-on (Event), pushing commissioning by 3 weeks and creating a $250,000 cost impact (Impact) |
| Category | Risk type for filtering | Long-Lead Equipment |
| Named Owner | Single accountable individual | John Doe (Electrical PM) |
| Probability | Likelihood of occurrence | 4 (Likely / 60%) |
| Impact | Severity of cost or schedule hit | 5 (Severe) |
| Risk Score | Priority ranking (P × I) | 20 - Red, immediate action |
| Trigger | Signal to execute mitigation | Manufacturer fails to provide shipping documents by 08/15/2026 |
| Mitigation Action | Specific step to reduce or avoid the risk | Pay expediting fee; identify rental generator as backup |
| Due Date | Deadline for mitigation completion | 08/20/2026 |
| Status | Current state | Active / Mitigating |
| Latest Update | Most recent progress note | 06/21/2026: Factory confirmed assembly is 90% complete |
Once the process is steady, add a Residual Risk Rating [5][3]. Close a risk only when the mitigation is done and the proof is stored in the project file [6].
Static risk registers go stale fast. PM-owned registers stay tied to what’s happening on the ground.
That gap matters most on complex jobs, where small misses can turn into schedule delays or cost overruns before the team has time to react. When the PM owns the register, risks like permitting delays, long-lead equipment slips, labor gaps, design changes, and commissioning failures are less likely to sit quietly until they become on-site problems.
A PM-owned register keeps risk in plain view. It assigns accountability to specific people and links mitigation steps directly to schedule milestones and cost plans.
That same level of discipline now shows up in hiring. Teams look for active risk ownership as a sign that a PM can protect schedule and budget under pressure. It shows that the PM thinks ahead, takes responsibility, and guards delivery when the job gets tight.
On mission-critical projects, PM-owned risk management is both a delivery advantage and a hiring signal.
A risk register tracks potential future events that haven't happened yet. An issue log tracks problems that are already affecting the project.
Put simply, a risk register is proactive. It helps the PM spot, assess, and reduce risks before they turn into bigger problems. An issue log is reactive. It records problems that have already happened and need corrective action.
Assign each risk to one named person. That way, there’s no confusion about who owns it.
Don’t give risks to a department, a broad job title, or a whole team. When everyone owns it, no one does.
Instead, name the person best placed to handle the mitigation, such as a project manager, site manager, or lead surveyor. This keeps the risk visible, helps move actions forward, and makes it easier to confirm when the risk has been closed.
Map each schedule-related risk straight to the exact activity IDs in your scheduling tool, whether that’s Oracle Primavera P6 or Microsoft Project.
For each risk, add a three-point impact range: minimum, most likely, and maximum. That way, the risk register can support Quantitative Schedule Risk Analysis (QSRA).
This keeps the register tied closely to the schedule and helps make contingency planning more data-driven and easier to defend.
