Construction Budgeting for Owners: From Conceptual Estimate to Final Closeout

By:
Dallas Bond

If you only track the contractor’s price, you’re missing the budget that drives the whole project. I’d treat owner budgeting as one control path that starts before design is finished and ends only after final payment, retainage release, and closeout.

Here’s the short version:

  • An estimate is not a budget until I approve it
  • The owner budget is more than the GC contract
  • Scope, schedule, risk, and cost move together
  • Early estimates need more contingency
  • Bid leveling and GMP review only work when scope is lined up
  • Monthly cost reports must show actual cost, pending changes, forecast, and EAC
  • Cash-flow timing matters as much as total cost
  • Closeout is where I confirm what the project actually cost and why

A few numbers stand out:

  • 69% of projects go over their original budgets by 10% or more
  • Projects under 75% Construction Documents usually need larger reserves
  • Fast-track work may need 2% to 4% more contingency
  • Owner contingency often runs 5% to 8% for tenant improvement work and 12% to 18% for complex data center or biotech jobs

What I take from this article is simple: the owner’s budget should stay in one structure from concept to closeout, then get updated at each milestone instead of rebuilt from scratch. That means tracking hard costs, soft costs, OFE, utilities, financing, contingency, and closeout in one place.

I’d also keep my eye on these decision points:

  • Concept and feasibility: set the first baseline
  • SD, DD, and CD pricing: check design growth against funding
  • Procurement: level bids on equal scope
  • Award: lock the execution budget
  • Construction: track changes, contingency use, and monthly forecast
  • Closeout: reconcile final cost back to the original funding case

One simple way to read the article is this: budgeting is not one number; it is a series of owner approvals tied to better cost data over time.

Project stage What I’m watching
Early estimate Cost range, assumptions, reserve level
Design progress Scope growth, estimate updates, gaps
Bidding/GMP Scope alignment, allowances, contingencies
Construction Actual cost, pending changes, EAC, cash flow
Closeout Final reconciliation, retainage, lessons learned

If I had to sum it up in one line, it would be this: good owner budgeting connects the first estimate, the contract amount, the monthly forecast, and the final cost into one clear trail.

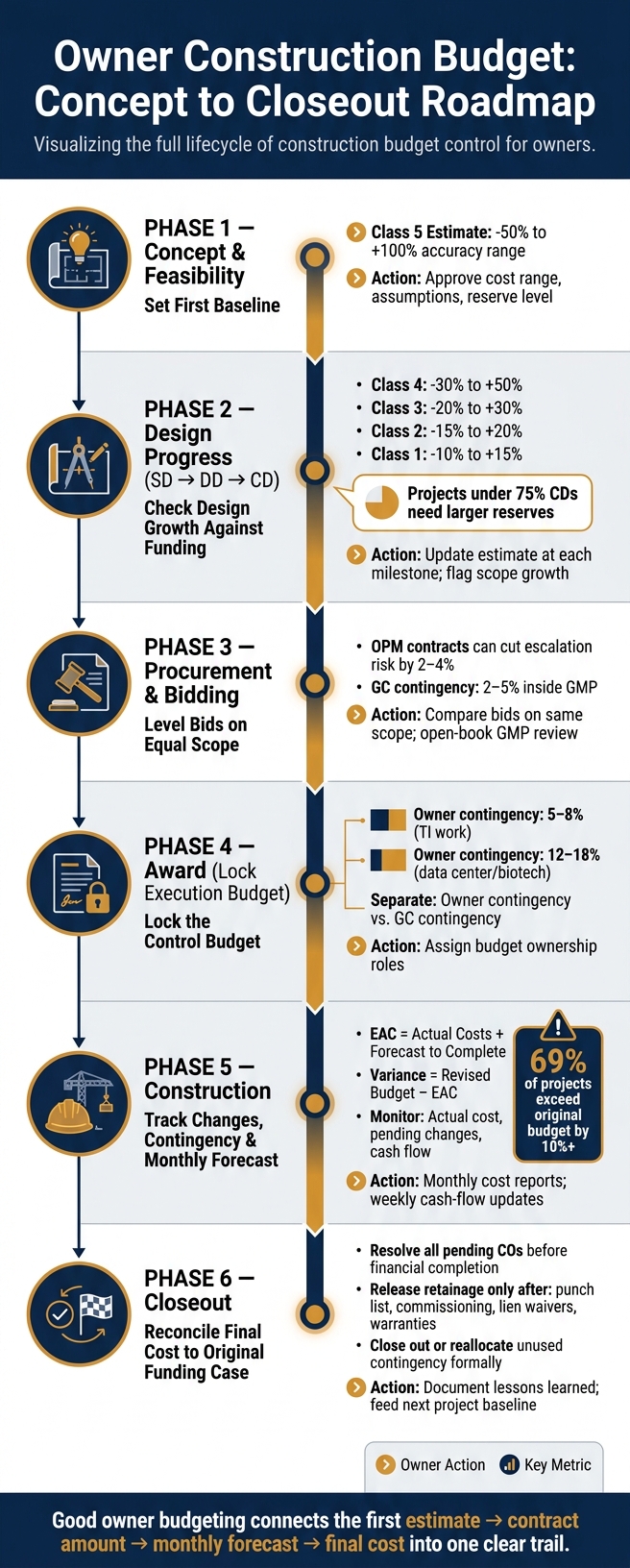

Owner Construction Budget: Concept to Closeout Roadmap

Owner Construction Budget: Concept to Closeout Roadmap

How To Manage A Construction Budget As A Project Manager

Building the Budget Baseline: Estimate Classes, Cost Structure, and Early Forecasts

Once scope and schedule are set, the owner turns the concept estimate into the first control baseline.

Estimate Classes From Conceptual Through Detailed Design

Each estimate class comes with a different confidence range. It should also come with a matching level of decision authority. Put simply: an estimate does not become a budget until the owner approves it.

The table below shows how each class fits into the owner's decision process.

Estimate Class Design Maturity Typical Accuracy Range Primary Basis of Estimate
Class 5 0%–2% -50% to -20% / +30% to +100% Capacity Factored, Parametric, or Judgment
Class 4 1%–15% -30% to -15% / +20% to +50% Equipment Factored or Parametric
Class 3 10%–40% -20% to -10% / +10% to +30% Semi-Detailed Unit Costs with Assembly Level
Class 2 30%–75% -15% to -5% / +5% to +20% Detailed Unit Cost with Detailed Quantity Takeoff
Class 1 65%–100% -10% to -3% / +3% to +15% Detailed Unit Cost with Detailed Takeoff

Adapted from AACE International classifications [2].

These ranges overlap on purpose. Treat them as confidence bands, not rigid cutoffs.

Once approved, that baseline becomes the yardstick for later bid review, GMP analysis, and change control.

Organizing the Owner Budget by WBS, CSI, and Cost Type

The owner budget should be organized by WBS, CSI code, and cost type so scope, funding, and reporting all point to the same structure. The usual setup layers a Work Breakdown Structure (WBS), CSI coding, and cost categories so scope, schedule, and funding stay aligned.

For early estimates, CSI UniFormat (OmniClass Table 21) works well because it groups costs by functional systems. As the design gets more detailed, the budget should shift to CSI MasterFormat (OmniClass Table 22), which supports more granular work results and ties in better with the schedule [2].

A complete owner budget should also separate cost types clearly, including:

  • Hard construction costs
  • Soft costs such as design services, permits, and legal fees
  • Markups
  • Escalation
  • Contingency
  • Management reserve

Unit metrics like $/SF give the team a fast way to compare scope changes against the funding case [2].

Every later cost report and forecast should roll up to this same owner baseline. That's what supports procurement comparisons and award-level budget control.

Moving From Conceptual Estimate to Design Development Budget Checks

The usual path is a series of milestone-based cost checks tied to design submittals: Schematic Design (SD), Design Development (DD), and Construction Documents (CD). At each stage, the estimating team updates the model with the latest design data, records what changed and why, and checks the new estimate against the approved budget.

If the updated estimate comes in above the approved screen, that's a sign to adjust scope or revisit the funding case before the design moves any farther.

Sensitivity testing makes each milestone check more useful. By changing key inputs - such as square footage or capacity - the team can see which factors have the biggest effect on total cost [2]. That helps sort out where scope changes might save money and where cuts could create too much risk.

Clear notes on inclusions, exclusions, and other assumptions at each milestone also matter. They make reviews easier to use and help prevent budget drift as the design develops [1][2].

Use specialty-contractor input during DD to line up labor and material assumptions with market pricing.

Procurement and Contract Setup: Converting Estimates Into a Control Budget

At this point, the owner puts the approved budget in front of the market. A planning figure now has to stand up to actual pricing, subcontractor availability, and contract terms. If this step gets loose, the budget can start slipping the moment procurement begins.

Pre-Bid Planning and Bid Comparison

Before bid documents go out, owners should run a formal constructability review. That means clearing up structural, MEP, and envelope coordination first, not after bids come back.

For projects exposed to price swings in materials like structural steel, copper, or specialty mechanical equipment, Owner-Purchased Material (OPM) contracts can help lock pricing earlier. In plain terms, the owner buys key items sooner instead of waiting for the full contract path to play out. That can cut escalation risk and reduce contingency needs by 2–4% [3].

When bids come in, compare them on the same scope. A low base number can be misleading if one contractor excludes items, carries higher general conditions, or needs more time. Bid leveling shows what each offer will actually cost after alternates, schedule, and contract assumptions are lined up.

Bidder Base Price Alternates Fee % General Conditions Duration Major Qualifications
Contractor A $10.2M +$150k 3.5% $850k 12 mos Excludes utility tap fees
Contractor B $10.5M Included 4.0% $780k 11 mos Includes all permits
Contractor C $9.8M +$300k 5.0% $920k 14 mos Requires owner-provided hoist

Source: Adapted from [2][3].

Contractor C looks cheapest at first glance. But once you add the alternates and account for the longer schedule, the gap starts to shrink. Two extra months of general conditions can eat up that early price edge fast.

After bids are leveled, the selected number becomes the starting point for GMP negotiation and final contingency setting.

GMP Analysis, Allowances, and Open-Book Review

A GMP only limits owner exposure when the assumptions behind it are tight. A standard GMP usually includes:

  • Cost of the work
  • GC contingency, usually 2–5% inside the GMP
  • Allowances for scope that is not yet fully defined
  • A fixed fee
  • Shared savings terms [3][4][6]

Owner Contingency and GC Contingency should stay separate [3]. They do different jobs. Owner contingency covers scope changes and owner directives. GC contingency covers means and methods, along with minor coordination issues.

Estimate Class Design Maturity Accuracy Range Recommended Owner Reserve
Class 3 (Design Dev) 10–40% ±10–20% 10–14%
Class 2 (Construction Docs) 30–75% ±5–15% 7–10%
Class 1 (Final CDs) 65–100% ±3–10% 5–8%

Source: [3]

During the open-book review, require direct costs by work package before fee, markup, and contingency [2]. That makes it easier to see where the money is actually going. Allowances also need a close look. They should match the current procurement status and the scope that is actually defined. Owners should also check assumptions tied to material pricing, labor rates, design specs, and escalation [1][2].

Locking In the Execution Control Budget at Award

At award, all approved costs should roll into one execution baseline. This is bigger than the GC contract alone. It should include all project cost pieces, along with approved contingency [4][5].

Contingency should match the project type, not get picked out of thin air. Institutional lenders in 2026 want contingency shown as a separate draw line, not buried inside broad budget buckets [3]. Typical owner contingency ranges run from 5–8% for tenant improvements to 12–18% for complex data center or biotech builds [3].

Just as important, someone has to own each part of the control budget. If everyone touches it but no one owns it, drift can sneak in fast. In most cases, the project manager oversees the full budget, the cost engineer tracks actuals against the baseline, the scheduler flags schedule-driven cost effects, the finance lead manages funding draws, and the executive sponsor controls management reserve [2][4].

With the control budget locked, the next step is monthly tracking of actual cost, forecast, and contingency against that baseline.

Construction Phase Budget Control: Cost Reports, Changes, Contingency, and Cash Flow

This is the part of the job where cost control stops being a plan on paper and starts getting tested in the field. Monthly reporting, change control, and cash-flow planning help protect the owner's baseline once work is underway. The flow is pretty simple: start with the baseline, measure variance, manage changes, then map out when cash is needed. Those four steps work best as one connected control system.

Monthly Cost Reporting and Estimate at Completion

Monthly reporting turns the awarded baseline into a working forecast. For owners, a good cost report doesn't just show what has happened. It shows where the job stands now and where final cost is headed.

The report should keep the original baseline in view while also showing the revised budget, committed costs, actual costs to date, pending changes, forecast to complete (FTC), and estimate at completion (EAC). The basic math is straightforward: EAC = Actual Costs + FTC. Variance is Revised Budget - EAC. Keep base contract costs and change orders in separate columns so scope growth is easy to spot and doesn't get mixed up with execution problems [8].

Cost Report Column Definition / Formula Purpose for Owners
Original Budget Initial approved baseline Measures performance against the starting business case
Approved Changes Fully authorized scope/price adjustments Shows how much the authorized target has grown
Revised Budget Original Budget + Approved Changes The current authorized target for the project
Committed Costs Value of signed contracts and POs Shows what the owner is legally obligated to pay
Actual Costs Invoices paid or recorded to date Tracks actual cash outflow
Pending Changes Proposed changes under review Early warning: signals potential future budget hits
Forecast to Complete Estimated cost for remaining work Predicts future spending based on current trends
Estimate at Completion Actual Costs + Forecast to Complete The final number the owner should expect to pay
Variance Revised Budget - EAC Identifies if the project is trending over or under budget

One column deserves extra attention: pending changes. This is where owners get an early heads-up before a cost hit becomes official. If that column is ignored, the report can look calm right up until the budget jumps.

Use one monthly cutoff date for the whole report. Also assign one owner to approve forecast updates and explain variances. That keeps the numbers consistent and cuts down on the all-too-common problem of multiple versions of the truth [7][8].

Change Management and Contingency Governance

Every change should come with three things before work starts: a defined scope, a priced impact, and an approved funding source [9]. That's the basic discipline that keeps scope creep from sneaking into the job and disconnecting cost from approved decisions.

It also helps to split contingency into separate buckets for design, construction, owner, and management reserve. Each bucket should have a clear purpose, a draw trigger, and an approval rule. If everything goes into one lump sum, it gets harder to tell why money was used and whether that use was justified.

Use variance and pending changes to decide whether to draw from contingency or ask for more approval. A live change and contingency log keeps that process visible:

ID Description Cause Cost Impact Schedule Impact Funding Source Status Starting Balance Approved Use Remaining Balance
CO-01 Foundation Reinforcement Unforeseen Soil Condition $45,000 5 Days Construction Contingency Approved $500,000 ($45,000) $455,000
CO-02 Upgraded Lobby Finishes Owner Scope Change $12,500 0 Days Owner Contingency Pending $250,000 $0 $250,000
CO-03 HVAC Lead Time Delay Supply Chain Shift $8,000 12 Days Management Reserve Approved $150,000 ($8,000) $142,000

Pending changes should be logged before approval, not after. Once approved, those changes move into the revised budget. Until then, they should feed the forecast. That link matters. Without it, the cost report and the change log turn into two separate tools that don't quite agree with each other [9].

Cash-Flow Forecasting and Funding Draw Planning

Once cost is forecasted, the next step is timing. A cash-flow forecast shows when money will be needed, not just how much the work will cost [13]. That's a big difference. Total cost may stay the same while cash timing shifts a lot.

Build the cash-flow forecast from the budget, subtract actuals, and spread the balance across the schedule [12]. But don't spread it evenly unless the work is even, which it usually isn't. Different trade packages burn through cash in different ways. Concrete tends to ramp up and down. Elevators are front-loaded. Finishes are back-loaded. Trailer rentals are often linear [12].

That package-by-package view matters because bad timing can create bad borrowing decisions. If cash needs are overstated, owners can end up carrying larger loans and paying more in financing costs than they need to [12].

Retainage is another spot where teams get caught off guard. During closeout, spending may slow down, but final payments and retainage releases can create a concentrated cash event [12]. On paper, the job may look like it's winding down. In the bank account, it can feel like the opposite.

Update the forecast weekly as invoices are posted, work gets completed, and changes are approved [13]. Approved changes should update both the revised budget and the funding forecast. When that happens in sync, owners can line up milestone timing with funding draws and avoid borrowing more than the job actually needs [13].

Final Closeout and Portfolio Learning

Financial Reconciliation, Final Payments, and Closeout Controls

Closeout is the last big cost-control check. Before you call a project financially complete, reconcile every contract, purchase order, and change order against the approved cost structure and baseline [10][11].

Final payment should go out only after the punch list is closed, commissioning is done, documents are handed over, lien waivers are in place, and warranties have been delivered [14][16]. Retainage should stay in place until all of that is done.

Change order cleanup is often where things get messy. Pending change orders and variance orders need to be resolved and documented before the job is fully finished [11][15]. Clean, time-stamped records help move final claim resolution along and reduce retainage disputes.

If contingency money is left over, close it out or reallocate it through a formal process. Don’t let it disappear into the final numbers. That keeps the last cost figure honest.

Comparing Final Cost to the Original Funding Case

Once final costs are reconciled, compare the result to the original funding case. Go back to the first pro forma and the procurement baseline [17].

The point is simple: find out why the numbers changed. Cost growth usually comes from scope changes, escalation, delays, and field issues [15]. Compare final spend, IRR, and LTV to the approved funding case, and measure any effect from delayed draws or slow documentation [17].

"Projects that fail at scale typically break down at the handoffs, where budget logic, approval context, and risk data get lost between disconnected systems." - Erik Koentje, Sales and Account Management Lead, Built [17]

Conclusion: The Owner Budgeting Roadmap From Concept to Closeout

Once the final variance is explained, the closeout data becomes a tool for the next project. Owner budgeting works best when every cost decision stays tied to the approved baseline from concept through closeout.

After final reconciliation, transfer the full record set to operations and asset management. Then document lessons learned for the next job. The closed project record should feed the next baseline, forecast, and contingency plan.

FAQs

How often should an owner update the project budget?

An owner should update the project budget on a regular basis. In most cases, monthly or quarterly reviews work well because they help spot unplanned costs or budget gaps before they get out of hand.

What costs should be included beyond the GC contract?

Beyond the General Contractor (GC) contract, include all recurring and one-time project costs. That means purchase, installation, operations, maintenance, upgrades, and any residual or salvage value.

It also helps to account for scope changes, design development, procurement, construction management, contingency funds, and testing, commissioning, and closeout work.

When you include the full cost picture, decisions tend to get better, cost certainty gets stronger, and the budget is less likely to drift.

How do owners decide the right contingency amount?

Owners don’t set contingency by picking a standard percentage and calling it a day. They usually base it on the specific risks, project complexity, and how much is still unknown in the scope.

A few things tend to shape that number:

  • Project type
  • Design maturity
  • Delivery method

For simpler renovations with a well-defined scope, contingency may land around 10%–15%. More complex or uncertain projects, such as industrial builds or data centers, may need about 12%–18%.

That number also shouldn’t stay frozen. Owners need to review the main risk drivers, track how contingency is being used, and adjust reserves as conditions shift. That helps maintain cost certainty and avoid budget drift.

Related Blog Posts

Keywords:
construction budgeting, owner budget, conceptual estimate, GMP, contingency, cost control, cash flow, construction closeout
Free Download

Data Center Construction Labor Trends in 2026

Thank you! Your submission has been received!
Oops! Something went wrong while submitting the form.

More mission critical construction news

Design Management in Construction: A Complete Guide for Project Owners
June 15, 2026

Design Management in Construction: A Complete Guide for Project Owners

How owners steer design to control cost, schedule, and constructability—from OPR to turnover, using gates, BIM, and decision logs.
Change Order Management in Construction: The Owner's Defense Playbook
June 15, 2026

Change Order Management in Construction: The Owner's Defense Playbook

Control change orders with strict contracts, written notices, itemized backup, and schedule proof.
What Is Value Engineering in Construction? A Plain-English Guide for Owners
June 15, 2026

What Is Value Engineering in Construction? A Plain-English Guide for Owners

How owners use value engineering to cut lifecycle costs, protect function and schedule, and evaluate VE options during design.
Data Center Construction Management: A Playbook for Hyperscale and Colocation Owners
June 15, 2026

Data Center Construction Management: A Playbook for Hyperscale and Colocation Owners

Owner-side control—early hires, integrated schedules, and parallel commissioning—prevent data center build delays and revenue loss.
